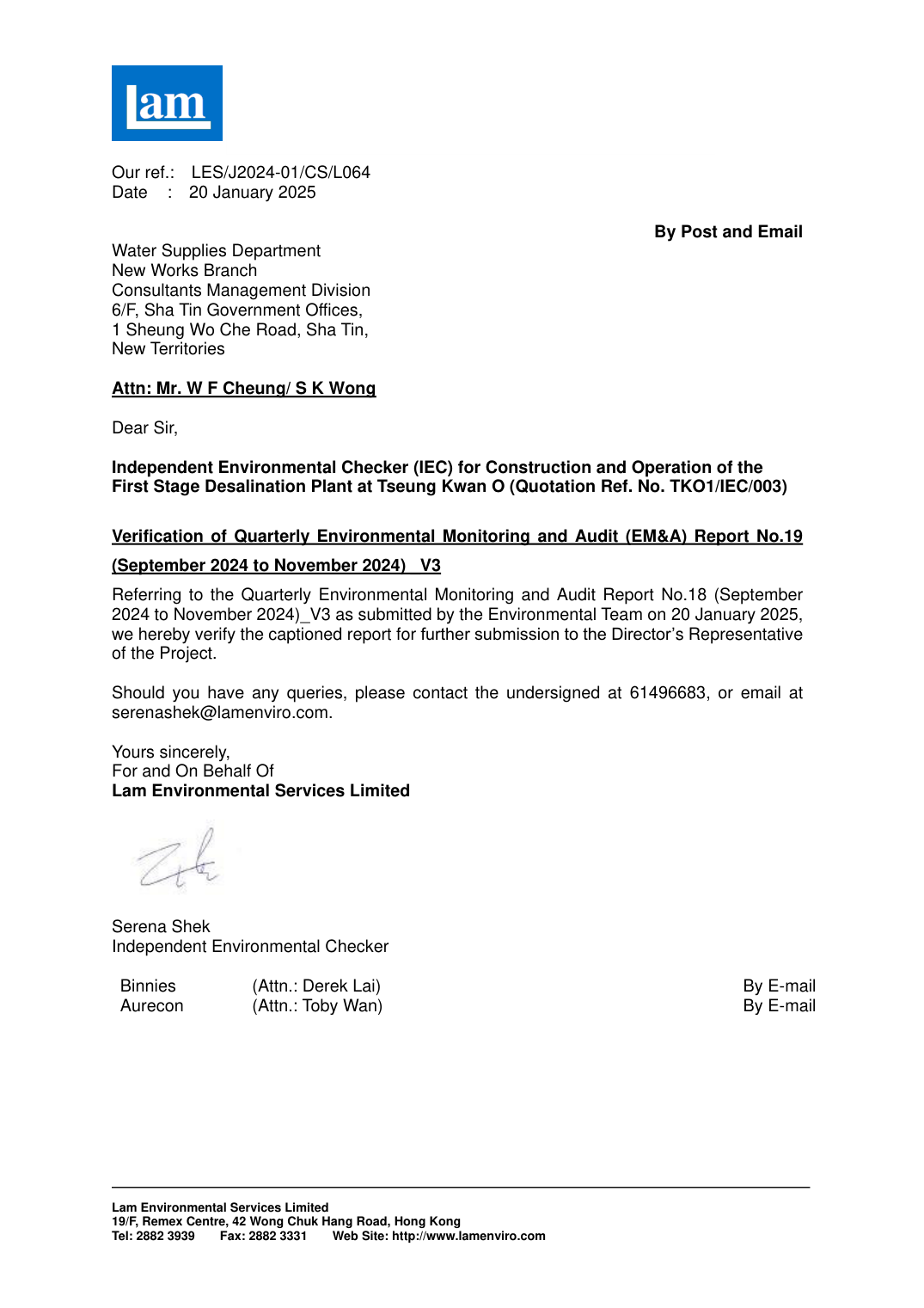

REVISION HISTORY

REV.

DESCRIPTION OF MODIFICATION

DATE

1.

1st Issue

19/12/2024

2.

2nd Issue

16/01/2025

3.

3rd Issue

20/01/2025

CONTENTS

Executive Summary ................................................................................................................................................................ 1

Basic Project Information ........................................................................................................................................... 7

Noise ................................................................................................................................................................................. 14

Water Quality ................................................................................................................................................................ 18

Waste ............................................................................................................................................................................... 27

Landfill Gas Monitoring ............................................................................................................................................ 28

Summary of Exceedance, Complaint, Notification of Summons and Prosecutions ......................... 32

EM&A Site Inspection ................................................................................................................................................ 35

Conclusions and Recommendations ................................................................................................................... 36

Appendix A

Master Programme

Appendix B

Overview of Desalination Plant in Tseung Kwan O Appendix C

Summary of Implementation Status of Environmental Mitigation Appendix D

Water Quality Monitoring Graphical Presentation Appendix E

Summary of Exceedances

Appendix F

Waste Flow Table

Appendix G

Complaint Log

Appendix H

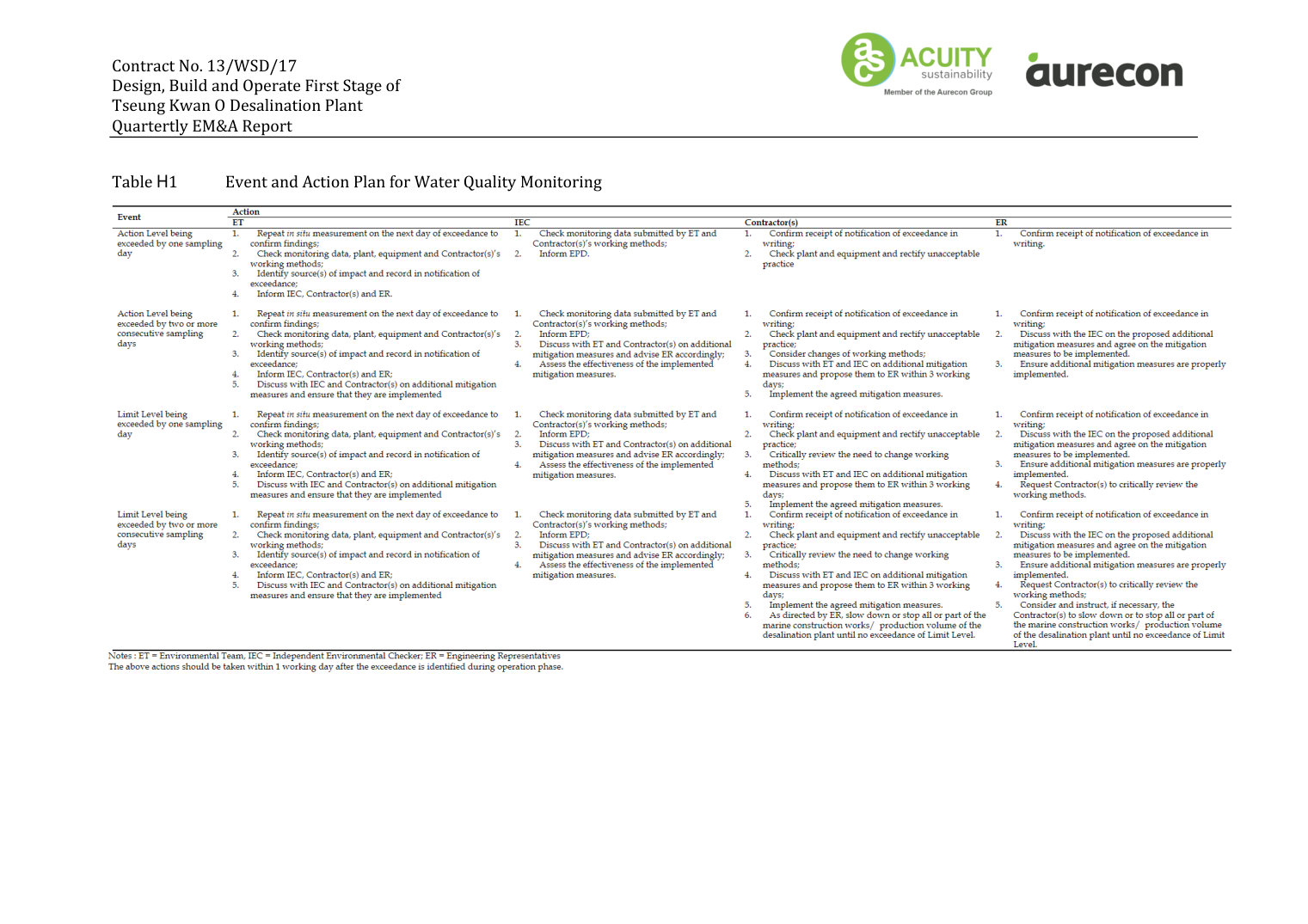

Event/Action Plan for Water Quality Monitoring Appendix I

Event/Action Plan for Construction Noise Exceedance Appendix J

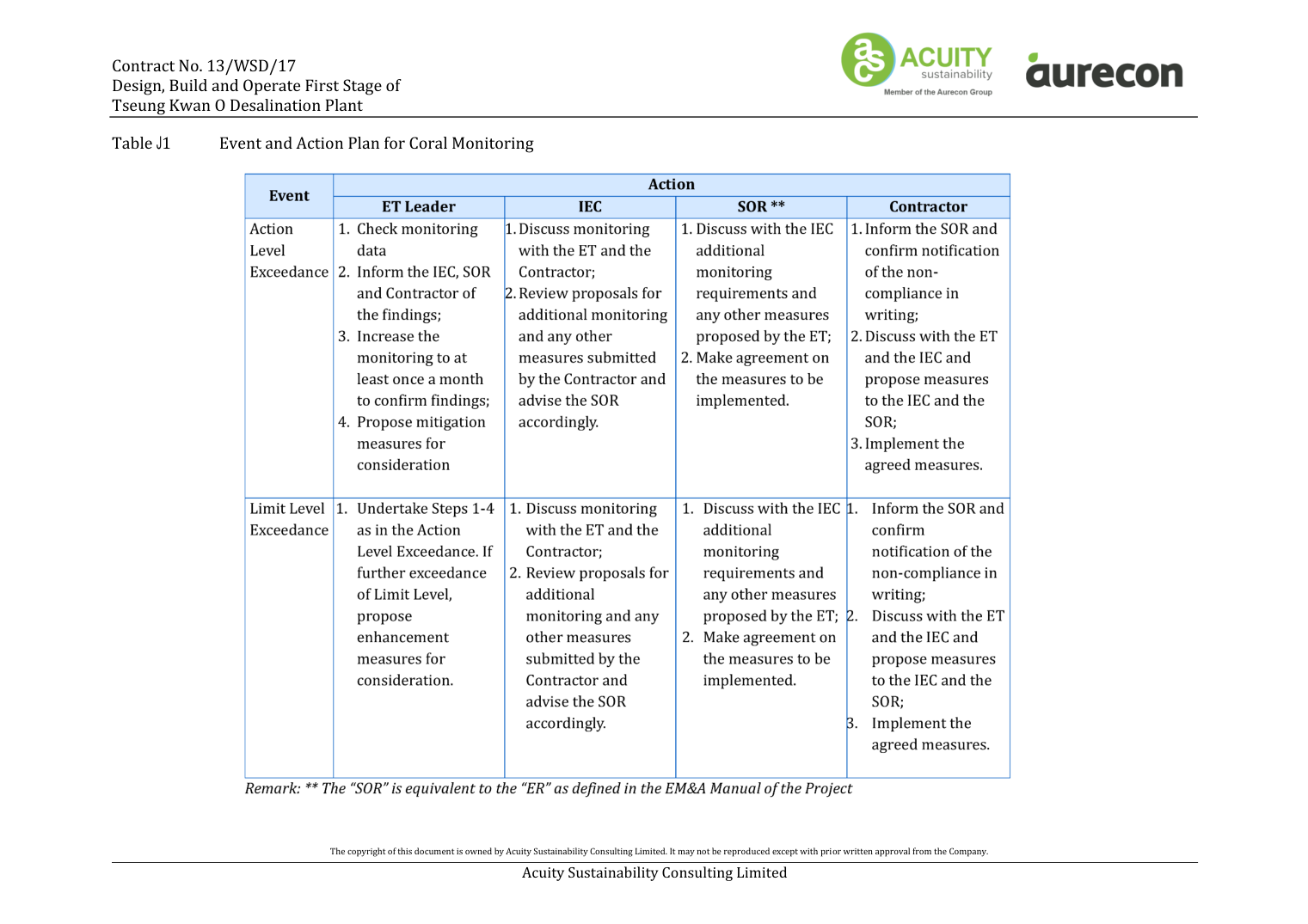

Event/Action Plan for Coral Monitoring Exceedance

EXECUTIVE SUMMARY

INTRODUCTION

A1. The Project, Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (TKODP), is a Designated Project under the Environmental Impact Assessment Ordinance (Cap. 499) (EIAO) and is currently governed by a Further Environmental Permit (EP No. FEP – 01/503/2015/B) for the construction and operation of the Contract.

A2. In accordance with the Environmental Monitoring and Audit (EM&A) Manual for the Contract, EM&A works for marine water quality, noise, waste management and ecology should be carried out by Environmental Team (ET), Acuity Sustainability Consulting Limited (ASCL), during the construction phase of the Contract.

A3. According to the contractor’s information, the works of TKODP were substantially completed on 30 June 2024 and the plant commenced the operation phase on 1 July 2024. The outstanding construction works were being carried out during this reporting period.

A4. This is the 19th Quarterly EM&A Report, prepared by ASCL, for the Contract summarizing the monitoring results and audit findings of the EM&A programme at and around Tseung Kwan O Area 137 (TKO 137) during the reporting period from 1 September 2024 to 30 November 2024.

A5. The EM&A programme for this contract has covered environmental monitoring on construction noise level at selected NSRs and Contractor’s environmental performance auditing in the aspects of construction dust, construction noise, water quality, waste management, Landscape and Visual and Ecology.

SUMMARY OF MAIN WORKS UNDERTAKEN & KEY MITIGATION MEASURES IMPLEMENTED

A6. Key activities carried out in this reporting period for the Project included the followings:

All Area

• Security Fence footing construction work •

Footpath Construction

• Landscape Construction

• Irrigation System Construction

• Water Pressure Test for FS and PL system •

Landscape planting work

• Traffic signage work

• E&M Works and Mechanical Installation

PWST

• Water Test in Tank A

• Waterproofing work at Roof Slab on Tank A •

Installation of building services, electrical switchboards and cables Installation of mechanical equipment, steel pipe, Pressure Test

Administration Building

• External wall aluminum features installation •

Finishing works for dog house

• Minor Installation of building services, electrical switchboards & cables, Pressure Test, T&C

• Fitting out works

• Painting Works

Chemical building

• Defect rectification

• Repairing the defects inside the dangerous store

ActiDAFF

• Installation of access opening covers for filtered water tank •

Carrying out finishing works for staircase no. 3.

• Minor Installation of mechanical equipment, piping system •

Minor Installation of building services, electrical switchboards and cables, Installation of FRP Enclosure System

Product Water Storage Tank Building

• Minor Installation of building services, cable laying and termination, PV Panel Installation, Testing & Commissioning

OSCG Building

• Protective Coating for DG Rooms

• Installation of Railing on Brine Maker Tank •

Minor Installation of building services, cables and pipe works, T&C •

Tank surface cleaning, T&C

Reverse Osmosis Building

• Installation of Signage, AP doors, sanitary fitting, sanitary ware in toilet, tiling work and water meter cabinets

• Minor Installation of building services, minor cable laying and termination,

Testing & Commissioning, PV Panel Installation

Post Treatment Building

• Installation of Cat Ladders in Water Tanks •

Placing Soil Mix at Roof

• Curb Construction for Rescue Opening at Water Tanks

• Installation of building services, piping system, mechanical equipment and piping system, Pressure Test

Inspection gallery

• Construction of roof tiling works

• Installation of steel balustrade at roof •

Installation of movement joints

• Construction of block works

• Minor Installation of building service, T&C

RO and Electrical Building

• Installation of Glass House

• Minor Installation of building services, electrical switchboards and cables •

Minor Installation of mechanical pipework and raised Floor, •

PV Panel Installation, T&C

Chiller plant & Main Electrical Building

• Minor Installation of building services, electrical switchboards and cables, Pressure Test, T&C

Others

• Slope works*

• Construction works of extended access road

Remark: *The slope works were completed in October 2024, and there was no site activities related to the slope works conducted in November 2024.

A7. The major environmental impacts brought by the above construction works and slope works include:

• Construction dust and noise generation from excavation works, construction works;

• Waste generation from the construction activities A8. The key environmental mitigation measures implemented for the Project in this reporting period associated with the above construction works include:

• Dust suppression by regular wetting and water spraying for construction works and slope works;

• Reduction of noise from equipment and machinery on-site and regularly inspection to machinery and plants/vehicles on-site to ensure proper functioning;

• Sorting and storage of general refuse and construction waste;

• Deployment of silt curtain at the inshore water outflow; and • Deployment protective fencing for trees.

SUMMARY OF EXCEEDANCE & INVESTIGATION & FOLLOW-UP

A9. No noise monitoring was conducted during the reporting period since there are no project- related construction activities undertaken within a radius of 300m from the monitoring locations. No exceedance of the Action Level was recorded during the reporting period.

A10. Referring to EM&A Manual, the general water quality monitoring should be carried out when there are marine-related construction activities undertaken. General water quality monitoring at the ten monitoring stations (CE, CF, WSR1, WSR2, WSR3, WSR4, WSR16, WSR33, WSR36 and WSR37) was ceased from 1 September 2023 due to the completion of marine-related construction works.

A11. The operation phase water quality was conducted from 1 September 2024 to 30 November 2024. Thirty-six (36) of the operation phase water quality monitoring results of SS obtained had exceeded the Action Level. Eighty-five (85) of the operation phase water quality monitoring results of SS obtained during the reporting period had exceeded the Limit Level.

After investigation, all exceedances were concluded unrelated to the Project.

A12. The continuous monitoring of effluent quality was conducted from 1 September 2024 to 30 November 2024 in accordance with the EM&A Manual. No exceedance of the sampling was obtained during the reporting period had exceeded the Limit Level. The plant was shut down from 7 a.m. to 7 p.m. on 3 November 2024. No effluent discharge from TKODP occurred during this period. Due to the plant has suspended production, there was no effluent discharge from the TKODP during the period between 24 November 2024 and 30 November 2024.

A13. In this reporting period, 132 times of Construction Phase landfill gas monitoring were recorded at Wan Po Road (Ch0+390 – Ch0+780) and (Ch0+400 - Ch1+200). No action and limit level exceedance for methane, oxygen and carbon dioxide was recorded. The Construction Phase landfill gas monitoring was ceased from 31 October 2024.

A14. In this reporting period, Operation Phase landfill gas monitoring was conducted on 25, 26 and 27 September 2024, 9 and 10 October 2024, 14 and 15 November 2024. No exceedances of action level and limit level was observed.

A15. Operation phase monthly coral monitoring was conducted during the reporting period on 18 September 2024, 21 October 2024, 11 November 2024. There is no AL/LL exceedance during the monitoring period.

A16. Operation phase fishery monitoring for wet season 2024 was carried out on 24 and 31 August 2024. The detail of the monitoring was presented in the 4th Operation Phase Monthly EM&A Report.

A17. Total thirteen (13) times of Weekly site inspections of the construction works were also carried out by ET to audit the mitigation measures implementation status. Three (3) times of monthly Joint site inspections were carried out by ET and IEC.

A18. A summary of the EM&A activities in this reporting period is listed in Table I and summary of the environmental exceedance of the reporting period is tabulated in Table II.

Table I

Summary Table for EM&A Activities in the Reporting Period

EM&A Activities

Sep 2024

Oct 2024

Nov 2024

Noise Monitoring

N/A

N/A

N/A

Water Quality Monitoring

3, 7, 10, 12, 14, 17, 19, 21, 24, 26 and 28 September 2024

1, 3, 5, 8, 10, 12, 15, 17, 19, 22, 24, 26, 29 and 31 October 2024

2, 5, 7, 9, 12, 16, 19, 21, 23, 26, 28 and 30 November 2024

TRC Monitoring for Main Disinfection

N/A

N/A

N/A

Coral Monitoring

18 September 2024

21 October 2024

11 November 2024

Fishery Monitoring

N/A

N/A

N/A

Landfill Gas Monitoring (Construction Phase)

2, 3, 4, 5, 6, 7, 9, 10, 11, 12, 13, 14, 16, 17, 19, 20, 21, 23, 24, 25, 26, 27, 28 and 30 September 2024

1, 2, 3, 4, 5, 7, 8, 9, 10, 12, 14, 15, 16, 17, 18, 19, 21, 22, 23, 24 and 25 October 2024

N/A

Landfill Gas Monitoring (Operation Phase)

25, 26 and 27 September 2024

9 and 10 October 2024

14 and 15 November 2024

Environmental Site Inspection

3, 10, 17 and 24 September 2024

3, 8, 15, 22 and 28 October 2024

5, 14, 18 and 26 November 2024

Continuous Monitoring of Effluent Quality

From 1 to 30 September 2024

From 1 to 31 October 2024

From 1 to 30 November 2024

Table II

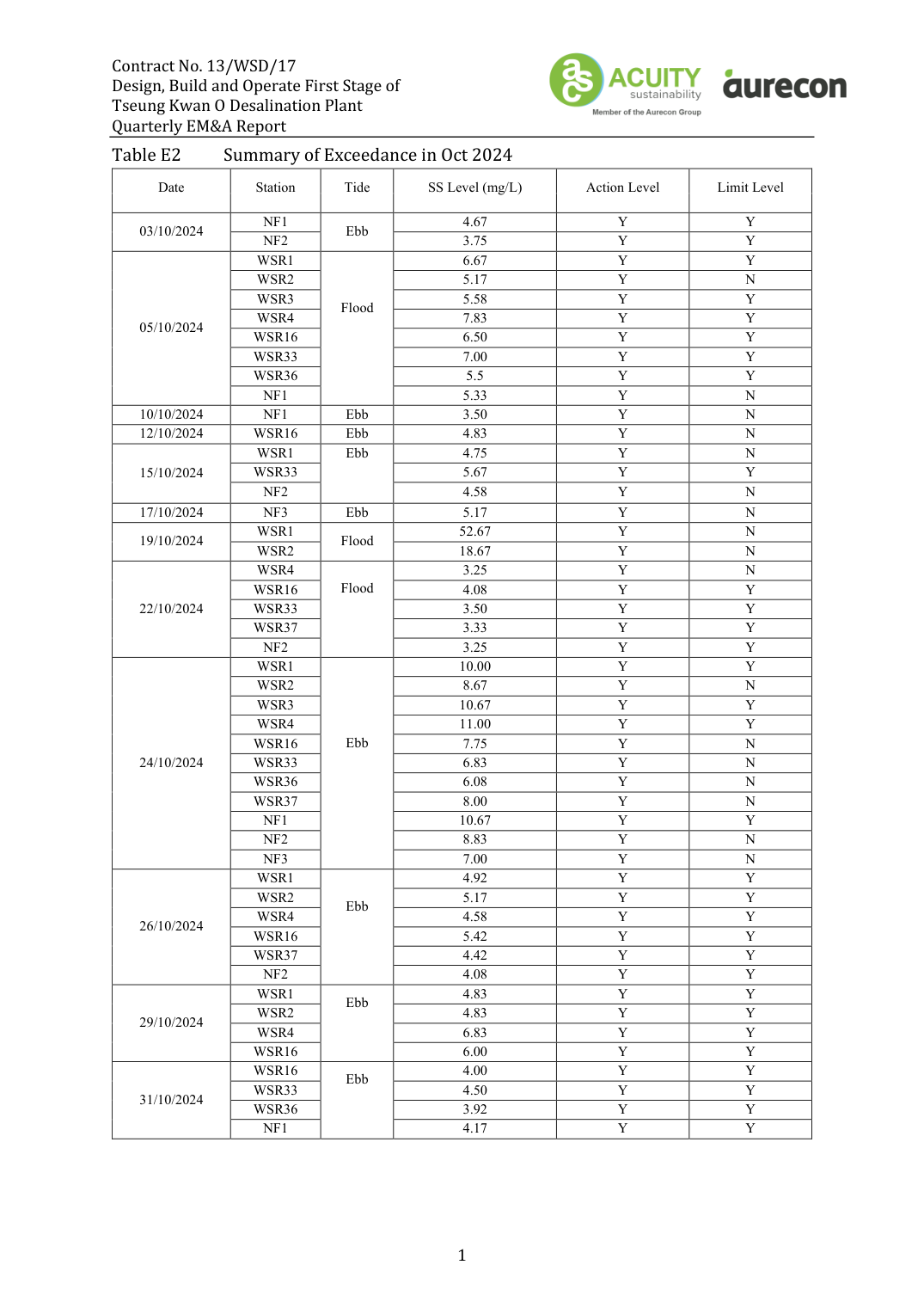

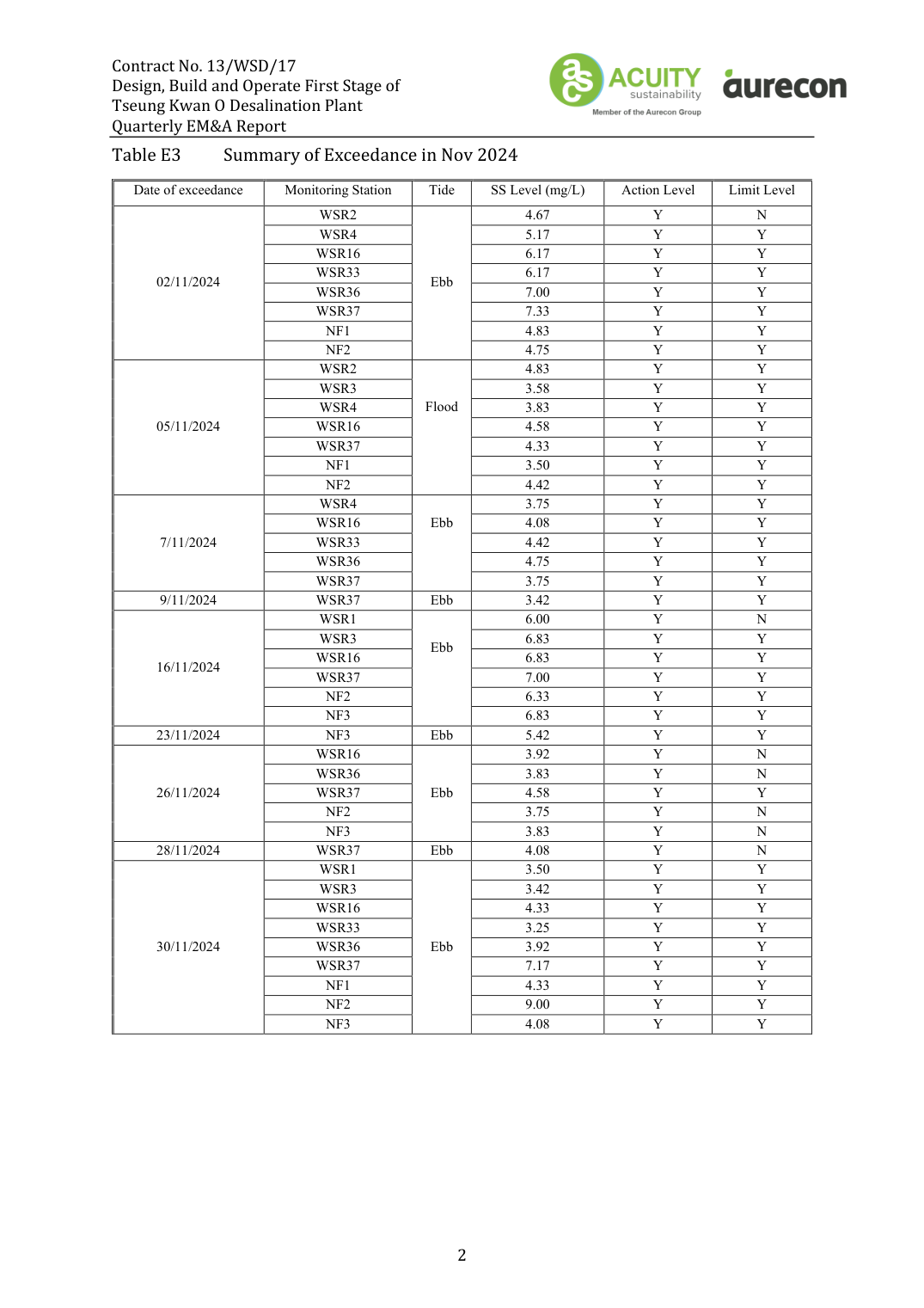

Summary Table for Exceedance in the Reporting Period

Environmental Monitoring

Parameter

No. of non- Project related exceedance

Total No. of non-Project related exceedance

No. of Project related exceedance

Total No. of Project related exceedance

AL

LL

AL

LL

Noise

L eq (30min)

N/A

N/A

N/A

N/A

N/A

N/A

Water

DO

0

0

0

0

0

0

Turbidity

0

0

0

0

0

0

Environmental Monitoring

Parameter

No. of non- Project related exceedance

Total No. of non-Project related exceedance

No. of Project related exceedance

Total No. of Project related exceedance

AL

LL

AL

LL

SS

36

85

121

0

0

0

pH

0

0

0

0

0

0

Salinity

0

0

0

0

0

0

TRC

0

0

0

0

0

0

Landfill Gas

O 2

0

0

0

0

0

0

CH 4

0

0

0

0

0

0

CO 2

0

0

0

0

0

0

Continuous Monitoring of Effluent Quality

Temperature

0

0

0

0

0

0

pH

0

0

0

0

0

0

Salinity

0

0

0

0

0

0

Total Residual Chlorine

0

0

0

0

0

0

Suspended Solids

0

0

0

0

0

0

Iron-Soluble

0

0

0

0

0

0

Total Inorganic Nitrogen

0

0

0

0

0

0

Total Phosphorus

0

0

0

0

0

0

Sodium Metabisulphite

0

0

0

0

0

0

Anti-scalant as Reactive Phosphorus*

0

0

0

0

0

0

Coral Monitoring

/

0

0

0

0

0

0

Fisheries Monitoring

/

N/A

N/A

N/A

N/A

N/A

N/A

*Remark: Anti-scalant water quality testing will only be conducted whenever anti-scalant dosage is adopted.

COMPLAINT HANDLING AND PROSECUTION

A19. No environmental complaint was received during the reporting period. No notifications of summons or prosecution was received during the reporting period.

REPORTING CHANGE

A20. There was no change to be reported that may affect the on-going EM&A programme.

A21. According to the contractor’s information, the TKODP commenced operation phase on 1 July 2024. The outstanding construction works were being carried out during this reporting period.

BASIC PROJECT INFORMATION

1.1. BACKGROUND

The Acciona Agua, S.A. Trading, Jardine Engineering Corporation Limited and China State Construction Engineering (Hong Kong) Limited and as AJC Joint Venture (AJCJV) is contracted to carry out the Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (TKODP) under Contract No. 13/WSD/17 (the Contract).

Acuity Sustainability Consulting Limited (ASCL) is commissioned by AJCJV to undertake the Environmental Team (ET) services as required and/or implied, both explicitly and implicitly, in the Environmental Permit (EP), Environmental Impact Assessment Report (EIA Report) (Register No. AEIAR-192/2015) and Environmental Monitoring and Audit Manual (EM&A Manual) for the Contract; and to carry out the Environmental Monitoring and Audit (EM&A) programme in fulfillment of the EIA Report’s EM&A requirements and Contract No. 13/WSD/17 Specification requirements.

Pursuant to the Environmental Impact Assessment Ordinance (EIAO), the Director of Environmental Protection granted the Environmental Permit (No. EP-01/503/2015) and Variation of Environmental Permit (No. EP-01/503/2015/B) to Water Supplies Department (WSD); and granted the Further Environmental Permit (No. FEP-01/503/2015/B) to AJCJV for the Contract.

1.2. THE REPORTING SCOPE

This is the 19th Quarterly EM&A Report for the Project which summarizes the key findings of the EM&A programme during the reporting period from 1 September 2024 to 30 November 2024.

1.3. PROJECT ORGANIZATION

The Project Organization structure for Construction Phase is presented in Figure 1.1.

Figure 1.1

Project Organization Chart

Aurecon Hong Kong Limited

Contact details of the key personnel are presented in Table 1.1 below:

Table 1.1

Contact Details of Key Personnel

Party

Position

Name

Telephone no.

Remark

Project Proponent

SE/CM2

Milton Law

2634-3573

/

Supervising Officer (Binnies Hong Kong Limited)

Project Manager

Augustine Li

2608-7671

/

Chief Resident Engineer

David Wong

5229-8638

/

The Jardine Engineering Corporation, Limited, China State Construction Engineering (Hong Kong) Limited and Acciona Agua, S.A. Trading

Project Manager

Stephen Yeung

2807-4665

/

Environmental Monitoring Manager

Brian Kam

9456-9541

/

Operation Manager

Arnes Parra, Victor

6468-6710

/

Environmental Monitoring Manager

Tommy Law

6468-1782

/

Aurecon Hong Kong Limited

Environmental Team Leader

Toby Wan

9719-5422

/

Lam Environmental Services Limited

Independent Environmental Checker (IEC)

Serena Shek

6149-6683

/

1.4. SUMMARY OF CONSTRUCTION WORKS

Details of the major construction activities undertaken in this reporting period are shown as below. The construction programme is presented in Appendix A.

Administration Building

• External wall aluminum features installation •

Finishing works for dog house

• Minor Installation of building services, electrical switchboards & cables, Pressure Test, T&C

• Installation of AP Door, Wall finishing, Ceiling, Tile, Internal partition wall, cat ladder, wood decking;

• Painting works and external finishing works;

• Minor Installation of minor cables laying and termination, T&C, and electrical switchboards & cables

Aurecon Hong Kong Limited

• External wall aluminum features installation

PWST

• Water Test in Tank A

• Waterproofing work at Roof Slab on Tank A •

Installation of building services, electrical switchboards and cables •

Installation of mechanical equipment, steel pipe, Pressure Test

Chemical building

• Defect rectification

• Repairing the defects inside the dangerous store

Combined Shaft & Pump House

• Internal finishing, defect rectification •

Construction of hose reel cabinet

• T&C

ActiDAFF

• Installation of access opening covers for filtered water tank •

Carrying out finishing works for staircase no. 3.

• Minor Installation of mechanical equipment, piping system •

Minor Installation of building services, electrical switchboards and cables, Installation of FRP Enclosure System

Product Water Storage Tank Building

• Minor Installation of building services, cable laying and termination, PV Panel Installation, Testing & Commissioning

OSCG Building

• Protective Coating for DG Rooms

• Installation of Railing on Brine Maker Tank •

Minor Installation of building services, cables and pipe works, T&C •

Tank surface cleaning, T&C

Reverse Osmosis Building

• Installation of Signage, AP doors, sanitary fitting, sanitary ware in toilet, tiling work and water meter cabinets

• Minor Installation of building services, minor cable laying and termination, Testing &

Commissioning, PV Panel Installation

Post Treatment Building

• Installation of Cat Ladders in Water Tanks •

Placing Soil Mix at Roof

• Curb Construction for Rescue Opening at Water Tanks •

Installation of building services, piping system, mechanical equipment and piping system, Pressure Test

Aurecon Hong Kong Limited

Inspection gallery

• Interior fitting out works and painting works •

Minor Installation of building services, Lift Installation, T&C •

Construction of roof tiling works

• Installation of steel balustrade at roof •

Installation of movement joints

• Construction of block works

• Construction of roof tiling works

RO and Electrical Building

• Installation of Glass House

• Minor Installation of building services, electrical switchboards and cables •

Minor Installation of mechanical pipework and raised Floor, •

PV Panel Installation, T&C

Chiller plant & Main Electrical Building

• Minor Installation of building services, electrical switchboards and cables, Pressure Test, T&C

Others

• Slope works*

• Construction works of extended access road Remark: *The slope works were completed in October 2024, and there were no site activities related to the slope works conducted in November 2024.

1.5. SUMMARY OF ENVIRONMENTAL STATUS

A summary of the valid permits, licences, and /or notifications on environmental protection for this Project is presented in Table 1.2.

Aurecon Hong Kong Limited

Table 1.2

Summary of the Status of Valid Environmental Licence, Notification, Permit and Documentations

Permit/ Licences

Valid Period

Status

Remark

From

To

Environmental Permit

EP – 503/2015/B

Throughout the Contract

Valid

-Issued on 3 April 2024

FEP – 01/503/2015/B

Throughout the Contract

Valid

-Issued on 3 April 2024

Notification of Construction Works under the Air Pollution Control (Construction Dust) Regulation (Form NA)

451539

Throughout the Contract

Valid

-

Billing Account for Disposal of Construction Waste

7036276

Throughout the Contract

Valid

-

Sludge (Special Waste) Disposal (Admission Ticket)

17674

12/06/2024

31/12/2024

Valid

-

17913

01/07/2024

24/12/2024

Valid

-

Chemical Waste Producer Registration

5213-839-A2987-01

Throughout the Contract

Valid

-

Wastewater Discharge Licence (Land and Marine works)

WT00035775-2020

23/08/2021

31/07/2025

Valid

-

WT00044188-2023

16/06/2023

30/06/2028

Valid

- For Plant T&C and operation. - Variation of sampling point S.P.1 is approved by the EPD on 25 June 2024. (EPD ref.: EP640/W3/D1358/462874).

Construction Noise Permit

GW-RE0667-24

22/06/2024

20/12/2024

Valid

-

The status for all environmental aspects is presented in Table 1.3 Aurecon Hong Kong Limited

Table 1.3

Summary of Status for Key Environmental Aspects under the EM&A Manual

Parameters

Status

Water Quality

Baseline Monitoring under EM&A Manual

The baseline water quality monitoring was conducted between 12 May 2020 and 6 June 2020

Construction Phase Impact Monitoring

Ceased from 1 September 2023

TRC Monitoring for Main Disinfection

Completed

Operation Phase Impact Monitoring

On-going

Continuous Monitoring of Effluent Quality

On-going, the plant was shut down from 7 a.m. to 7 p.m. on 3 November 2024. No effluent discharge from TKODP occurred during this period. Due to the plant has suspended production, there was no effluent discharge from the TKODP during the period between 24 November 2024 and 30 November 2024.

Noise

Baseline Monitoring

The baseline noise monitoring result has been reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4

Impact Monitoring

Completed

Waste Management

Mitigation Measures in Waste Management Plan

On-going

Landfill Gas

(Construction Phase) Regular Monitoring when Construction Works are within the 250m Consultation Zone

In this reporting period, 132 times of Construction Phase landfill gas monitoring were recorded at Wan Po Road (Ch0+390 – Ch0+780) and (Ch0+400 - Ch1+200). No exceedance of action or limit level for methane, oxygen and carbon dioxide was observed. Construction Phase landfill gas monitoring were ceased from 31 October 2024.

(Operation Phase) Monthly Monitoring for buildings, manholes and utility pits within the Project Site and along the fresh water mains

In this reporting period, Operation Phase landfill gas monitoring was conducted on 25, 26, 27 September 2024, 9, 10 October 2024 and 14, 15 November 2024. No exceedances of action level and limit level was observed.

Ecology (Coral)

Operation phase Regular Coral Monitoring (Monthly)

Operation phase coral monitoring works was conducted on 18 September 2024, 21 October 2024 and 11 November 2024.

Aurecon Hong Kong Limited

Parameters

Status

There is no AL/LL exceedance during the monitoring period.

Ecology (Fishery)

Operation phase Regular Fishery Monitoring (Seasonally)

Operation phase fishery monitoring for wet season 2024 was carried out on 24 and 31 August 2024.

Ecology (Landscape)

Operation phase Landscape and Visual Site Inspection

On-going

Environmental Audit

Site Inspection covering Measures of Air Quality, Noise Impact, Water Quality, Waste, Ecological Quality, Fisheries, Landscape and Visual

On-going

Other than the EM&A work by ET, environmental briefings, trainings and regular environmental management meetings were conducted, in order to enhance environmental awareness and closely monitor the environmental performance of the contractors.

The EM&A programme has been implemented in accordance with the recommendations presented in the approved EIA Report and the EM&A Manual. A summary of implementation status of the environmental mitigation measures for the construction phase and operation phase of the Project during the reporting period is provided in Appendix C.

Aurecon Hong Kong Limited

NOISE

2.1. MONITORING REQUIREMENTS

To ensure no adverse noise impact, construction noise monitoring is recommended to be carried out within 300m radius from the nearby noise sensitive receivers (NSRs), during construction phase. The NSRs selected as monitoring station are (i) NSR4 – Creative Secondary School, (ii) NSR24 – PLK Laws Foundation College, and (iii) NSR31 – School of Continuing and Professional Studies – CUHK respectively.

No impact construction noise monitoring was conducted in the reporting period due to the overly distant monitoring station from the works location, where they were farther than 1 km from the closet monitoring station NSR4 to the works location.

2.2. MONITORING PARAMETERS, FREQUENCY AND DURATION

Construction noise level would be measured in terms of the A-weighted equivalent continuous sound pressure level (LAeq). Leq 30min was used as the monitoring parameter for the time period between 0700 and 1900 on normal weekdays. Table 2.1 summarizes the monitoring parameters, frequency and duration of the impact noise monitoring.

Table 2.1

Noise Monitoring Parameters, Time, Frequency and Duration

Time

Duration

Interval

Parameters

Daytime: 0700-1900

Day time: 0700-1900 (during normal weekdays)

Continuously in L /L (average of eq 5min eq 30min 6 consecutive L ) eq 5min

L eq30min L & L 1030min 9030min

2.3. MONITORING LOCATIONS

The monitoring locations should normally be made at a point 1m from the exterior of the NSRs building façade and be at a position 1.2m above the ground. A correction of +3dB(A) should be made to the free-field measurements.

According to the environmental findings detailed in the EIA report and Baseline Monitoring Report, the designated locations for the construction noise monitoring are listed in Table 2.2 below.

Table 2.2

Noise Sensitive Receivers

NSR ID

Noise Sensitive Receivers

Monitoring Location

Position

NSR 4

Creative Secondary School

Roof Floor

1 m from facade

NSR 24

PLK Laws Foundation College

Pedestrian Road on Ground Floor

Free-field

NSR 31

School of Continuing and Professional Studies - CUHK

Roof Floor

1 m from facade

Aurecon Hong Kong Limited

The monitoring locations should normally be made at a point 1m from the exterior of the NSRs building façade and be at a position 1.2m above the ground. A correction of +3dB(A) should be made to the free-field measurements. Three noise monitoring locations for impact monitoring at the nearby sensitive receivers are shown in Figure 2.1-2.3.

Figure 2.1 NSR4 Creative Secondary School

Figure 2.2 NSR24 PLK Laws Foundation College

Aurecon Hong Kong Limited

Figure 2.3 NSR31 School of Continuing and Professional Studies - CUHK

2.4. ACTION AND LIMIT LEVELS

The Action/Limit Levels are in line with the criteria of Practice Note for Professional Persons (ProPECC PN 2/93) “Noise from Construction Activities – Non-statutory Controls” and Technical Memorandum on Environmental Impact Assessment Process issued by HKSAR Environmental Protection Department [“EPD”] under the Environmental Impact Assessment Ordinance, Cap 499, S.16 are presented in Table 2.3.

Table 2.3 Action and Limit Levels for Construction Noise Monitoring per EM&A Manual

Time Period

Action Level

Limit Level (dB(A))

0700-1900 on normal weekdays

When one documented complaint is received from any one of the noise sensitive receivers

• 70 dB(A) for school and • 65 dB(A) during examination period

Notes: Limits specified in the GW-TM and IND-TM for construction and operation noise, respectively.

If exceedances were found during noise monitoring, the actions in accordance with the Event and Action Plan shall be carried out according to Appendix E.

Aurecon Hong Kong Limited

2.5. MONITORING RESULTS AND OBSERVATIONS

Referring to EM&A manual Section 4.1.2, the impact noise monitoring should be carried out when there are project-related construction activities undertaken within a radius of 300m from the monitoring stations. As no Contract-related construction activities were undertaken in the reporting period within a radius of 300m from the monitoring stations of the Project site as shown in Figure 2.4, no impact noise monitoring was conducted in the reporting period.

Figure 2.4

Site Layout Plan with Noise Sensitive Receivers and Desalination Plant

Aurecon Hong Kong Limited

WATER QUALITY

In accordance with the recommendations of the EIA, water quality monitoring is required during dredging for the submarine pipelines and, during operation phase. In addition, baseline water quality monitoring was conducted prior to the commencement of marine construction activities.

The following Section provides details of the water quality monitoring to be undertaken by the Environmental Team (ET) to verify the distance of sediment and brine plume dispersion and to identify whether the potential exists for any indirect impacts to occur to ecological sensitive receivers. The water quality monitoring programme was carried out to allow any deteriorating water quality to be readily detected and timely action taken to rectify the situation.

Water quality monitoring for the Project can be divided into the following stages:

• Dredging activities during construction phase;

• Discharge of effluent from main disinfection during construction phase;

• Operation phase – first year upon operation; and, •

Continuous monitoring of effluent quality.

3.1. WATER QUALITY PARAMETERS

Parameters to be measured in the marine water quality monitoring and the Continuous Monitoring of Effluent Quality are listed in Table 3.1 and Table 3.2 respectively.

a) Operation phase Marine Water Quality Monitoring The parameters that have been selected for measurement in situ and in the laboratory are those that were either determined in the EIA to be those with the most potential to be affected by the operation works or are a standard check on water quality conditions. Parameters measured in the monitoring are listed in Table 3.1

Table 3.1

Parameters measured in the marine water quality monitoring

Parameters

Unit

Abbreviation

In-situ measurements

Dissolved oxygen

mg/L

DO

Temperature

oC

-

pH

pH

-

Turbidity

NTU

-

Salinity

0/ 00

-

Total Residual Chlorine

mg/L

TRC

Total Residual Chlorine (Disinfection)

mg/L

TRC

Laboratory measurements

Suspended Solids

mg/L

SS

Iron

mg/L

Anti-scalant

mg/L

-

Aurecon Hong Kong Limited

NOTE 1: Monitoring of Total Residual Chlorine (Disinfection) will be conducted when cleaning and sterilization of the new freshwater main is carried out.

b) Continuous Monitoring of Effluent Quality

The monitoring requirement for the continuous effluent quality monitoring shall be conducted in accordance with the effluent parameters and standards stipulated by the Water Pollution Control Ordinance Discharge License (No.: WT00044188-2023) conditions.

Table 3.2

Parameters measured in the Continuous Monitoring of Effluent Quality

Parameters

Unit

Abbreviation

In-situ measurements

Temperature

oC

-

pH

pH

-

Salinity

0/00

-

Total Residual Chlorine

mg/L

TRC

Laboratory measurements

Suspended Solids

mg/L

SS

Iron-Soluble

mg/L

Fe

Total Inorganic Nitrogen

mg/L

-

Total Phosphorus

mg/L

-

Sodium Metabisulphite

mg/L

SMBS

Anti-scalant as Reactive Phosphorus *

mg/L

PO4 as P-

*Remark: Anti-scalant water quality testing will only be conducted whenever anti-scalant dosage is adopted.

In addition to the water quality parameters, other relevant data were measured and recorded in Water Quality Monitoring Logs, including the location of the sampling stations, water depth, time, weather conditions, sea conditions, tidal stage, current direction and velocity, special phenomena and work activities undertaken around the monitoring and works area that may influence the monitoring results.

3.2. MONITORING LOCATIONS

a) Operation phase Marine Water Quality Monitoring The water quality monitoring locations are detailed in Table 3.2 and shown in Figure 3.1 below.

Table 3.3

Location of Water Quality Monitoring Station

Station

Easting

Northing

Description

CE

843550

815243

Upstream control station at ebb tide

CF

846843

810193

Upstream control station at flood tide

WSR1

846864

812014

Ecological sensitive receiver at Tung Lung Chau

WSR2

847645

812993

Fisheries sensitive receiver at Tung Lung Chau

WSR3

848023

813262

Ecological sensitive receiver at Tung Lung Chau

WSR4

847886

814154

Ecological sensitive receiver at Tai Miu Wan

Aurecon Hong Kong Limited

WSR16

845039

815287

Ecological sensitive receiver at Fat Tong Chau

WSR33

847159

814488

Ecological sensitive receiver at Tai Miu Wan

WSR36

846878

814081

Ecological sensitive receiver at Kwun Tsai

WSR37

846655

813810

Ecological sensitive receiver at Tit Cham Chau

NF1

846542

813614

Edge of mixing zone, ~ 200m west of outfall diffuser

NF2

846942

813614

Edge of mixing zone, ~ 200m east of outfall diffuser

NF3

846742

813414

Edge of mixing zone, ~ 200m south of outfall diffuser

NF3

846742

813414

Edge of mixing zone, ~ 200m south of outfall diffuser

Figure 3.1

Water Quality Monitoring Locations under EM&A Manual

b) Continuous Monitoring of Effluent Quality

In accordance with the discharge license, the Continuous Monitoring shall be sampling at Brine Outfall Shaft.

Aurecon Hong Kong Limited

Figure 3.2

Continuous Monitoring locations

3.3. MONITORING EQUIPMENT, METHODOLOGY AND QA/QC PROCEDURES

The monitoring methodology, equipment used, and QA/QC procedures could be referred to Section 3.1.2 -3.1.4, 3.1.6-3.1.7 and 3.2 of the Monthly EM&A Report.

3.4. ACTION AND LIMIT LEVELS

The Action and Limit Levels have been set based on the derivation criteria specified in the EM&A Manual. The Action/Limit Levels have been derived and are presented in Table 3.4 and Table 3.5.

a) Operation phase Marine Water Quality Monitoring Table 3.4

Derived Action and Limit Levels for Water Quality

Parameters

Action

Limit

Operation Phase Monitoring

DO in mg/L

Surface and Middle 7.30 mg L-1 Bottom 7.31 mg L-1 Tung Lung Chau Fish Culture Zone 5.1 mgL-1 or level at control station (Whichever the lower)

Surface and Middle 4 mg L-1 Bottom 2 mg L-1 Tung Lung Chau Fish Culture Zone 5.0 mgL-1 or level at control station (Whichever the lower)

Aurecon Hong Kong Limited

Parameters

Action

Limit

Operation Phase Monitoring

SS in mg/L (Depth- averaged)

5.00 mg L-1 or 20% exceedance of value at any impact station compared with corresponding data from control station

6.00 mg L-1 or 30% exceedance of value at any impact station compared with corresponding data from control station

Turbidity in NTU (Depth- averaged)

2.41 NTU or 20% exceedance of value at any impact station compared with corresponding data from control station

2.84 NTU or 30% exceedance of value at any impact station compared with corresponding data from control station

Salinity in PSU (Depth- averaged)

34.28 PSU or 9% exceedance of value at any impact station compared with corresponding data from control station

34.60 PSU or 10% exceedance of value at any impact station compared with corresponding data from control station

Iron in mg/L (Depth- averaged)

0.3 mg/L

0.3 mg/L

Total residual chlorine in mg/L

0.01 mg/L

0.01 mg/L

Total residual chlorine in mg/L (Disinfection)

0.1 mg/L

0.1 mg/L

Notes:

i.

"Depth-averaged" is calculated by taking the arithmetic means of reading of all three depths.

ii.

For DO, non-compliance of the water quality limits occurs when monitoring result is lower than the limits.

iii.

For Turbidity, SS, iron and Salinity, non-compliance of the water quality limits occurs when monitoring result is higher than the limits.

b) Continuous Monitoring of Effluent Quality

Parameters

Limit

Continuous Monitoring of Effluent Quality

Flow Rate in m3/day

216841

Temperature in °C

Maximum 40

Salinity

71347

SS in mg/L

13

pH

6-9

Iron in mg/L

0.6

Total residual chlorine in mg/L

0.1

Total Inorganic Nitrogen in mg/L

2

Total Phosphorous in mg/L

1

Aurecon Hong Kong Limited

Parameters

Limit

Continuous Monitoring of Effluent Quality

Sodium Metabisulphite in mg/L

0.5

Anti scalant in mg/L*

2.2

*Remark:

1. Anti-scalant water quality testing will only be conducted whenever anti-scalant dosage is adopted.

3.5. MONITORING RESULTS AND OBSERVATIONS

Construction Phase

Referring to EM&A Manual, the general water quality monitoring should be carried out when there are marine-related construction activities undertaken. General water quality monitoring at the ten monitoring stations (CE, CF, WSR1, WSR2, WSR3, WSR4, WSR16, WSR33, WSR36 and WSR37) was ceased from 1 September 2023 due to the completion of marine-related construction works.

Operation Phase

The first-year operation phase marine water quality monitoring was carried out during the reporting period, the monitoring was conducted at the thirteen monitoring stations (CE, CF, WSR1, WSR2, WSR3, WSR4, WSR16, WSR33, WSR36, WSR37, NF1, NF2 and NF3). The Action and Limit Level would be referred to the approved EM&A Manual Table 5.4 First-year Operation Phase Marine Water Monitoring.

The operation phase marine water quality monitoring was conducted on 3, 7, 10, 12, 14, 17, 19, 21, 24, 26 and 28 September 2024 , 1, 3, 5, 8, 10, 12, 15, 17, 19, 22, 24, 26, 29 and 31 October 2024 and 2, 5, 7, 9, 12, 16, 19, 21, 23, 26, 28 and 30 November 2024. The result of the reporting quarterly is presented in Table 3.6.

Thirty-six (36) of the operation phase marine water quality monitoring results of SS obtained had exceeded the Action Level. Eighty-five (85) of the operation phase water quality monitoring results of SS obtained during the reporting period had exceeded the Limit Level.

Investigation on the reason of exceedance has been carried out, where the exceedances of SS were concluded to be unrelated to the Contract as detailed in the Incident Reports on Action Level or Limit Level. Summary of the exceedance is presented in Appendix E.

Continuous Monitoring of Effluent Quality Continuous Monitoring of Effluent Quality was conducted sampling point in the reporting period.

No exceedance of the sampling was obtained during the reporting period had exceeded the Limit Level. The detailed results are summarized in Table 3.7.

The plant was shut down from 7 a.m. to 7 p.m. on 3 November 2024. No effluent discharge from TKODP occurred during this period.

Due to the plant has suspended production, there was no effluent discharge from the TKODP during the period between 24 November 2024 and 30 November 2024.

Aurecon Hong Kong Limited

Quarterly EM&A Report No.19

Table 3.6

Summary of Operation Phase Water Quality Monitoring Results

Location

Parameter

Salinity (ppt)

Dissolved Oxygen (mg/L)

pH

Turbidity (NTU)

Suspended Solids (mg/L)

Temp. (oC)

TRC (mg/L)

Iron (mg/L)

Surface & Middle

Bottom

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

CE

Avg.

32.49

32.40

32.06

8.71

8.90

8.48

8.73

8.89

8.51

8.14

8.19

8.18

2.52

2.44

2.41

3.41

4.60

3.29

28.84

28.64

26.55

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

31.63

30.94

31.27

8.12

7.90

8.05

8.04

7.89

8.05

8.03

8.08

8.00

1.98

2.01

2.05

2.50

2.50

2.50

27.94

27.78

25.10

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

33.66

33.12

33.14

9.54

9.64

8.98

9.58

9.67

8.96

8.27

8.31

8.36

2.85

2.79

2.69

7.00

37.00

6.00

29.85

29.38

27.57

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

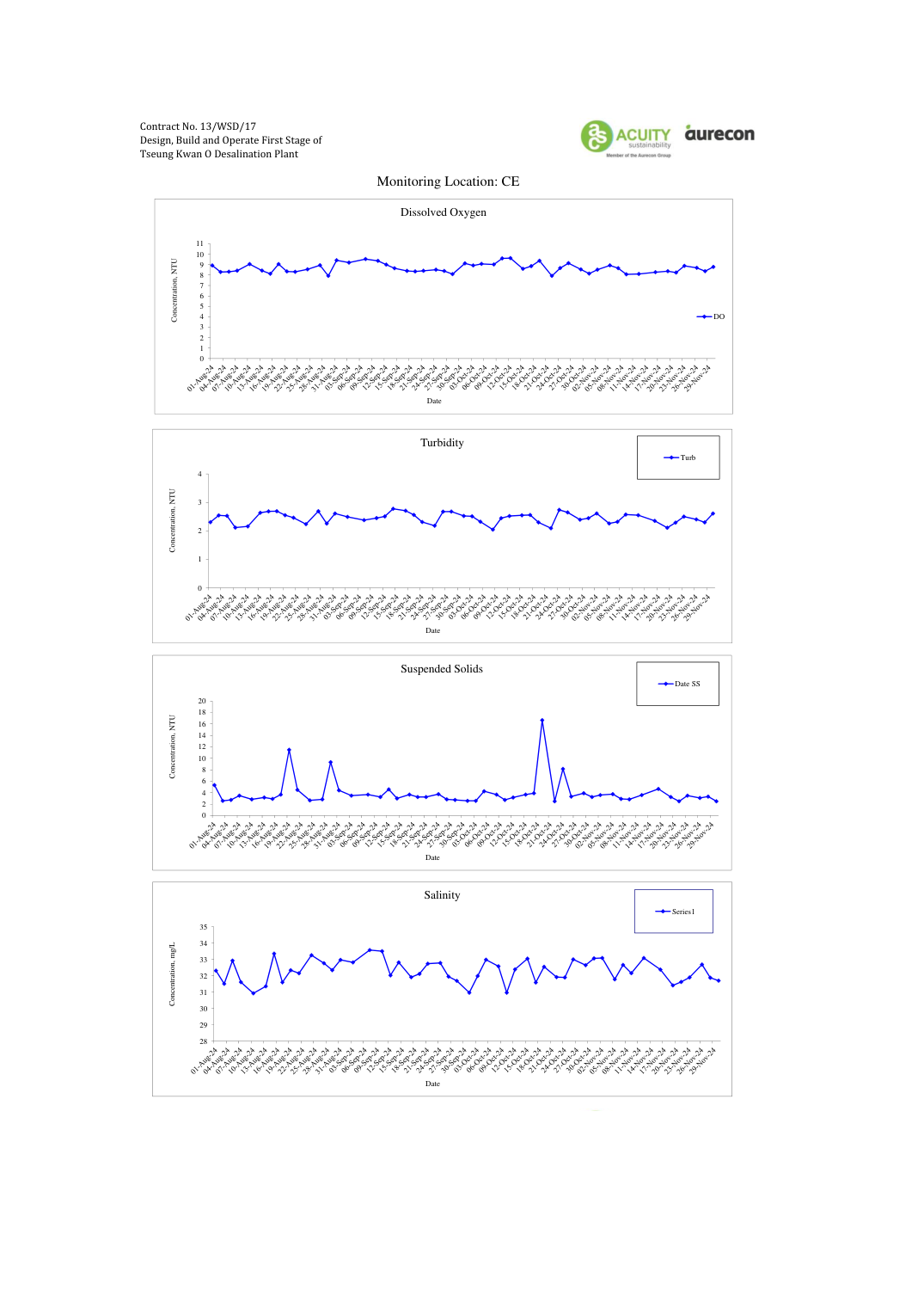

CF

Avg.

32.19

32.55

32.14

8.62

8.83

8.69

8.60

8.82

8.69

8.27

8.24

8.14

2.40

2.28

2.32

3.55

7.68

3.76

28.94

28.65

26.41

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

31.20

31.71

31.52

7.91

7.98

8.12

7.92

7.80

8.04

8.12

8.09

7.94

2.13

1.86

2.06

2.00

2.50

2.50

28.02

27.81

25.06

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

33.55

33.56

33.23

9.57

9.84

9.21

9.51

9.74

9.26

8.40

8.40

8.41

2.96

2.68

2.66

9.00

86.00

8.00

29.98

29.38

27.59

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

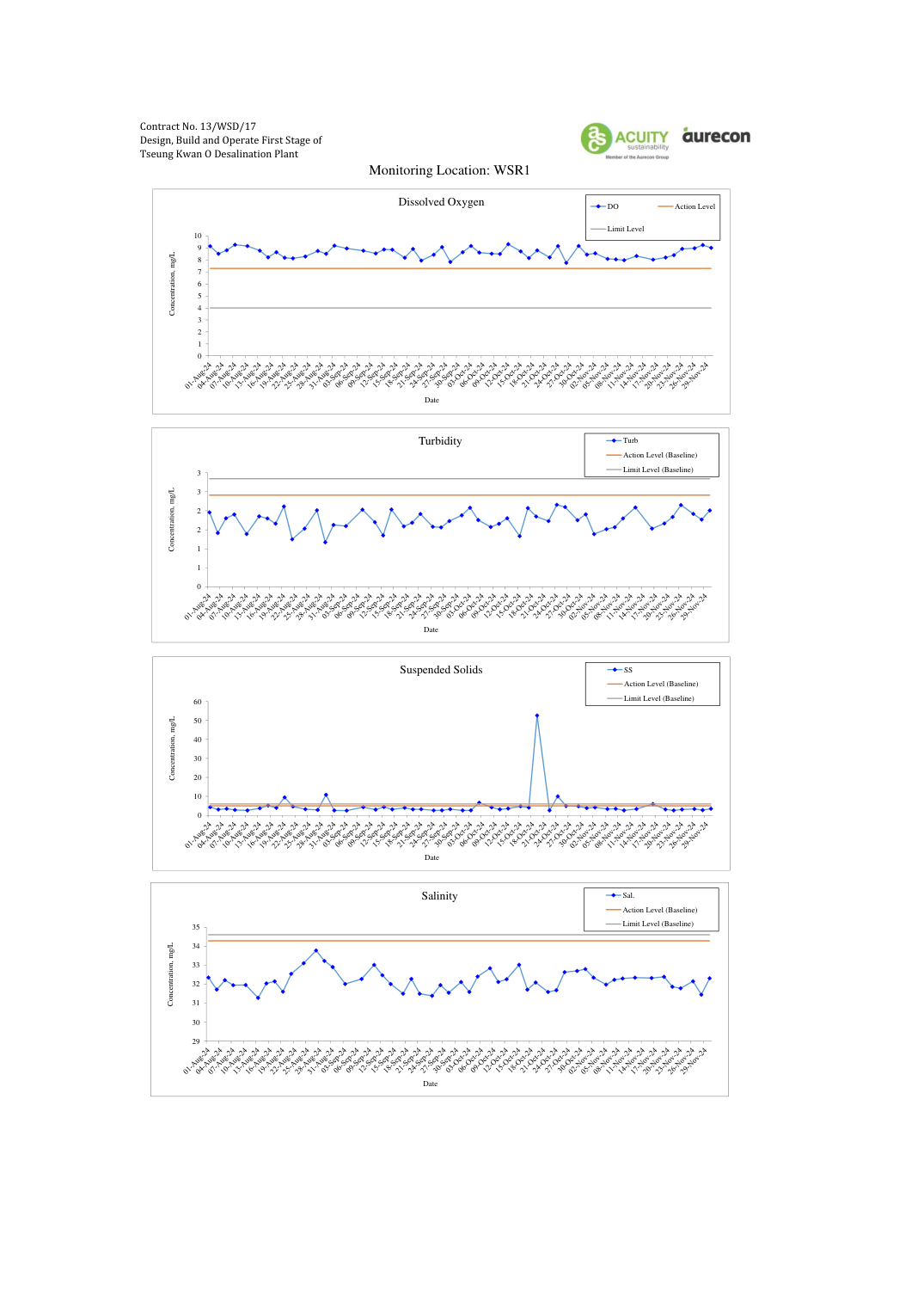

WSR1

Avg.

31.97

32.21

32.07

8.59

8.67

8.48

8.60

8.67

8.50

8.19

8.24

8.17

1.71

1.83

1.77

3.30

7.90

3.44

28.91

28.60

26.55

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

31.33

31.41

31.40

7.81

7.70

7.96

7.80

7.72

7.95

8.08

8.05

7.98

1.32

1.30

1.34

2.50

2.50

2.50

28.14

27.73

25.25

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

33.09

33.04

32.42

9.08

9.36

9.22

9.13

9.40

9.33

8.31

8.40

8.32

2.10

2.22

2.18

6.00

65.00

9.00

29.69

29.26

27.81

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

WSR2

Avg.

32.34

32.52

32.07

8.66

8.87

8.71

8.66

8.85

8.73

8.20

8.21

8.14

1.84

1.65

1.73

3.28

5.01

3.38

28.92

28.59

26.49

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

31.54

31.59

31.05

7.52

7.99

7.91

7.53

7.95

7.91

8.05

8.04

8.00

1.52

1.34

1.40

2.50

2.50

2.50

28.12

27.69

25.00

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

33.17

33.59

33.30

9.66

9.64

9.15

9.72

9.65

9.25

8.32

8.33

8.30

2.17

2.22

2.20

6.00

63.00

10.00

29.74

29.30

27.60

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

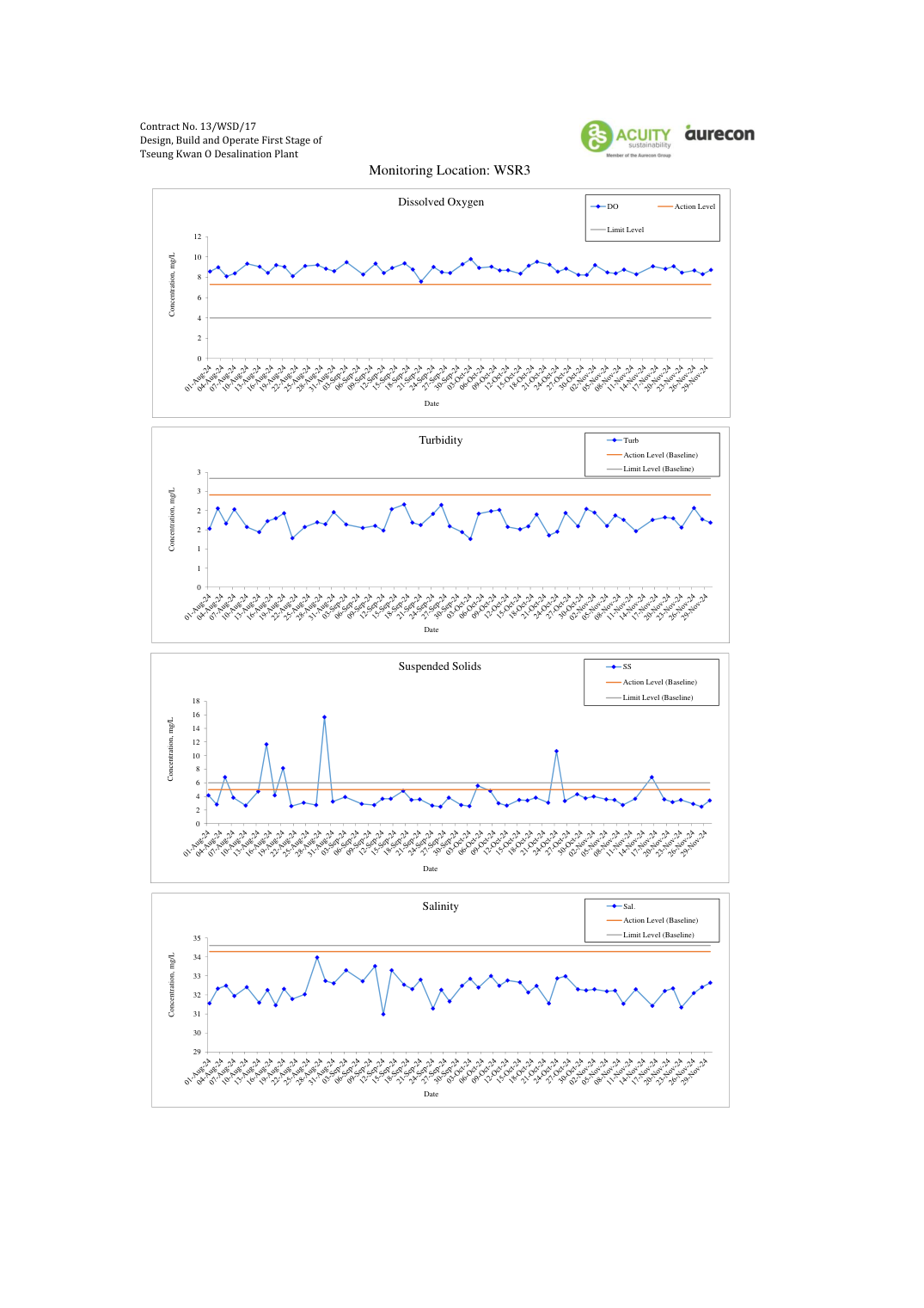

WSR3

Avg.

32.34

32.52

32.13

8.75

8.91

8.68

8.74

8.90

8.69

8.23

8.22

8.16

1.77

1.68

1.76

3.44

4.10

3.62

28.82

28.59

26.47

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

30.93

31.52

31.29

7.54

8.16

8.21

7.58

8.13

8.28

7.98

8.03

7.98

1.45

1.22

1.42

2.50

2.50

2.50

27.85

27.91

24.94

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

33.59

33.05

32.90

9.46

9.86

9.24

9.57

9.86

9.25

8.39

8.39

8.36

2.21

2.08

2.09

8.00

12.00

12.00

29.80

29.22

27.80

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

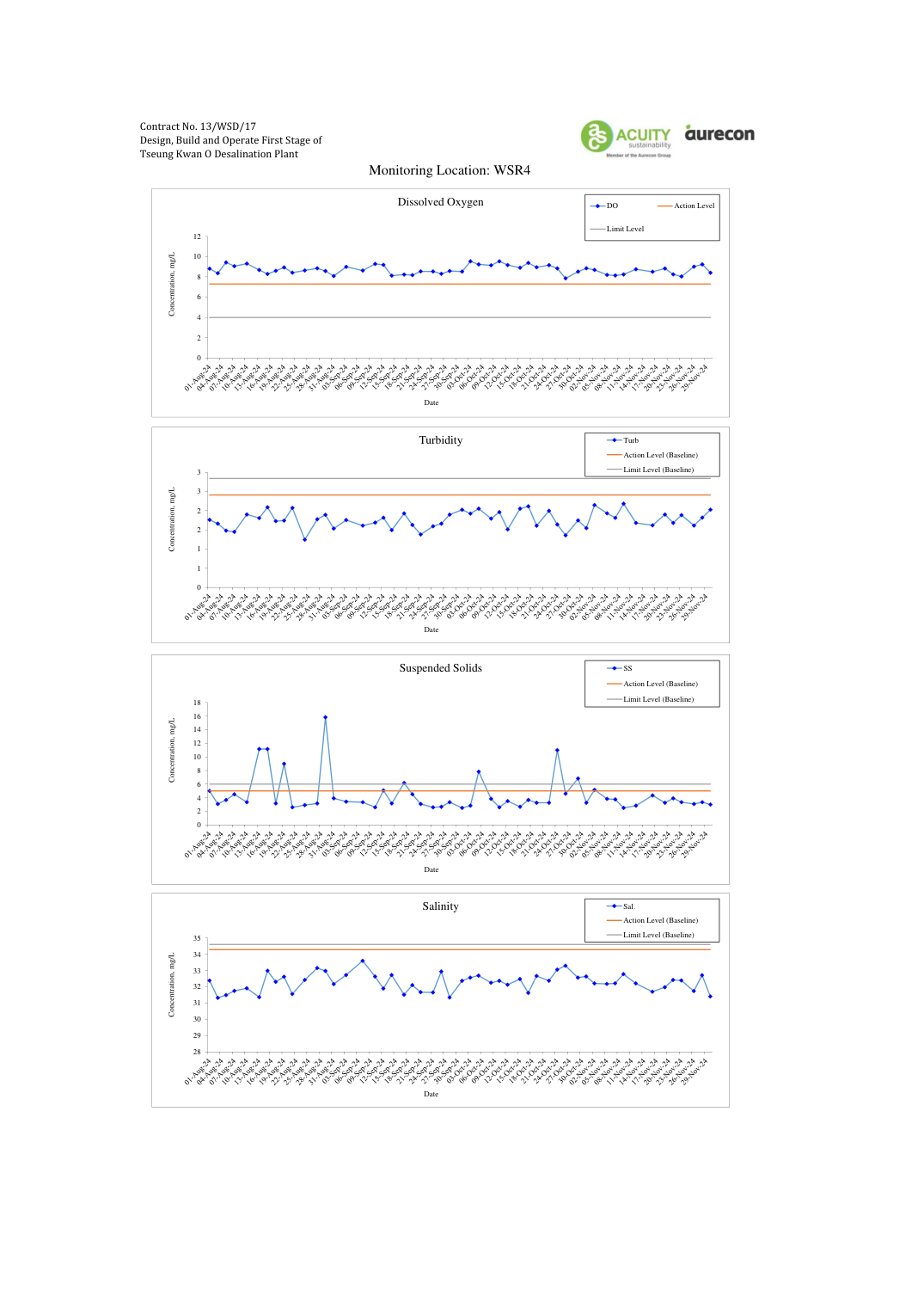

WSR4

Avg.

32.24

32.52

32.07

8.61

8.96

8.52

8.61

8.99

8.52

8.20

8.21

8.15

1.68

1.81

1.86

3.63

4.40

3.53

28.91

28.64

26.56

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

31.27

31.56

31.00

8.08

7.75

8.02

8.15

7.78

8.00

8.10

8.00

7.91

1.34

1.31

1.47

2.50

2.00

2.50

27.88

27.93

25.15

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

33.62

33.33

32.84

9.27

9.60

9.27

9.36

9.61

9.19

8.28

8.41

8.33

1.96

2.16

2.21

10.00

13.00

7.00

29.74

29.33

27.71

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

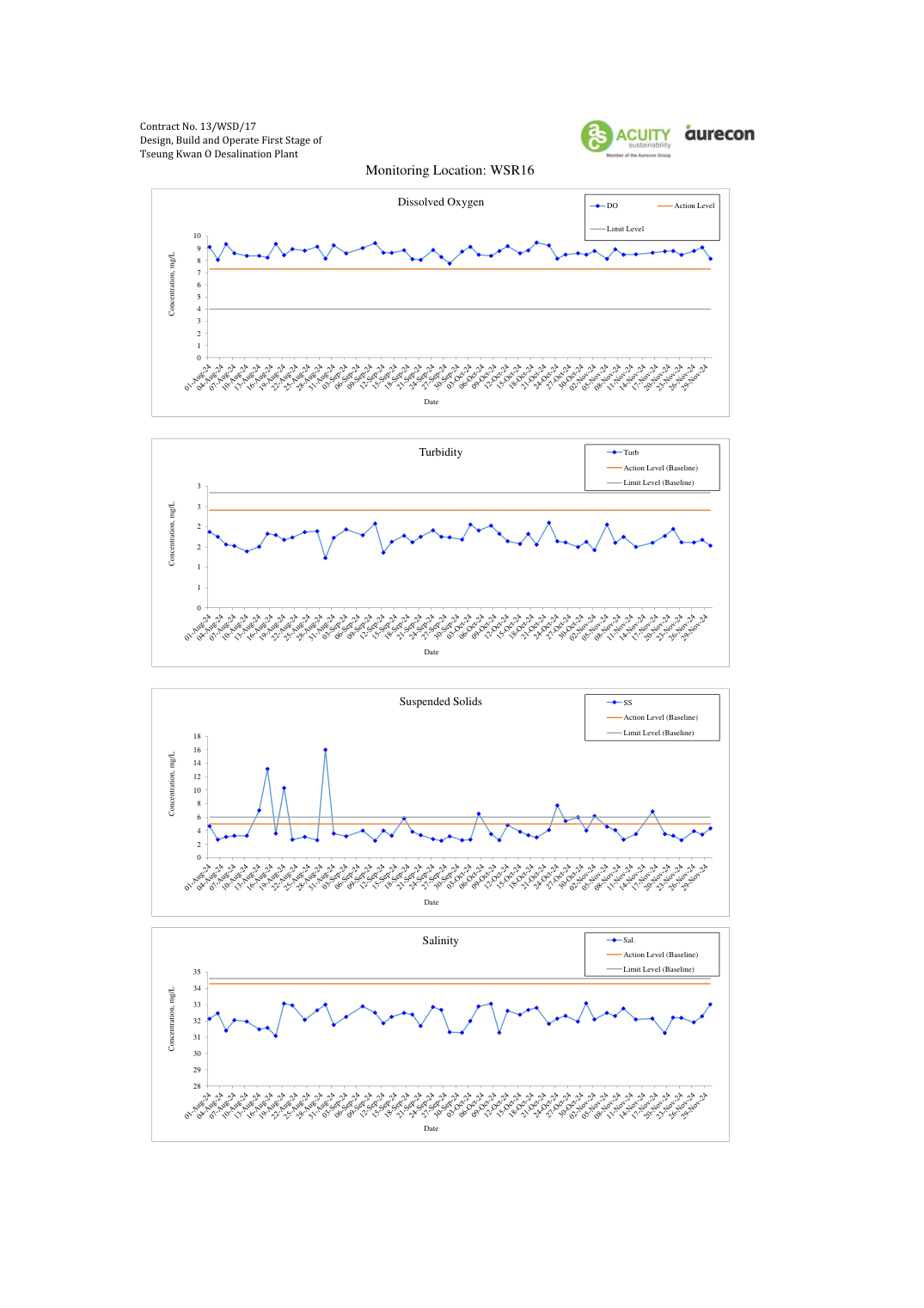

WSR16

Avg.

32.24

32.35

32.24

8.56

8.76

8.62

8.55

8.75

8.63

8.21

8.20

8.18

1.76

1.76

1.67

3.48

4.29

4.07

28.93

28.58

26.51

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

31.21

31.24

31.20

7.68

8.14

8.09

7.73

8.12

8.05

8.06

8.06

7.94

1.34

1.44

1.37

2.50

2.50

2.50

27.88

27.72

25.19

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

32.97

33.13

33.07

9.52

9.49

9.05

9.39

9.55

9.11

8.40

8.34

8.33

2.10

2.14

2.10

7.00

11.00

9.00

29.83

29.19

27.44

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

WSR33

Avg.

32.29

32.42

32.10

8.66

8.59

8.47

8.66

8.59

8.49

8.26

8.21

8.20

1.72

1.74

1.77

3.52

4.03

3.53

28.93

28.66

26.55

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

31.64

30.89

31.27

7.77

7.82

7.83

7.80

7.89

7.97

8.12

8.03

7.92

1.33

1.32

1.23

2.50

2.50

2.50

27.83

28.01

25.14

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

32.90

33.56

33.09

9.47

9.16

9.28

9.49

9.15

9.38

8.37

8.34

8.36

2.13

2.19

2.20

8.00

14.00

8.00

30.05

29.32

27.88

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

WSR36

Avg.

32.27

32.34

31.80

8.44

8.93

8.66

8.45

8.94

8.68

8.22

8.21

8.16

1.82

1.77

1.78

3.64

3.83

3.69

28.97

28.59

26.46

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

30.94

31.31

31.17

7.73

7.73

8.14

7.73

7.75

8.21

8.05

8.09

7.97

1.54

1.34

1.46

2.50

2.50

2.50

28.05

27.82

24.84

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

33.51

33.14

32.54

9.29

9.68

9.14

9.32

9.66

9.13

8.35

8.35

8.32

2.19

2.15

2.13

7.00

9.00

11.00

29.87

29.20

27.36

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

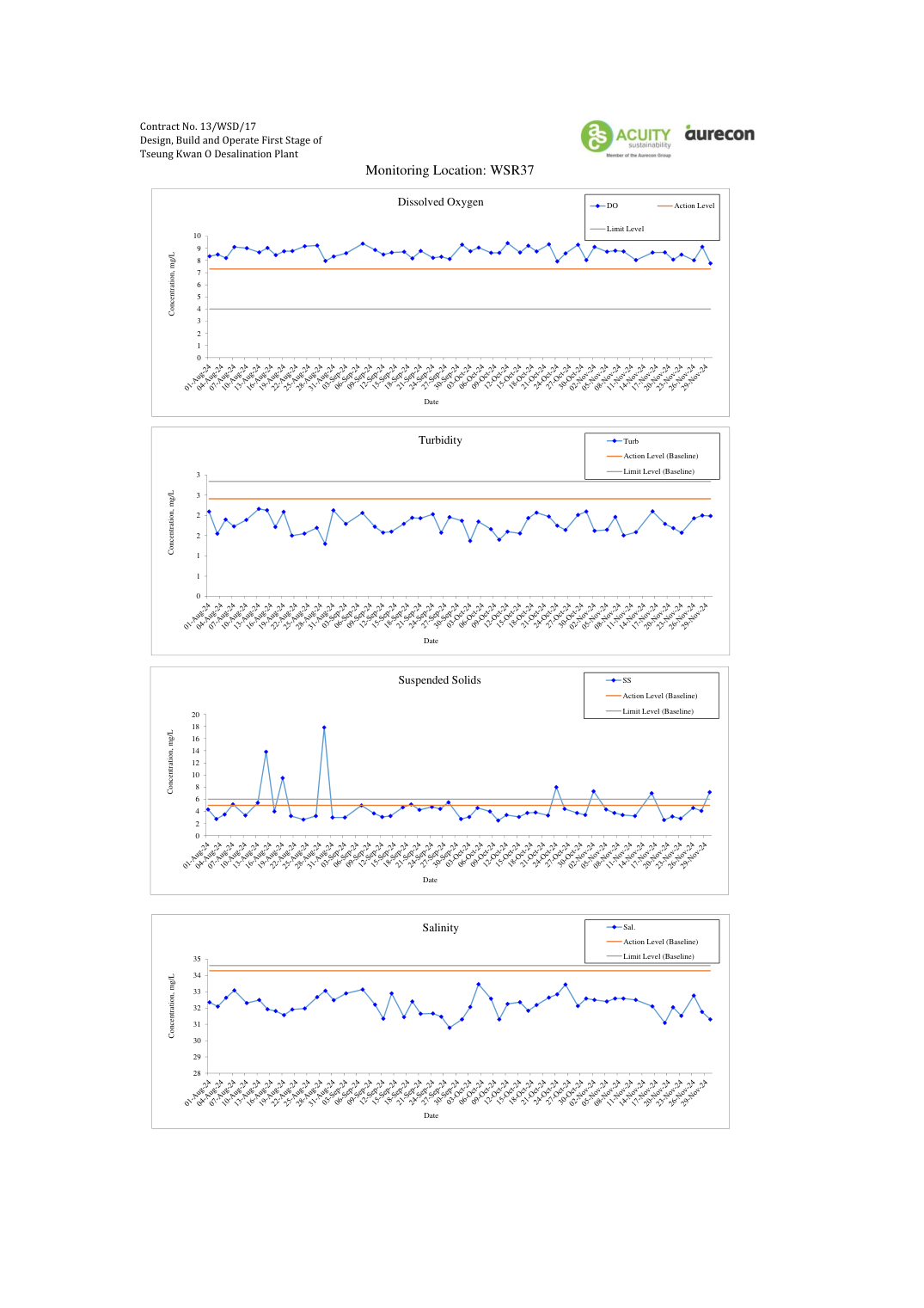

WSR37

Avg.

31.88

32.43

32.00

8.56

8.83

8.52

8.59

8.84

8.52

8.22

8.23

8.20

1.77

1.78

1.76

4.25

3.85

4.46

28.93

28.62

26.55

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

30.72

31.23

31.04

8.08

7.90

7.75

8.10

7.93

7.72

8.07

8.12

8.04

1.29

1.37

1.48

2.50

2.00

2.50

27.77

28.05

25.13

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

33.21

33.49

32.79

9.42

9.41

9.10

9.47

9.49

9.18

8.34

8.40

8.32

2.12

2.14

2.21

8.00

11.00

13.00

30.12

29.30

27.88

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Quarterly EM&A Report No.19

Location

Parameter

Salinity (ppt)

Dissolved Oxygen (mg/L)

pH

Turbidity (NTU)

Suspended Solids (mg/L)

Temp. (oC)

TRC (mg/L)

Iron (mg/L)

Surface & Middle

Bottom

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

Sep- 2024

Oct- 2024

Nov- 2024

NF1

Avg.

32.37

32.35

32.27

8.70

8.76

8.67

8.69

8.75

8.68

8.21

8.21

8.16

1.81

1.77

1.74

3.79

4.19

3.47

28.88

28.64

26.51

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

31.55

31.55

31.59

7.87

8.27

8.11

7.81

8.22

8.11

8.02

8.11

7.96

1.58

1.33

1.39

2.50

2.50

2.50

27.99

27.76

25.04

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

33.04

33.36

33.24

9.54

9.28

9.21

9.42

9.22

9.14

8.32

8.39

8.30

2.08

2.18

2.04

8.00

13.00

9.00

29.70

29.38

27.87

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

NF2

Avg.

32.26

32.31

32.05

8.53

8.76

8.49

8.54

8.75

8.48

8.19

8.21

8.13

1.73

1.71

1.71

3.77

4.00

4.14

28.96

28.61

26.49

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

31.51

31.34

31.38

7.89

8.19

7.99

7.84

8.19

8.02

8.01

8.05

7.99

1.39

1.25

1.43

2.50

2.00

2.50

27.94

27.75

25.14

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

32.90

33.27

32.84

9.14

9.35

9.24

9.19

9.33

9.11

8.33

8.39

8.28

2.09

2.20

2.14

7.00

11.00

15.00

29.98

29.20

27.57

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

NF3

Avg.

32.18

32.25

32.11

8.79

8.75

8.72

8.82

8.73

8.70

8.21

8.24

8.15

1.66

1.83

1.67

3.83

3.64

3.78

28.93

28.60

26.50

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Min.

31.14

31.45

31.25

7.97

7.81

8.05

7.98

7.78

8.08

8.04

8.07

7.98

1.41

1.47

1.42

2.50

2.00

2.50

28.04

27.81

24.99

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Max..

32.92

33.08

32.83

9.21

9.61

9.33

9.31

9.55

9.33

8.34

8.36

8.25

1.96

2.22

2.22

8.00

11.00

10.00

29.77

29.30

27.74

<0.01

<0.01

<0.01

<0.1

<0.1

<0.1

Table 3.7

Summary of Continuous Effluent Monitoring Results

Salinity (ppt)

pH

Temp (°C)

Total Residual Chlorine (mg/L)

Suspended Solids (mg/L)

Total Inorganic Nitrogen (mg/L)

Total Phosphorus (mg/L)

*Sodium Metabisulphite (mg/L)

Iron (mg/L)

Sep-2024

Avg.

54.88

7.68

29.67

0.03

3.00

0.54

0.01

<2

<0.1

Min.

51.05

7.27

24.50

0.00

<2

0.08

<0.01

<2

<0.1

Max.

58.25

7.85

31.06

0.20

2

0.49

0.02

<2

<0.1

Oct-2024

Avg.

55.19

7.55

27.77

0.04

3.00

0.54

0.01

<2

<0.1

Min.

51.05

7.14

24.50

0.01

<2

0.08

<0.01

<2

<0.1

Max.

58.26

7.86

31.15

0.07

2

0.49

0.02

<2

<0.1

Nov-2024

Avg.

53.82

7.32

26.01

0.04

2.00

0.21

0.01

<2

<0.1

Min.

49.80

6.68

24.01

0.01

<2

0.02

<0.01

<2

<0.1

Max.

58.57

8.00

28.60

0.09

2

0.42

0.02

<2

<0.1

* Remark: As confirmed by various laboratories in Hong Kong, the lowest detection limit for Sodium Metabisulphite is <2 mg/L. Due to the limitation of the laboratory, the lowest result for Sodium Metabisulphite will only be shown as < 2 mg/L.

Quarterly EM&A Report No.16

WASTE

The waste generated from this Project includes inert construction and demolition (C&D) materials, and non-inert C&D materials. Non-inert C&D materials are made up of general refuse, vegetative wastes, and recyclable wastes such as plastics and paper/cardboard packaging waste. Steel materials generated from the project are also grouped into non-inert C&D materials as the materials were not disposed of with other inert C&D materials. With reference to relevant handling records and trip tickets of this Project, the quantities of different types of waste generated in the reporting period are summarized in Table 4.1. Details of cumulative waste management data are presented as a waste flow table in Appendix F.

Table 4.1

Quantities of Waste Generated from the Project during reporting period

Reporting Months

Actual Quantities of Inert C&D Materials Generated Monthly

Actual Quantities of C&D Wastes Generated Monthly

Total Quantity Generated

Hard Rock and Large Broken Concrete

Reused in the Contract

Reused in other Projects

Disposed as Public Fill

Imported Fill

Metals

Paper / cardboard packaging

Plastics (1)

Chemical Waste

Others, e.g. general refuse

(in ,000kg)

(in ,000kg)

(in ,000kg)

(in ,000kg)

(in ,000kg)

(in ,000kg)

(in ,000kg)

(in ,000kg)

(in ,000kg)

(in ,000kg)

(in ,000kg)

Sep 2024

834.890

0.000

0.000

0.000

834.890

0.000

0.000

0.000

0.000

0.805

27.020

Oct 2024

78.140

0.000

0.000

0.000

78.140

0.000

0.000

0.000

0.000

0.000

71.810

Nov 2024

237.790

0.000

0.000

0.000

237.790

0.000

0.000

0.000

0.000

0.000

62.300

Notes:

(1) Plastics refer to plastic bottles / containers, plastic sheets / foam from packaging material

LANDFILL GAS MONITORING

5.1. MONITORING REQUIREMENT

In accordance with Section 11 of the EM&A Manual, monitoring of landfill gas is required for construction works within the 250m Consultation Zone. Part of the desalination plant and the indicative area of natural slope mitigation works fall within the SENT Landfill Extension Consultation Zone; and part of the 1,200 mm diameter fresh water mains along Wan Po Road falls within the SENT Landfill and SENT Landfill Extension Consultation Zones, TKO Stage II/III Restored Landfill and TKO Stage I Restored Landfill Consultation Zones.

Routine monitoring is required at buildings within the Project Site and consultation zones. The monitoring frequency will be monthly for the first year of operation.

For the manholes and utility pits within the Project Site and along the fresh water mains, each manhole/ utility pit should be monitored with two measurements (at mid depth and base). Each measurement should be monitored for a minimum of 10 minutes. A steady reading and peak reading should be recorded at each manhole/ utility pit and for each measurement.

Monitoring of oxygen, methane, carbon dioxide and barometric pressure would be performed monthly during the operation phase.

5.2. MONITORING LOCATION

Monitoring of oxygen, methane, carbon dioxide and barometric pressure was performed for excavations at 1m depth or more within the consultation Zone.

During construction of works within the consultation zones, excavations of 1m depth or more was monitored:

• At the ground surface before excavation commences;

• Immediately before any worker enters the excavation;

• At the beginning of each working day for the entire period the excavation remains open; and

• Periodically through the working day whilst workers are in the excavation.

For excavations between 300mm and 1m deep, measurements should be carried out:

• Directly after the excavation has been completed; and

• Periodically whilst the excavation remains open.

5.3. MONITORING PARAMETERS

LFG monitoring was carried out to identify any migration between the landfill and the Project and to ensure the safety of the construction, operation and maintenance personnel working on- site, visitors and any other person within the Project area.

The following parameters were monitored:

• Methane.

• Oxygen.

• Carbon Dioxide.

• Barometric Pressure.

5.4. MONITORING LOCATION

The area required to be monitored for landfill gas in the reporting period is shown in Figure 5.1, 5.2 and 5.3.

Figure 5.1 Overview of the SENT Extension Consultation Zone and the Project Site Area

Page 33

5.5. ACTION AND LIMIT LEVEL

Action and Limit Level are provided in Table 5.1.

Parameters

Action Level

Limit Level

Oxygen (O ) 2

<19% O 2

<19% O 2

Methane (CH ) 4

>10% LEL

>20% LEL

Carbon Dioxide (CO ) 2

>0.5% CO 2

>1.5% CO 2

5.6. MONITORING EQUIPMENT

The monitoring equipment used during the construction phase in this reporting period is detailed in Section 5.8 of the Construction Phase Monthly EM&A Report and the monitoring equipment used during the operation phase in the reporting period is detailed in Section 4.7 – 4.8 of the Operation Phase Monthly EM&A Report.

5.7. MONITORING RESULTS AND OBSERVATIONS

In this reporting period, 132 times of Construction Phase landfill gas monitoring were recorded at Wan Po Road (Ch0+390 – Ch0+780) and (Ch0+400 - Ch1+200). No exceedance of action and limit levels for methane, oxygen and carbon dioxide was observed. Monitoring was conducted during excavations at 1m depth or more within the consultation zone and whenever workers entered the excavation on the day. The landfill gas monitoring was ceased from 31 October 2024.

In this reporting period, Operation Phase landfill gas monitoring was conducted on 25, 26 and 27 September 2024, 9 and 10 October 2024 and 14 and 15 November 2024. No exceedances of action level and limit level was observed.

SUMMARY OF EXCEEDANCE, COMPLAINT, NOTIFICATION OF SUMMONS AND

PROSECUTIONS

The Environmental Complaint Handling Procedure is shown in below Figure 6.1:

Figure 6.1

Environmental Complaint Handling Procedures

No noise monitoring was conducted during the reporting period since there are no Contract- related construction activities undertaken within a radius of 300m from the monitoring locations.

No Action Level exceedance was recorded during the reporting period.

Referring to EM&A Manual, the general water quality monitoring should be carried out when there are marine-related construction activities undertaken. General water quality monitoring at the ten monitoring stations (CE, CF, WSR1, WSR2, WSR3, WSR4, WSR16, WSR33, WSR36 and WSR37) was ceased from 1 September 2023 due to the completion of marine-related construction works.

Thirty-six (36) of the operation phase water quality monitoring results of SS obtained had exceeded the Action Level. Eighty-five (85) of the operation phase water quality monitoring results of SS obtained during the reporting period had exceeded the Limit Level. After investigation, all exceedances were considered non-project related.

In this reporting period, 132 times of Construction Phase landfill gas monitoring were recorded at Wan Po Road (Ch0+390 – Ch0+780) and (Ch0+400 - Ch1+200). No exceedance of action and limit levels for methane, oxygen and carbon dioxide was observed. Monitoring was conducted during excavations at 1m depth or more within the consultation zone and whenever workers entered the excavation on the day. The landfill gas monitoring was ceased from 31 October 2024.

In this reporting period, Operation Phase landfill gas monitoring was conducted on 25, 26 and 27 September 2024, 9 and 10 October 2024 and 14, 15 November 2024. No exceedances of action level and limit level was observed.

Operation phase monthly coral monitoring was conducted during the reporting period on 18 September 2024, 21 October 2024 and 11 November 2024. No sediment, bleaching or increased mortality in the general condition of all other tagged coral colonies were observed during the monthly operation phase monitoring period. No deterioration of the coral community was observed in the ecological monitoring results when compared with the baseline ecological monitoring results. There is no AL/LL exceedance during the monitoring period.

Operation phase fishery monitoring for wet season 2024 was carried out on 24 and 31 August 2024. The detail of the monitoring was presented in the 4th Operation Phase Monthly EM&A Report.

Continuous Monitoring of Effluent Quality was conducted sampling point from 1 September 2024 to 30 November 2024. No exceedance of the sampling was obtained during the reporting period had exceeded the Limit Level.

The plant was shut down from 7 a.m. to 7 p.m. on 3 November 2024. No effluent discharge from TKODP occurred during this period.

Due to the plant has suspended production, there was no effluent discharge from the TKODP during the period between 24 November 2024 and 30 November 2024.

ET will keep closely monitoring the performance of Contractor, implementation of water quality mitigation measure and other contamination issue around the Project site, to ensure the EM&A requirement is properly implemented.

No environmental complaint was received in the reporting period. No notification of summons and prosecution was received in the reporting period.

Statistics on complaints and regulatory compliance are summarized in Appendix G.

EM&A SITE INSPECTION

Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract.

No trespass by the Contractor outside the works area of the Project and Clear Water Bay Country Park, and no damage to the vegetation and rocky shore outside the Project area was observed in the reporting period. All plants were observed to be in satisfactory condition in the reporting period.

ET weekly site inspections were carried out by ET on 3, 10, 17 and 24 September 2024, 3, 8, 15, 22 and 28 October 2024 and 5, 14, 18 and 26 November 2024.

Joint site inspections were also carried out by ET and IEC on 24 September 2024, 28 October 2024 and 26 November 2024.

According to the EIA Study Report, Environmental Permit, contract documents and EM&A Manual, the mitigation measures detailed in the documents should be implemented as much as practical during the reporting period. An updated Implementation Status of Environmental Mitigation Measures (EMIS) is provided in Appendix C.

CONCLUSIONS AND RECOMMENDATIONS

This is the 19th Quarterly EM&A Report for the Project which summarizes the key findings of the EM&A programme during the reporting period from 1 September 2024 to 30 November 2024, in accordance with the EM&A Manual and the requirement under FEP-01/503/2015/B.

According to the contractor’s information, the works of TKODP were substantially completed on 30 June 2024 and the plant commenced the operation phase on 1 July 2024. The outstanding construction works were being carried out during this reporting period.

No noise monitoring was conducted in the reporting period due to the over distant monitoring station from the works location.

Referring to EM&A Manual, the general water quality monitoring should be carried out when there are marine-related construction activities undertaken. General water quality monitoring at the ten monitoring stations (CE, CF, WSR1, WSR2, WSR3, WSR4, WSR16, WSR33, WSR36 and WSR37) was ceased from 1 September 2023 due to the completion of marine-related construction works.

Thirty-six (36) of the operation phase water quality monitoring results of SS obtained had exceeded the Action Level. Eighty-five (85) of the operation phase water quality monitoring results of SS obtained during the reporting period had exceeded the Limit Level. After investigation, all exceedances were considered non-project related.

Continuous Monitoring of Effluent Quality was conducted sampling point 1 September 2024 to 30 November 2024. No exceedance of the sampling was obtained during the reporting period had exceeded the Limit Level.

The plant was shut down from 7 a.m. to 7 p.m. on 3 November 2024. No effluent discharge from TKODP occurred during this period.

Due to the plant has suspended production, there was no effluent discharge from the TKODP during the period between 24 November 2024 and 30 November 2024.

In this reporting period, 132 times of Construction Phase landfill gas monitoring were recorded at Wan Po Road (Ch0+390 – Ch0+780) and (Ch0+400 - Ch1+200). No exceedance of action and limit levels for methane, oxygen and carbon dioxide was observed. Monitoring was conducted during excavations at 1m depth or more within the consultation zone and whenever workers entered the excavation on the day. The landfill gas monitoring was ceased from 31 October 2024.

In this reporting period, Operation Phase landfill gas monitoring was conducted on 25, 26, 27 September 2024, 9, 10 October 2024 and 14, 15 November 2024. No exceedances of action level and limit level was observed.

Operation phase monthly coral monitoring was conducted during the reporting period on 18 September 2024, 21 October 2024 and 11 November 2024. No sediment, bleaching or increased mortality in the general condition of all other tagged coral colonies were observed during the monthly operation phase monitoring period. No deterioration of the coral community was

observed in the ecological monitoring results when compared with the baseline ecological monitoring results. There is no AL/LL exceedance during the monitoring period.

Operation phase fishery monitoring for wet season 2024 was carried out on 24 and 31 August 2024. The detail of the monitoring was presented in the 4th Operation Phase Monthly EM&A Report.

Weekly environmental site inspection was conducted during the reporting period. Minor deficiency was observed during site inspection and was rectified. The environmental performance of the project was therefore considered satisfactory.

According to the environmental site inspections performed in the reporting period, the Contractor is reminded to pay attention on maintaining proper materials storage.

Two (2) environmental complaints were received of Contract since commencement of the Contract. No notification of summons or prosecution was received of the Contract since commencement of the Contract quarter.

The ET will keep track on the construction and operation works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.

Page 41

13/WSD/17

Design, Build and Operate Stage 1 of Tesung Kwan O Desalination Plant

31 Jul 24

ctivity ID

Activity Name

Baseline Duration

Baseline Start

Baseline Finish

Remaining Duration

Actual / Planned Start

Actual / Planned Finish

Actual % Complete

Variance Finish Date

Total Float

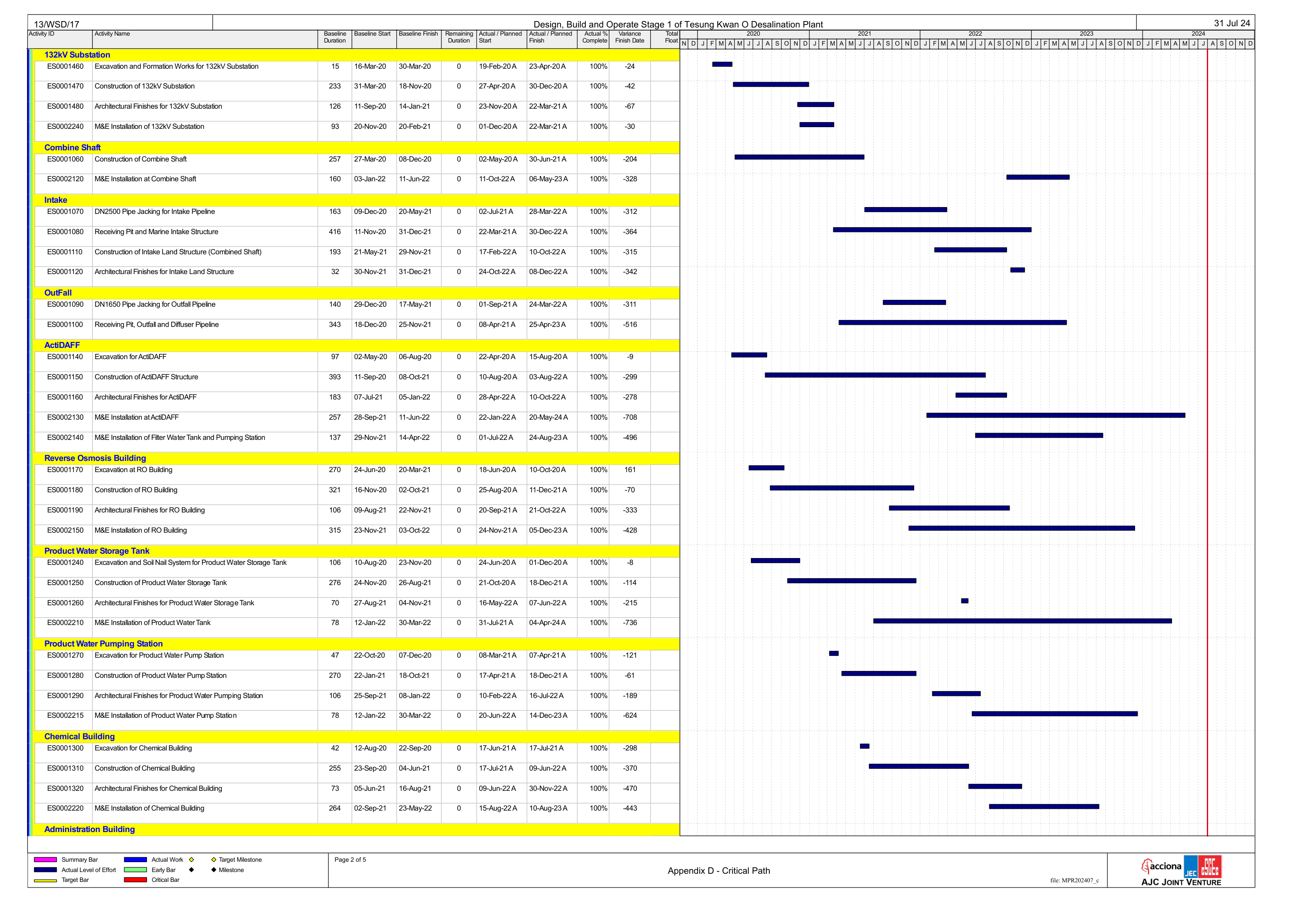

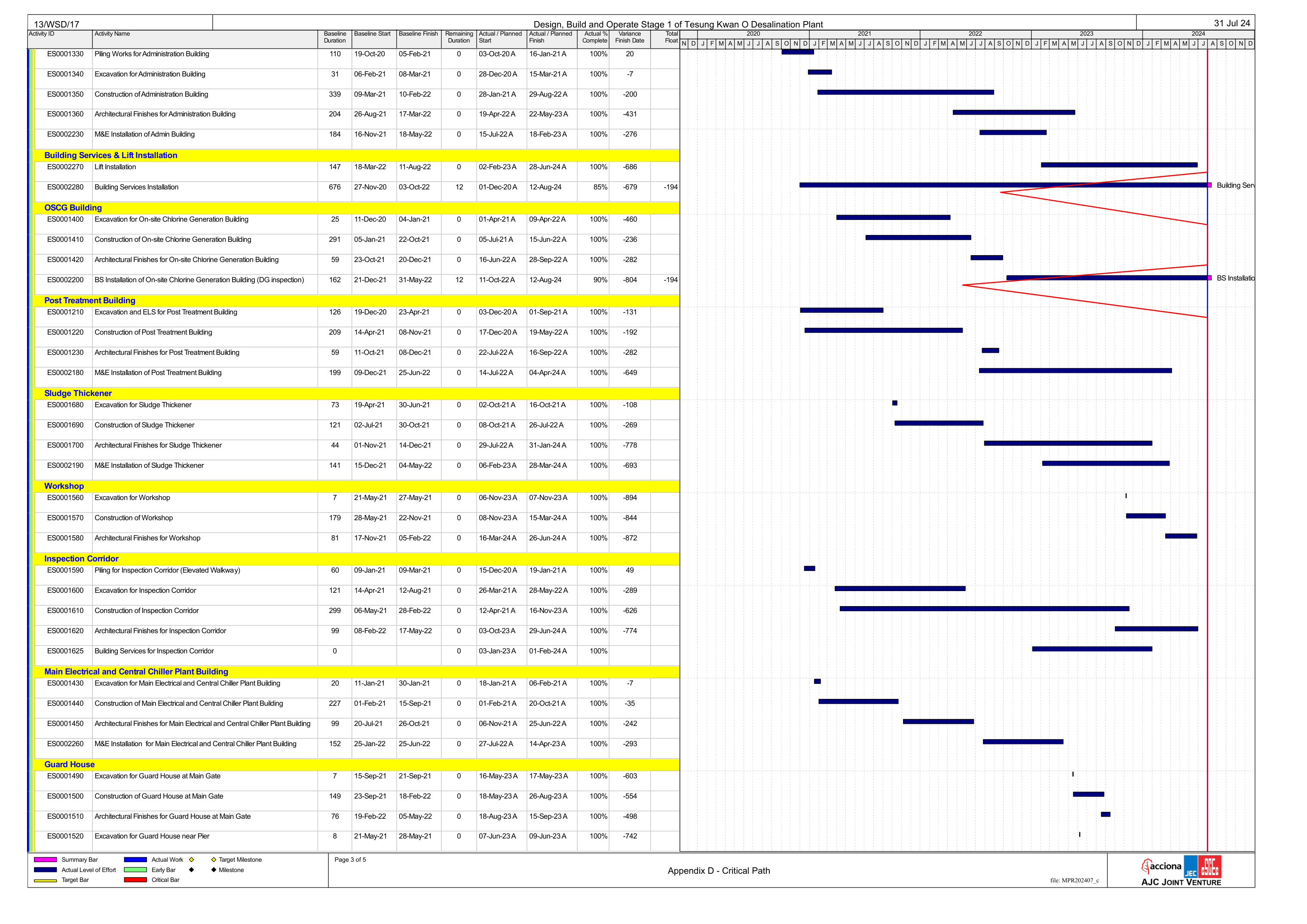

2020

2021

2022

2023

2024

N

D

J

F

M

A

M

J

J

A

S

O

N

D

J

F

M

A

M

J

J

A

S

O

N

D

J

F

M

A

M

J

J

A

S

O

N

D

J

F

M

A

M

J

J

A

S

O

N

D

J

F

M

A

M

J

J

A

S

O

N

D

Project Progr

amme Updated as at 31 Jul 2024

Le

tter C

of om

Acc me

ep nc

tan em

ce ent

of

the

W

ork

s

Key Dates

Commencem

ent and Completion Date

KD0000100

Letter of Acceptance

0

15-Nov-19

0

15-Nov-19 A

100%

0

KD0000110

Commencement of the Works

0

30-Dec-19

0

30-Dec-19 A

100%

0

KD0000120

Original Completion of the Works (1170 Days)

0

13-Mar-23

0

13-Mar-23 A

100%

0

P

os

ses

sio

n of

Fir

st

Sta

ge

Por

tion

A

Ori

gin

al C

om

ple

tio

n of

th

e W

or

ks ( R

117 ev

0 ise

Day d C

s) om

ple P

tion lan

of ne

the d C

W om

ork ple

KD0000130

Revised Completion of the Works (324 Days EOT Granted)

0

0

14-Mar-23 A

31-Jan-24 A

100%

KD0000510

Planned Completion of the Works

0

0

30-Jun-24 A

100%

Possession

of Site

KD0000200

Possession of First Stage Portion A

0

30-Dec-19

0

30-Dec-19 A

100%

0

KD0000210

Possession of First Stage Portion B

0

30-Dec-19

0

30-Dec-19 A

100%

0

P P P P P

os os os os os

ses ses ses ses ses

sio sio sio sio sio

n of n of n of n of n of

Fir Ar Te Te Te

st ea mp mp mp

Sta for ora ora ora

ge Acc ry ry ry

Por es Wo Wo Wo

tion s R rks rks rks

B oa Are Are Are

d a 1 a 2 a 3

KD0000220

Possession of Area for Access Road

0

30-Dec-19

0

30-Dec-19 A

100%

0

KD0000230

Possession of Temporary Works Area 1

0

30-Dec-19

0

30-Dec-19 A

100%

0

KD0000240

Possession of Temporary Works Area 2

0

30-Dec-19

0

30-Dec-19 A

100%

0

KD0000250

Possession of Temporary Works Area 3

0

30-Dec-19

0

30-Dec-19 A

100%

0

KD0000260

Possession of Temporary Works in Clear Water Bay Country Park

0

30-Dec-19

0

30-Dec-19 A

100%

0

P

os

ses

sio

n of

Te

mp

ora

ry

Wo

rks

in

Cle

ar

Wa

ter

Ba

y C

ou

ntry

Pa

rk

Executive Su

mmaries

Preliminary S

etup

ES0001000

Mobilization and Preliminary Set Up

191

30-Dec-19

07-Jul-20

0

30-Dec-19 A

20-Jul-20 A

100%

-13

Civil Design

AIP and DDA

ES0001010

AIP Civil Design Submission and Approval

330

30-Dec-19

23-Nov-20

0

30-Dec-19 A

31-Aug-20 A

100%

84

ES0001020

DDA Civil Design Submission and Approval

414

28-Feb-20

16-Apr-21

0

22-Jan-20 A

01-Sep-21 A

100%

-138

M&E Design

AIP and DDA

ES0002000

M&E AIP Process Mechanical Submission and Approval

477

30-Dec-19

19-Apr-21

0

30-Dec-19 A

22-Dec-20 A

100%

118

ES0002010

M&E DDA Process Mechanical Submission and Approval

679

08-Feb-20

17-Dec-21

0

21-Jul-20 A

02-Sep-21 A

100%

106

ES0002020

M&E AIP Instrumentation & Control Submission and Approval

607

31-Jan-20

28-Sep-21

0

04-Feb-20 A

25-Feb-20 A

100%

581

ES0002030

M&E DDA Instrumentation & Control Submission and Approval

514

22-Jul-20

17-Dec-21

0

13-Feb-21 A

14-Apr-23 A

100%

-482

ES0002050

M&E DDA Renewable Energy Submission and Approval

382

16-Aug-20

01-Sep-21

0

17-Aug-20 A

31-Dec-20 A

100%

244

ES0002060

M&E AIP Building Services Submission and Approval

226

30-Dec-19

11-Aug-20

0

30-Dec-19 A

30-Oct-20 A

100%

-80

ES0002065

M&E Design Basis & Civil Guidance Dwg

112

30-Dec-19

19-Apr-20

0

30-Dec-19 A

24-Jul-20 A

100%

-96

ES0002070

M&E DDA Building Services Submission and Approval

306

28-Feb-20

29-Dec-20

0

01-Mar-20 A

30-Jun-21 A

100%

-183

ES0002085

M&E AIP Site Wide Electrical Submission and Approval

155

09-Jun-20

10-Nov-20

0

21-Mar-20 A

22-Jul-20 A

100%

111

ES0002090

M&E CMS Lift Submission and Approval

140

27-Aug-20

13-Jan-21

0

01-Oct-20 A

20-Jul-21 A

100%

-188

ES0002095

M&E DDA Site Wide Electrical Submission and Approval

140

11-Nov-20

30-Mar-21

0

23-Jul-20 A

04-Jun-21 A

100%

-66

ES0002100

M&E DDA T&C Design Submission and Approval

155

29-Mar-22

30-Aug-22

0

01-Aug-21 A

05-Oct-23 A

100%

-401

Procurement

of Major Plant & Equipment Schedule

ES0002320

M&E Procurement of Major Plant, Equipment, Material and Delivery

901

14-Mar-20

31-Aug-22

0

04-Feb-20 A

16-Jan-23 A

100%

-137

ES2420

M&E Procurement of Mechanical Equipment - Intake Pumps

595

18-May-20

02-Jan-22

0

04-Feb-20 A

11-May-22 A

100%

-128

ES2430

M&E Procurement of Mechanical Equipment - ActiDAFF Underdrain

333

30-Oct-20

27-Sep-21

0

02-Aug-20 A

14-Mar-22 A

100%

-168

ES2440

M&E Procurement of Mechanical Equipment - ActiDAFF Media

298

15-Mar-21

06-Jan-22

0

23-Jul-20 A

14-Oct-22 A

100%

-281

ES2450

M&E Procurement of Mechanical Equipment - RO and ERD Rack

274

22-Feb-21

22-Nov-21

0

22-Jul-20 A

28-Dec-21 A

100%

-36

ES2460

M&E Procurement of Mechanical Equipment - RO Membrane

755

29-Mar-20

22-Apr-22

0

12-Feb-20 A

28-Dec-22 A

100%

-249

ES2470

M&E Procurement of Electrical Equipment - CLP Substation for LV Switchboard / Genset / Building Services

300

14-Mar-20

07-Jan-21

0

14-Mar-20 A

28-Feb-21 A

100%

-52

Summary Bar Actual Work Target Milestone Actual Level of Effort Early Bar Milestone Target Bar Critical Bar

Page 1 of 5 Appendix D - Critical Path file: MPR202407 c _

13/WSD/17

Design, Build and Operate Stage 1 of Tesung Kwan O Desalination Plant 31 Jul 24

ES0001020

DDA Civil Design Submission and Approval

28-Feb-20

16-Apr-21

22-Jan-20 A

01-Sep-21 A

100%

-138

ES0002030

M&E DDA Instrumentation & Control Submission and Approval

22-Jul-20

17-Dec-21

13-Feb-21 A

14-Apr-23 A

100%

-482

ES0002070

M&E DDA Building Services Submission and Approval

28-Feb-20

29-Dec-20

01-Mar-20 A

30-Jun-21 A

100%

-183

ES0002090

M&E CMS Lift Submission and Approval

27-Aug-20

13-Jan-21

01-Oct-20 A

20-Jul-21 A

100%

-188

ES0002100

M&E DDA T&C Design Submission and Approval

29-Mar-22

30-Aug-22

01-Aug-21 A

05-Oct-23 A

100%

-401

ES0002320

M&E Procurement of Major Plant, Equipment, Material and Delivery

14-Mar-20

31-Aug-22

04-Feb-20 A

16-Jan-23 A

100%

-137

ES2420

M&E Procurement of Mechanical Equipment - Intake Pumps

18-May-20

02-Jan-22

04-Feb-20 A

11-May-22 A

100%

-128

ES2430

M&E Procurement of Mechanical Equipment - ActiDAFF Underdrain

30-Oct-20

27-Sep-21

02-Aug-20 A

14-Mar-22 A

100%

-168

ES2440

M&E Procurement of Mechanical Equipment - ActiDAFF Media

15-Mar-21

06-Jan-22

23-Jul-20 A

14-Oct-22 A

100%

-281

ES2460

M&E Procurement of Mechanical Equipment - RO Membrane

29-Mar-20

22-Apr-22

12-Feb-20 A

28-Dec-22 A

100%

-249

ES0002010

M&E DDA Process Mechanical Submission and Approval

08-Feb-20

17-Dec-21

21-Jul-20 A

02-Sep-21 A

100%

106

ES0002020

M&E AIP Instrumentation & Control Submission and Approval

31-Jan-20

28-Sep-21

04-Feb-20 A

25-Feb-20 A

100%

581

ES0002050

M&E DDA Renewable Energy Submission and Approval

16-Aug-20

01-Sep-21

17-Aug-20 A

31-Dec-20 A

100%

244

ES0002085

M&E AIP Site Wide Electrical Submission and Approval

09-Jun-20

10-Nov-20

21-Mar-20 A

22-Jul-20 A

100%

111

ES0002000

M&E AIP Process Mechanical Submission and Approval

30-Dec-19

19-Apr-21

30-Dec-19 A

22-Dec-20 A

100%

118

ES0001000

Mobilization and Preliminary Set Up

30-Dec-19

07-Jul-20

30-Dec-19 A

20-Jul-20 A

100%

-13

ES0002060

M&E AIP Building Services Submission and Approval

30-Dec-19

11-Aug-20

30-Dec-19 A

30-Oct-20 A

100%

-80

ES0002065

M&E Design Basis & Civil Guidance Dwg

30-Dec-19

19-Apr-20

30-Dec-19 A

24-Jul-20 A

100%

-96

ES0002095

M&E DDA Site Wide Electrical Submission and Approval

11-Nov-20

30-Mar-21

23-Jul-20 A

04-Jun-21 A

100%

-66

ES2450

M&E Procurement of Mechanical Equipment - RO and ERD Rack

22-Feb-21

22-Nov-21

22-Jul-20 A

28-Dec-21 A

100%

-36

Switchboard / Genset / Building Services

14-Mar-20

07-Jan-21

14-Mar-20 A

28-Feb-21 A

100%

-52

ES0001010

AIP Civil Design Submission and Approval

30-Dec-19

23-Nov-20

30-Dec-19 A

31-Aug-20 A

100%

84

KD0000100

Letter of Acceptance

15-Nov-19

15-Nov-19 A

100%

0

KD0000110

Commencement of the Works

30-Dec-19

30-Dec-19 A

100%

0

KD0000120

Original Completion of the Works (1170 Days)

13-Mar-23

13-Mar-23 A

100%

0

KD0000200

Possession of First Stage Portion A

30-Dec-19

30-Dec-19 A

100%

0

KD0000210

Possession of First Stage Portion B

30-Dec-19

30-Dec-19 A

100%

0

KD0000220

Possession of Area for Access Road

30-Dec-19

30-Dec-19 A

100%

0

KD0000230

Possession of Temporary Works Area 1

30-Dec-19

30-Dec-19 A

100%

0

KD0000240

Possession of Temporary Works Area 2

30-Dec-19

30-Dec-19 A

100%

0

KD0000250

Possession of Temporary Works Area 3

30-Dec-19

30-Dec-19 A

100%

0

KD0000260

Possession of Temporary Works in Clear Water Bay Country Park

30-Dec-19

30-Dec-19 A

100%

0

KD0000130

Revised Completion of the Works (324 Days EOT Granted)

14-Mar-23 A

31-Jan-24 A

100%

KD0000510

Planned Completion of the Works

30-Jun-24 A

100%

Duration

Baseline Start

Baseline Finish

Remaining

Activity ID

Activity Name

Baseline

ES2470

M&E Procurement of Electrical Equipment - CLP Substation for LV

Target Milestone

Milestone

Procureme

Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule

Project Prog

Project Programme Updated as at 31 Jul 2024 Project Programme Updated as at 31 Jul 2024 Project Programme Updated as at 31 Jul 2024 Project Programme Updated as at 31 Jul 2024 Project Programme Updated as at 31 Jul 2024 Project Programme Updated as at 31 Jul 2024 Project Programme Updated as at 31 Jul 2024 Project Programme Updated as at 31 Jul 2024 Project Programme Updated as at 31 Jul 2024 Project Programme Updated as at 31 Jul 2024

Commence

Commencement and Completion Date

Commencement and Completion Date

Commencement and Completion Date

Commencement and Completion Date

Commencement and Completion Date

Commencement and Completion Date

Commencement and Completion Date

Commencement and Completion Date

Commencement and Completion Date

Commencement and Completion Date

Actual Work

Critical Bar

Early Bar

M&E Desig

M&E Design AIP and DDA

M&E Design AIP and DDA

M&E Design AIP and DDA

M&E Design AIP and DDA

M&E Design AIP and DDA

M&E Design AIP and DDA

M&E Design AIP and DDA

M&E Design AIP and DDA

M&E Design AIP and DDA

M&E Design AIP and DDA

Civil Design

Civil Design AIP and DDA

Civil Design AIP and DDA

Civil Design AIP and DDA

Civil Design AIP and DDA

Civil Design AIP and DDA

Civil Design AIP and DDA

Civil Design AIP and DDA

Civil Design AIP and DDA

Civil Design AIP and DDA

Civil Design AIP and DDA

Executive S

Executive Summaries

Executive Summaries

Executive Summaries

Executive Summaries

Executive Summaries

Executive Summaries

Executive Summaries

Executive Summaries

Executive Summaries

Executive Summaries

Actual Level of Effort

Possession

Possession of Site

Possession of Site

Possession of Site

Possession of Site

Possession of Site

Possession of Site

Possession of Site

Possession of Site

Possession of Site

Possession of Site

Preliminary

Preliminary Setup

Preliminary Setup

Preliminary Setup

Preliminary Setup

Preliminary Setup

Preliminary Setup

Preliminary Setup

Preliminary Setup

Preliminary Setup

Preliminary Setup

Summary Bar

Target Bar

Key Dates

Key Dates

Key Dates

Key Dates

Key Dates

Key Dates

Key Dates

Key Dates

Key Dates

Key Dates

Key Dates

Page 43

Page 44

13/WSD/17

Design, Build and Operate Stage 1 of Tesung Kwan O Desalination Plant

31 Jul 24

ctivity ID

Activity Name

Baseline Duration

Baseline Start

Baseline Finish

Remaining Duration

Actual / Planned Start

Actual / Planned Finish

Actual % Complete

Variance Finish Date

Total Float

2020

2021

2022

2023

2024

N

D

J

F

M

A

M

J

J

A

S O

N

D

J

F

M

A

M

J

J

A

S

O

N

D

J

F

M

A

M

J

J

A

S

O

N

D

J

F

M

A

M

J

J

A

S

O

N

D

J

F

M

A

M

J

J

A

S

O

N

D

ES0001530

Construction of Guard House near Pier

147

29-May-21

22-Oct-21

0

10-Jun-23 A

10-Oct-23 A

100%

-718

ES0001540

Architectural Finishes for Guard House near Pier

74

23-Oct-21

04-Jan-22

0

05-Oct-23 A

23-Mar-24 A

100%

-809

CO2 Tanks A

reas

ES0001370

Filling to Formation for CO2 Tanks Area

29

22-Jun-21

20-Jul-21

0

14-Dec-21 A

17-Dec-21 A

100%

-150

ES0001380

Construction of CO2 Tanks Area

116

21-Jul-21

13-Nov-21

0

21-Dec-21 A

10-Mar-22 A

100%

-117

ES0002170

M&E Installation of CO2 Tanks Area

84

27-Jan-22

20-Apr-22

0

11-Mar-22 A

03-Oct-23 A

100%

-531

Diesel Emerg

ency Generator

ES0002250

M&E Diesel Emergency Generator

57

25-Feb-22

22-Apr-22

0

18-Jan-23 A

28-Jul-23 A

100%

-462

Switch Room

and Transformer Installation

ES0002300

M&E Installation of HV/LV Switchroom and Transformer (Admin)

242

16-Nov-21

15-Jul-22

0

27-Jul-22 A

20-Apr-23 A

100%

-279

Miscellaneou

s

ES0001630

Remaining Architectural Finishes for All Buildings

322

11-Jan-22

28-Nov-22

0

09-Dec-22 A

29-Jun-24 A

100%

-579

Slo

pe

ES0001640

External Process and Non Process Pipe

655

18-Dec-20

03-Oct-22

0

27-May-21 A

23-Nov-23 A

100%

-416

ES0001650

Drainage and Cable Duct

518

04-Jun-21

03-Nov-22

0

25-Apr-22 A

18-Jul-23 A

100%

-257

ES0001660

Slope Mitigation Works

684

23-Nov-20

07-Oct-22

76

28-Sep-21 A

15-Oct-24

50%

-739

-258

ES0001670

Landscaping Works

469

28-Oct-21

08-Feb-23

0

01-Mar-23 A

18-May-24 A

100%

-465

ES0002290

M&E PV Panels

215

23-Nov-21

25-Jun-22

0

05-Jan-23 A

29-Jul-24 A

100%

-764

ES0002310

M&E Chiller & Irrigation System Installation

298

27-Oct-21

20-Aug-22

0

25-Aug-23 A

30-May-24 A

100%

-648

ES0002350

M&E Installation of Surge Vessel

70

24-Feb-22

04-May-22

0

15-Sep-23 A

30-Oct-23 A

100%

-544

ES0002390

M&E Installation of Thickened Sludge Holding Tank

42

09-Dec-21

19-Jan-22

0

27-Mar-23 A

31-Jan-24 A

100%

-742

Statutory Sub

mission & Inspection

ES0002330

Statutory Submission & Inspection

1148

11-Jan-20

03-Mar-23

2

03-Dec-19 A

02-Aug-24

100%

-518

-184

S

tat

uto

ry S

ub

Testing and

Commissioning

ES0002400

M&E Precomissioning

229

12-Jun-22

26-Jan-23

0

22-Apr-23 A

29-Mar-24 A

100%

-428

ES0002410

M&E Commissioning

213

04-Jul-22

01-Feb-23

0

02-Jun-23 A

30-Jul-24 A

100%

-544

ES0002420

M&E Performance Test

40

02-Feb-23

13-Mar-23

0

28-Nov-23 A

26-Apr-24 A

100%

-409

Procurement

of Major Plant & Equipment Schedule

NR

Re Re

cei ceip

pt - t o

Pr f of

ess fer

ure s -

re Pre

lief ssu

val re

ves relie

f v

alv

es

Pipes, Fitting

s and Valves

Pressure Relief

Valves

P-PV-A51IK-0

1NR Receipt - Pressure relief valves

0

08-Sep-21

0

02-Oct-20 A

100%

341

P-PV-A51IK-0

2Receipt of offers - Pressure relief valves

30

09-Sep-21

08-Oct-21

0

03-Oct-20 A

27-Oct-20 A

100%

346

P-PV-A51IK-0

3Technical Validation - Pressure relief valves

30

09-Oct-21

07-Nov-21

0

28-Oct-20 A

05-Mar-21 A

100%

248

Tec

hni

cal Ne

Va goti

lida atio

tion n a

- nd

Pre Aw

ssu ard M

re / anu T 1

relie Clie fac ran st d

f v nt A tur sp eli

alv pp e a ort ver

es rov nd & C y d

al - FA us ate

Pr T - tom to

ess Pre s - site

ure ssu Pre - P

re re ss res

lief reli ure sur

val ef v rel e r

ves alv ief elie

es valv f va

es lve

s

P-PV-A51IK-0

5Negotiation and Award / Client Approval - Pressure relief valves

60

08-Nov-21

06-Jan-22

0

06-Mar-21 A

19-Nov-21 A

100%

49

P-PV-A51IK-0

6Manufacture and FAT - Pressure relief valves

187

07-Jan-22

12-Jul-22

0

20-Nov-21 A

22-Jul-22 A

100%

-9

P-PV-A51IK-0

7Transport & Customs - Pressure relief valves

50

13-Jul-22

31-Aug-22

0

23-Jul-22 A

31-Jul-22 A

100%

32

P-PV-A51IK-0

81st delivery date to site - Pressure relief valves

0

31-Aug-22

0

31-Jul-22 A

100%

32

Instrumentati

on, Control & Automation

NR

R Re

ece cei Tec

ipt pt o hn

- B f of ical

ypa fer Va

ss s - lida

Lev Byp tio

el I as n -

ndi s L Byp

cat eve as

ors l In s L

dic eve

ato l In

rs dic

ato

rs

Bypass Level Ind

icators

P-IC-A08FK2-

0NR Receipt - Bypass Level Indicators

0

12-Apr-21

0

16-Sep-20 A

100%

208

P-IC-A08FK2-

0Receipt of offers - Bypass Level Indicators

30

13-Apr-21

12-May-21

0

17-Sep-20 A

20-Oct-20 A

100%

205

P-IC-A08FK2-

0Technical Validation - Bypass Level Indicators

30

13-May-21

11-Jun-21

0

21-Oct-20 A

25-Nov-20 A

100%

199

P-IC-A08FK2-

0Negotiation and Award / Client Approval - Bypass Level Indicators

60

12-Jun-21

10-Aug-21

0

26-Nov-20 A

30-Jun-21 A

100%

42

Ne

goti

atio

n a

nd

Aw

ar

d /

Clie

nt

App

rov M

al - anu

By fac

pa tur Tr

ss e a an

Lev nd spo

el I FA rt

ndi T - & C

cat Byp ust

ors as om

s L s -

eve Byp

l In as

dic s L

ato eve

rs l In

dic

ato

rs

P-IC-A08FK2-

0Manufacture and FAT - Bypass Level Indicators

90

11-Aug-21

08-Nov-21

0

01-Jul-21 A

22-Jul-22 A

100%

-255

P-IC-A08FK2-

0Transport & Customs - Bypass Level Indicators

50

09-Nov-21

28-Dec-21

0

18-Sep-22 A

26-Oct-22 A

100%

-301

Summary Bar Actual Work Target Milestone Actual Level of Effort Early Bar Milestone Target Bar Critical Bar

Page 4 of 5 Appendix D - Critical Path file: MPR202407 c _

13/WSD/17

Design, Build and Operate Stage 1 of Tesung Kwan O Desalination Plant 31 Jul 24

ES0001660

Slope Mitigation Works

23-Nov-20

07-Oct-22

28-Sep-21 A

15-Oct-24

50%

-739

-258

ES0002330

Statutory Submission & Inspection

11-Jan-20

03-Mar-23

03-Dec-19 A

02-Aug-24

100%

-518

-184

ES0001530

Construction of Guard House near Pier

29-May-21

22-Oct-21

10-Jun-23 A

10-Oct-23 A

100%

-718

ES0001540

Architectural Finishes for Guard House near Pier

23-Oct-21

04-Jan-22

05-Oct-23 A

23-Mar-24 A

100%

-809

ES0001370

Filling to Formation for CO2 Tanks Area

22-Jun-21

20-Jul-21

14-Dec-21 A

17-Dec-21 A

100%

-150

ES0002170

M&E Installation of CO2 Tanks Area

27-Jan-22

20-Apr-22

11-Mar-22 A

03-Oct-23 A

100%

-531

ES0002250

M&E Diesel Emergency Generator

25-Feb-22

22-Apr-22

18-Jan-23 A

28-Jul-23 A

100%

-462

ES0002300

M&E Installation of HV/LV Switchroom and Transformer (Admin)

16-Nov-21

15-Jul-22

27-Jul-22 A

20-Apr-23 A

100%

-279

ES0001630

Remaining Architectural Finishes for All Buildings

11-Jan-22

28-Nov-22

09-Dec-22 A

29-Jun-24 A

100%

-579

ES0001640

External Process and Non Process Pipe

18-Dec-20

03-Oct-22

27-May-21 A

23-Nov-23 A

100%

-416

ES0001650

Drainage and Cable Duct

04-Jun-21

03-Nov-22

25-Apr-22 A

18-Jul-23 A

100%

-257

ES0001670

Landscaping Works

28-Oct-21

08-Feb-23

01-Mar-23 A

18-May-24 A

100%

-465

ES0002290

M&E PV Panels

23-Nov-21

25-Jun-22

05-Jan-23 A

29-Jul-24 A

100%

-764

ES0002310

M&E Chiller & Irrigation System Installation

27-Oct-21

20-Aug-22

25-Aug-23 A

30-May-24 A

100%

-648

ES0002350

M&E Installation of Surge Vessel

24-Feb-22

04-May-22

15-Sep-23 A

30-Oct-23 A

100%

-544

ES0002390

M&E Installation of Thickened Sludge Holding Tank

09-Dec-21

19-Jan-22

27-Mar-23 A

31-Jan-24 A

100%

-742

ES0002400

M&E Precomissioning

12-Jun-22

26-Jan-23

22-Apr-23 A

29-Mar-24 A

100%

-428

ES0002410

M&E Commissioning

04-Jul-22

01-Feb-23

02-Jun-23 A

30-Jul-24 A

100%

-544

ES0002420

M&E Performance Test

02-Feb-23

13-Mar-23

28-Nov-23 A

26-Apr-24 A

100%

-409

P-IC-A08FK2-0Manufacture and FAT - Bypass Level Indicators

11-Aug-21

08-Nov-21

01-Jul-21 A

22-Jul-22 A

100%

-255

P-IC-A08FK2-0Transport & Customs - Bypass Level Indicators

09-Nov-21

28-Dec-21

18-Sep-22 A

26-Oct-22 A

100%

-301

ES0001380

Construction of CO2 Tanks Area

21-Jul-21

13-Nov-21

21-Dec-21 A

10-Mar-22 A

100%

-117

P-PV-A51IK-01NR Receipt - Pressure relief valves

08-Sep-21

02-Oct-20 A

100%

341

P-PV-A51IK-02Receipt of offers - Pressure relief valves

09-Sep-21

08-Oct-21

03-Oct-20 A

27-Oct-20 A

100%

346

P-PV-A51IK-03Technical Validation - Pressure relief valves

09-Oct-21

07-Nov-21

28-Oct-20 A

05-Mar-21 A

100%

248

P-IC-A08FK2-0NR Receipt - Bypass Level Indicators

12-Apr-21

16-Sep-20 A

100%

208

P-IC-A08FK2-0Receipt of offers - Bypass Level Indicators

13-Apr-21

12-May-21

17-Sep-20 A

20-Oct-20 A

100%

205

P-IC-A08FK2-0Technical Validation - Bypass Level Indicators

13-May-21

11-Jun-21

21-Oct-20 A

25-Nov-20 A

100%

199

P-PV-A51IK-05Negotiation and Award / Client Approval - Pressure relief valves

08-Nov-21

06-Jan-22

06-Mar-21 A

19-Nov-21 A

100%

49

P-PV-A51IK-07Transport & Customs - Pressure relief valves

13-Jul-22

31-Aug-22

23-Jul-22 A

31-Jul-22 A

100%

32

P-PV-A51IK-081st delivery date to site - Pressure relief valves

31-Aug-22

31-Jul-22 A

100%

32

P-IC-A08FK2-0Negotiation and Award / Client Approval - Bypass Level Indicators

12-Jun-21

10-Aug-21

26-Nov-20 A

30-Jun-21 A

100%

42

P-PV-A51IK-06Manufacture and FAT - Pressure relief valves

07-Jan-22

12-Jul-22

20-Nov-21 A

22-Jul-22 A

100%

-9

Duration

Baseline Start

Baseline Finish

Remaining

Activity ID

Activity Name

Baseline

Target Milestone

Milestone

Procuremen

Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule Procurement of Major Plant & Equipment Schedule

Switch Roo

Switch Room and Transformer Installation Switch Room and Transformer Installation Switch Room and Transformer Installation Switch Room and Transformer Installation Switch Room and Transformer Installation Switch Room and Transformer Installation Switch Room and Transformer Installation Switch Room and Transformer Installation Switch Room and Transformer Installation Switch Room and Transformer Installation

Instrumenta

Instrumentation, Control & Automation

Instrumentation, Control & Automation

Instrumentation, Control & Automation

Instrumentation, Control & Automation

Instrumentation, Control & Automation

Instrumentation, Control & Automation

Instrumentation, Control & Automation

Instrumentation, Control & Automation

Instrumentation, Control & Automation

Instrumentation, Control & Automation

Actual Work

Critical Bar

Statutory Su

Statutory Submission & Inspection

Statutory Submission & Inspection

Statutory Submission & Inspection

Statutory Submission & Inspection

Statutory Submission & Inspection

Statutory Submission & Inspection

Statutory Submission & Inspection

Statutory Submission & Inspection

Statutory Submission & Inspection

Statutory Submission & Inspection

Early Bar

Diesel Eme

Diesel Emergency Generator

Diesel Emergency Generator

Diesel Emergency Generator

Diesel Emergency Generator

Diesel Emergency Generator

Diesel Emergency Generator

Diesel Emergency Generator

Diesel Emergency Generator

Diesel Emergency Generator

Diesel Emergency Generator

Testing and

Testing and Commissioning

Testing and Commissioning

Testing and Commissioning

Testing and Commissioning

Testing and Commissioning

Testing and Commissioning

Testing and Commissioning

Testing and Commissioning

Testing and Commissioning

Testing and Commissioning

Pipes, Fittin

Pipes, Fittings and Valves

Pipes, Fittings and Valves

Pipes, Fittings and Valves

Pipes, Fittings and Valves

Pipes, Fittings and Valves

Pipes, Fittings and Valves

Pipes, Fittings and Valves

Pipes, Fittings and Valves

Pipes, Fittings and Valves

Pipes, Fittings and Valves

Actual Level of Effort

Bypass Level In

Bypass Level Indicators

Bypass Level Indicators

Bypass Level Indicators

Bypass Level Indicators

Bypass Level Indicators

Bypass Level Indicators

Bypass Level Indicators

Bypass Level Indicators

Bypass Level Indicators

Bypass Level Indicators

CO2 Tanks

CO2 Tanks Areas

CO2 Tanks Areas

CO2 Tanks Areas

CO2 Tanks Areas

CO2 Tanks Areas

CO2 Tanks Areas

CO2 Tanks Areas

CO2 Tanks Areas

CO2 Tanks Areas

CO2 Tanks Areas

Pressure Relie

Pressure Relief Valves

Pressure Relief Valves

Pressure Relief Valves

Pressure Relief Valves

Pressure Relief Valves

Pressure Relief Valves

Pressure Relief Valves

Pressure Relief Valves

Pressure Relief Valves

Pressure Relief Valves

Miscellaneo

Miscellaneous

Miscellaneous

Miscellaneous

Miscellaneous

Miscellaneous

Miscellaneous

Miscellaneous

Miscellaneous

Miscellaneous

Miscellaneous

Summary Bar

Target Bar

13/WSD/17

Design, Build and Operate Stage 1 of Tesung Kwan O Desalination Plant

31 Jul 24

ctivity ID

Activity Name

Baseline Duration

Baseline Start

Baseline Finish

Remaining Duration

Actual / Planned Start

Actual / Planned Finish

Actual % Complete

Variance Finish Date

Total Float

2020

2021

2022

2023

2024

N

D

J

F

M

A

M

J

J

A

S

O

N

D

J

F

M

A

M

J

J

A

S

O

N

D

J

F

M

A

M

J

J

A

S

O

N

D

J

F

M

A

M

J

J

A

S

O

N

D

J

F

M

A

M

J

J

A

S

O

N

D

P-IC-A08FK2-

01st delivery date to site - Bypass Level Indicators

0

28-Dec-21

0

26-Oct-22 A

100%

-301

1

st d

eliv

ery

da

te t

o s

ite

- B

ypa

ss

Lev

el I

ndi

cat

ors

Level Transmitter

s

P-IC-A08FK1-

0NR Receipt - Level Transmitters

0

12-Apr-21

0

16-Sep-20 A

100%

208

NR

R Re

ece cei Tec

ipt pt o hn

- Le f of ical

ve fer Va

l Tr s - L lida

ans ev tio N

mit el T n - eg

ter ran Lev otia

s sm el T tio

itte ra n a M

rs nsm nd an

itte Aw ufa

rs ard ctu

/ C re

lien and

t A FA

ppr T -

ov Le

al - vel

Le Tra

vel ns

Tra mitt

ns ers

mitt

ers

P-IC-A08FK1-

0Receipt of offers - Level Transmitters

30

13-Apr-21

12-May-21

0

17-Sep-20 A

20-Oct-20 A

100%

204

P-IC-A08FK1-

0Technical Validation - Level Transmitters

30

13-May-21

11-Jun-21

0

21-Oct-20 A

26-Nov-20 A

100%

198

P-IC-A08FK1-

0Negotiation and Award / Client Approval - Level Transmitters

60

12-Jun-21

10-Aug-21

0

26-Nov-20 A

02-Dec-21 A

100%

-113

P-IC-A08FK1-

0Manufacture and FAT - Level Transmitters

90

11-Aug-21

08-Nov-21

0

03-Dec-21 A

31-Mar-22 A

100%

-142

P-IC-A08FK1-

0Transport & Customs - Level Transmitters

50

09-Nov-21

28-Dec-21

0

02-Apr-22 A

01-Jun-22 A

100%

-154

T 1

ran st d

sp eli

ort ver

& C y d

us ate

tom to

s - site

Le - L

vel eve

Tra l Tr

ns an

mitt smi

ers tter

s

P-IC-A08FK1-

01st delivery date to site - Level Transmitters

0

28-Dec-21

0

01-Jun-22 A

100%

-154

Construction

Civil & Struct

ure Construction

ActiDAFF Structu

re (DAF)

CC0200906k

DAF: Remedial Work at Cell No. 1 and 3 after Water Test

0

0

30-Nov-21 A

27-Jun-22 A

100%

D

AF:

R

em

edi

al W

or

k a

t C

ell N

o. GR

1 a P C

nd om

3 a bin

fter ed

W Sh

ate aft

r Te S -

st DN

50

0 T

ee

at +

3.2

14

mP

D

Yard Piping - Pro

cess & Non Process

Yard Piping - Co

mbined Shaft Zone

CC2401356k

GRP Combined Shaft S - DN500 Tee at +3.214mPD

0

0

01-Apr-23 A

06-Apr-23 A

100%

Yard Piping - Ac

tiDAFF Zone

CC2401311k

GRP West ActiDAFF: (Covid-19) Limited Resources Effect to GRP Works

0

0

08-Feb-22 A

19-Apr-22 A

100%

G

RP

We G

st RP

Acti So

DA uth

FF: Act

(C iDA

ovi FF

d-1 : D

9) N4

Lim 00

ited at 5

R .49

eso 0m

urc PD

es at

Eff C1

ect 0/

to CD

GR ~CF

P W

or

ks

CC2401349k

GRP South ActiDAFF: DN400 at 5.490mPD at C10/CD~CF

0

0

14-May-22 A

18-Jun-22 A

100%

Summary Bar Actual Work Target Milestone Actual Level of Effort Early Bar Milestone Target Bar Critical Bar

Page 5 of 5 Appendix D - Critical Path file: MPR202407 c _

13/WSD/17

Design, Build and Operate Stage 1 of Tesung Kwan O Desalination Plant 31 Jul 24

P-IC-A08FK2-01st delivery date to site - Bypass Level Indicators

28-Dec-21

26-Oct-22 A

100%

-301

P-IC-A08FK1-0Manufacture and FAT - Level Transmitters

11-Aug-21

08-Nov-21

03-Dec-21 A

31-Mar-22 A

100%

-142

P-IC-A08FK1-0Transport & Customs - Level Transmitters

09-Nov-21

28-Dec-21

02-Apr-22 A

01-Jun-22 A

100%

-154

P-IC-A08FK1-01st delivery date to site - Level Transmitters

28-Dec-21

01-Jun-22 A

100%

-154

P-IC-A08FK1-0Negotiation and Award / Client Approval - Level Transmitters

12-Jun-21

10-Aug-21

26-Nov-20 A

02-Dec-21 A

100%

-113

P-IC-A08FK1-0NR Receipt - Level Transmitters

12-Apr-21

16-Sep-20 A

100%

208

P-IC-A08FK1-0Receipt of offers - Level Transmitters

13-Apr-21

12-May-21

17-Sep-20 A

20-Oct-20 A

100%

204

P-IC-A08FK1-0Technical Validation - Level Transmitters

13-May-21

11-Jun-21

21-Oct-20 A

26-Nov-20 A

100%

198

CC0200906k DAF: Remedial Work at Cell No. 1 and 3 after Water Test

30-Nov-21 A

27-Jun-22 A

100%

CC2401356kGRP Combined Shaft S - DN500 Tee at +3.214mPD

01-Apr-23 A

06-Apr-23 A

100%

CC2401311k GRP West ActiDAFF: (Covid-19) Limited Resources Effect to GRP Works

08-Feb-22 A

19-Apr-22 A

100%

CC2401349kGRP South ActiDAFF: DN400 at 5.490mPD at C10/CD~CF

14-May-22 A

18-Jun-22 A

100%

Duration

Baseline Start

Baseline Finish

Remaining

Activity ID

Activity Name

Baseline

Target Milestone

Milestone

Actual Work

Critical Bar

Early Bar

Civil & Stru

Civil & Structure Construction

Civil & Structure Construction

Civil & Structure Construction

Civil & Structure Construction

Civil & Structure Construction

Civil & Structure Construction

Civil & Structure Construction

Civil & Structure Construction

Civil & Structure Construction

Civil & Structure Construction

Yard Piping - Pr

Yard Piping - Process & Non Process

Yard Piping - Process & Non Process

Yard Piping - Process & Non Process

Yard Piping - Process & Non Process

Yard Piping - Process & Non Process

Yard Piping - Process & Non Process

Yard Piping - Process & Non Process

Yard Piping - Process & Non Process

Yard Piping - Process & Non Process

Yard Piping - Process & Non Process

Yard Piping - C

Yard Piping - Combined Shaft Zone

Yard Piping - Combined Shaft Zone

Yard Piping - Combined Shaft Zone

Yard Piping - Combined Shaft Zone

Yard Piping - Combined Shaft Zone

Yard Piping - Combined Shaft Zone

Yard Piping - Combined Shaft Zone

Yard Piping - Combined Shaft Zone

Yard Piping - Combined Shaft Zone

Yard Piping - Combined Shaft Zone

Yard Piping - A

Yard Piping - ActiDAFF Zone

Yard Piping - ActiDAFF Zone

Yard Piping - ActiDAFF Zone

Yard Piping - ActiDAFF Zone

Yard Piping - ActiDAFF Zone

Yard Piping - ActiDAFF Zone

Yard Piping - ActiDAFF Zone

Yard Piping - ActiDAFF Zone

Yard Piping - ActiDAFF Zone

Yard Piping - ActiDAFF Zone

Actual Level of Effort

ActiDAFF Struc

ActiDAFF Structure (DAF)

ActiDAFF Structure (DAF)

ActiDAFF Structure (DAF)

ActiDAFF Structure (DAF)

ActiDAFF Structure (DAF)

ActiDAFF Structure (DAF)

ActiDAFF Structure (DAF)

ActiDAFF Structure (DAF)

ActiDAFF Structure (DAF)

ActiDAFF Structure (DAF)

Summary Bar

Level Transmitt

Level Transmitters

Level Transmitters

Level Transmitters

Level Transmitters

Level Transmitters

Level Transmitters

Level Transmitters

Level Transmitters

Level Transmitters

Level Transmitters

Constructio

Construction

Construction

Construction

Construction

Construction

Construction

Construction

Construction

Construction

Construction

Target Bar

Page 47

Page 48

Page 49

Page 50

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

Air Quality

S4.8.1

Impervious dust screen or sheeting will be provided to enclose scaffolding from the ground floor level of building for construction of superstructure of the new buildings.

Land site/ During Construction

Contractor(s)

✓

Implemented

Air Pollution Control (Construction Dust)

S4.8.1

Impervious sheet will be provided for skip hoist for material transport.

Land site/ During Construction

Contractor(s)

✓

NA

-

S4.8.1

The area where dusty work takes place should be sprayed with water or a dust suppression chemical immediately prior to, during and immediately after dusty activities as far as practicable.

Land site/ During Construction

Contractor(s)

✓

Implemented

-

S4.8.1

All dusty materials should be sprayed with water or a dust suppression chemical immediately prior to any loading, unloading or transfer operation.

Land site/ During Construction

Contractor(s)

✓

Implemented

-

S4.8.1

Dropping heights for excavated materials should be controlled to a practical height to minimize the fugitive dust arising from unloading.

Land site/ During Construction

Contractor(s)

✓

Implemented

-

S4.8.1

During transportation by truck, materials should not be loaded to a level higher than the side and tail boards and should be dampened or covered before transport.

Land site/ During Construction

Contractor(s)

✓

Implemented

-

S4.8.1

Wheel washing device should be provided at the exits of the work sites. Immediately before leaving a construction site, every vehicle shall be washed to remove any dusty material from its body and wheels as far as practicable.

Land site/ During Construction

Contractor(s)

✓

Implemented

-

S4.8.1

Road sections between vehicle-wash areas and vehicular entrance will be paved.

Land site/ During Construction

Contractor(s)

✓

Implemented

-

S4.8.1

Hoarding of not less than 2.4m high from ground level will be provided along the length of the Project Site boundary.

Land site/ During construction

Contractor(s)

✓

✓

N/A

-

S4.8.1

Haul roads will be kept clear of dusty materials and will be sprayed with water so as to maintain the entire road surface wet at all times.

Land site/ During construction

Contractor(s)

✓

Implemented after reminder

-

S4.8.1

Temporary stockpiles of dusty materials will be either covered entirely by impervious sheets or sprayed with water to maintain the entire surface wet all the time.

Land site/ During construction

Contractor(s)

✓

Implemented after reminder

-

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S4.8.1

Stockpiles of more than 20 bags of cement, dry pulverized fuel ash and dusty construction materials will be covered entirely by impervious sheeting sheltered on top and 3-sides.

Land site/ During construction

Contractor(s)

✓

N/A

-

S4.8.1

All exposed areas will be kept wet always to minimize dust emission.

Land site/ During construction

Contractor(s)

✓

Implemented after reminder

-

S4.8.1

Ultra-low-Sulphur diesel (ULSD) will be used for all construction plant on-site, as defined as diesel fuel containing not more than 0.005% Sulphur by weight) as stipulated in Environment, Transport and Works Bureau Technical Circular (ETWB-TC(W)) No 19/2005 on Environmental Management on Construction Sites.

Land site/ During construction/ During Operation

Contractor(s)

✓

✓

Implemented

Environment, Transport and Works Bureau Technical Circular (ETWB- TC(W)) No 19/2005 on Environmental Management on Construction Sites

S4.8.1

The engine of the construction equipment during idling will be switched off.

Land site/ During construction

Contractor(s)

✓

Implemented

-

S4.8.1

Concrete batching plant will be required on site. control measures recommended in the Guidance Note on a Best Practicable Means for Cement Works (Concrete Batching Plant) (BPM 3/2 (93)) will be implemented. The control measures recommended in the Guidance Note on a Best Practicable Means for Cement Works (Concrete Batching Plant) (BPM 3/2 (93)) will be implemented.

Land site/ During construction

Contractor(s)

✓

N/A

-

S4.8.1

Regular maintenance of construction equipment deployed on- site will be conducted to prevent black smoke emission.

Land site/ During construction

Contractor(s)

✓

Implemented

-

S4.10

To ensure proper implementation of the recommended dust mitigation measures and good construction site practices during the construction phase, environmental site audits on weekly basis is recommended throughout the construction period.

Land site/ During construction

Contractor(s)/ Environmental Team (ET) & Independent Environmental Checker (IEC)

✓

Implemented

-

Noise

S5.7

Only well-maintained plant will be operated on-site, and plant will be serviced regularly during the construction phase.

All area/ During construction

Contractor(s)

✓

Implemented

A Practical Guide for the Reduction of Noise from Construction Works A Practical Guide for the Reduction of Noise from Construction Works

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S5.7

Silencers or mufflers on construction equipment will be utilized and will be properly maintained during the construction phase.

Noise control/ During construction

Contractor(s)

✓

N/A

-

S5.7

Mobile plant, if any, will be sited as far away from NSRs as possible.

Noise control/ During construction

Contractor(s)

✓

N/A

-

S5.7

Machines and plant (such as trucks) that may be in intermittent use will be shut down between work periods or will be throttled down to a minimum.

Noise control/ During construction

Contractor(s)

✓

Implemented

-

S5.7

Plants known to emit noise strongly in one direction will, wherever possible, be orientated so that the noise is directed away from the nearby NSRs.

Noise control/ During construction

Contractor(s)

✓

N/A

-

S5.7

Material stockpiles and other structures will be effectively utilized, wherever practicable, in screening noise from on-site construction activities.

Noise control/ During construction

Contractor(s)

✓

N/A

-

S5.7

Use of Quite Powered Mechanical Equipment (QPME).

Noise control/ During construction

Contractor(s)

✓

Implemented

-

S5.7

Movable noise barriers of 3m in height with skid footing should be used and located within a few meters of stationary plant and mobile plant such that the line of sight to the NSR is blocked by the barriers. The length of the barrier should be at least five times greater than its height. The noise barrier material should have a superficial surface density of at least 7 kg m-2 and have no o or gappeningss.

Noise control/ During construction

Contractor(s)

✓

N/A

-

S5.7

The noise insulating sheet should be deployed such that there would be no opening or gaps on the joints.

Noise control/ During construction

Contractor(s)

✓

N/A

-

S5.7

Construction activities (e.g., excavation/shoring, reinstatement (asphalt), and pipe jacking) will be planned and carried out in sequence, such that items of PME proposed for these activities will not be operated simultaneously.

Noise control/ During construction

Contractor(s)

✓

✓

Implemented

-

S5.7

PMEs will not be used at the works areas near educational institutions with residual impact (i.e., the “influence area” within a radius of 40m) during school hours in order to reduce impact to the educational institutions.

Noise control / During construction

Contractor(s)

✓

N/A

-

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S5.7

Noise enclosures or acoustic sheds would be used to cover stationary PME such as generators. Portable/Movable noise enclosure made of material with superficial surface density of at least 7 kg m-2 may be used for screening the noise from operation of the saw/groover, concrete.

Noise control/ Pre- construction/ During construction

Contractor(s)

✓

✓

N/A

-

5.9

Sawcutting pavement, breaking up of pavement, excavation /shoring, pipe laying, backfilling, reinstatement (concrete) and pipe jacking shall be scheduled outside the examination period.

Noise control/ Pre- construction/ During construction

Contractor(s)

✓

✓

N/A

-

S5.9

In view the duration of noise exceedance at Creative Secondary School, PLK Laws Foundation College, TKO Kei Tak Primary School and School of Continuing and Professional Studies-CUHK is limited to 8 weeks, the construction work in the influence areas near the four schools shall be scheduled during long school holidays (eg summer holiday, Easter holiday or Christmas holiday, etc) as far as practicable. Scheduling the construction work for the four schools.

Noise control/ Pre- construction/ During construction

Contractor(s)

✓

✓

N/A

-

S5.10

A noise monitoring programme shall be implemented for the construction phase.

Designated monitoring stations as defined in EM&A Manual/During construction phase

Environmental Team

✓

N/A

-

S5.10

The effectiveness of on-site control measures could also be evaluated through the regular site audits.

All facilities/ During construction

Contractor(s)/ ET & IEC

✓

Implemented

-

Water Quality

S6.9

Dredged marine sediment will be disposed of in a gazette marine disposal area in accordance with marine dumping permit conditions of the Dumping at Sea Ordinance (DASO).

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

Dumping at Sea Ordinance (DASO)

S6.9

Disposal vessels will be fitted with tight bottom seals in order to prevent leakage of material during transport.

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

-

S6.9

Barges will be filled to a level, which ensures that material does not spill over during transport to the disposal site and that adequate freeboard is maintained to ensure that the decks are not washed by wave action.

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

-

S6.9

After dredging, any excess materials will be cleaned from decks and exposed fittings before the vessel is moved from the dredging area.

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

-

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S6.9

All vessels should be well maintained and inspected before use to limit any potential discharges to the marine environment.

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

-

S6.9

All vessels must have a clean ballast system.

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

-

S6.9

No discharge of sewage/grey wastewater should be allowed. Wastewater from potentially contaminated area on working vessels should be minimized and collected. These kinds of wastewater should be brought back to port and discharged at appropriate collection and treatment system.

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

S6.9

No soil waste is allowed to be disposed overboard.

Marine Dredging/ During construction

Contractor(s)

✓

N/A

S6.9

Silt removal facilities such as silt traps or sedimentation facilities will be provided to remove silt particles from runoff to meet the requirements of the TM standard under the WPCO. The design of silt removal facilities will be based on the guidelines provided in ProPECC PN 1/94. All drainage facilities and erosion and sediment control structures will be inspected on a regular basis and maintained to confirm proper and efficient operation at all times and particularly during rainstorms. Deposited silt and grit will be removed regularly.

Land site & drainage/ During construction

Contractor(s)

✓

Implemented

ProPECC PN 1/94 TM Standard under the WPCO

S6.9

Earthworks to form the final surfaces will be followed up with surface protection and drainage works to prevent erosion caused by rainstorms.

Land site & drainage/ During construction

Contractor(s)

✓

Implemented

-

S6.9

Appropriate surface drainage will be designed and provided where necessary.

Land site & drainage/ During construction

Contractor(s)

✓

Implemented

-

S6.9

The precautions to be taken at any time of year when rainstorms are likely together with the actions to be taken when a rainstorm is imminent or forecasted and actions to be taken during or after rainstorms are summarised in Appendix A2 of ProPECC PN 1/94.

Land site & drainage/ During construction

Contractor(s)

✓

✓

Implemented

ProPECC PN 1/94

S6.9

Oil interceptors will be provided in the drainage system where necessary and regularly emptied to prevent the release of oil and grease into the storm water drainage system after accidental spillages.

Land site & drainage/ During construction

Contractor(s)

✓

N/A

-

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S6.9

Temporary and permanent drainage pipes and culverts provided to facilitate runoff discharge, if any, will be adequately designed for the controlled release of storm flows.

Land site & drainage/ During construction

Contractor(s)

✓

Implemented

-

S6.9

The temporary diverted drainage, if any, will be reinstated to the original condition when the construction work has finished or when the temporary diversion is no longer required.

Land site & drainage/ During construction

Contractor(s)

✓

N/A

-

S6.9

Appropriate numbers of portable toilets shall be provided by a licensed contractor to serve the construction workers over the construction site to prevent direct disposal of sewage into the water environment.

Land site & drainage/ During construction

Contractor(s)

✓

Implemented

-

S6.9 and S6.12

The sterilization water should be dechlorinated with total residual chlorine (TRC) level below 1 mg/L before discharge to public sewer. In situ testing of TRC should also be conducted for the discharge of chlorinated water for pipeline disinfection to ensure sufficient dechlorination before discharge to public sewer.

Sterilization of water mains prior to commissioning

Contractor(s)

✓

✓

N/A

Technical Memorandum for Effluents Discharged into Drainage and Sewerage Systems Inland and Coastal Waters

S6.9

The cleaning and flushing water should also be treated and desilted to the relevant discharge requirement stipulated in TM-DSS before discharging.

Sterilization of water mains prior to commissioning

Contractor(s)

✓

✓

Implemented

S6.9

Site drainage should be well maintained, and good construction practices should be observed to ensure that oil, fuels, solvents and other chemicals are managed, stored and handled properly and do not enter the nearby water streams.

Land site & drainage/ During construction/ During operation

Contractor(s)

✓

✓

Implemented after reminder

-

S6.12

Regular site inspections will be carried out in order to confirm that regulatory requirements are being met and that contractors are implementing the standard site practice and mitigation measures as proposed to reduce potential impacts to water quality.

During construction

Contractor(s)/ ET & IEC

✓

Implemented

-

Waste Management

S8.5

Nomination of approved personnel to be responsible for standard site practices, arrangements for collection and effective disposal to an appropriate facility of all wastes generated at the site.

Contract mobilization/ During construction

Contractor(s)

✓

Implemented

-

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S8.5

Training of site personnel in proper waste management and chemical handling procedures. Training will be provided to workers on the concepts of site cleanliness and appropriate waste management procedures, including waste reduction, reuse and recycling at the beginning of the construction works.

Contract mobilization/ During construction

Contractor(s)

✓

Implemented

-

S8.5

Provision of sufficient waste disposal points and regular collection for disposal.

All area/ During construction/ During operation

Contractor(s)

✓

✓

Implemented

DEVB TC(W) No. 8/2010, Enhanced Specification for Site Cleanliness and Tidiness.

S8.5

Appropriate measures to reduce windblown litter and dust transportation of waste by either covering trucks or by transporting wastes in enclosed containers.

All area/ During construction

Contractor(s)

✓

Implemented

S8.5

A waste management plan (WMP) as stated in the “ETWB TC(W) No. 19/2005, Environmental Management on Construction Sites” for the amount of waste generated, recycled and disposed of (including the disposal sites) will be established and implemented during the construction phase as part of the Environmental Management Plan (EMP). The Contractor will be required to prepare the EMP and submits it to the Architect/ Engineer under the Contract for approval prior to implementation.

All area/ During construction

Contractor(s)

✓

Implemented

ETWB TC(W) No. 19/2005, Environmental Management on Construction Sites

S8.5

Separation of chemical wastes for special handling and appropriate treatment at the Chemical Waste Treatment Centre at Tsing Yi.

All area/ During construction

Contractor(s)

✓

Implemented

Chapters 2 & 3 Code of Practice on the Packaging, Labelling & Storage of Chemical Wastes published under the Waste Disposal Ordinance (Cap 354),

S8.5

Regular cleaning and maintenance programme for drainage systems, sumps and oil interceptors.

Land site/ During construction

Contractor(s)

✓

Implemented

Waste Disposal Ordinance (Cap 354)

S8.5

A recording system for the amount of waste generated/ recycled and disposal sites. The trip- ticket system will be included as one of the contractual requirements and implemented by the contractor(s).

Land site/ During construction

Contractor(s)

✓

Implemented

DEVB TC(W) No. 6/2010, Trip Ticket System for Disposal of Construction &

S8.5

Segregation and storage of different types of waste in different containers, skips or stockpiles to enhance reuse or recycling of material and their proper disposal.

Land site/ During construction/ During operation

Contractor(s)

✓

Implemented

WBTC 32/92, The Use of Tropical Hard Wood on Construction Site

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S8.5

Encourage collection of aluminium cans and wastepaper by individual collectors during construction with separate labelled bins provided to segregate these wastes from other general refuse by the workforce.

Land site/ During construction

Contractor(s)

✓

Implemented

ETWB TCW No. 33/2002, Management of Construction and

S8.5

Any unused chemicals and those with remaining functional capacity will be recycled as far as possible.

Land site/ During construction

Contractor(s)

✓

N/A

-

S8.5

Use of reusable non-timber formwork to reduce the amount of C&D materials.

All areas/ During construction

Contractor(s)

✓

Implemented

WBTC 32/92, The Use of Tropical Hard Wood on Construction Site

S8.5

Prior to disposal of construction waste, wood, steel and other metals will be separated to the extent practical, for re-use and/or recycling to reduce the quantity of waste to be disposed of to landfill.

All areas/ During construction

Contractor(s)

✓

Implemented

DEVB TC(W) No. 6/2010, Trip Ticket System for Disposal of Construction & Demolition Materials

S8.5

Proper storage and site practices to reduce the potential for damage or contamination of construction materials.

All areas/ During construction

Contractor(s)

✓

Implemented

-

S8.5

Plan and stock construction materials carefully to reduce amount of waste generated and avoid unnecessary generation of waste.

All areas/ During construction

Contractor(s)

✓

Implemented

-

S8.5

A Sediment Quality Report (SQR) for sampling and chemical testing of the sediment will be prepared and submitted to the EPD for approval. The approved detailed sampling and chemical testing will be carried out prior to the commencement of the dredging activities to confirm the sediment disposal method.

Marine works/ During construction

Contractor(s)

✓

N/A

ETWB TC(W) No. 34/2002 and Dumping at Sea Ordinance (DASO)

S8.5

The management of dredged/ excavated sediment management requirement from ETWB TC(W) No. 34/2002 will be incorporated in the Specification of the Contract Documents.

Marine works/ During construction

WSD/ Contractor(s)

✓

Implemented

ETWB TC(W) No. 34/2002 and Dumping at Sea Ordinance (DASO)

S8.5

The contractor will open a billing account with EPD in accordance with the Waste Disposal (Charges for Disposal of Construction Waste) Regulation for the payment of disposal charges.

Contract mobilization/ During construction

Contractor(s)

✓

Implemented

Cap 354N Waste Disposal (Charges for Disposal of Construction Waste) Regulation

S8.5

A trip-ticket system will be established in accordance with DEVB TC(W) No. 6/2010 to monitor the reuse of surplus excavated materials off-site and disposal of construction waste and general refuse at transfer facilities/ landfills, and to control fly-tipping.

Contract mobilization/ During construction

Contractor(s)

✓

Implemented

DEVB TC(W) No. 6/2010, Trip Ticket System for Disposal of Construction & Demolition Materials

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S8.5

The project proponent will also conduct regular inspection of the waste management measures implemented on site as described in the Waste Management Plan.

All area/ During construction

Contractor(s)/ Environmental Team (ET) & Independent Environmental Checker (IEC)

✓

Implemented

ETWB TC(W) No. 19/2005, Environmental Management on Construction Sites

S8.5

A recording system (similar to summary table as shown in Annex 5 and Annex 6 of Appendix G of ETWB TC(W) No. 19/2005) for the amount of waste generated, recycled and disposed of (including the disposal sites) will be established during the construction phase.

All area/ During construction

Contractor(s)

✓

Implemented

Annex 5 and Annex 6 of Appendix G of ETWB TC(W) No. 19/2005

S8.5

Inert C&D materials (public fill) will be reused within the Project as far as practicable.

All area/ During construction

Contractor(s)

✓

Implemented

-

S8.5

Public fill and construction waste shall be segregated and stored in different containers or skips to facilitate reuse or recycling of materials and their proper disposal.

All area/ During construction

Contractor(s)

✓

Implemented

-

S8.5

Specific areas of the work site will be designated for such segregation and storage if immediate use is not practicable.

All area/ During construction

Contractor(s)

✓

Implemented

-

S8.5

To reduce the potential dust and water quality impacts of site formation works, C&D materials will be wetted as quickly as possible to the extent practice after filling.

All area/ During construction

Contractor(s)

✓

Implemented

Air Pollution Control (Construction Dust) Regulation (Cap 311R); WPCO (Cap 358)

S8.5

Open stockpiles of excavated/ fill materials or construction wastes on-site should be covered with tarpaulin or similar fabric.

Land site/ During Construction, particularly dry season

Contractor(s)

✓

Implemented

Air Pollution Control (Construction Dust) Regulation (Cap 311R)

S8.5

Chemical waste container shall be suitable for the substance they are holding, resistant to corrosion, maintained in a good condition, and securely closed.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

Waste Disposal (Chemical Waste) (General) Regulation; Code of Practice on the Packaging, Handling and Storage of Chemical Wastes

S8.5

Chemical waste container shall have a capacity of less than 450 L unless the specifications have been approved by the EPD.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

S8.5

A label in English and Chinese shall be displayed on the chemical container in accordance with instructions prescribed in Schedule 2 of the Regulations.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S8.5

Storage areas for chemical waste shall be enclosed on at least 3 sides.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

S8.5

Storage areas for chemical waste shall have an impermeable floor and bunding, of capacity to accommodate 110% of the volume of the largest container or 20% by volume of the chemical waste stored in that area, whichever is the greatest.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

S8.5

Storage areas for chemical waste shall have adequate ventilation.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

S8.5

Storage areas for chemical waste shall be covered to prevent rainfall entering (water collected within the bund must be tested and disposed of as chemical waste, if necessary).

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

S8.5

Storage areas for chemical waste shall be arranged so that incompatible materials are appropriately separated.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

S8.5

General refuse will be stored in enclosed bins or compaction units separately from construction and chemical wastes.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented after reminder

S8.5

Adequate number of waste containers will be provided to avoid over-spillage of waste.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

DEVB TC(W) No. 8/2010 Enhanced Specification for Site Cleanliness and Tidiness.

S8.5

A reputable waste collector will be employed by the Contractor to remove general refuse from the site, separately from construction and chemical wastes, on a daily basis to minimise odour, pest and litter impacts.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented after reminder

-

S8.5

Recycling bins will be provided at strategic locations within the Site to facilitate recovery of recyclable materials (including aluminum can, waste paper, glass bottles and plastic bottles) from the Site. Materials recovered will be sold for recycling.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

-

S8.5

To avoid any odour and litter impact, accurate number of portable toilets will be provided for workers on-site.

All area/ During construction

Contractor(s)

✓

Implemented

-

S8.5

The burning of refuse on construction sites is prohibited by law.

All area/ During construction

Contractor(s)

✓

Implemented

Air Pollution Control Ordinance (Cap 311)

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S8.7

To facilitate monitoring and control over the contractors’ performance on waste management, a waste inspection and audit programme will be implemented throughout the construction phase.

All facilities/ During construction

ET/ IEC

✓

Implemented

-

Ecology

S9.7

For slope mitigation works within the Clear Water Bay Country Park, to avoid tree felling and damages to trees, the exact locations of the flexible barrier foundation plates, soil nails and rock dowels can be adjusted during detailed design, and a setback distance from existing trees is recommended to be maintained as far as practical. A detailed specification describing the exact locations of the flexible barrier foundation plates, soil nails and rock dowels will be prepared to illustrate how the setback distance from existing trees would be implemented for tree avoidance.

Slope mitigation works area/ During detailed design/ During construction

Contractor(s)

✓

✓

Implemented

-

S9.7

Pruning of tree canopies along the alignment of the flexible barriers shall be limited to a minimum.

Slope mitigation works area/ During construction

Contractor(s)

✓

Implemented

S9.7

The alignment of flexible barriers shall be optimized to preserve all species of conservation interest and minimize the impact to the existing vegetation as far as practicable. All individuals of Marsdenia lachnostoma within the slope mitigation areas shall be retained in- situ, by positioning the alignment of flexible barrier at a minimum 1.5m in a radius away from these individuals.

Slope mitigation works area/ During detailed design/ During construction

Contractor(s)

✓

✓

Implemented

-

S9.7 and 9.10

At the detailed design stage prior to the commencement of the slope mitigation works, a vegetation survey shall be carried out at the slope mitigation areas within the Clear Water Bay Country Park to assess the condition and identify the location of each individual of Marsdenia lachnostoma and other flora species of conservation interest that may be directly affected by the construction works.

Slope mitigation works area/ During detailed design/ During construction

Contractor(s)

✓

Implemented

-

S9.7

Temporary fencing will be installed to fence off the concerned species either in groups of individually within the works area and in the close proximity to prevent from being damaged and disturbed during construction. A sign identifying the site shall be attached to the fence and flagging tape shall be attached to the individuals to visualize their locations.

Slope mitigation works area/ During construction

Contractor(s)

✓

Implemented

-

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S9.7 and S9.10

A specification for fencing and demarcating individuals of Marsdenai lachnostoma (or other flora species of conservation interest, if found) adjacent to the proposed alignment of the flexible barriers will be prepared to protect the species.

Slope mitigation works area/ During construction

Contractor(s)

✓

Implemented

-

S9.7

Induction training shall also be provided to all site personnel in order to brief them on this flora of conservation interest including the locations and their importance.

Slope mitigation works area/ During construction

Contractor(s)

✓

Implemented

-

S9.7

The resident site supervisory staff will closely monitor the conditions of concerned individuals during construction of flexible barriers in the close proximity.

Slope mitigation works area/ During construction

Contractor(s)

✓

Implemented

-

S9.7

Erect fences along the boundary of the works area before the commencement of works to prevent vehicle movements and encroachment of personnel onto adjacent areas.

All area/ During construction

Contractor(s)

✓

Implemented

-

S9.7

Regularly check the work site boundaries to ensure that they are not breached and that damage does not occur to surrounding areas.

All area/ During construction

Contractor(s)/ ET

✓

Implemented after reminder

-

S9.7

Avoid any damage and disturbance, particularly those caused by filling and illegal dumping, to the surrounding habitats through proper management of waste disposal.

All area/ During construction

Contractor(s)

✓

Implemented

-

S9.7

Reinstate temporarily affected areas, particularly the habitats of plantation and shrubland-grassland immediately after completion of construction works, through on-site tree/shrub planting. The tree/shrub species will be chosen with reference to those in the surrounding area.

All area/ During construction

Contractor(s)

✓

To be Implemented

-

S9.7

Affected habitats within the Clear Water Bay Country Bay shall be reinstated by hydro-seeding and planting of climbers and native shrub seedlings where practical upon completion of the slope mitigation works.

All area/ During construction

Contractor(s)

✓

To be Implemented

-

Landscape & Visual

S11.10 & 11.11

The construction area and area allowed for temporary structures, such as the contractor’s office, will be minimized to a practical minimum. (MM1)

All area/ Detailed design/ During construction/ During operation

WSD/ Contractor(s)

✓

✓

✓

Implemented

-

S11.10 & 11.11

At the detailed design stage, the design team will seek to minimize the landscape footprint of the Project and above ground facilities, while satisfying all other requirements. (MM2)

All area/ Detailed design/ During construction/ During operation

WSD/ Contractor(s)

✓

✓

✓

Implemented

-

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S11.10 & 11.11

Design principles will be adopted to take into account the surrounding area, particularly Clear Water Bay Country Park behind and the nearby waterfront, with due consideration given to: - green roofs where practical (i.e. without equipment on the roof); - roadside planting; - aesthetic treatment of all structures; - vertical greening; - screen planting along application site; and - landscape enhancement with amenity planting where practical including planting along the edge (site boundary) fence with native shrubs where feasible, to reduce their visual impact and blend them into the surrounding landscape. (MM3)

All area/ Detailed design/ During construction/ During operation

WSD/ Contractor(s)

✓

✓

✓

Implemented

--

S11.10 & 11.11

All trees within the Project Site or the potential slope mitigation works area will be carefully protected during construction according to DEVB TCW No. 10/2013 – Tree Preservation (MM4)

All area/ Detailed design/ During construction/ During operation

WSD/ Contractor(s)

✓

✓

✓

Implemented after reminder

ETWB TCW No. 3/2006 - Tree Preservation.

S11.10 & 11.11

No tree within the Country Park will be felled. Trees within the Site unavoidably affected by the works will be transplanted where necessary and practical. For trees that need to be felled, compensatory planting will be provided to the satisfaction of relevant Government departments. A compensatory tree planting proposal including locations of tree compensation will be submitted to seek relevant government department’s approval, in accordance with DEVB TC(W) No. 10/2013. (MM5)

All area/ Detailed design/ During construction/ During operation

WSD/ Contractor(s)

✓

✓

✓

Implemented

DEVB TC(W) No. 10/2013

S11.10 & 11.11

Any slope mitigation works necessary to address natural terrain hazards, will be minimized to minimize any potential environmental impact to the Country Park e.g. soil nailing and rock stabilization will aim to avoid existing trees e.g. should any restoration of vegetation be necessary, the best planting matrix with native species will be established, with the aim of resembling the existing vegetation. (MM6)

All area/ Detailed design/ During construction/ During operation

WSD/ Contractor(s)

✓

✓

✓

N/A

-

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S11.10 & 11.11

Dredging works for the installation of intake structures and outfall diffusers should be minimized to avoid or reduce any potential environmental impacts to as low as reasonably practicable (ALARP). The intake and outfall structures (e.g. intake openings and diffuser heads) will be prefabricated and transferred to site for installation. (MM7)

All area/ Detailed design/ During construction/ During operation

WSD/ Contractor(s)

✓

✓

✓

Implemented

-

S11.10 & 11.11

All night-time lighting will be reduced to a practical minimum both in terms of number of level and will be hooded and directional. (MM8) units and lux level and will be hooded and directional. (MM8)

All area/ Detailed design/ During construction/ During operation

WSD/ Contractor(s)

✓

✓

✓

Implemented

-

Landfill Gas Hazard

S12.7

During all works, safety procedures should be implemented to minimise the risks of fires and explosions, asphyxiation of workers and toxicity effects resulting from contact with contaminated soil and groundwater.

All area/ Detailed design/ During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

During trenching and excavation as well as creation of confined spaces at near to or below ground level, precautions should be clearly laid down and rigidly Gas detection equipment and appropriate breathing apparatus should be available and used when entering confined spaces or trenches deeper than 1 meter.

All area/ Detailed design/ During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

The Contractor should make the workers are aware of potential hazards of working in confined spaces (any chamber, manhole or culvert which is large enough to permit access to personnel). Such work in confined spaces is controlled by the Factories and Industrial Undertakings (Confined Spaces) Regulations of the Factories and Industrial Undertakings Ordinance. Following the Safety Guide to Working in Confined Spaces ensures compliance with the above regulations.

All area/ Detailed design/ During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

Safety officers, specifically trained with regard to landfill gas and leachate related hazards and the appropriate actions to take in adverse circumstances, should be present on the site throughout the works, in particular, when works are undertaken below grade.

All area/ Detailed design/ During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

All personnel who work on site and all visitors to the site should be made aware of the possibility of ignition of gas in the vicinity of the works, the possible presence of contaminated water and the need to avoid physical contact with it.

All area/ Detailed design/ During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S12.7

Monitoring for landfill gas should be undertaken in all excavations, manholes, chambers (particularly during pipe jacking) and any confined spaces through the use of an intrinsically safe portable instrument, appropriately calibrated and capable of measuring the concentrations of methane. carbon dioxide and oxygen.

All area/ Detailed design/ During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

Monitoring frequency and areas to be monitored should be specified prior to commencement of groundwork, either by the Safety Officer, or by an appropriately qualified person. All measurements should be recorded and documented.

All area/ Detailed design/ During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

Proceed drilling with adequate care and precautions against the potential hazards which may be encountered.

All area/ Detailed design/ During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

Prior to the commencement of the site works, the drilling contractor should devise a 'method-of- working' statement covering all normal and emergency procedures (including but not limited to number of operatives, experience and special skills of operatives, normal method of operations, emergency procedures, supervisors responsibilities, storage and use of safety equipment, safety procedures and signs, barriers and guarding). The site supervisor and all operatives must be familiar with this statement.

All area/ During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

Where below ground service entries are necessary to the Incoming Switchgear Room, 132 kV Substation and Chlorine Store (I) and (II), the entry point should be sealed to prevent gas entry. In addition, any below grade cable trenches entering the Incoming Switchgear Room and 132 kV Substation can become the pathway for landfill gas and hence grilled metal covers should be used.

All area/ Detailed design/ During construction/ During operation

Contractor(s)

✓

✓

✓

N/A

-

S12.7

It is recommended regular landfill gas monitoring should be carried out at the Incoming Switchgear Room, 132 kV Substation and Chlorine Store (I) and (II). The monitoring frequency will be monthly for the first year of operation. If the monitoring results show no sign of landfill gas migration, reduce the monitoring frequency to once every six months.

All area/ Detailed design/ During construction/ During operation

Contractor(s)

✓

✓

✓

N/A

-

Quarterly EM&A Report

EIA Reference

Recommended Environmental Protection Measures/ Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant Legislation & Guidelines

D

C

O

S12.7

The manholes and utility pits within the Project Site and along the freshwater mains. Each manhole/ utility pit should be monitored with two measurements (at mid depth and base). Each measurement should be monitored for a minimum of 10 minutes. A steady reading and peak reading should be recorded at each manhole/ utility pit and for each measurement. The need for venting the manhole/ utility pit and further monitoring will be reviewed after the initial monitoring.

All area/ Detailed design/ During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

All construction, operation and maintenance personnel working on-site as well as visitors should be made aware of the hazards of landfill gas and its possible presence on-site. This should be achieved through a combination of posting warning signs in prominent places and also by access to detailed information on landfill gas hazards and the designs and procedural means by which these hazards are being minimized on-site.

All area/ Detailed design/ During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

Note: D – Design stage C – Construction O – Operation

Page 67

Page 68

Tseung Kwan O Desalination Plant

Monitoring Location: CE

Iron

Iron

0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

TRC

0.3 0.25 Concentration, mg/L

0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

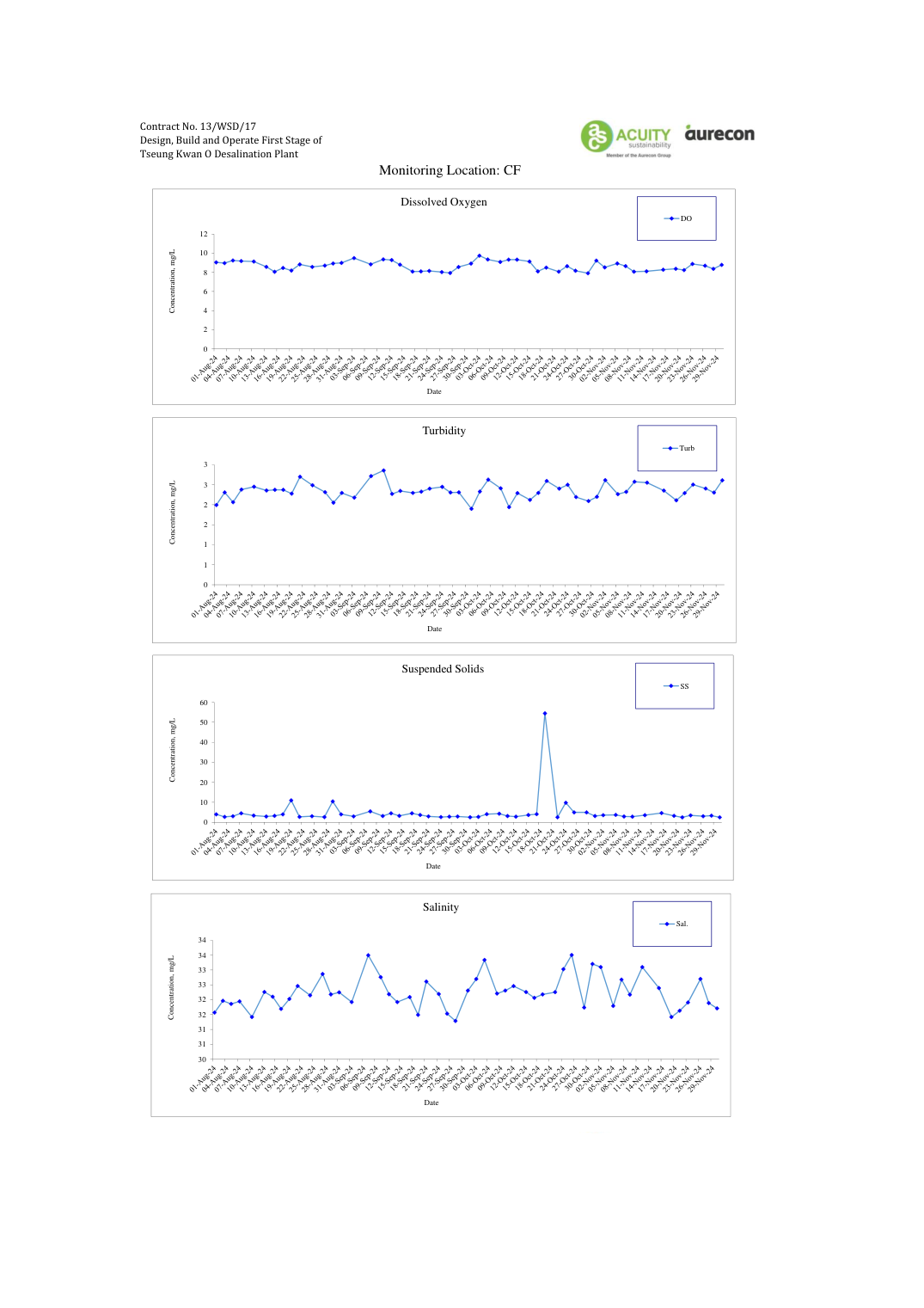

Page 70

Tseung Kwan O Desalination Plant

Monitoring Location: CF

Iron

Iron

0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

TRC

0.3 0.25 Concentration, mg/L

0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

Page 72

Tseung Kwan O Desalination Plant

Monitoring Location: WSR1

Iron

Iron

Action Level

0.35 0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

TRC

Action Level

0.012 Concentration, mg/L

0.01 0.008 0.006 0.004 0.002 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

Page 74

Tseung Kwan O Desalination Plant

Monitoring Location: WSR2

Iron

Iron

Action Level

0.35 0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

TRC

Action Level

0.012 Concentration, mg/L

0.01 0.008 0.006 0.004 0.002 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

Page 76

Tseung Kwan O Desalination Plant

Monitoring Location: WSR3

Iron

Iron

Action Level

0.35 0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

Iron

Action Level

0.35 0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

Page 78

Tseung Kwan O Desalination Plant

Monitoring Location: WSR4

Iron

Iron

Action Level

0.35 0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

TRC

Action Level

0.012 Concentration, mg/L

0.01 0.008 0.006 0.004 0.002 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

Page 80

Tseung Kwan O Desalination Plant

Monitoring Location: WSR16

Iron

Iron

Action Level

0.35 0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

TRC

Action Level

0.012 Concentration, mg/L

0.01 0.008 0.006 0.004 0.002 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

Page 82

Tseung Kwan O Desalination Plant

Monitoring Location: WSR33

Iron

Iron

Action Level

0.35 0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

TRC

Action Level

0.012 Concentration, mg/L

0.01 0.008 0.006 0.004 0.002 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

Page 84

Tseung Kwan O Desalination Plant

Monitoring Location: WSR36

Iron

Iron

Action Level

0.35 0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

TRC

Action Level

0.012 Concentration, mg/L

0.01 0.008 0.006 0.004 0.002 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

Page 86

Tseung Kwan O Desalination Plant

Monitoring Location: WSR37

Iron

Iron

Action Level

0.35 0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

TRC

Action Level

0.12 Concentration, mg/L

0.1 0.08 0.06 0.04 0.02 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

Page 88

Tseung Kwan O Desalination Plant

Monitoring Location: NF1

Iron

Iron

Action Level

0.35 0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

TRC

Action Level

0.12 0.1 Concentration, mg/L

0.08 0.06 0.04 0.02 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

Page 90

Tseung Kwan O Desalination Plant

Monitoring Location: NF2

Iron

Iron

Action Level

0.35 0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

TRC

Action Level

0.12 0.1 Concentration, mg/L

0.08 0.06 0.04 0.02 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

Page 92

Tseung Kwan O Desalination Plant

Monitoring Location: NF3

Iron

Iron

Action Level

0.35 0.3 Concentration, mg/L

0.25 0.2 0.15 0.1 0.05 0 Date

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Total Residual Chlorine

TRC

Action Level

0.12 0.1 Concentration, mg/L

0.08 0.06 0.04 0.02 0 Date

Remark: The lowest detection limit of the Total Residual Chlorine is 0.01mg/L. All result of Total Residual Chlorine monitoring are lower than the detection limit.

Continuous Effluent Monitoring

Salinity

Sal (ppt)

Limit Level

80 70 Concentration, mg/L

60 50 40 30 20 10 0 Month

pH

pH

Limit Level

1

2

3

4

5

6

7

8

9

10

11

12

13

14

pH

Month

Temperature

Temp (°C)

Limit Level

45 40 35 30 Temp (°C)

25 20 15 10 5 0 Month

Continuous Effluent Monitoring

Total Residual Chlorine

Total Residual Chlorine

(mg/L)

Limit Level

0.16 0.14 Concentration, mg/L

0.12 0.10 0.08 0.06 0.04 0.02 0.00 Month

Suspended Solids

Suspended Solids (mg/L)

Limit Level

0

1

2

3

4

5

6

7

8

9

10

11

12

13

14

15

Concentration, mg/L

Month

Total Inorganic Nitrogen

Total Inorganic Nitrogen

(mg/L)

Limit Level

0.0

0.2

0.4

0.6

0.8

1.0

1.2

1.4

1.6

1.8

2.0

2.2

Concentration, mg/L

Month

Continuous Effluent Monitoring

Total Phosphorus

Total Phosphorus (mg/L)

Limit Level

0.00

0.10

0.20

0.30

0.40

0.50

0.60

0.70

0.80

0.90

1.00

1.10

1.20

Concentration, mg/L

Month

Sodium Metabisulphite

Sodium Metabisulphite

(mg/L)

Limit Level

5.00 4.50 Concentration, mg/L

4.00 3.50 3.00 2.50 2.00 1.50 1.00 0.50 0.00 Month

Remark: Due to the limitation of the laboratory, the lowest result for Sodium Metabisulphite will only be shown as < 2 mg/L.

Iron

Iron

(mg/L)

Limit Level

1.00 0.90 Concentration, mg/L

0.80 0.70 0.60 0.50 0.40 0.30 0.20 0.10 0.00 Month

Page 97

Page 98

Page 99

Page 100

Page 101

September 2024

All Area

• Security Fence footing construction work •

Footpath Construction

• Landscape Construction

• Irrigation System Construction

• Water Pressure Test for FS and PL system •

Landscape planting work

• Traffic signage work

• E&M Works and Mechanical Installation

PWST

• Water Test in Tank A

• Waterproofing work at Roof Slab on Tank A •

Installation of building services, electrical switchboards and cables •

Installation of mechanical equipment, steel pipe, Pressure Test

Administration Building

• External wall aluminum features installation •

Finishing works for dog house

• Minor Installation of building services, electrical switchboards & cables, Pressure Test, T&C

Chemical building

• Defect rectification

• Repairing the defects inside the dangerous store

Combined Shaft & Pump House

• Internal finishing, defect rectification •

Construction of hose reel cabinet

• T&C

ActiDAFF

• Installation of access opening covers for filtered water tank •

Carrying out finishing works for staircase no. 3.

• Minor Installation of mechanical equipment, piping system •

Minor Installation of building services, electrical switchboards and cables, Installation of FRP Enclosure System

Product Water Storage Tank Building

• Minor Installation of building services, cable laying and termination, PV Panel Installation, Testing & Commissioning

OSCG Building

• Protective Coating for DG Rooms

• Installation of Railing on Brine Maker Tank •

Minor Installation of building services, cables and pipe works, T&C •

Tank surface cleaning, T&C

Reverse Osmosis Building

• Installation of Signage, AP doors, sanitary fitting, sanitary ware in toilet, tiling work and water meter cabinets

• Minor Installation of building services, minor cable laying and termination, Testing & Commissioning, PV Panel Installation

Post Treatment Building

• Installation of Cat Ladders in Water Tanks •

Placing Soil Mix at Roof

• Curb Construction for Rescue Opening at Water Tanks •

Installation of building services, piping system, mechanical equipment and piping system, Pressure Test

Inspection gallery

• Construction of roof tiling works

• Installation of steel balustrade at roof •

Installation of movement joints

• Construction of block works

• Minor Installation of building service, T&C

RO and Electrical Building

• Installation of Glass House

• Minor Installation of building services, electrical switchboards and cables •

Minor Installation of mechanical pipework and raised Floor, •

PV Panel Installation, T&C

Chiller plant & Main Electrical Building

• Minor Installation of building services, electrical switchboards and cables, Pressure Test, T&C

Others

• Slope works

• Construction works of extended access road

October 2024

All Area

• Security Fence footing construction work •

Footpath Construction

• Landscape Construction

• Irrigation System Construction

• Water Pressure Test for FS and PL system •

Landscape planting work

• Traffic signage work

• E&M Works and Mechanical Installation

PWST

• Water Test in Tank A

• Waterproofing work at Roof Slab on Tank A •

Installation of building services, electrical switchboards and cables •

Installation of mechanical equipment, steel pipe, Pressure Test

Administration Building

• External wall aluminum features installation •

Finishing works for dog house

• Minor Installation of building services, electrical switchboards & cables, Pressure Test, T&C

Chemical building

• Defect rectification

• Repairing the defects inside the dangerous store

Combined Shaft & Pump House

• Internal finishing, defect rectification •

Construction of hose reel cabinet

• T&C

ActiDAFF

• Installation of access opening covers for filtered water tank •

Carrying out finishing works for staircase no. 3.

• Minor Installation of mechanical equipment, piping system •

Minor Installation of building services, electrical switchboards and cables, Installation of FRP Enclosure System

Product Water Storage Tank Building

• Minor Installation of building services, cable laying and termination, PV Panel Installation, Testing & Commissioning

OSCG Building

• Protective Coating for DG Rooms

• Installation of Railing on Brine Maker Tank •

Minor Installation of building services, cables and pipe works, T&C •

Tank surface cleaning, T&C

Reverse Osmosis Building

• Installation of Signage, AP doors, sanitary fitting, sanitary ware in toilet, tiling work and water meter cabinets

• Minor Installation of building services, minor cable laying and termination, Testing & Commissioning, PV Panel Installation

Post Treatment Building

• Installation of Cat Ladders in Water Tanks •

Placing Soil Mix at Roof

• Curb Construction for Rescue Opening at Water Tanks •

Installation of building services, piping system, mechanical equipment and piping system, Pressure Test

Inspection gallery

• Construction of roof tiling works

• Installation of steel balustrade at roof •

Installation of movement joints

• Construction of block works

• Minor Installation of building service, T&C

RO and Electrical Building

• Installation of Glass House

• Minor Installation of building services, electrical switchboards and cables •

Minor Installation of mechanical pipework and raised Floor, •

PV Panel Installation, T&C

Chiller plant & Main Electrical Building

• Minor Installation of building services, electrical switchboards and cables, Pressure Test, T&C

Others

• Slope works

• Construction works of extended access road

November 2024

All Area

• Security Fence footing construction work •

Footpath Construction

• Landscape Construction

• Irrigation System Construction

• Water Pressure Test for FS and PL system •

Landscape planting work

• Traffic signage work

• E&M Works and Mechanical Installation

PWST

• Water Test in Tank A

• Waterproofing work at Roof Slab on Tank A •

Installation of building services, electrical switchboards and cables •

Installation of mechanical equipment, steel pipe, Pressure Test

Administration Building

• External wall aluminum features installation •

Finishing works for dog house

• Minor Installation of building services, electrical switchboards & cables, Pressure Test, T&C

Chemical building

• Defect rectification

• Repairing the defects inside the dangerous store

Combined Shaft & Pump House

• Internal finishing, defect rectification •

Construction of hose reel cabinet

• T&C

ActiDAFF

• Installation of access opening covers for filtered water tank •

Carrying out finishing works for staircase no. 3.

• Minor Installation of mechanical equipment, piping system •

Minor Installation of building services, electrical switchboards and cables, Installation of FRP Enclosure System

Product Water Storage Tank Building

• Minor Installation of building services, cable laying and termination, PV Panel Installation, Testing & Commissioning

OSCG Building

• Protective Coating for DG Rooms

• Installation of Railing on Brine Maker Tank •

Minor Installation of building services, cables and pipe works, T&C •

Tank surface cleaning, T&C

Reverse Osmosis Building

• Installation of Signage, AP doors, sanitary fitting, sanitary ware in toilet, tiling work and water meter cabinets

• Minor Installation of building services, minor cable laying and termination, Testing & Commissioning, PV Panel Installation

Post Treatment Building

• Installation of Cat Ladders in Water Tanks •

Placing Soil Mix at Roof

• Curb Construction for Rescue Opening at Water Tanks •

Installation of building services, piping system, mechanical equipment and piping system, Pressure Test

Inspection gallery

• Construction of roof tiling works

• Installation of steel balustrade at roof •

Installation of movement joints

• Construction of block works

• Minor Installation of building service, T&C

RO and Electrical Building

• Installation of Glass House

• Minor Installation of building services, electrical switchboards and cables •

Minor Installation of mechanical pipework and raised Floor, •

PV Panel Installation, T&C

Chiller plant & Main Electrical Building

• Minor Installation of building services, electrical switchboards and cables, Pressure Test, T&C

Others

• Construction works of extended access road

Page 108

Other Factors might affect the monitoring results

Reporting Period

Aug 2024

Sep 2024

Oct 2024

Nov 2024

N/A

N/A

N/A

N/A

Page 110

Quarterly EM&A Report

Table E1

Summary of Exceedance in Sep 2024

Date of exceedance

Monitoring Station

Tide

SS Level (mg/L)

Action Level

Limit Level

07/09/2024

WSR33

Flood

5.33

Y

N

WSR36

5.33

Y

N

NF1

5.33

Y

N

12/09/2024

WSR4

Ebb

5.08

Y

N

NF1

5.17

Y

N

14/09/2024

WSR3

Ebb

3.67

Y

N

NF2

4.17

Y

Y

17/09/2024

WSR3

Ebb

4.83

Y

N

WSR4

6.17

Y

Y

WSR16

5.83

Y

Y

WSR36

4.67

Y

N

WSR37

4.67

Y

N

19/09/2024

WSR4

Ebb

4.50

Y

Y

WSR33

5.67

Y

Y

WSR36

5.50

Y

Y

WSR37

5.17

Y

Y

NF1

6.17

Y

Y

NF2

5.67

Y

Y

NF3

5.17

Y

Y

21/09/2024

WSR3

Flood

4.25

Y

Y

24/09/2024

WSR37

Flood

4.75

Y

Y

26/09/2024

WSR37

Ebb

4.42

Y

Y

NF3

4.42

Y

Y

28/09/2024

WSR2

Ebb

3.42

Y

N

WSR3

3.83

Y

Y

WSR4

3.33

Y

N

WSR36

4.50

Y

Y

WSR37

5.50

Y

Y

NF1

4.67

Y

Y

NF2

4.50

Y

Y

NF3

5.83

Y

Y

Page 112

Page 113

Page 114

Environmental Management Plan for Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant Appendix F - Monthly Summary Waste Flow Table

Name of Department: WSD

Contract No.: 13/WSD/17

Monthly Summary Waste Flow Table for 2024 (year)

w

Month

Actual Quantities of Inert C&D Materials Generated Monthly

Actual Quantities of C&D Wastes Generated Monthly

Total Quantity Generated

Hard Rock and Large Broken Concrete

Reused in the Contract

Reused in other Projects

Disposed as Public Fill

Imported Fill

Metals

Paper/ cardboard packaging

Plastics (see Note 3)

Chemical Waste

Others, e.g. general refuse

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000 kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

Jan

4978.345

0.000

0.000

4667.745

310.600

0.000

0.000

0.000

0.000

0.000

77.800

Feb

22561.796

0.000

0.000

21883.006

678.790

0.000

0.000

0.000

0.000

0.000

53.480

Mar

81.140

0.000

0.000

0.000

81.140

0.000

0.000

0.000

0.000

0.000

52.260

Apr

57.130

0.000

0.000

0.000

57.130

0.000

0.000

0.000

0.000

0.000

47.390

May

91.370

0.000

0.000

0.000

91.370

0.000

0.000

0.000

0.000

0.000

77.260

Jun

49.190

0.000

0.000

0.000

49.190

0.000

0.000

0.000

0.002

0.000

60.780

Sub-total

27818.971

0.000

0.000

26550.751

1268.220

0.000

0.000

0.000

0.002

0.000

368.970

Jul

60378.440

0.000

0.000

0.000

60378.440

0.000

0.000

0.000

0.000

0.000

42.820

Aug

57.390

0.000

0.000

0.000

57.390

0.000

0.000

0.000

0.000

2.460

33.980

Sep

834.890

0.000

0.000

0.000

834.890

0.000

0.000

0.000

0.000

0.805

27.020

Oct

78.140

0.000

0.000

0.000

78.140

0.000

0.000

0.000

0.000

0.000

71.810

Nov

237.790

0.000

0.000

0.000

237.790

0.000

0.000

0.000

0.000

0.000

62.300

Dec

Total

89405.621

0.000

0.000

26550.751

62854.870

0.000

0.000

0.000

0.002

3.265

606.900

Notes:

(1)

(2)

(3)

The performance targets are given in Section 1.69 of Specification B The waste flow table shall also include C&D materials that are specified in the Contract to be imported for use at the Site.

Plastics refer to plastic bottles/containers, plastic sheets/ foam from packaging material

第 1 頁,共 1 頁

Page 116

Quarterly EM&A Report

Table G1

Statistical Summary of Environmental Complaints

Reporting Period

Environmental Complaint Statistics

Frequency

Cumulative

Complaint Nature

1 September 2024 - 30 November 2024

0

2

N/A

Table G2

Statistical Summary of Environmental Summons

Reporting Period

Environmental Summons Statistics

Frequency

Cumulative

Details

1 September 2024 - 30 November 2024

0

0

N/A

Table G3

Statistical Summary of Environmental Prosecution

Reporting Period

Environmental Prosecution Statistics

Frequency

Cumulative

Details

1 September 2024 - 30 November 2024

0

0

N/A

Page 118

Page 119

Page 120

Page 121

Page 122

Page 123
