Contract No. 13/WSD/17

Design, Build and Operate First Stage of Tseung Kwan O

Desalination Plant

Final EM&A Review Report

(Period from March 2020 to July 2025)

Document No.

ASCL

/

200168078

/

FEMAR1

/

3

Publisher

Project Code

Sequential No.

Revision Index

Reviewed and Certified by:

Name

Toby Wan

Position

Environmental Team Leader

Signature

Date:

26 September 2026

Acuity Sustainability Consulting Limited tel +852 2698 6833

Flat/RM E, 12/F, Ford Glory Plaza, fax +852 2698 9383︱e-mail admin@acuityhk.com

Nos. 37-39 Wing Hong Street, Kowloon, Hong Kong http www.acuityhk.com︱www.aurecongroup.com

Our ref.:  LES/J2024-01/CS/L146

Date      :  29 September 2026

By Post and Email

Water Supplies Department

New Works Branch

Consultants Management Division

6/F, Sha Tin Government Offices,

1 Sheung Wo Che Road, Sha Tin,

New Territories

Attn: Mr. W.S. Wong / S K Wong

Dear Sir,

Independent Environmental Checker (IEC) for Construction and Operation of the

First Stage Desalination Plant at Tseung Kwan O (Quotation Ref. No. TKO1/IEC/003)

Verification of Final Environmental Monitoring and Audit (EM&A) Review Report

Referring to the Final Environmental Monitoring and Audit (EM&A) Review Report (rev.4) as submitted by the Environmental Team on 28 September 2026, we hereby verify the captioned report in accordance with Clause 14.6 of the EM&A Manual.

Should you have any queries, please contact the undersigned at 61496683, or email at serenashek@lamenviro.com.

Yours sincerely,

For and On Behalf Of

Lam Environmental Services Limited

Serena Shek

Independent Environmental Checker

Binnies                   (Attn.: Image Yeung)                                                                         By E-mail

Aurecon                 (Attn.: Toby Wan)                                                                               By E-mail

Lam Environmental Services Limited

Unit No. 03, 29/F, New Treasure Centre, 10 Ng Fong Street, San Po Kong, Kowloon Tel: 3752 3580   Fax: 3460 2905 Website: www.lamenvron.com

REVISION HISTORY

REV.

DESCRIPTION OF MODIFICATION

DATE

0.

First Issue

17/06/2026

1.

Second Issue

10/08/2026

2.

Third Issue

11/09/2026

3.

Fourth Issue

16/09/2026

4.

Fifth Issue

26/09/2026

i

CONTENTS

Executive Summary..................................................................................................................................................................... 4

1.  Basic Contract Information................................................................................................................................................ 7

2.  Noise......................................................................................................................................................................................... 10

3.  Water Quality........................................................................................................................................................................ 14

4.  Waste........................................................................................................................................................................................ 23

5.  Landfill Gas Monitoring.................................................................................................................................................... 24

6.  Ecology (Coral Monitoring)............................................................................................................................................. 29

7.  Ecology (Fishery Monitoring)........................................................................................................................................ 31

8.  Ecology(Landscape)........................................................................................................................................................... 34

9.  Summary of Exceedance, Complaints, Notification of Summons and Prosecutions.............................. 35

10. EM&A Site Inspection....................................................................................................................................................... 38

11. Conclusions and Recommendations.......................................................................................................................... 39

      Appendix A            Master Programme

      Appendix B            Overview of Desalination Plant in Tseung Kwan O

      Appendix C            Summary of Implementation Status of Environmental Mitigation

      Appendix D            Water Quality Graphical Presentation

      Appendix E            Site Inspection Proforma

      Appendix F             Waste Flow Table

      Appendix G            Summary of Exceedances

      Appendix H            Complaint Log

      Appendix I              Event/Action Plan for Noise, Water Quality and Coral Monitoring Exceedance

ii

EXECUTIVE SUMMARY

INTRODUCTION

A1.

The Project, Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (TKODP), is a Designated Project under the Environmental Impact Assessment Ordinance (Cap. 499) (EIAO) and is currently governed by a Further Environmental Permit (EP No. FEP – 01/503/2015/A and EP No. FEP – 01/503/2015/B) for the construction and operation of the Contract.

A2.

In accordance with the Environmental Monitoring and Audit (EM&A) Manual for the Contract, EM&A works for marine water quality, noise, waste management and ecology should be carried out by Environmental Team (ET), Acuity Sustainability Consulting Limited (ASCL), during the construction phase of the Contract.

A3.

This is the Final EM&A Review Report, prepared by ASCL, for the Contract summarizing the monitoring results and audit findings of the EM&A programme(Construction Phase) at and around Tseung Kwan O Area 137 (TKO 137) during the reporting period from 16 March 2020 to 31 January 2024.

A4.

The EM&A programme for this contract has covered environmental monitoring on water quality, construction noise level at selected noise sensitive receivers, and Contractor’s environmental performance auditing in the aspects of construction dust, construction noise, water quality, landfill gas, waste management, landscape and visual and ecology.

A5.

The works of TKODP were substantially completed on 30 June 2024 and the plant commenced the operation phase on 1 July 2024.  A Justification of Termination of the EM&A Programme for the Construction Phase was resubmitted to the EPD on 11 August 2025 and approved by the EPD on 15 August 2025.

SUMMARY OF ENVIRONMENTAL MONITORING AND AUDIT WORKS

A6.

A summary of the environmental monitoring and audit works undertaken in the reporting period are summarized in Table I.

A7.

No construction noise monitoring was conducted during the reporting period since there are no Contract -related construction activities undertaken within a radius of 300m from the monitoring locations. No Action and Limit Level exceedance was recorded during the reporting period.

A8.

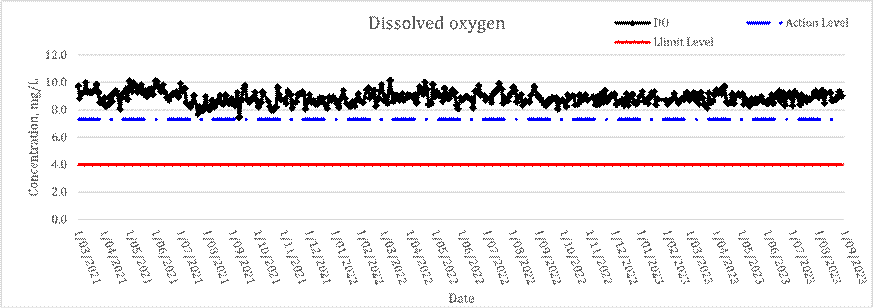

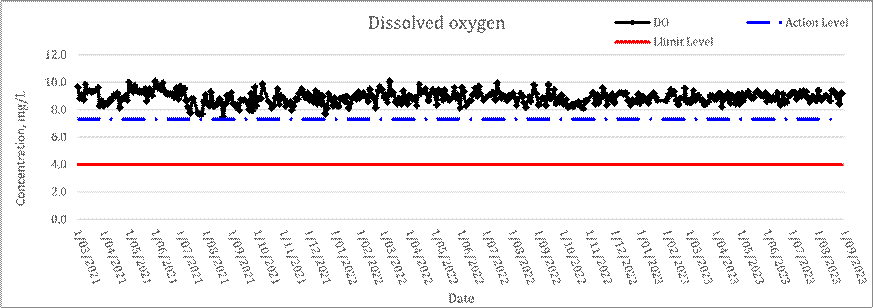

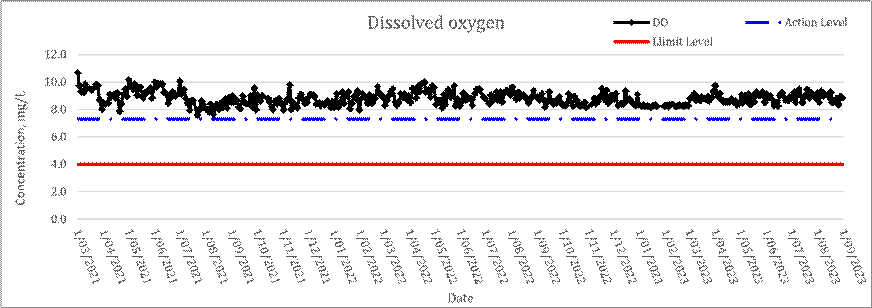

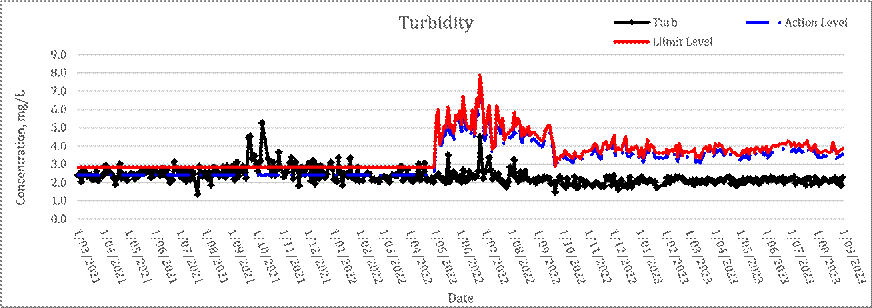

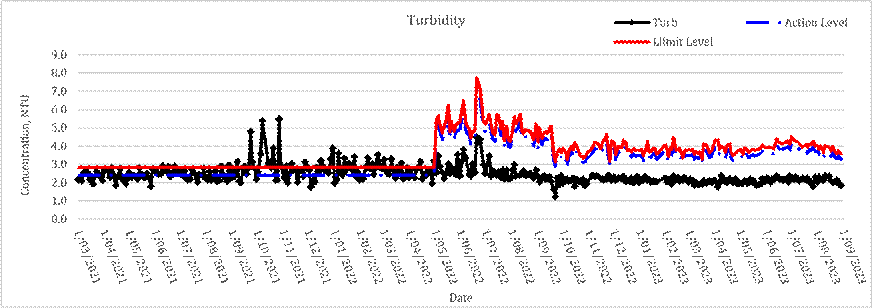

Construction Phase Impact Water Quality Monitoring was conducted as schedule in the reporting period.  One thousand four hundred and twelve (1412) action level exceedances

and one thousand one hundred and twenty-five (1125) limit level exceedances of Suspended Solid were recorded in the reporting period.

A9.     Pre-operation Phase Impact Water Quality Monitoring was conducted as scheduled in the reporting period.  One hundred and seventy-nine (179) action level exceedances and One hundred and forty-one (141) limit level exceedances of Suspended Solid were recorded in the reporting period.

A10. Operation Phase Impact Water Quality Monitoring was conducted as scheduled in the reporting period.  One hundred and thirty-four (134) action level exceedances and Two hundred and ninety-four (294) limit level exceedances of Suspended Solid were recorded in the reporting period.

A11. All Action and Limit Level exceedance was concluded to be unrelated to the Project. Details of the exceedance could be referred to the corresponding Monthly EM&A Report.

A12. Total eleven (11) of dechlorinated effluent sample were taken during the discharge of dechlorinated effluent by contractor. No TRC exceedance of action or limit levels was obtained during the discharge of dechlorinated effluent.

A13. The continuous monitoring of effluent quality was conducted from 1 July 2024 to 31 July 2025. No exceedance of the sampling was obtained during the reporting period.

A14. One thousand nine hundred and ninety-eight (1998) times of construction phase landfill gas monitoring were conducted in the reporting period. No action or limit level exceedance was recorded in the reporting period.

A15. A total of twelve (12) times of operation landfill gas monitoring were conducted in the report period. No action or limit level exceedances was recorded in the reporting period.

A16. Construction phase coral monitoring commenced in March 2021. From March 2021 to Aug 2023, a total of twenty (20) monitoring was carried out in the reporting period. No AL/LL exceedances were recorded during the reporting period.

A17. Pre-operation phase coral monitoring commenced in December 2023. A total of two (2) monitoring was carried out in the reporting period. There were no AL/LL exceedances observed during the reporting period.

A18. Operation phase coral monitoring commenced in July 2024. A total of twelve (12) monitoring was carried out in the reporting period. There were no AL/LL exceedances observed during the reporting period.

A19. A total of twelve (12) construction phase fishery monitoring were conducted during the reporting period, consisting of six (6) dry season and six (6) wet season assessments.

A20. A total of two (2) pre-operation phase fishery monitoring were conducted during the reporting period, consisting of one (1) dry season and one (1) wet season assessment.

A21. A total of four (4) operation phase fishery monitoring were conducted during the reporting period, consisting of two (2) dry season and two (2) wet seasons assessment.

Table I Summary of Environmental Monitoring Works

Environmental Monitoring works

Total Number of EM&A

Activities

Noise Monitoring

N/A

Construction Phase Water Quality Monitoring

383

Pre-operation Phase Water Quality Monitoring

22

Operation Phase Water Quality Monitoring

152

Construction Phase Coral Monitoring

20

Pre-operation Phase Coral Monitoring

2

Operation Phase Coral Monitoring

12

Construction Phase Fishery Monitoring

12

Pre-operation Phase Fishery Monitoring

2

Operation Phase Fishery Monitoring

4

Construction Phase Landfill Gas Monitoring

1998

Operation Phase Landfill Gas Monitoring

12

Environmental Site Inspection

271

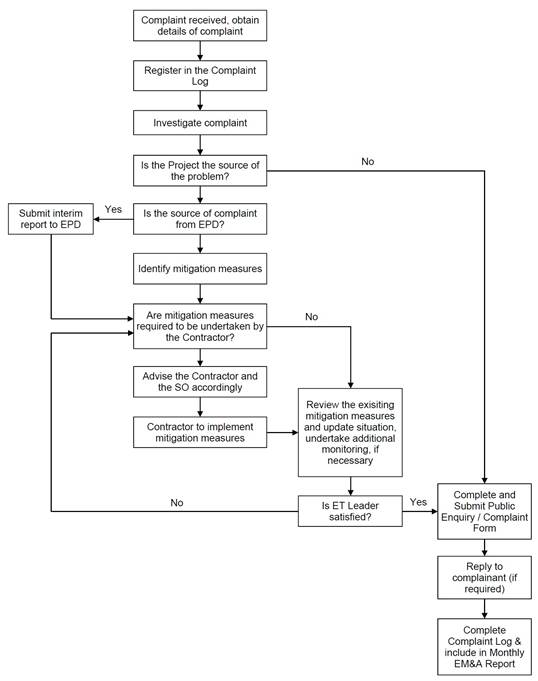

COMPLAINT HANDLING AND PROSECUTION

A22. Two environmental complaints were received from the EPD in the reporting period, no notifications of summons and prosecution was received during the reporting period.

1.       BASIC CONTRACT INFORMATION

1.1.      BACKGROUND

The Jardine Engineering Corporation, Limited, China State Construction Engineering (Hong Kong) Limited and Acciona Agua, S.A. Trading as AJC Joint Venture (AJCJV) is contracted to carry out the Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (TKODP) under Contract No. 13/WSD/17 (the Contract).

Acuity Sustainability Consulting Limited (ASCL) is commissioned by AJCJV to undertake the Environmental Team (ET) services as required and/or implied, both explicitly and implicitly, in the Environmental Permit (EP), Environmental Impact Assessment Report (EIA Report) (Register No. AEIAR-192/2015) and Environmental Monitoring and Audit Manual (EM&A Manual) for the Contract; and to carry out the Environmental Monitoring and Audit (EM&A) programme in fulfillment of the EIA Report’s EM&A requirements and Contract No. 13/WSD/17 Specification requirements.

Pursuant to the Environmental Impact Assessment Ordinance (EIAO), the Director of Environmental Protection granted the Environmental Permit (No. FEP-01/503/2015/B) and Variation of Environmental Permit (No. EP-01/503/2015/A and No. FEP01/503/2015/B) to Water Supplies Department (WSD); and granted the Further Environmental Permit (No. FEP-01/503/2015/A and FEP-01/503/2015/B) to AJCJV for the Contract.

1.2.      THE REPORTING SCOPE

This is the Final EM&A Review Report for the Project which summarizes the key findings of the EM&A programme during the reporting period from 16 March 2020 to 31 July 2025. 1.3. CONTRACT ORGANIZATION

The Contract Organization structure for Construction Phase is presented in Figure 1.1 and contact details of the key personnel are presented in Table 1.1 below:

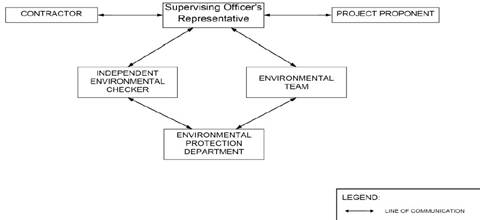

                                                        Figure 1.1          Contract Organization Chart

                                                        Table 1.1               Contact Details of Key Personnel

Party

Position

Name

Telephone no.

Remark

Project Proponent (WSD)

SE/CM2

Benny Lam

2634-3573

Until February 2023

SE/CM2

Milton Law

2634-3573

On the position from February 2023

Supervising Officer

(Binnies Hong Kong Limited)

Project Manager

Christina Ko

2608-7302

Until December 2024

Project Manager

Augustine Li

2608-7671

-

Chief Resident Engineer

Roger Wu

6343-1002

Until August 2024

Chief Resident

Engineer / Senior

Resident Engineer

David Wong

5229-8638

On the position from August

2024 to January 2025

Senior Resident Engineer

Mason Pau

6765-4131

On the position from January

2025

The Jardine Engineering Corporation, Limited,

China State Construction

Engineering (Hong Kong)

Limited and Acciona Agua,

S.A. Trading

Project Manager

Stephen Yeung

2807-4665

Until December 2024

Operation Manager / Project Manager

Arnes Parra, Victor

6468-6710

-

ANewR Consulting Limited

Independent

Environmental

Checker (IEC)

Louis Kwan

2618-2831

Until June 2023

Alex Chan

2618-2831

On the position from June 2023 and until 31

January 2024

Lam Environmental Services Limited

Independent

Environmental

Checker (IEC)

Serena Shek

6149-6683

On the position from 1 February 2024

Acuity Sustainability Consulting Limited

Environmental Team Leader (ETL)

Jacky Leung

2698-6833

Until 21 April 2024

Toby Wan

9719-5422

On the position from 22 April

2024

1.4.     SUMMARY OF CONSTRUCTION WORKS

The construction programme is presented in Appendix A. Detail of the major construction activities are presented below:

•       Excavation, Construction and E&M works of 132kV Substation

•       Construction and E&M works for Combine Shaft

•       Construction works for Intake Structure

•       Construction works for receiving pit, outfall and diffuser pipeline

•       Excavation, Construction and E&M works for ActiDAFF

•       Excavation, Construction and E&M works for Reverse Osmosis Building

•       Excavation, Construction and E&M works for Product Water Storgae Tank

•       Excavation, Construction and E&M works for Product Water Pumping Station

•       Excavation, Construction and E&M works for Chemical Building

•       Piling, Excavation, Construction and E&M works for Administration Building

•       Excavation, Construction and E&M works for Post Treatment Building

•       Excavation, Construction and E&M works for Sludge Thickener

•       Excavation and Construction works for Workshop

•       Excavation, Construction and E&M works for Main Electrical and Central Chiller Plant Building

•       Excavation, Construction for Main Gate and Guard House

•       Filling to Formation for CO2 Tanks Area

•       Construction and E&M works for CO2 Tanks Area

•       E&M works for Diesel Emergency Generator

•       E&M works for Switch Room and Transformer Installation

•       Slope Mitigation Works and Landscaping Works

Other than the EM&A work by ET, environmental briefings, trainings and regular environmental management meetings were conducted, in order to enhance environmental awareness and closely monitor the environmental performance of the contractors.

The EM&A programme has been implemented in accordance with the recommendations presented in the approved EIA Report and the EM&A Manual. A summary of implementation status of the environmental mitigation measures for the construction phase and pre-operation phase of the Contract during the reporting period is provided in Appendix C.

2.       NOISE

2.1.     MONITORING REQUIREMENTS

To ensure no adverse noise impact, noise monitoring is recommended to be carried out within 300m radius from the nearby noise sensitive receivers (NSRs), during construction phase. The NSRs selected as monitoring station are (i) NSR4 – Creative Secondary School, (ii) NSR24 – PLK Laws Foundation College, and (iii) NSR31 – School of Continuing and Professional Studies – CUHK respectively.

2.2.     MONITORING LOCATIONS

The monitoring locations were normally made at a point 1m from the exterior of the NSRs building façade and be at a position 1.2m above the ground. A correction of +3dB(A) was made to the free-field measurements.

According to the environmental findings detailed in the EIA report and Baseline Monitoring Report, the designated locations for the construction noise monitoring are listed in Table 2.1 below.

                                                                Table 2.1               Noise Sensitive Receivers

NSR ID

Noise Sensitive Receivers

Monitoring Location

Position

NSR 4

Creative Secondary School

Roof Floor

1 m from facade

NSR 24

PLK Laws Foundation College

Pedestrian Road on Ground

Floor

Free field

NSR 31

School of Continuing and

Professional Studies -

CUHK

Roof Floor

1 m from facade

Three noise monitoring locations for impact monitoring at the nearby sensitive receivers are shown in Figure 2.1-2.3.

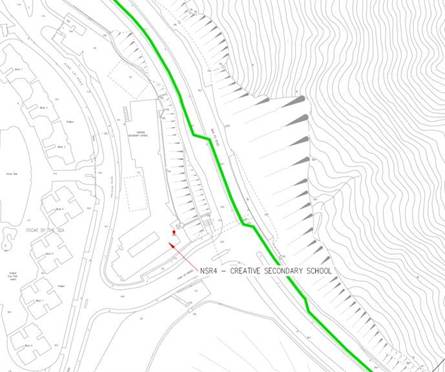

Figure 2.1 NSR4 Creative Secondary School

Figure 2.2 NSR24 PLK Laws Foundation College

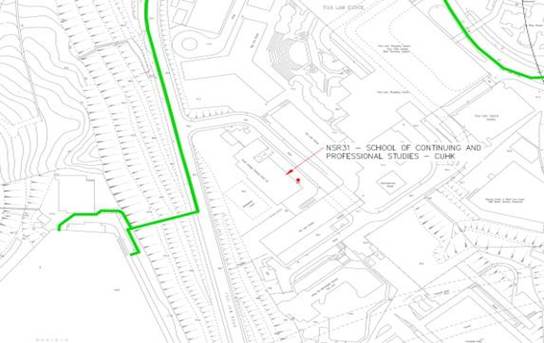

Figure 2.3 NSR31 School of Continuing and Professional Studies - CUHK

2.3.     MONITORING PARAMETER, FREQUENCY AND DURATION

Construction noise level were measured in terms of the A-weighted equivalent continuous sound pressure level (LAeq). Leq 30min was used as the monitoring parameter for the time period between 0700 and 1900 on normal weekdays. Table 2.2 summarizes the monitoring parameters, frequency, and duration of the impact noise monitoring.

                        Table 2.2               Noise Monitoring Parameters, Time, Frequency and Duration

Time

Duration

Interval

Parameters

Daytime: 0700-1900

Day time: 0700-1900

(during normal weekdays)

Continuously in Leq 5min/Leq 30min

(Average of 6 consecutive Leq 5min)

Leq 30min L10 30min & L90 30min

2.4.     IMPACT MONITORING METHODOLOGY

The monitoring methodology and QA/QC procedure could be referring to Section 2.3 of the Monthly EM&A Report.

2.5.     ACTION AND LIMIT LEVELS

The Action/Limit Levels are in line with the criteria of Practice Note for Professional Persons (ProPECC PN 2/93) “Noise from Construction Activities – Non-statutory Controls” and Technical Memorandum on Environmental Impact Assessment Process issued by HKSAR Environmental Protection Department [“EPD”] under the Environmental Impact Assessment Ordinance, Cap 499, S.16 are presented in Table 2.3.

                                         Table 2.3         Action and Limit Levels for Noise per EM&A Manual

Time Period

Action

Limit (dB(A))

0700-1900 on normal weekdays

When one documented complaint is received from any one of the noise sensitive receivers

•       70 dB(A) for school and

•       65 dB(A) during examination period

Notes: Limits specified in the GW-TM and IND-TM for construction and operation noise, respectively.

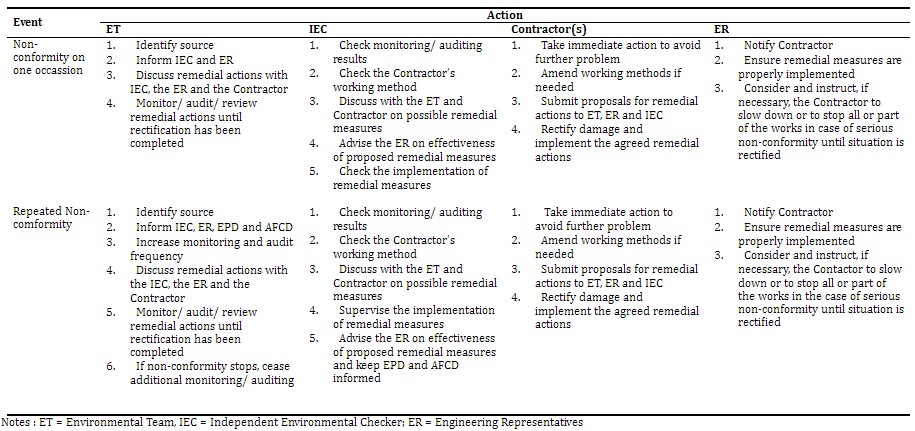

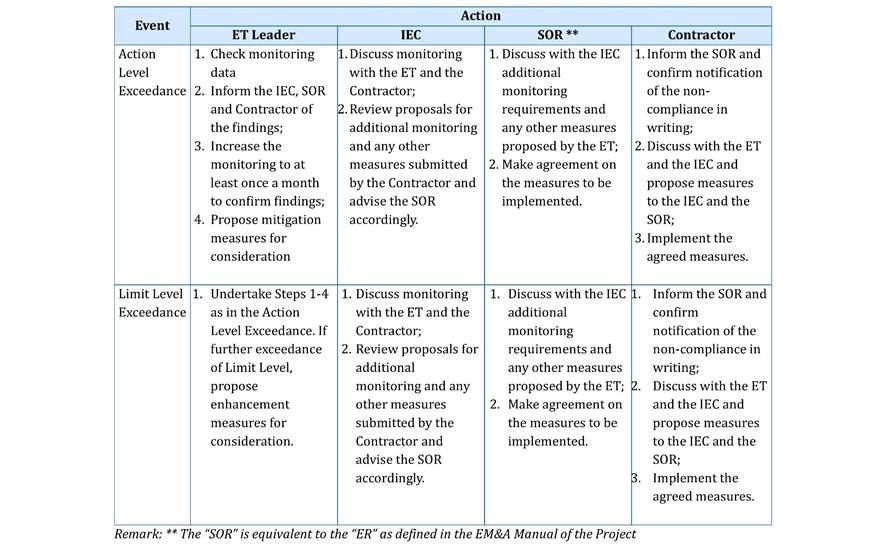

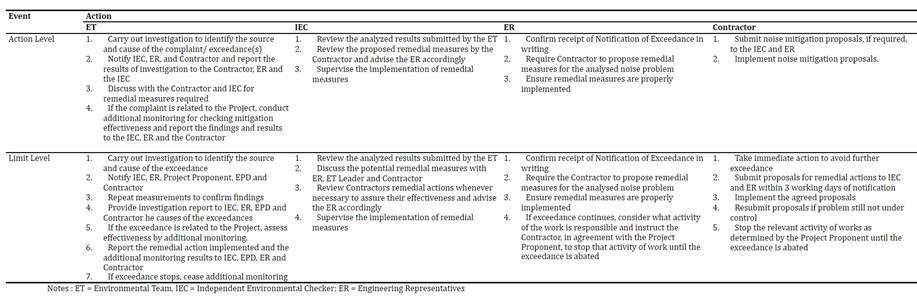

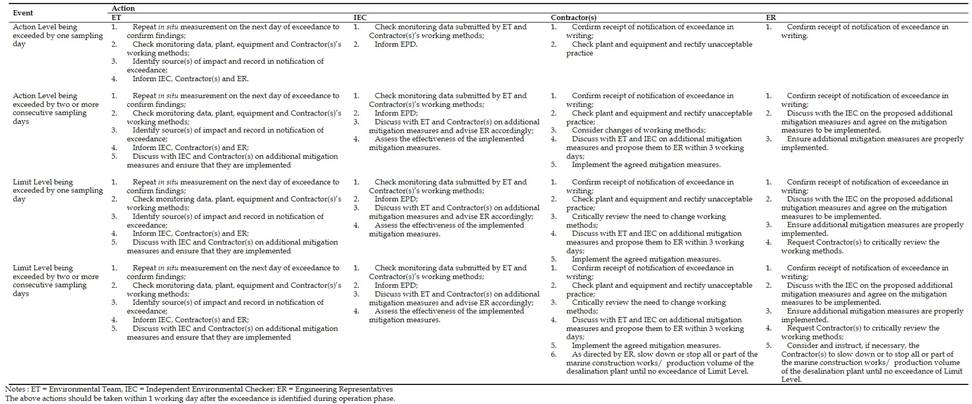

If exceedances were found during noise monitoring, the actions in accordance with the Event and Action Plan shall be carried out according to Appendix I.

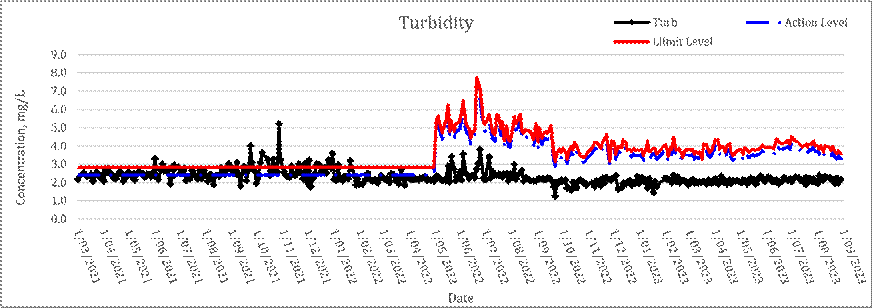

2.6.      MONITORING RESULTS AND OBSERVATIONS

Referring to EM&A manual Section 4.1.2, the impact noise monitoring should be carried out when there are Contract-related construction activities undertaken within a radius of 300m from the monitoring stations. No monitoring station was located within a radius of 300m of the Contract site as shown in Figure 2.4, no impact monitoring for noise impact was conducted in the reporting period.

         Figure 2.4          Site Layout Plan with Noise Sensitive Receivers and Desalination Plant

3.      WATER QUALITY

In accordance with the recommendations of the EIA, water quality EM&A is required during dredging for the submarine pipelines and, during operation phase. In addition, baseline water quality monitoring was prior to the commencement of marine construction activities.

The following Section provides details of the water quality monitoring to be undertaken by the Environmental Team (ET) to verify the distance of sediment and brine plume dispersion and to identify whether the potential exists for any indirect impacts to occur to ecological sensitive receivers.

Water quality monitoring for the Contract can be divided into the following stages:

⚫   Dredging activities during construction phase;

⚫   Discharge of effluent from main disinfection during construction phase;

⚫   Pre-operation – before operation phase

⚫   Operation phase – first year upon commissioning; and,

⚫   Continuous monitoring of effluent quality (Operation phase)

In addition, the marine works contractor is required to complete a silt curtain efficiency test for the combined use of floating silt curtain type and cage type silt curtain for dredging at seawater intake to confirm the silt curtain reduction efficiency assumptions of the assessment.  The details of testing plan together with the silt curtain deployment plan shall be submitted by the ET to seek approval from the IEC and EPD.

3.1.     WATER QUALITY PARAMETERS

Marine Water Quality Monitoring

The parameters that have been selected for measurement in situ and in the laboratory are those that were either determined in the EIA to be those with the most potential to be affected by the construction works or are a standard check on water quality conditions. Parameters to be measured in the impact water quality monitoring are listed in Table 3.1.

                Table 3.1            Parameters measured in the impact marine water quality monitoring

Parameters

Unit

Abbreviation

S

tage

Construction

Pre-operation

In-situ measurements

Dissolved oxygen

mg/L

DO

🗸

🗸

Temperature

oC

-

🗸

🗸

pH

-

-

🗸

🗸

Turbidity

NTU

-

🗸

🗸

Salinity

0/00

-

🗸

🗸

Total Residual Chlorine

mg/L

TRC

-

🗸

Parameters

Unit

Abbreviation

S

tage

Construction

Pre-operation

Laboratory measurements

Suspended Solids

mg/L

SS

🗸

🗸

Iron

mg/L

Fe

🗸

In addition to the water quality parameters, other relevant data was measured and recorded in Water Quality Monitoring Logs, including the location of the sampling stations, water depth, time, weather conditions, sea conditions, tidal stage, current direction and velocity, special phenomena and work activities undertaken around the monitoring and works area that may influence the monitoring results.

3.2.     MONITORING EQUIPMENT

The monitoring methodology, monitoring equipment and QA/QC procedure could be referred to the Monthly EM&A Report. 3.3. MONITORING LOCATION

Marine Water Quality Monitoring

The impact water quality monitoring locations are in accordance with the EM&A Manual and detailed in Table 3.2 and Figure 3.1 below.

               Table 3.2             Location of Impact Water Quality Monitoring Station

Station

Easting

Northing

Description

CE

843550

815243

Upstream control station at ebb tide

CF

846843

810193

Upstream control station at flood tide

WSR1

846864

812014

Ecological sensitive receiver at Tung Lung Chau

WSR2

847645

812993

Fisheries sensitive receiver at Tung Lung Chau

WSR3

848023

813262

Ecological sensitive receiver at Tung Lung Chau

WSR4

847886

814154

Ecological sensitive receiver at Tai Miu Wan

WSR16

845039

815287

Ecological sensitive receiver at Fat Tong Chau

WSR33

847159

814488

Ecological sensitive receiver at Tai Miu Wan

WSR36

846878

814081

Ecological sensitive receiver at Kwun Tsai

WSR37

846655

813810

Ecological sensitive receiver at Tit Cham Chau

Station

Easting

Northing

Description

NF1*

846542

813614

Edge of mixing zone, ~ 200m west of outfall diffuser

NF2*

846942

813614

Edge of mixing zone, ~ 200m east of outfall diffuser

NF3*

846742

813414

Edge of mixing zone, ~ 200m south of outfall diffuser

Remark*: NF1 to NF3 are added for the operation phase of TKODP in accordance with Table 5.3 in the approved EM&A Manual.

WSR1 to WSR37 were identified in accordance with Annex 14 of the EIAO-TM as well as Clause 3.4.4.2 of the Environmental Impact Assessment Study Brief for Desalination Plant at Tseung Kwan O (No. ESB-266/2013). WSR1 to WSR3 are sited near the Tung Lung Chau Fish Culture Zone; WSR16 and WSR36 are sited near the coral assemblages along the coastlines of Fat Tong Chau and Kwun Tsai respectively; WSR 4 and WSR33 are sited near the Coastal Protection Area and coral assemblages in waters of Tai Miu Wan; WSR37 is sited near the fisheries resource including spawning and nursery grounds at the coastal water of Tit Cham Chau. NF1 to NF3 are the Edge of Mixing zone.

                   Figure 3.1       Impact water quality monitoring locations under EM&A Manual

Effluent Monitoring from Main Disinfection

According to the approved Flushing and Disinfection Procedure and Supplementary of the Disinfection Procedure for Desalination Plant at Tseung Kwan O, the sampling point of the dechlorinated effluent was located at Contact tank/Product Water Tank (PWT) and T1GKC01AA502/manhole 18.  The approved sampling location was shown in Table 3.3, Figure 3.2 and Figure 3.3 below.

                   Table 3.3          Sampling location of dechlorinated effluent

System/Loop

Discharge location

Sampling Location

Contact tank/ Product Water Tank (PWT)

Culvert

Contact tank/PWT

Connection to dist. network

Manhole 18 in connection point

Sampling point

T1GKC01AA502/manhole 18

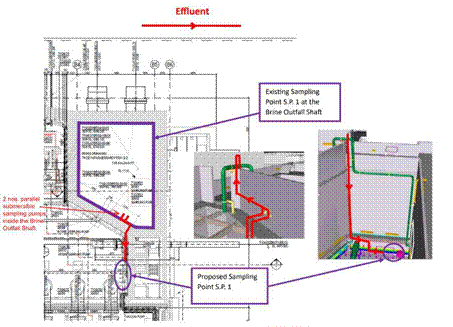

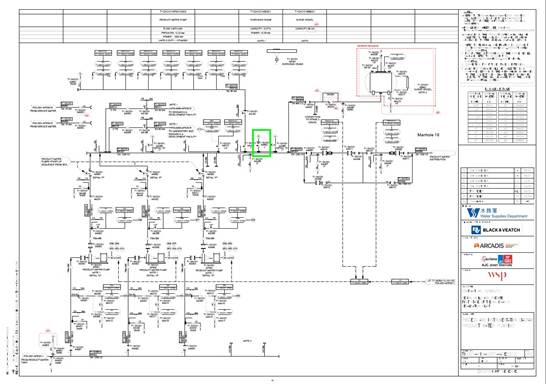

Figure 3.2          Impact water quality monitoring point for dechlorinated effluent (Contact tank/PWT)

      Figure 3.3      Impact water quality monitoring point for dechlorinated effluent (Sampling

point T1GKC01AA502/manhole 18)

                                                    Figure 3.4        Continuous Monitoring locations

3.4.     ACTION AND LIMIT LEVELS

Marine Water Quality Monitoring

The Action and Limit Levels have been set based on the derivation criteria specified in the EM&A Manual. Based on the baseline water quality monitoring data and the derivation criteria, the Action/Limit Levels have been derived and are presented in Table 3.4.

                Table 3.4                Derived Action and Limit Levels for Water Quality

Parameters

Action

Limit

Marine Water Quality Monitoring

DO in mg/L

Surface and Middle

7.30 mg L-1

Bottom

7.31 mg L-1

Tung Lung Chau Fish Culture Zone

5.1 mgL-1 or level at control station

(Whichever the lower)

Surface and Middle

4 mg L-1

Bottom

2 mg L-1

Tung Lung Chau Fish Culture Zone

5.0 mgL-1 or level at control station

(Whichever the lower)

SS         in        mg/L

(Depthaveraged)

5.00 mg L-1 or 20% exceedance of value at any impact station compared with corresponding data from control station

6.00 mg L-1 or 30% exceedance of value at any impact station compared with corresponding data from control station

Turbidity in NTU (Depth-

averaged)

2.41 NTU or 20% exceedance of value at any impact station compared with corresponding data from control station

2.84 NTU or 30% exceedance of value at any impact station compared with corresponding data from control station

Salinity in PSU

(Depthaveraged)

34.25 PSU or 9% exceedance of value at any impact station compared with corresponding data from control station

34.56 PSU or 10% exceedance of value at any impact station compared with corresponding data from control station

Iron       in      mg/L

(Depthaveraged)

0.3 mg/L

0.3 mg/L

Total residual chlorine in mg/L

0.01 mg/L

0.01 mg/L

Parameters

Action

Limit

Marine Water Quality Monitoring

Total residual chlorine in mg/L (Disinfection)

0.1 mg/L

0.1 mg/L

Notes:

i.        "Depth-averaged" is calculated by taking the arithmetic means of reading of all three depths.

ii.       For DO, non-compliance of the water quality limits occurs when monitoring result is lower than the limits.

iii.     For Turbidity, SS, iron and Salinity, non-compliance of the water quality limits occurs when monitoring result is higher than the limits.

iv.     For the Action and Limit Levels adopted during First-year Operation Phase Monitoring, further review would be made according to the EM&A Manual during Operation Phase.

v.       Monitoring of Total Residual Chlorine (Disinfection) will be conducted when cleaning and sterilization of the new freshwater main is carried out.

vi.     Monitoring of Iron and Total Residual Chlorine were conducted during the pre-operation phase.

Continuous Monitoring of Effluent Quality

                Table 3.5               Derived Limit Levels for Water Quality

Parameters

Limit

Continuous Monitoring of Effluent Quality

Flow Rate in m3/day

216841

Temperature in °C

Maximum 40

Salinity

71347

SS in mg/L

13

pH

6-9

Iron in mg/L

0.6

Total residual chlorine in mg/L

0.1

Total Inorganic Nitrogen in mg/L

2

Total Phosphorous in mg/L

1

Sodium Metabisulphite in mg/L

0.5

Anti scalant in mg/L*

2.2

*Remark:

1. Anti-scalant water quality testing will only be conducted whenever anti-scalant dosage is adopted.

3.5.     MONITORING PROGRAMME

Marine Water Quality Monitoring

The ET of the Contract conducted the construction phase impact water quality monitoring between 1 March 2021 and 31 August 2023 at the ten designated monitoring stations in accordance with the EM&A Manual and Contract Specification.

Following the completion of the marine-related construction works, the construction phase impact water quality monitoring was suspended on 1 September 2023 and the preoperation phase marine impact monitoring commenced in December 2023.

The additional pre-operation phase marine water quality monitoring was conducted between 12 December 2023 and 30 June 2024 at the thirteen designated monitoring stations near TKO in accordance with the EM&A Manual and Contract Specification.

Operation phase marine water quality monitoring was conducted between 1 July 2024 to 30 June 2025 at the thirteen designated monitoring stations near TKODP.

Effluent Monitoring from Main Disinfection

According to the approved EM&A Manual Section 5.1.6(b), Flushing and Disinfection Procedure and Supplementary of the Disinfection Procedure was prepared by ET and approved by EPD. The dechlorinated effluent was conducted by the contractor on 24 November 2023, 2 December 2023 and 3 December 2023 in accordance with the EM&A Manual and Contract Specification

Continuous Monitoring of Effluent Quality

Continuous monitoring of Effluent was conducted between 1 July 2024 and 31 July 2025 at Brine Outfall Shaft in accordance with the discharge license.

3.6.     MONITORING RESULTS AND OBSERVATIONS

Marine Water Quality Monitoring

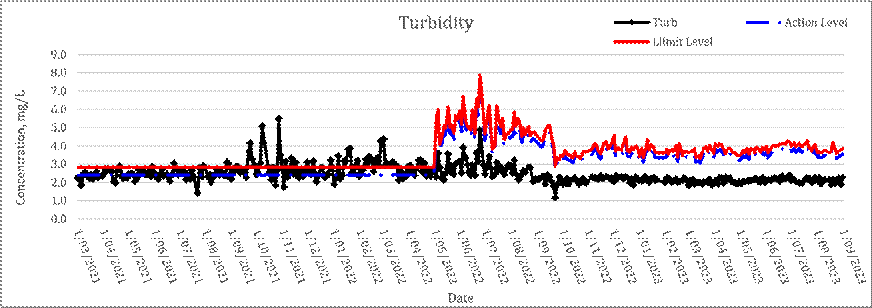

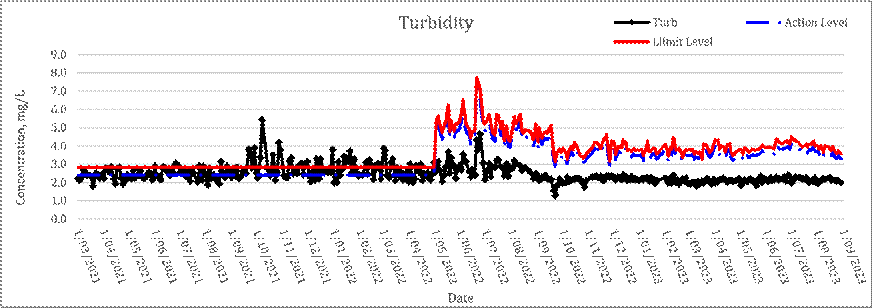

The water quality monitoring at the designated locations was conducted by the ET as scheduled in the reporting period. The graphical presentation of the water quality monitoring result was shown in Appendix D.

Construction Phase Impact Water Quality Monitoring was conducted as schedule in the reporting period.  One thousand four hundred and twelve (1412) action level exceedances and one thousand one hundred and twenty-five (1125) limit level exceedances of Suspended Solid were recorded in the reporting period.

Pre-operation Phase Impact Water Quality Monitoring was conducted as scheduled in the reporting period.  One hundred and seventy-nine (179) action level exceedances and One hundred and forty-one (141) limit level exceedances of Suspended Solid were recorded in the reporting period.

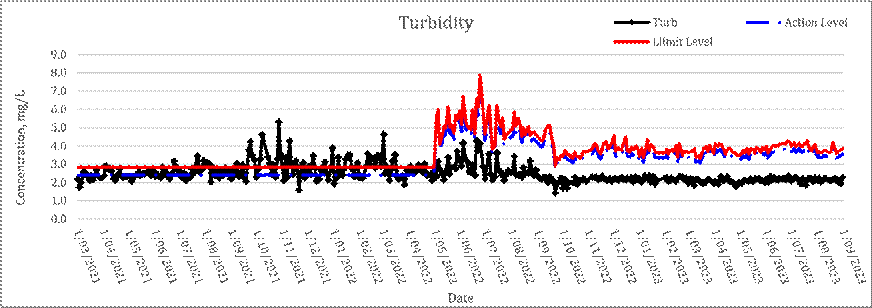

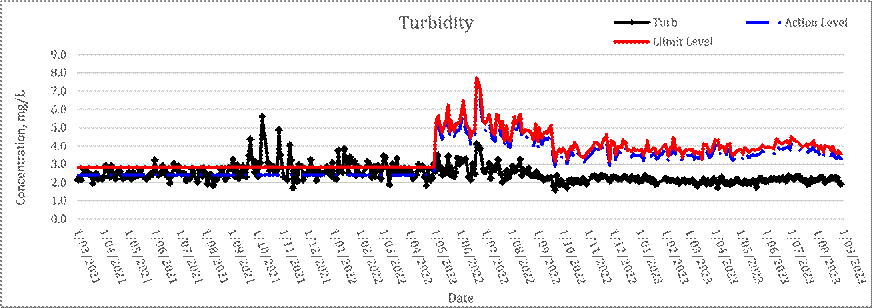

Operation Phase Impact Water Quality Monitoring was conducted as scheduled in the reporting period.  One hundred and thirty-four (134) action level exceedances and Two hundred and ninety-four (294) limit level exceedances of Suspended Solid were recorded in the reporting period.

Investigation on the reason for the exceedances has been conducted, and it is concluded that the exceedances were non-project related. No follow-up actions were taken during the reporting period.

Details of the exceedance and the investigation report could refer to Appendix L of the Monthly EM&A Report.

Effluent Monitoring from Main Disinfection

Total eleven (11) of dechlorinated effluent sample were taken during the discharge of dechlorinated effluent by contractor. No TRC exceedance of action or limit levels was obtained during the discharge of dechlorinated effluent. Monitoring results are summarized in Table 3.5.

                Table 3.5                 Summary of dechlorinated effluent Monitoring Results

Location

Contact Tank / Product Water Tank Flushing after Neutralization

Date

24 Nov

2023

2 Dec 2023

3 Dec

2023

Time

16:00

17:00

18:00

19:00

23:59

01:00

02:00

03:00

04:00

05:00

06:00

TRC (mg/L)

0.08

0.03

0.02

0.01

0.04

0.04

0.03

0.02

0.01

0.00

0.01

Continuous Monitoring of Effluent Quality

Continuous Monitoring of Effluent Quality was conducted sampling point in the reporting period. No exceedance of the sampling was obtained during the reporting period had exceeded the Limit Level.

4.    WASTE

The waste generated from this Project includes inert construction and demolition (C&D) materials, and non-inert C&D materials. Noninert C&D materials are made up of general refuse, vegetative wastes and recyclable wastes such as plastics and paper/cardboard packaging waste. Steel materials generated from the project are also grouped into non-inert C&D materials as the materials were not disposed of with other inert C&D materials. Details of cumulative waste management data are presented as a waste flow table in Appendix

F.

             Table 4.1                 Quantities of Waste Generated from the Contract during the reporting period

Reporting Month

Actual Quantities of Inert C&D Materials Generated Monthly

Actual Quantities of C&D Wastes Generated Monthly

Total

Quantity

Generated

Hard Rock and Large

Broken

Concrete

Reused in the

Contract

Reused in other

Projects

Disposed as Public

Fill

Imported

Fill

Metals

Paper / cardboard packaging

Plastics (1)

Chemical Waste

Others,

e.g.,

general refuse

(in ’000kg)

(in ’000kg)

(in ’000kg)

(in ’000kg)

(in ’000kg)

(in ’000kg)

(in ’000kg)

(in ’000kg)

(in ’000kg)

(in ’000kg)

(in ’000kg)

2020

15759.320

0.000

0.000

13791.930

1967.390

0.000

56.099

0.100

0.062

0.000

378.080

2021

20165.540

0.000

0.000

12250.220

7915.320

0.000

43.718

1.293

0.096

0.000

1091.600

2022

71961.800

0.000

0.000

0.000

7196.800

0.000

0.021

0.758

0.213

0.296

2307.970

2023

9110.910

0.000

0.000

0.000

9110.910

0.000

0.010

167.806

0.064

0.000

2021.070

2024

89523.961

0.000

0.000

26550.751

62973.210

0.000

0.000

0.000

0.002

4.265

669.170

2025

51.810

0.000

0.000

0.000

51.810

0.000

0.000

0.000

0.000

1.434

363.550

23

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

5.      LANDFILL GAS MONITORING

5.1.     MONITORING REQUIREMENT

Construction Phase

In according with Section 11 of the EM&A Manual, monitoring of landfill gas is required for construction works within the 250m Consultation Zone. Part of the desalination plant and the indicative area of natural slope mitigation works fall within the SENT Landfill Extension Consultation Zone; and part of the 1,200 mm diameter freshwater mains along Wan Po Road falls within the SENT Landfill and SENT Landfill Extension Consultation Zones, TKO Stage II/III Restored Landfill and TKO Stage I Restored Landfill Consultation Zones.

Since part of the desalination plant (Wan Po Road and MIC compound/Basketball Court) and the indicative area of natural slope mitigation works fall within the SENT Landfill Extension Consultation Zone in this contract (Figure 5.1), landfill gas monitoring would be required for Wan Po Road and MIC compound/Basketball Court (Figure 5.2) if excavations were conducted at more than 300mm deep. Although SENT Landfill Extension has commenced operation since November 2021, no excavation works were conducted at MIC compound/Basketball Court. Hence no landfill gas monitoring would be scheduled for MIC compound/Basketball Court at the current stage.

Figure 5.1 Overview of the SENT Extension Consultation Zone and the Contract Site Area

                        Figure 5.2          Location Map for Landfill Gas Monitoring at Wan Po Road

Operation Phase

In accordance with Section 11 of the EM&A Manual, monthly monitoring of landfill gas is required for the first year of operation at buildings within the Project Site and consultation zone.  Part of the desalination plant and the indicative area of natural slope mitigation works fall within the SENT Landfill Extension Consultation Zone; and part of the 1,200 mm diameter freshwater mains along Wan Po Road falls within the SENT Landfill and SENT Landfill Extension Consultation Zones, TKO Stage II/III Restored Landfill and TKO Stage I Restored Landfill Consultation Zones.

Routine monitoring is required at buildings within the Project Site and consultation zones.  The monitoring frequency will be monthly for the first year of operation.

For the manholes and utility pits within the Project Site and along the fresh water mains, each manhole/ utility pit should be monitored with two measurements (at mid depth and base).  Each measurement should be monitored for a minimum of 10 minutes.  A steady reading and peak reading should be recorded at each manhole/ utility pit and for each measurement.

The area required to be monitored for landfill gas in the reporting period is shown in Figure

5.1, Figure 5.3 and Figure 5.4.

Figure 5.3 Landfill Gas Monitoring Location For Building

Figure 5.4 Landfill Gas Monitoring Location For Manholes/Pits

5.2.     MONITORING PARAMETERS

LFG monitoring was carried out to identify any migration between the landfill and the Contract and to ensure the safety of the construction, operation and maintenance personnel working on-site, visitors and any other person within the Contract area.

The following parameters were monitored:

•           Methane

•           Oxygen

•           Carbon Dioxide

•           Barometric Pressure

5.3.     MONITORING EQUIPMENT

Landfill Gas monitoring was carried out using intrinsically safe, portable multi-gas monitoring instruments. Detail of monitoring equipment used in the reporting period could be referred to Section 5.10 of the corresponding Monthly EM&A Report.

5.4.     MONITORING RESULTS AND OBSERVATIONS

One thousand nine hundred and ninety-eight (1998) times of construction phase landfill gas monitoring were conducted in the reporting period. No action or limit level exceedance was recorded in the reporting period.

A total of twelve (12) times of operation landfill gas monitoring were conducted in the report period. No action or limit level exceedances was recorded in the reporting period.

Action and Limit Level are provided in Table 5.1.

Table 5.1       Action / Limit Levels and Event and Action Plan for LFG Hazard

Parameters

Level

Action

Oxygen (O2)

Action Level < 19% O2

Ventilate trench/void to restore

O2 to > 19%

Limit Level < 19% O2

Stop works

Evacuate personnel/prohibit entry

Increase ventilation to restore O2 to > 19%

Methane (CH4)

Action Level   >10% LEL

Post "No Smoking" signs

Prohibit hot works

Increase ventilation to restore CH4 to

<10% LEL

Limit Level     >20% LEL

Stop works

Evacuate personnel/prohibit entry

Increase     ventilation     to      restore

CH4 to<10% LEL

                 Carbon Dioxide (CO2)         Action Level   >0.5% CO2                 Ventilate to restore CO2 to < 0.5%

Parameters

Level

Action

Limit Level

>1.5% CO2

Stop works

Evacuate personnel / prohibit entry

Increase ventilation to restore CO2 to

<0.5%

6.      ECOLOGY (CORAL MONITORING)

Under the approval conditions of the EIA Report for the Project, an EM&A programme on coral for the construction, pre-operation and operation phase of the Project is recommended. Pursuant to these EIA approval conditions and Condition 3.1 of the EP and FEP, details of the regular coral monitoring programme have been proposed based on the baseline coral monitoring results in the Report on Pre-Operation Baseline Coral Monitoring and Regular Coral Monitoring Methodology.

MONITORING LOCATION

In accordance with Appendix B Section 5.1 of the approved supplementary EM&A Manual, two indirect impact sites (C2 and C3) and one control site (C8) as shown in Figure 6.1 should be monitored during the pre-operation Phase. Pre- operation coral survey should be conducted at the indirect impact and control sites. Ten selected hard coral colonies with similar species should be tagged at each of the control and indirect impact sites before commencement of the operation phase. Tagged hard coral colonies should be monitored in open waters during the pre- operation phase and operation phase.

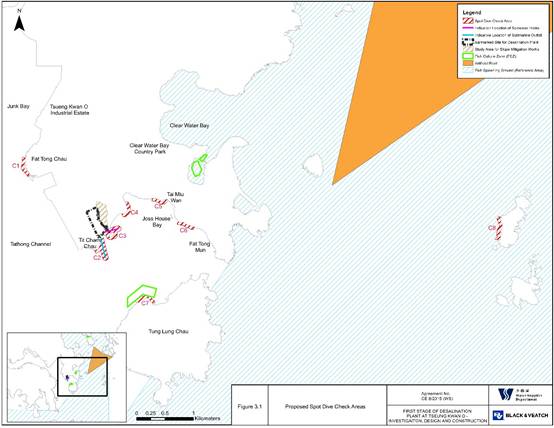

Figure 6.1 Spot Dive Check Areas Two Proposed Indirect Impact Sites (C2 and C3) and one control site (C8) during pre-operation Phase

ACTION AND LIMIT LEVELS

The Action and Limit Levels have been set based on the derivation criteria specified in the

EM&A Manual. The Action/Limit Levels have been derived and are presented in Table 6.1.

                   Table 6.1            Action and Limit Level for Coral Monitoring Equipment

Parameter

Action Level Definition

Limit Level Definition

Mortality

If during Impact Monitoring a 15% increase in the percentage of partial mortality on the corals occurs at more than 20% of the tagged indirect impact site coral colonies that is not recorded on the tagged corals at the control site, then the Action Level is exceeded

If during Impact Monitoring a 25% increase in the percentage of partial mortality on the corals occurs at more than 20% of the tagged indirect impact site coral colonies that is not recorded on the tagged corals at the control site, then the Limit Level is exceeded

Note: If the defined Action Level or Limit Level for coral monitoring is exceeded, the actions as set out in Table E3 of Appendix E will be implemented.

If non-compliance were found during the construction works, the actions in accordance with the Event and Action Plan will be carried out according to Appendix I.

MONITORING FREQUENCY

Construction phase coral monitoring shall be monitored on a weekly basis in the first month, monitoring frequency is reduced from weekly to monthly in second and third month and further reduce to quarterly in the remaining months.

Pre-operation phase and 1st year operation phase coral monitoring shall be monitored once per month in accordance with the approved supplementary EM&A Manual.

According to the approved proposal to change the operation phase EM&A programme for the 2nd to 10th year, coral monitoring will be conducted on a quarterly basis starting from August 2025.

MONITORING RESULT AND OBSERVATION

Construction phase coral monitoring commenced in March 2021. From March 2021 to Aug 2023, a total of twenty (20) monitoring was carried out in the reporting period. No AL/LL exceedances were recorded during the reporting period.

Consultation with AFCD, a total of six (6) coral colonies were re-tagged on 15 September 2022. A re-tagging survey was conducted in September 2022 and additional coral monitoring were conducted in September 2022 and October 2022.

Pre-operation phase coral monitoring commenced in December 2023. A total of six (6) monitoring was carried out in the reporting period. There were no AL/LL exceedances observed during the reporting period. The detailed result of the monitoring is presented in the Monthly EM&A Report.

Operation phase coral monitoring commenced in July 2024. A total of twelve (12) monitoring was carried out in the reporting period. There were no AL/LL exceedances observed during the reporting period. The detailed result of the monitoring is presented in the Monthly EM&A Report.

7.      ECOLOGY (FISHERY MONITORING)

The purpose of the pre-operation phase regular fisheries monitoring programme is to monitor the potential impacts on fisheries resources in the vicinity of the project site. Apart from the regular fisheries monitoring programme, a water quality monitoring programme in addition to the water quality monitoring programme in the approved EM&A Manual is also described in Section 2.4 to (i) provide supplementary information in the interpretation of the findings of the fisheries monitoring and (ii) assist the monitoring of the potential impact on the Tung Lung Chau Fish Culture Zone (FCZ) in Joss House Bay.

MONITORING LOCATION

In accordance with Section 2.3 of the approved Methodology Paper on Regular Fisheries Monitoring, it is recommended to set up six (6) fisheries monitoring locations in Joss House Bay and its vicinity to monitor the fisheries resources.

Two (2) sampling locations are set up in close proximity of the direct footprint of the proposed submarine utilities around TKO Area 137. These sampling locations represent the potential Project impact zones (i.e. areas at and in close proximity to the footprint of the proposed submarine utilities that will be directly affected by the Project works).

Two (2) gradient locations are proposed between the proposed submarine utilities and Tung Lung Chau FCZ to assist in the interpretation and identification of any potential fisheries impact in the vicinity of the FCZ.

Two (2) reference locations are proposed in the outer Joss House Bay between the waters of Tung Lung Chau and Fat Tong Mun. These reference locations are further away and will not be affected by the Project discharge (based on the EIA prediction) and will serve as control stations. Any significant fisheries impact identified at the reference locations should be caused by other natural factors or non-Project activities. The trends of fisheries conditions recorded in the reference locations will be used to assist in the interpretation of the trends of fisheries impact identified in the impact and gradient locations.

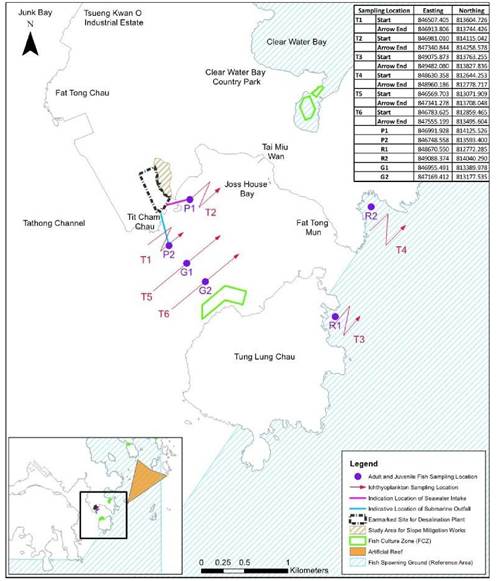

The coordinates of the proposed monitoring locations are shown in Figure 7.1.

Figure 7.1 Monitoring location of regular fishery monitoring during pre-operation Phase

MONITORING FREQUENCY

Pre-operation phase fishery monitoring shall be carried out 2 times in wet season (April to October) and 2 times in dry season (November to March) to examine the following:

•         Fish species composition;

•         Abundance: number of fish captured;

•         Diversity of fish resources: species diversity and evenness;

•         Size: range of total length; Biomass in weight; and

•         Values of catches of commercial species: catch per unit effort (CPUE) and yield per unit effort (YPUE).

MONITORING RESULT AND OBSERVATION

A total of twelve (12) construction phase fishery monitoring were conducted during the reporting period, consisting of six (6) dry season and six (6) wet season assessments.

A total of two (2) pre-operation phase fishery monitoring were conducted during the reporting period, consisting of one (1) dry season and one (1) wet season assessment.

A total of four (4) operation phase fishery monitoring were conducted during the reporting period, consisting of two (2) dry season and two (2) wet seasons assessment.

Overall, the survey findings showed that the abundance and diversity of fish eggs and larvaeare on the low side of the Study Area, and the abundance and diversity of juveniles are very low for the Study Area. Survery findings also showed that there was a very week relationship in recorded families between ichthyoplankton assemblages, adult fish and juvenile fish in the Study Area, which implies that the Study Area does not appear to be an important spawning or nursery gorunds for commercial fishes.

8.      ECOLOGY(LANDSCAPE)

MONITORING REQUIREMENTS

In accordance with Section 8.1 of the EM&A Manual, weekly site audit shall be carried out by the ET include checking whether good site practices are being properly implemented by the Contractor and the extent of the works area within the Clear Water Bay Country Park should be checked by the ET during the weekly site audit.

SITE INSPECTION

Weekly site audit was carried out by the ET in the reporting month, no trespass by the Contractor outside the works area of the Project and Clear Water Bay Country Park, and no damage to the vegetation and rocky shore outside the Project area was observed in the reporting month.  Retained trees were properly protected during the construction works, no unacceptable construction works were observed.

9.    SUMMARY OF EXCEEDANCE, COMPLAINTS, NOTIFICATION OF SUMMONS AND PROSECUTIONS

The Environmental Complaint Handling Procedure is shown in below Figure 8.1:

                                  Figure 8.1          Environmental Complaint Handling Procedures

No noise monitoring was conducted during the reporting period since there are no Contract-related construction activities undertaken within a radius of 300m from the monitoring locations.

The construction phase water quality monitoring was suspended on 1 September 2023 following the completion of marine-related construction works, and the pre-operation phase marine impact monitoring commenced in December 2023.

Construction Phase Impact Water Quality Monitoring was conducted as schedule in the reporting period.  One thousand four hundred and twelve (1412) action level exceedances and one thousand one hundred and twenty-five (1125) limit level exceedances of Suspended Solid were recorded in the reporting period.

Pre-operation Phase Impact Water Quality Monitoring was conducted as scheduled in the reporting period.  One hundred and seventy-nine (179) action level exceedances and One hundred and forty-one (141) limit level exceedances of Suspended Solid were recorded in the reporting period.

Operation Phase Impact Water Quality Monitoring was conducted as scheduled in the reporting period.  One hundred and thirty-four (134) action level exceedances and Two hundred and ninety-four (294) limit level exceedances of Suspended Solid were recorded in the reporting period.

All Action and Limit Level exceedance was concluded to be unrelated to the Project. Details of the exceedance could be referred to the corresponding Monthly EM&A Report.

Total eleven (11) of dechlorinated effluent sample were taken during the discharge of dechlorinated effluent by contractor. No TRC exceedance of action or limit levels was obtained during the discharge of dechlorinated effluent.

The continuous monitoring of effluent quality was conducted from 1 July 2024 to 31 July 2025. No exceedance of the sampling was obtained during the reporting period.

One thousand nine hundred and ninety-eight (1998) times of construction phase landfill gas monitoring were conducted in the reporting period. No action or limit level exceedance was recorded in the reporting period.

A total of twelve (12) times of operation landfill gas monitoring were conducted in the report period. No action or limit level exceedances was recorded in the reporting period.

Construction phase coral monitoring commenced in March 2021. From March 2021 to Aug 2023, a total of twenty (20) monitoring was carried out in the reporting period. No AL/LL exceedances were recorded during the reporting period.

Pre-operation phase coral monitoring commenced in December 2023. A total of two (2) monitoring was carried out in the reporting period. There were no AL/LL exceedances observed during the reporting period.

Operation phase coral monitoring commenced in July 2024. A total of twelve (12) monitoring was carried out in the reporting period. There were no AL/LL exceedances observed during the reporting period.

A total of twelve (12) construction phase fishery monitoring were conducted during the reporting period, consisting of six (6) dry season and six (6) wet season assessments.

A total of two (2) pre-operation phase fishery monitoring were conducted during the reporting period, consisting of one (1) dry season and one (1) wet season assessment.

A total of four (4) operation phase fishery monitoring were conducted during the reporting period, consisting of two (2) dry season and two (2) wet seasons assessment.

Two (2) environmental complaints were received from EPD on 22 July 2022 and 23 January 2024.

On 22 July 2022, the EPD received a complaint concerning air and water quality. ET conducted an investigation and found that the Contractor had properly implemented the required mitigation measures for both air and water quality. Consequently, the complaint was deemed invalid.

On 23 January 2024, the EPD received a complaint related to noise nuisance from TKODP. ET carried out an ad-hoc nighttime noise monitoring on 25 January 2024. According to the investigation, the complaint was considered as non-project related.

No notification of summons or prosecution was received in the reporting period. Statistics on complaints and regulatory compliance are summarized in Appendix H.

10. EM&A SITE INSPECTION

Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract. In the reporting period, site inspections were carried out from 1 March 2020 to 31 May 2025.

According to the approved proposal to change the operation phase EM&A programme for the 2nd to 10th year, site inspection will be conducted on a bi-weekly basis starting from 15 August 2025.

Two hundred and seventy-one (271) site inspections were carried out in the reporting period.

Environmental deficiencies were observed during weekly site inspection. Key observations during the site inspections and during the reporting period could be referring to Appendix E and corresponding Monthly Report.

According to the EIA Study Report, Environmental Permit, contract documents and EM&A Manual, the mitigation measures detailed in the documents should be implemented as much as practical during the reporting period. An updated Implementation Status of Environmental Mitigation Measures (EMIS) is provided in Appendix C.

The EM&A programme was found effective in monitoring the environmental impacts of this project. Data collection was useful in determining whether the project has caused unacceptable impacts on the sensitive receivers. The impact monitoring data indicated whether exceedances would occur and helped determine whether the works' exceedances were due.

Twenty-seven (27) EPD Joint site inspections were carried out in the report period. No noncompliance and complaint was provided by EPD during the inspection.

11. CONCLUSIONS AND RECOMMENDATIONS

This is the Final EM&A Review Report, prepared by ASCL, for the Contract summarizing the monitoring results and audit findings of the EM&A programme at and around Tseung Kwan O Area 137 (TKO 137) during the reporting period from 1 March 2020 to 31 January 2024.

No noise monitoring was conducted in the reporting period due to the over distant monitoring station from the works location, in which construction activities were not undertaken within a radius of 300m from the monitoring locations.

The EM&A works for water quality were conducted during the reporting period in accordance with the EM&A Manual.

Construction Phase Impact Water Quality Monitoring was conducted as schedule in the reporting period.  One thousand four hundred and twelve (1412) action level exceedances and one thousand one hundred and twenty-five (1125) limit level exceedances of Suspended Solid were recorded in the reporting period.

Pre-operation Phase Impact Water Quality Monitoring was conducted as scheduled in the reporting period.  One hundred and seventy-nine (179) action level exceedances and One hundred and forty-one (141) limit level exceedances of Suspended Solid were recorded in the reporting period.

Operation Phase Impact Water Quality Monitoring was conducted as scheduled in the reporting period.  One hundred and thirty-four (134) action level exceedances and Two hundred and ninety-four (294) limit level exceedances of Suspended Solid were recorded in the reporting period.

All Action and Limit Level exceedance was concluded to be unrelated to the Project. Details of the exceedance could be referred to the corresponding Monthly EM&A Report.

Total eleven (11) of dechlorinated effluent sample were taken during the discharge of dechlorinated effluent by contractor. No TRC exceedance of action or limit levels was obtained during the discharge of dechlorinated effluent.

The continuous monitoring of effluent quality was conducted from 1 July 2024 to 31 July 2025. No exceedance of the sampling was obtained during the reporting period.

One thousand nine hundred and ninety-eight (1998) times of construction phase landfill gas monitoring were conducted in the reporting period. No action or limit level exceedance was recorded in the reporting period.

A total of twelve (12) times of operation phase landfill gas monitoring were conducted in the report period. No action or limit level exceedances was recorded in the reporting period.

Construction phase coral monitoring commenced in March 2021. From March 2021 to Aug 2023, a total of twenty (20) monitoring was carried out in the reporting period. No AL/LL exceedances were recorded during the reporting period.

Pre-operation phase coral monitoring commenced in December 2023. A total of two (2) monitoring was carried out in the reporting period. There were no AL/LL exceedances observed during the reporting period.

Operation phase coral monitoring commenced in July 2024. A total of twelve (12) monitoring was carried out in the reporting period. There were no AL/LL exceedances observed during the reporting period.

A total of twelve (12) construction phase fishery monitoring were conducted during the reporting period, consisting of six (6) dry season and six (6) wet season assessments.

A total of two (2) pre-operation phase fishery monitoring were conducted during the reporting period, consisting of one (1) dry season and one (1) wet season assessment.

A total of four (4) operation phase fishery monitoring were conducted during the reporting period, consisting of two (2) dry season and two (2) wet seasons assessment.

Two hundred and seventy-one (271) site inspections were carried out in the reporting period.

Two (2) environmental complaints were received from EPD on 22 July 2022 and 23 January 2024.

On 22 July 2022, the EPD received a complaint concerning air and water quality. ET conducted an investigation and found that the Contractor had properly implemented the required mitigation measures for both air and water quality. Consequently, the complaint was deemed invalid.

On 23 January 2024, the EPD received a complaint related to noise nuisance from TKODP. ET carried out an ad-hoc nighttime noise monitoring on 25 January 2024. According to the investigation, the complaint was considered as non-project related.

No notification of summons or prosecution was received in the reporting period.

The recommended environmental mitigation measures, as proposed in the EIA reports and EM&A Manuals shall be effectively implemented to minimize the potential environmental impacts from the Project. The EM&A programme would effectively monitor the environmental impacts generated from the construction activities and ensure the proper implementation of mitigation measures.

With the success of the overall EM&A programme, the deterioration of the environment caused by the Project was cost-effectively identified and necessary prompt effective mitigation measures were implemented to avoid any unacceptable impacts. In conclusion, the Project was environmentally acceptable and returned to the ambient.

Appendix A

Master Programme

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

Appendix B

Overview of Desalination Plant in

Tseung Kwan O

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

Appendix C

Summary of Implementation Status

of Environmental Mitigation

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

EIA Reference

Recommended Environmental Protection Measures/

Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant

Legislation & Guidelines

D

C

O

Air Quality

S4.8.1

Impervious dust screen or sheeting will be provided to enclose scaffolding from the ground floor level of building for construction of superstructure of the new buildings.

Land site/ During Construction

Contractor(s)

✓

Implemented

Air Pollution

Control

(Construction Dust)

S4.8.1

Impervious sheet will be provided for skip hoist for material transport.

Land site/ During

Construction, particularly dry season

Contractor(s)

✓

NA

-

S4.8.1

The area where dusty work takes place should be sprayed with water or a dust suppression chemical immediately prior to, during and immediately after dusty activities as far as practicable.

Land site/ During Construction

Contractor(s)

✓

Implemented

-

S4.8.1

All dusty materials should be sprayed with water or a dust suppression chemical immediately prior to any loading, unloading or transfer operation.

Land site/ During Construction

Contractor(s)

✓

Implemented, reminder issued

-

S4.8.1

Dropping heights for excavated materials should be controlled to a practical height to minimize the fugitive dust arising from unloading.

Land site/ During Construction

Contractor(s)

✓

Implemented

-

S4.8.1

During transportation by truck, materials should not be loaded to a level higher than the side and tail boards and should be dampened or covered before transport.

Land site/ During Construction

Contractor(s)

✓

Implemented

-

S4.8.1

Wheel washing device should be provided at the exits of the work sites. Immediately before leaving a construction site, every vehicle shall be washed to remove any dusty material from its body and wheels as far as practicable.

Land site/ During Construction

Contractor(s)

✓

Implemented

-

S4.8.1

Road sections between vehicle-wash areas and vehicular entrance will be paved.

Land site/ During

Construction

Contractor(s)

✓

Implemented

-

S4.8.1

Hoarding of not less than 2.4m high from ground level will be provided along the length of the Project Site boundary.

Land site/ During construction

Contractor(s)

✓

✓

N/A

-

S4.8.1

Haul roads will be kept clear of dusty materials and will be sprayed with water so as to maintain the entire road surface wet at all times.

Land site/ During construction

Contractor(s)

✓

Implemented, reminder issued

-

EIA Reference

Recommended Environmental Protection Measures/

Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant

Legislation & Guidelines

D

C

O

S4.8.1

Temporary stockpiles of dusty materials will be either covered entirely by impervious sheets or sprayed with water to maintain the entire surface wet all the time.

Land site/ During construction

Contractor(s)

✓

Implemented, reminder issued

-

S4.8.1

Stockpiles of more than 20 bags of cement, dry pulverised fuel ash and dusty construction materials will be covered entirely by impervious sheeting sheltered on top and 3sides.

Land site/ During construction

Contractor(s)

✓

N/A

-

S4.8.1

All exposed areas will be kept wet always to minimize dust emission.

Land site/ During construction

Contractor(s)

✓

Implemented, reminder issued

-

S4.8.1

Ultra-low-sulphur diesel (ULSD) will be used for all construction plant on-site, as defined as diesel fuel containing not more than 0.005% sulphur by weight) as stipulated in Environment, Transport and Works Bureau Technical Circular (ETWB-TC(W)) No 19/2005 on Environmental Management on Construction Sites.

Land site/ During construction/ During

Operation

Contractor(s)

✓

✓

Implemented

Environment,

Transport and

Works Bureau

Technical Circular

(ETWB- TC(W)) No

19/2005 on

Environmental

Management on

Construction Sites

S4.8.1

The engine of the construction equipment during idling will be switched off.

Land site/ During construction

Contractor(s)

✓

Implemented

-

S4.8.1

Concrete batching plant will be required on site. control measures recommended in the Guidance Note on a Best Practicable Means for Cement Works (Concrete Batching Plant) (BPM 3/2 (93)) will be implemented. The control measures recommended in the Guidance Note on a Best Practicable Means for Cement Works (Concrete Batching Plant) (BPM 3/2 (93)) will be implemented.

Land site/ During construction

Contractor(s)

✓

N/A

-

S4.8.1

 Regular maintenance of construction equipment deployed on-site will be conducted to prevent black smoke emission.

Land site/ During construction

Contractor(s)

✓

Implemented

-

S4.10

To ensure proper implementation of the recommended dust mitigation measures and good construction site practices during the construction phase, environmental site audits on weekly basis is recommended throughout the construction period.

Land site/ During construction

Contractor(s)/ ET & IEC

✓

Implemented

Note:  D – Design stage C – Construction O – Operation

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant

Legislation & Guidelines

D

C

O

Noise

S5.7

Only well-maintained plant will be operated on-site and plant will be serviced regularly during the construction phase.

All area/ During construction

Contractor(s)

✓

Implemented

A Practical Guide for the Reduction of Noise from

Construction Works

S5.7

Silencers or mufflers on construction equipment will be utilised and will be properly maintained during the construction phase.

Noise control/ During construction

Contractor(s)

✓

N/A

S5.7

Mobile plant, if any, will be sited as far away from NSRs as possible.

Noise control/ During construction

Contractor(s)

✓

N/A

S5.7

Machines and plant (such as trucks) that may be in intermittent use will be shut down between work periods or will be throttled down to a minimum.

Noise control/ During construction

Contractor(s)

✓

Implemented

S5.7

Plants known to emit noise strongly in one direction will, wherever possible, be orientated so that the noise is directed away from the nearby NSRs.

Noise control/ During construction

Contractor(s)

✓

N/A

S5.7

Material stockpiles and other structures will be effectively utilised, wherever practicable, in screening noise from onsite construction activities.

Noise control/ During construction

Contractor(s)

✓

N/A

S5.7

Use of Quite Powered Mechanical Equipment (QPME).

Noise control/ During construction

Contractor(s)

✓

Implemented

S5.7

Movable noise barriers of 3m in height with skid footing should be used and located within a few metres of stationary plant and mobile plant such that the line of sight to the NSR is blocked by the barriers. The length of the barrier should be at least five times greater than its height. The noise barrier material should have a superficial surface density of at least 7 kg m-2 and have no o or gappeningss.

Noise control/ During construction

Contractor(s)

✓

N/A

S5.7

The noise insulating sheet should be deployed such that there would be no opening or gaps on the joints.

Noise control/ During construction

Contractor(s)

✓

N/A

S5.7

Construction activities (e.g. excavation/shoring, reinstatement (asphalt), and pipe jacking) will be planned and carried out in sequence, such that items of PME proposed for these activities will not be operated simultaneously.

Noise control/ During construction

Contractor(s)

✓

✓

Implemented

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant

Legislation & Guidelines

D

C

O

S5.7

PMEs will not be used at the works areas near educational institutions with residual impact (ie the “influence area” within a radius of 40m) during school hours in order to reduce impact to the educational institutions.

Noise control / During construction

Contractor(s)

✓

N/A

S5.7

Noise enclosures or acoustic sheds would be used to cover stationary PME such as generators. Portable/Movable noise enclosure made of material with superficial surface density of at least 7 kg m-2 may be used for screening the noise from operation of the saw/groover, concrete.

Noise control/ Pre- construction/ During construction

Contractor(s)

✓

✓

N/A

-

S5.9

Sawcutting pavement, breaking up of pavement, excavation /shoring, pipe laying, backfilling, reinstatement (concrete) and pipe jacking shall be scheduled outside the examination period.

Noise control/ Pre- construction/ During construction

Contractor(s)

✓

✓

N/A

--

S5.9

In view the duration of noise exceedance at Creative

Secondary School, PLK Laws Foundation College, TKO Kei Tak Primary School and School of Continuing and Professional Studies-CUHK is limited to 8 weeks, the construction work in the influence areas near the four schools shall be scheduled during long school holidays (e.g., summer holiday, Easter holiday or Christmas holiday, etc.) as far as practicable. Scheduling the construction work for the four schools.

Noise control/ Pre- construction/ During construction

Contractor(s)

✓

✓

N/A

-

S5.10

A noise monitoring programme shall be implemented for the construction phase.

Designated monitoring stations as defined in EM&A Manual/During construction phase

ET

✓

N/A

-

S5.10

The effectiveness of on-site control measures could also be evaluated through the regular site audits.

All facilities/ During construction

Contractor(s)/ ET & IEC

✓

Implemented

-

Note:  D – Design stage C – Construction O – Operation

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant

Legislation & Guidelines

D

C

O

Water Quality

S6.9

Dredged marine sediment will be disposed of in a gazetted marine disposal area in accordance with marine dumping permit conditions of the Dumping at Sea Ordinance (DASO).

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

Dumping at Sea Ordinance (DASO)

S6.9

Disposal vessels will be fitted with tight bottom seals in order to prevent leakage of material during transport.

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

-

S6.9

Barges will be filled to a level, which ensures that material does not spill over during transport to the disposal site and that adequate freeboard is maintained to ensure that the decks are not washed by wave action.

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

-

S6.9

After dredging, any excess materials will be cleaned from decks and exposed fittings before the vessel is moved from the dredging area.

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

-

S6.9

All vessels should be well maintained and inspected before use to limit any potential discharges to the marine environment.

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

-

S6.9

All vessels must have a clean ballast system.

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

-

S6.9

No discharge of sewage/grey wastewater should be allowed. Wastewater from potentially contaminated area on working vessels should be minimized and collected.  These kinds of wastewater should be brought back to port and discharged at appropriate collection and treatment system.

Marine Dredging/ During construction

Contractor(s)

✓

Implemented

-

S6.9

No soil waste is allowed to be disposed overboard.

Marine Dredging/ During construction

Contractor(s)

✓

N/A

-

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant

Legislation & Guidelines

D

C

O

S6.9

Silt removal facilities such as silt traps or sedimentation facilities will be provided to remove silt particles from runoff to meet the requirements of the TM standard under the WPCO. The design of silt removal facilities will be based on the guidelines provided in ProPECC PN 1/94.   All drainage facilities and erosion and sediment control structures will be inspected on a regular basis and maintained to confirm proper and efficient operation at all times and particularly during rainstorms.   Deposited silt and grit will be removed regularly.

Land site & drainage/ During construction

Contractor(s)

✓

Implemented reminder issued

ProPECC PN 1/94

TM

Standard under the WPCO

S6.9

Earthworks to form the final surfaces will be followed up with surface protection and drainage works to prevent erosion caused by rainstorms.

Land site & drainage/ During construction

Contractor(s)

✓

Implemented

-

S6.9

Appropriate surface drainage will be designed and provided where necessary.

Land site & drainage/ During construction

Contractor(s)

✓

Implemented

-

S6.9

The precautions to be taken at any time of year when rainstorms are likely together with the actions to be taken when a rainstorm is imminent or forecasted and actions to be taken during or after rainstorms are summarized in Appendix A2 of ProPECC PN 1/94.

Land site & drainage/ During construction

Contractor(s)

✓

✓

Implemented

ProPECC PN 1/94

S6.9

Oil interceptors will be provided in the drainage system where necessary and regularly emptied to prevent the release of oil and grease into the storm water drainage system after accidental spillages.

Land site & drainage/ During construction

Contractor(s)

✓

N/A

-

S6.9

 Temporary and permanent drainage pipes and culverts provided to facilitate runoff discharge, if any, will be adequately designed for the controlled release of storm flows.

Land site & drainage/ During construction

Contractor(s)

✓

Implemented

-

S6.9

The temporary diverted drainage, if any, will be reinstated to the original condition when the construction work has finished or when the temporary diversion is no longer required.

Land site & drainage/ During construction

Contractor(s)

✓

N/A

-

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation status

Relevant

Legislation & Guidelines

D

C

O

S6.9

Appropriate numbers of portable toilets shall be provided by a licensed contractor to serve the construction workers over the construction site to prevent direct disposal of sewage into the water environment.

Land site & drainage/ During construction

Contractor(s)

✓

Implemented

-

S6.9 and S6.12

The sterilization water should be dechlorinated with total residual chlorine (TRC) level below 1 mg/L before discharge to public sewer. In situ testing of TRC should also be conducted for the discharge of chlorinated water for pipeline disinfection to ensure sufficient dichlorination before discharge to public sewer.

Sterilization of water mains prior to commissioning

Contractor(s)

✓

✓

Implemented

Technical

Memorandum for

Effluents

Discharged into

Drainage and

Sewerage Systems

S6.9

The cleaning and flushing water should also be treated and desilted to the relevant discharge requirement stipulated in TM-DSS before discharging.

Sterilization of water mains prior to commissioning

Contractor(s)

✓

✓

Implemented, observation issued

Technical

Memorandum for

Effluents

Discharged into Drainage and

S6.9

Site drainage should be well maintained, and good construction practices should be observed to ensure that oil, fuels, solvents and other chemicals are managed, stored and handled properly and do not enter the nearby water streams.

Land site & drainage/ During construction/ During operation

Contractor(s)

✓

✓

Implemented, reminder issued

-

S6.12

Regular site inspections will be carried out in order to confirm that regulatory requirements are being met and that contractors are implementing the standard site practice and mitigation measures as proposed to reduce potential impacts to water quality.

During construction

Contractor(s)/ ET & IEC

✓

Implemented, reminder issued

-

Note:  D – Design stage C – Construction O – Operation

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation Status

Relevant

Legislation & Guidelines

D

C

O

Waste Management

S8.5

Nomination of approved personnel to be responsible for standard site practices, arrangements for collection and effective disposal to an appropriate facility of all wastes generated at the site.

Contract mobilization/ During construction

Contractor(s)

✓

Implemented

-

S8.5

Training of site personnel in proper waste management and chemical handling procedures. Training will be provided to workers on the concepts of site cleanliness and appropriate waste management procedures, including waste reduction, reuse and recycling at the beginning of the construction works.

Contract mobilization/ During construction

Contractor(s)

✓

Implemented

-

S8.5

Provision of sufficient waste disposal points and regular collection for disposal.

All area/ During construction/ During operation

Contractor(s)

✓

✓

Implemented, reminder issued

DEVB TC(W) No.

8/2010, Enhanced Specification for

Site Cleanliness and Tidiness.

S8.5

Appropriate measures to reduce windblown litter and dust transportation of waste by either covering trucks or by transporting wastes in enclosed containers.

All area/ During construction

      Contractor(s)

✓

Implemented

S8.5

A waste management plan (WMP) as stated in the “ETWB TC(W) No. 19/2005, Environmental Management on Construction Sites” for the amount of waste generated, recycled and disposed of (including the disposal sites) will be established and implemented during the construction phase as part of the Environmental Management Plan (EMP).   The Contractor will be required to prepare the

EMP and submits it to the Architect/ Engineer under the Contract for approval prior to implementation.

All area/ During construction

      Contractor(s)

✓

Implemented

S8.5

Separation of chemical wastes for special handling and appropriate treatment at the Chemical Waste Treatment Centre at Tsing Yi.

All area/ During construction

      Contractor(s)

✓

Implemented

Chapters 2 & 3

Code of Practice on the Packaging, Labelling & Storage of Chemical Wastes published under

the Waste Disposal

Ordinance (Cap

354),

Section 35

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation Status

Relevant

Legislation & Guidelines

D

C

O

S8.5

Regular cleaning and maintenance programme for drainage systems, sumps and oil interceptors.

Land site/ During construction

Contractor(s)

✓

Implemented, reminder issued

Waste Disposal

Ordinance (Cap 354)

S8.5

A recording system for the amount of wastes generated/ recycled and disposal sites.   The trip- ticket system will be included as one of the contractual requirements and implemented by the contractor(s).

Land site/ During construction

Contractor(s)

✓

Implemented

DEVB TC(W) No.

6/2010,

Trip Ticket System for Disposal of

Construction &

Demolition Materials

S8.5

Prior to disposal of construction waste, wood, steel and other metals will be separated to the extent practical, for re-use and/or recycling to reduce the quantity of waste to be disposed of to landfill.

All areas/ During construction

Contractor(s)

✓

Implemented

S8.5

Segregation and storage of different types of waste in different containers, skips or stockpiles to enhance reuse or recycling of material and their proper disposal.

Land site/ During construction/ During operation

Contractor(s)

✓

Implemented, reminder issued

WBTC 32/92, The

Use of Tropical

Hard Wood on

Construction Site

S8.5

Use of reusable non-timber formwork to reduce the amount of C&D materials.

All areas/ During construction

Contractor(s)

✓

Implemented

S8.5

Encourage collection of aluminium cans and waste paper by individual collectors during construction with separate labelled bins provided to segregate these wastes from other general refuse by the workforce.

Land site/ During construction

Contractor(s)

✓

Implemented

ETWB TCW No. 33/2002,

Management of

Construction and

Demolition Material Including Rock

S8.5

Any unused chemicals and those with remaining functional capacity will be recycled as far as possible.

Land site/ During construction

Contractor(s)

✓

N/A

-

S8.5

Proper storage and site practices to reduce the potential for damage or contamination of construction materials.

All areas/ During construction

Contractor(s)

✓

Implemented, reminder issued

-

S8.5

Plan and stock construction materials carefully to reduce amount of waste generated and avoid unnecessary generation of waste.

All areas/ During construction

Contractor(s)

✓

Implemented

-

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation Status

Relevant

Legislation & Guidelines

D

C

O

S8.5

A Sediment Quality Report (SQR) for sampling and chemical testing of the sediment will be prepared and submitted to the EPD for approval.   The approved detailed sampling and chemical testing will be carried out prior to the commencement of the dredging activities to confirm the sediment disposal method.

Marine works/ During construction

Contractor(s)

✓

N/A

ETWB TC(W) No.

34/2002 and Dumping at

Sea Ordinance

(DASO)

S8.5

The management of dredged/ excavated sediment management requirement from ETWB TC(W) No. 34/2002 will be incorporated in the Specification of the Contract Documents.

Marine works/ During construction

WSD/ Contractor(s)

✓

 Implemented

S8.5

The contractor will open a billing account with EPD in accordance with the Waste Disposal (Charges for Disposal of Construction Waste) Regulation for the payment of disposal charges.

Contract mobilisation/ During construction

Contractor(s)

✓

Implemented

Cap 354N Waste

Disposal (Charges for Disposal of Construction

Waste) Regulation

S8.5

A trip-ticket system will be established in accordance with DEVB TC(W) No. 6/2010 to monitor the reuse of surplus excavated materials off-site and disposal of construction waste and general refuse at transfer facilities/ landfills, and to control fly-tipping.

Contract mobilisation/ During construction

Contractor(s)

✓

Implemented

DEVB TC(W) No.

6/2010,

Trip Ticket System for Disposal of

Construction &

Demolition Materials

S8.5

The project proponent will also conduct regular inspection of the waste management measures implemented on site as described in the Waste Management Plan.

All area/ During construction

 Contractor(s)/ ET/ IEC

✓

Implemented

ETWB TC(W) No.

19/2005,

Environmental

Management on

Construction Sites

S8.5

A recording system (similar to summary table as shown in Annex 5 and Annex 6 of Appendix G of ETWB TC(W) No. 19/2005) for the amount of waste generated, recycled and disposed of (including the disposal sites) will be established during the construction phase.

All area/ During construction

      Contractor(s)

✓

Implemented

Annex 5 and Annex 6 of Appendix G of ETWB TC(W) No.

19/2005

S8.5

Inert C&D materials (public fill) will be reused within the Project as far as practicable.

All area/ During construction

      Contractor(s)

✓

Implemented

-

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation Status

Relevant

Legislation & Guidelines

D

C

O

S8.5

Public fill and construction waste shall be segregated and stored in different containers or skips to facilitate reuse or recycling of materials and their proper disposal.

All area/ During construction

      Contractor(s)

✓

Implemented

-

S8.5

Specific areas of the work site will be designated for such segregation and storage if immediate use is not practicable.

All area/ During construction

      Contractor(s)

✓

Implemented

-

S8.5

To reduce the potential dust and water quality impacts of site formation works, C&D materials will be wetted as quickly as possible to the extent practice after filling.

All area/ During construction

      Contractor(s)

✓

Implemented

Air Pollution

Control

(Construction Dust) Regulation (Cap

311R); WPCO (Cap 358)

S8.5

Open stockpiles of excavated/ fill materials or construction wastes on-site should be covered with tarpaulin or similar fabric.

Land site/ During

Construction, particularly dry season

Contractor(s)

✓

Implemented, rectified after observation

Air Pollution

Control

(Construction Dust)

Regulation (Cap 311R)

S8.5

Chemical waste container shall be suitable for the substance they are holding, resistant to corrosion, maintained in a good condition, and securely closed.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented, reminder issued

Waste Disposal

(Chemical Waste)

(General)

Regulation; Code of

Practice on the

Packaging,

Handling and

Storage of Chemical

Wastes

S8.5

Chemical waste container shall have a capacity of less than 450 L unless the specifications have been approved by the EPD.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

S8.5

A label in English and Chinese shall be displayed on the chemical container in accordance with instructions prescribed in Schedule 2 of the Regulations.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented, rectified after observed issued

S8.5

Storage areas for chemical waste shall be enclosed on at least 3 sides.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

S8.5

Storage areas for chemical waste shall have an impermeable floor and bunding, of capacity to accommodate 110% of the volume of the largest container or 20% by volume of the chemical waste stored in that area, whichever is the greatest.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

S8.5

Storage areas for chemical waste shall have adequate ventilation.

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation Status

Relevant

Legislation & Guidelines

D

C

O

S8.5

Storage areas for chemical waste shall be covered to prevent rainfall entering (water collected within the bund must be tested and disposed of as chemical waste, if necessary).

All area/ During construction/ During operation

Contractor(s)/ WSD

✓

✓

Implemented

S8.5

Storage areas for chemical waste shall be arranged so that incompatible materials are appropriately separated.

All area/ During construction/ During operation

Contractor(s)/

WSD

✓

✓

Implemented

S8.5

General refuse will be stored in enclosed bins or compaction units separately from construction and chemical wastes.

All area/ During construction/ During operation

Contractor(s)/

WSD

✓

✓

Implemented, reminder and observation issued

S8.5

Adequate number of waste containers will be provided to avoid over-spillage of waste.

All area/ During construction/ During operation

Contractor(s)/

WSD

✓

✓

Implemented

DEVB TC(W) No.

8/2010

Enhanced

Specification for

Site Cleanliness and Tidiness.

S8.5

A reputable waste collector will be employed by the Contractor to remove general refuse from the site, separately from construction and chemical wastes, on a daily basis to minimise odour, pest and litter impacts.

All area/ During construction/ During operation

Contractor(s)/

WSD

✓

✓

Implemented, reminder issued

-

S8.5

Recycling bins will be provided at strategic locations within the Site to facilitate recovery of recyclable materials (including aluminium can, wastepaper, glass bottles and plastic bottles) from the Site. Materials recovered will be sold for recycling.

All area/ During construction/ During operation

Contractor(s)/

WSD

✓

✓

Implemented

-

S8.5

To avoid any odour and litter impact, accurate number of portable toilets will be provided for workers on-site.

All area/ During construction

        Contractor(s)

✓

Implemented

-

S8.5

The burning of refuse on construction sites is prohibited by law.

All area/ During construction

        Contractor(s)

✓

Implemented

Air Pollution

Control Ordinance

(Cap 311)

S8.7

To facilitate monitoring and control over the contractors’ performance on waste management, a waste inspection and audit programme will be implemented throughout the construction phase.

All facilities/ During construction

ET/ IEC

✓

Implemented

-

Note:  D – Design stage C – Construction O – Operation

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation Status

Relevant

Legislation & Guidelines

D

C

O

Ecology

S9.7

For slope mitigation works within the Clear Water Bay Country Park, to avoid tree felling and damages to trees, the exact locations of the flexible barrier foundation plates, soil nails and rock dowels can be adjusted during detailed design, and a setback distance from existing trees is recommended to be maintained as far as practical. A detailed specification describing the exact locations of the flexible barrier foundation plates, soil nails and rock dowels will be prepared to illustrate how the setback distance from existing trees would be implemented for tree avoidance.

Slope mitigation works area/

During detailed design/ During construction

Contractor(s)

✓

✓

N/A

-

S9.7

Pruning of tree canopies along the alignment of the flexible barriers shall be limited to a minimum.

Slope mitigation works area/ During construction

Contractor(s)

✓

N/A

S9.7

The alignment of flexible barriers shall be optimized to preserve all species of conservation interest and minimize the impact to the existing vegetation as far as practicable.   All individuals of Marsdenia lachnostoma within the slope mitigation areas shall be retained in- situ, by positioning the alignment of flexible barrier at a minimum 1.5m in a radius away from these individuals.

Slope mitigation works area/

During detailed design/ During construction

Contractor(s)

✓

✓

N/A

-

S9.7 and

9.10

At the detailed design stage prior to the commencement of the slope mitigation works, a vegetation survey shall be carried out at the slope mitigation areas within the Clear Water Bay Country Park to assess the condition and identify the location of each individual of Marsdenia lachnostoma and other flora species of conservation interest that may be directly affected by the construction works.

Slope mitigation works area/

During detailed design/ During construction

Contractor(s)

✓

Implemented

-

S9.7

Temporary fencing will be installed to fence off the concerned species either in groups of individually within the works area and in the close proximity to prevent from being damaged and disturbed during construction. A sign identifying the site shall be attached to the fence and flagging tape shall be attached to the individuals to visualize their locations.

Slope mitigation works area/ During construction

Contractor(s)

✓

N/A

-

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation Status

Relevant

Legislation & Guidelines

D

C

O

S9.7 and S9.10

A specification for fencing and demarcating individuals of Marsdenai lachnostoma (or other flora species of conservation interest, if found) adjacent to the proposed alignment of the flexible barriers will be prepared to protect the species.

Slope mitigation works area/ During construction

Contractor(s)

✓

N/A

-

S9.7

Induction training shall also be provided to all site personnel in order to brief them on this flora of conservation interest including the locations and their importance.

Slope mitigation works area/ During construction

Contractor(s)

✓

N/A

-

S9.7

The resident site supervisory staff will closely monitor the conditions of concerned individuals during construction of flexible barriers in the close proximity.

Slope mitigation works area/ During construction

Contractor(s)

✓

N/A

-

S9.7

Erect fences along the boundary of the works area before the commencement of works to prevent vehicle movements and encroachment of personnel onto adjacent areas.

All area/ During construction

      Contractor(s)

✓

Implemented

-

S9.7

Regularly check the work site boundaries to ensure that they are not breached, and that damage does not occur to surrounding areas.

All area/ During construction

     Contractor(s)/

Environmental Team (ET)

✓

Implemented.

-

S9.7

Avoid any damage and disturbance, particularly those caused by filling and illegal dumping, to the surrounding habitats through proper management of waste disposal.

All area/ During construction

      Contractor(s)

✓

Implemented

-

S9.7

Reinstate temporarily affected areas, particularly the habitats of plantation and shrubland-grassland immediately after completion of construction works, through on-site tree/shrub planting. The tree/shrub species will be chosen with reference to those in the surrounding area.

All area/ During construction

      Contractor(s)

✓

 N/A

-

S9.7

Affected habitats within the Clear Water Bay Country Bay shall be reinstated by hydro-seeding and planting of climbers and native shrub seedlings where practical upon completion of the slope mitigation works.

All area/ During construction

      Contractor(s)

✓

N/A

-

  Note:  D – Design stage C – Construction O – Operation

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation Status

Relevant

Legislation & Guidelines

D

C

O

Landscape & Visual

S11.10 &

11.11

The construction area and area allowed for temporary structures, such as the contractor’s office, will be minimized to a practical minimum. (MM1)

All area/ Detailed design/

During construction/ During operation

WSD/ Contractor(s)

 ✓

✓

✓

Implemented

-

S11.10 &

11.11

At the detailed design stage, the design team will seek to minimize the landscape footprint of the Project and above ground facilities, while satisfying all other requirements.

(MM2)

All area/ Detailed design/

During construction/ During operation

WSD/ Contractor(s)

 ✓

✓

✓

Implemented

-

S11.10 &

11.11

Design principles will be adopted to take into account the surrounding area, particularly Clear Water Bay Country Park behind and the nearby waterfront, with due consideration given to:

-  green roofs where practical (i.e. without equipment on the roof);

-  roadside planting;

-  aesthetic treatment of all structures;

-  vertical greening;

-  screen planting along application site; and

-  landscape enhancement with amenity planting where practical including planting along the edge (site boundary) fence with native shrubs where feasible, to reduce their visual impact and blend them into the

surrounding landscape.   (MM3)

All area/ Detailed design/

During construction/ During operation

WSD/ Contractor(s)

 ✓

✓

✓

Implemented

-

S11.10 &

11.11

All trees within the Project Site or the potential slope mitigation works area will be carefully protected during construction according to DEVB TCW No. 10/2013 – Tree Preservation (MM4)

All area/ Detailed design/

During construction/ During operation

WSD/ Contractor(s)

 ✓

✓

✓

Implemented, reminder issued

ETWB TCW No.

3/2006 - Tree Preservation.

S11.10 &

11.11

No tree within the Country Park will be felled. Trees within the Site unavoidably affected by the works will be transplanted where necessary and practical. For trees that need to be felled, compensatory planting will be provided to the satisfaction of relevant Government departments. A compensatory tree planting proposal including locations of tree compensation will be submitted to seek relevant government department’s approval, in accordance with

DEVB TC(W) No. 10/2013.   (MM5)

All area/ Detailed design/

During construction/ During operation

WSD/ Contractor(s)

 ✓

✓

✓

Implemented

DEVB TC(W) No. 10/2013

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation Status

Relevant

Legislation & Guidelines

D

C

O

S11.10 &

11.11

Any slope mitigation works necessary to address natural terrain hazards, will be minimized to minimize any potential environmental impact to the Country Park e.g. soil nailing and rock stabilization will aim to avoid existing trees e.g. should any restoration of vegetation be necessary, the best planting matrix with native species will be established, with the aim of resembling the existing vegetation. (MM6)

All area/ Detailed design/

During construction/ During operation

WSD/

Contractor(s)

✓

✓

✓

N/A

S11.10 &

11.11

Dredging works for the installation of intake structures and outfall diffusers should be minimized to avoid or reduce any potential environmental impacts to as low as reasonably practicable (ALARP). The intake and outfall structures (e.g. intake openings and diffuser heads) will be prefabricated and transferred to site for installation.

(MM7)

All area/ Detailed design/

During construction/ During operation

WSD/ Contractor(s)

 ✓

✓

✓

Implemented

S11.10 &

11.11

All night-time lighting will be reduced to a practical minimum both in terms of number of level and will be hooded and directional. (MM8) units and lux level and will be hooded and directional. (MM8)

All area/ Detailed design/

During construction/ During operation

WSD/ Contractor(s)

 ✓

✓

✓

Implemented

-

Note:  D – Design stage C – Construction O – Operation

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation Status

Relevant Legislation & Guidelines

D

C

O

Landfill Gas Hazard

S12.7

During all works, safety procedures should be implemented to minimise the risks of fires and explosions, asphyxiation of workers and toxicity effects resulting from contact with contaminated soil and groundwater.

All area/ Detailed design/

During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

During trenching and excavation as well as creation of confined spaces at near to or below ground level, precautions should be clearly laid down and rigidly Gas detection equipment and appropriate breathing apparatus should be available and used when entering confined spaces or trenches deeper than 1 metre.

All area/ Detailed design/

During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

The Contractor should make the workers are aware of potential hazards of working in confined spaces (any chamber, manhole or culvert which is large enough to permit access to personnel). Such work in confined spaces is controlled by the Factories and Industrial Undertakings (Confined Spaces) Regulations of the Factories and Industrial Undertakings Ordinance. Following the Safety Guide to Working in Confined Spaces ensures compliance with the above regulations.

All area/ Detailed design/

During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

Safety officers, specifically trained with regard to landfill gas and leachate related hazards and the appropriate actions to take in adverse circumstances, should be present on the site throughout the works, in particular, when works are undertaken below grade.

All area/ Detailed design/

During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

All personnel who work on site and all visitors to the site should be made aware of the possibility of ignition of gas in the vicinity of the works, the possible presence of contaminated water and the need to avoid physical contact with it.

All area/ Detailed design/

During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

Monitoring for landfill gas should be undertaken in all excavations, manholes, chambers (particularly during pipe jacking) and any confined spaces through the use of an intrinsically safe portable instrument, appropriately calibrated and capable of measuring the concentrations of methane. carbon dioxide and oxygen.

All area/ Detailed design/

During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation Status

Relevant Legislation & Guidelines

D

C

O

S12.7

Monitoring frequency and areas to be monitored should be specified prior to commencement of groundwork, either by the Safety Officer, or by an appropriately qualified person.  All measurements should be recorded and documented.

All area/ Detailed design/

During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

Proceed drilling with adequate care and precautions against the potential hazards which may be encountered.

All area/ Detailed design/

During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

Prior to the commencement of the site works, the drilling contractor should devise a 'method-of- working' statement covering all normal and emergency procedures (including but not limited to number of operatives, experience and special skills of operatives, normal method of operations, emergency procedures, supervisors responsibilities, storage and use of safety equipment, safety procedures and signs, barriers and guarding).   The site supervisor and all operatives must be familiar with this statement.

All area/ During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

S12.7

Where below ground service entries are necessary to the

Incoming Switchgear Room, 132 kV Substation and

Chlorine Store (I) and (II), the entry point should be sealed to prevent gas entry.   In addition, any below grade cable trenches entering the Incoming Switchgear Room and 132 kV Substation can become the pathway for landfill gas and hence grilled metal covers should be used.

All area/ Detailed design/

During construction/ During operation

Contractor(s)

✓

✓

✓

N/A

-

S12.7

It is recommended regular landfill gas monitoring should be carried out at the Incoming Switchgear Room, 132 kV Substation and Chlorine Store (I) and (II). The monitoring frequency will be monthly for the first year of operation. If the monitoring results show no sign of landfill gas migration, reduce the monitoring frequency to once every six months.

All area/ Detailed design/

During construction/ During operation

Contractor(s)

✓

✓

✓

N/A

-

S12.7

The manholes and utility pits within the Project Site and along the fresh water mains. Each manhole/ utility pit should be monitored with two measurements (at mid depth and base). Each measurement should be monitored for a minimum of 10 minutes. A steady reading and peak reading should be recorded at each manhole/ utility pit

All area/ Detailed design/

During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

EIA Reference

Recommended Environmental Protection Measures/

                                  Mitigation Measures

Objectives of the recommended measures & main concerns to address

Implementation Agent

Implementation Stage

Implementation Status

Relevant Legislation & Guidelines

D

C

O

and for each measurement.   The need for venting the manhole/ utility pit and further monitoring will be reviewed after the initial monitoring.

S12.7

All construction, operation and maintenance personnel working on-site as well as visitors should be made aware of the hazards of landfill gas and its possible presence onsite. This should be achieved through a combination of posting warning signs in prominent places and also by access to detailed information on landfill gas hazards and the designs and procedural means by which these hazards are being minimized on-site.

All area/ Detailed design/

During construction/ During operation

Contractor(s)

✓

✓

✓

Implemented

-

Note:  D – Design stage C – Construction O – Operation

Appendix D

Water            Quality            Graphical

Presentation

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

Appendix D-1

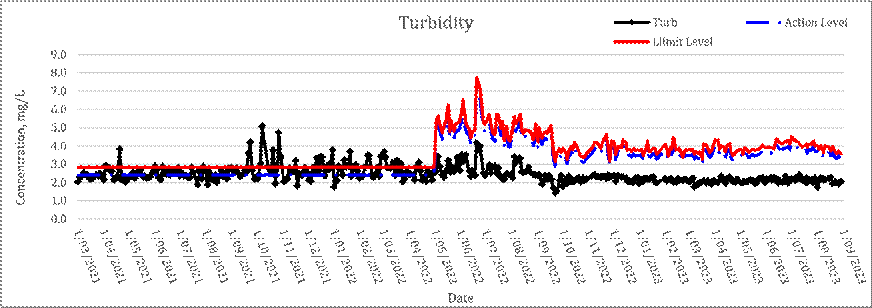

Construction Phase Impact Water Quality Monitoring

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

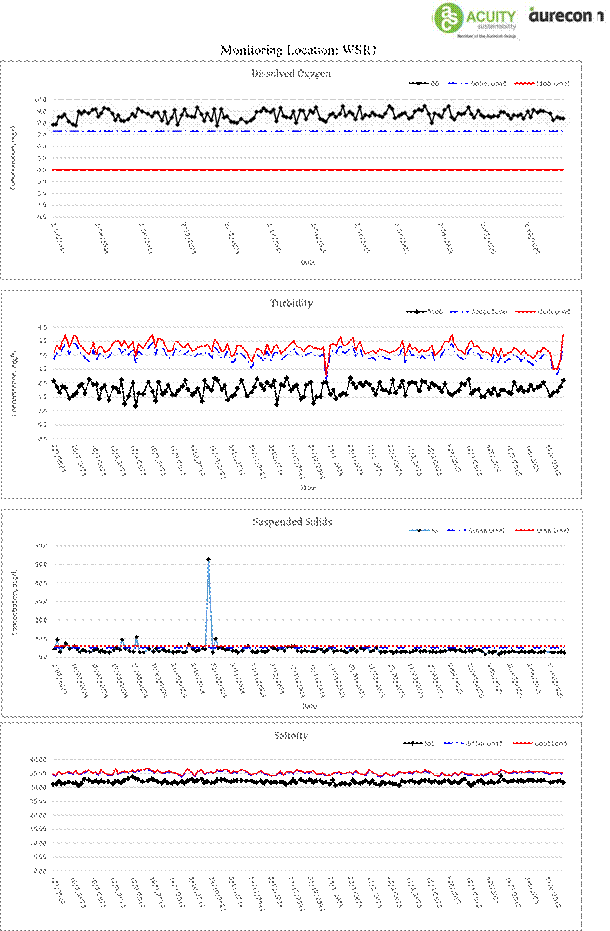

Monitoring Location : WSR 16

Monitoring Location : WSR 33

Monitoring Location : WSR 36

Monitoring Location : WSR 37

Monitoring Location : WSR 16

Monitoring Location : WSR 33

Monitoring Location : WSR 36

Monitoring Location : WSR 37

Appendix D-2

Pre-operation Phase Impact Water Quality Monitoring

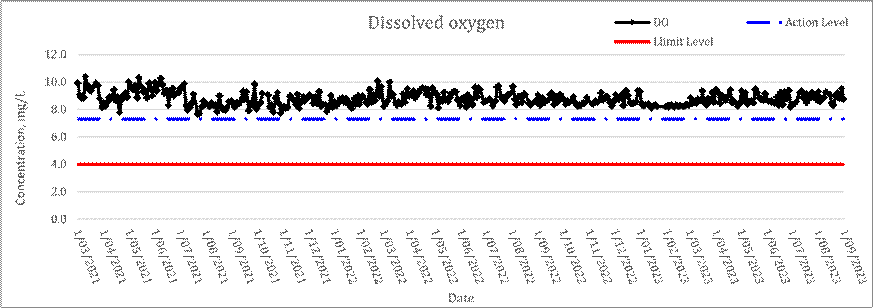

The water quality monitoring commenced in 12 December 2023.

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

Monitoring Location: WSR1

Monitoring Location: WSR2

Monitoring Location: WSR2

Monitoring Location: WSR3

Monitoring Location: WSR3

Monitoring Location: WSR4

Monitoring Location: WSR4

Monitoring Location: WSR16

Monitoring Location: WSR16

Monitoring Location: WSR33

Monitoring Location: WSR33

Monitoring Location: WSR36

Monitoring Location: WSR36

Monitoring Location: WSR37

Monitoring Location: WSR37

Monitoring Location: NF1

Monitoring Location: NF1

Monitoring Location: NF2

Monitoring Location: NF2

Monitoring Location: NF3

Monitoring Location: NF3

Appendix D-3

Operation Phase Impact Water Quality Monitoring

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Monitoring Location: WSR2

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Monitoring Location: WSR3

Monitoring Location: WSR3

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Monitoring Location: WSR4

Monitoring Location: WSR4

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Monitoring Location: WSR16

Monitoring Location: WSR16

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Monitoring Location: WSR33

Monitoring Location: WSR33

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Monitoring Location: WSR36

Monitoring Location: WSR36

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Monitoring Location: WSR37

Monitoring Location: WSR37

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Monitoring Location: NF1

Monitoring Location: NF1

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Monitoring Location: NF2

Monitoring Location: NF2

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

Monitoring Location: NF3

Monitoring Location: NF3

Remark: The lowest detection limit of the Iron is 0.1mg/L. All result of iron monitoring are lower than the detection limit.

EM&A Review Report

Appendix E

Site Inspection Proforma

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

Site Inspection Observation Record

Date

Environmental Observations

Follow-up Status

March 2020

17 March 2020

Observation(s) and Recommendation(s) 1. Opened cement’s package was observed. It should be removed to prevent dust emission.

1. Cement’s package removed to waste temporary storage area.

24 March 2020

No Major observation was observed.

Nil

30 March 2020

April 2020

7 April 2020

No Major observation was observed.

Nil

14 April 2020

21 April 2020

29 April 2020

Observation(s) and Recommendation(s)

1. The chemical (i.e. bleach) should be placed in the proper storage area.

1.

The chemical was removed and stored in proper storage area.

May 2020

5 May 2020

Observation(s) and Recommendation(s)

1.    Dust suppression mitigations were not implemented during construction activities.

2.    Drip tray was observed without a plug / stopper. It should be added to prevent the leakage of chemicals.

3.    NRMM label was not observed on the NRMM (crawler crane).

4.    Chemical stain was observed on ground.

1.

2. 3.

4.

Water spraying for dust suppression.

Plug provided.

NRMM label provided. Chemical stain removed and temporary stored at chemical waste storage.

13 May 2020

Observation(s) and Recommendation(s)

1. Dust suppression mitigations were not implemented. Follow up actions should be implemented on dusty stock piles to reduce dust emissions.

1. Cover provided for stockpile

19 May 2020

No Major observation was observed.

Nil

27 May 2020

June 2020

2 June 2020

Observation(s) and Recommendation(s)

1. The stagnant water had cleaned.

Date

Environmental Observations

Follow-up Status

1. Stagnant water was observed inside the drip tray. The stagnant water should be cleaned after raining.

8 June 2020

No Major observation was observed.

Nil

17 June 2020

23 June 2020

30 June 2020

July 2020

2 July 2020

No Major observation was observed.

Nil

14 July 2020

Observation(s) and Recommendation(s)

1. Chemicals drums were not placed inside a drip tray t 132kV and combined shaft area.

1. Chemical drums were removed or placed inside drip tray.

21 July 2020

No Major observation was observed.

Nil

29 July 2020

August 2020

4 August 2020

No Major observation was observed.

Nil

11 August 2020

18 August 2020

27 August 2020

September 2020

1 September 2020

No Major observation was observed.

Nil

8 September 2020

16 September 2020

25 September 2020

29 September 2020

Observation(s) and Recommendation(s)

1. Chemical were not placed inside the diptray at the RO area.

1. Chemical removed off site for proper storage.

October 2020

6 October 2020

No Major observation was observed.

Nil

14 October 2020

20 October 2020

Observation(s) and Recommendation(s)

1. Cover was provided.

Date

Environmental Observations

Follow-up Status

1. Stock of more than 20 bags of cement/dry pulverized fuel ash was not covered /enclosed in an area with 3 sides covered at Combine Shaft Area. (Observation)

30 October 2020

Observation(s) and Recommendation(s)

1. Housekeeping was reminded as C&D materials and general wastes were observed not stored properly in designed containers at ActifDAFF and RO areas.

(Observation)

1. Housekeeping             was conducted.

November 2020

3 November 2020

No Major observation was observed.

Nil

10 November 2020

Observation(s) and Recommendation(s)

1. Some connections of the silt curtain were observed detached and may reduce the subsequent filtering efficiency of dusty materials generated from the construction site. (observation)

1. Connections of slit curtain were repaired.

18 November 2020

No Major observation was observed.

Nil

26 November 2020

No Major observation was observed.

Nil

December 2020

1 December 2020

No Major observation was observed.

Nil

8 December 2020

No Major observation was observed.

Nil

15 December 2020

No Major observation was observed.

Nil

22 December 2020

No Major observation was observed.

Nil

30 December 2020

No Major observation was observed.

Nil

January 2021

5 January 2021

No Major observation was observed.

Nil

12 January 2021

No Major observation was observed.

Nil

19 January 2021

No Major observation was observed.

Nil

29 January 2021

No Major observation was observed.

Nil

February 2021

2 February 2021

No Major observation was observed.

Nil

9 February 2021

No Major observation was observed.

Nil

Date

Environmental Observations

Follow-up Status

18 February 2021

No Major observation was observed.

Nil

24 February 2021

No Major observation was observed.

Nil

March 2021

2 March 2021

Observation(s) and Recommendation(s)

1. Chemicals were not placed inside a drip tray near the Product Water Storage Tank (observation).

1. Chemical removed and stored in proper storage

9 March 2021

Observation(s) and Recommendation(s)

1. Chemicals were not placed on a drip tray at Combined Shaft Area, Product Water Storage Tank and Formwork Storage Area (observation).

1. Chemical removed and stored in proper storage

16 March 2021

No Major observation was observed.

Nil

23 March 2021

No Major observation was observed.

Nil

30 March 2021

No Major observation was observed.

Nil

April 2021

07 April 2021

No major observation was reported on the

Nil

respective day.

13 April 2021

20 April 2021

30 April 2021

May 2021

04 May 2021

No major observation was reported on the respective day.

Nil

12 May 2021

18 May 2021

2. Chemical waste container was observed in the general waste collection area at Combined Shaft Area (near to seafront)

2. Chemical drum was sorted out from the waste skip.

25 May 2021

1. Chemicals were not placed inside a drip tray at drainage channel near to No. 2 water treatment tank.

1. Drip tray was provided.

31 May 2021

No major observation was reported on the respective day.

Nil

June 2021

08 June 2021

No major observation was reported on the respective day.

Nil

15 June 2021

22 June 2021

2. Overflow of trapped concrete water at sump pit near to worker resting area was observed. More stringent mitigation measure should be implemented to prevent the wastewater discharge into the open channel. The Contractor was reminded to consider capacity of sump pit especially at the area of concrete washing.

2.

Soak/    sump    pit excavated to expand, and        sandbag                 were provided to enhance desilting capability.

30 June 2021

No major observation was reported on the respective day.

Nil

July 2021

06 July 2021

No major observation was reported on the respective day.

Nil

13 July 2021

20 July 2021

30 July 2021

1. Oil stain/ spillage was observed on multiple areas of sea surface around Intake Shaft Area. The Main Contractor was reminded to take remediate actions immediately.

1.

Oil stains cleaned up with absorbent.

August 2021

03 August 2021

2. Chemicals were not placed inside a drip tray at Product Water Storage Area.

2.

Drip tray provided.

10 August 2021

No major observation was reported on the respective day.

Nil

17 August 2021

24 August 2021

1. Gillies were observed not protected by sandbags and geotextile at Wan Po Road.

1.

Road gullies of concern were covered with tarpaulin sheet to avoid soil from dropping in and silty runoff from flowing in.

31 August 2021

1. Overflowing of concrete washing wastewater was observed at Concrete Washing Area. The Main Contractor was reminded to increase the wastewater holding capacity and add the earth bunds/ sandbags at the exit to prevent intreated water overflowing from the construction site.

1. Sandbags bunds provided to desilt the wastewater before darning to the perimeter drain.

September 2021

07 September

2021

1. Trapped general wastes materials were observed in the drainage open channel near to Reverse Osmosis Area. The Main Contractor was reminded to remove the trapped materials to allow efficient drainage.

1. Trapped materials was removed.

13 September

2021

1.       Chemical wastes were observed along the general waste sorting area at ActiDAFF Area. The Main Contractor was reminded that chemical wastes should be stored in chemical waste storage container and separately from the general wastes.

2.       General wastes were observed on the sea surface next to the marine barge at Outfall Shaft. The Main Contractor was reminded that all general wastes should be stored in wastes skips (observation).

3.       General wastes were found in the open cannel. These materials should be removed to allow efficient drainage (Between ActiDAFF and Reverses Osmosis Area)

4.       Chemicals were found not stored in drip tray at the derrick barge at Intake Shaft Area

1.     Waste removed and separated in proper storage area (i.e.: chemical removed into chemical waste storage container)

2.     Waste was removed.

3.     Wastes in channel were removed.

4.     Chemical removed into proper storage area.

21 September

2021

No major observation was reported on the respective day.

Nil

28 September

2021

1. Chemicals were found not stored in drip trays at barge at Intake Shaft Area.

1.

Chemicals           were stored   in                 suitable storage area.

October 2021

06 October 2021

No major observation was reported on the respective day.

Nil

15 October 2021

1.    The Main Contractor was reminded to add sandbags/earth bunds at the exit of Concrete Washing Area to ensure no effluent should be discharged from the construction site without treatment (Concrete Washing Area)

2.    Chemical container was observed at general waste storage area (Combined Shaft Area)

1.

2.

Sandbags we added. Chemical stored   on area       for disposal.

re

waste suitable proper

19 October 2021

No major observation was reported on the respective day.

Nil

29 October 2021

2. Proper storage for chemicals and chemical waste shall be provided (i.e., drip tray) at Combined Shaft Area.

2. Drip tray was provided.

November 2021

02 November 2021

No major observation was reported on the respective day.

Nil

09 November 2021

1. A drum of chemical was observed not placed on a drip tray at Worker Resting Area near to PWST Area

1.

Chemical was stored in suitable area.

16 November 2021

No major observation was reported on the respective day.

Nil

26 November 2021

2. Chemicals were observed not placed on a drip tray at Worker Area, Reverse Osmosis Area, and Steel Bar Area.

2.

Chemical             were arranged to store into a proper storage                 area asap. After that there is no chemical to be found on the workplace.

30 November 2021

No major observation was reported on the respective day.

Nil

December 2021

07 December 2021

1. Chemicals were not placed on a drip tray and cap added at Central Chiller Plant Building, metal storage area, between Reverse Osmosis/ActiDAFF Area and

Administration Building

1.

Removed the chemical to proper storage area as soon as possible.

15 December 2021

1. Chemicals were not placed on a drip tray at metal storage area, near to the area between Combined Shaft Area/ Seafront Area, near to VTEC Area.

2.

Chemicals removed to proper storage area.

22 December 2021

No major observation was reported on the respective day.

Nil

31 December 2021

January 2022

04 January 2022

No major observation was reported on the respective day.

Nil

11 January 2022

18 January 2022

1. It has been observed during the site inspection on 18 January 2022 that there is a new sources of underground seepage marine water in the outfall shaft caisson that was not by-pass through an uncontaminated isolation system. The main contractor was urged to take immediate

1. The seepage water is separated.

remediate action to ensure the seepage marine water should be contained in an isolation system before by-pass through a silt curtain

26 January 2022

1. The main contractor was reminded that all chemical containers should be placed in drip tray (VTEC Area, Product water Storage Area and Reverse Osmosis Area) & Chemical waste should be stored in an appropriate chemical waste container at

reverse osmosis area

1. Chemical        moved to proper storage area.

31 January 2022

No major observation was reported on the respective day.

Nil

February 2022

08 February 2022

No major observation was reported on the respective day.

Nil

17 February 2022

23 February 2022

28 February 2022

March 2022

08 March 2022

1. Drip tray should be provided for chemical storage.

1. Chemical moved and stored in proper area.

15 March 2022

No major observation was reported on the respective day.

Nil

23 March 2022

30 March 2022

April 2022

06 April 2022

No major observation was reported on the respective day.

Nil

12 April 2022

19 April 2022

29 April 2022

May 2022

3 May 2022

No major observation was reported on the respective day.

Nil

10 May 2022

17 May 2022

1. Drip tray should be provided for chemical storage and provide label for the chemical.

(RO Building)

1. Chemical removed offsite.

24 May 2022

1. The Contractors are reminded to provide drip trays for the oil drums near the power generator near outfall.

1. Drip tray provided.

31 May 2022

No major observation was reported on the respective day.

Nil

June 2022

07 June 2022

No major observation was reported on the Nil respective day.

14 June 2022

21 June 2022

28 June 2023

July 2022

05 July 2022

No major observation was reported on the respective day.

Nil

12 July 2022

19 July 2022

29 July 2022

1.    General refuse, food package and plastic bottle were found around the site OSCG Building, the Contractors are reminder to clean up immediately.

2.    Chemical tanks were found placed near the RO Building without drip tray or proper storage. The contractors are reminded to store the chemical tanks preoperly.

1.       General refuse, food package and plastic bottle were clean up.

2.       Chemical tanks were removed.

August 2022

02 August 2022

1. There are two oil tanks found near the Administration Building without proper storage or drip tray. The Contractor is reminded to provide a proper storage asap.

1. Proper           storage         was provided.

09 August 2022

No major observation was reported on the respective day.

Nil

16 August 2022

1. Chemical containers found near the chemical Building shall be placed/ stored on a drip tray to avid oil leakage or spillage.

1. Drip tray was provided for chemical storage.

23 August 2022

1. General refuse (lunch box) should be disposed of preoperly at a proper waste storage point (Produce Waste Storage Tank).

1. Waste was cleaned.

31 August 2022

No major observation was reported on the respective day.

Nil

September 2022

06 September

2022

3. Chemical s found near the ActiDaff Building Shall be stored properly.

3. Chemical was removed.

13 September

2022

1. Chemical containers found near the R.O. Building shall be stored on drip tray or proper chemical storage,

1. Chemical was removed.

20 September

2022

No major observation was reported on the respective day.

Nil

30 September

2022

2. Chemical containers found in the R.O Building Shall be stored on a drip tray or with proper storage.

2. Chemical removed.

was

October 2022

05 October 2022

2. The Chemical containers and the bottle found on the ground near the CO2 Building and Administration Building shall be stored on a drip tray or proper storage area to prevent leakage.

2. Chemical was removed.

11 October 2022

No major observation was reported on the respective day.

Nil

18 October 2022

1. Drip tray shall be provided for chemical container at Administration Building.

1. Chemical was removed.

25 October 2022

2. Drip tray shall be provided for chemical storage. (Product water storage tank)

2. Chemical removed.

was

31 October 2022

1. Chemical container shall be stored with drip tray (ActiDAFF).

1. Chemical removed.

was

November 2022

8 November 2022

1. Chemical containers found near the OSCG and staff office and ActiDAFF shall be stored on a drip tray or proper storage area to prevent leakage.

1. Chemical was removed.

15 November 2022

1. Chemical containers found near the OSCG shall be stored on a drip tray or proper storage. Excess chemicals on the ground shall be removed properly.

3. Chemical removed.

was

22 November 2022

No major observation was reported on the respective day.

Nil

29 November 2022

3. Chemical containers found near the contractor rest area and Admin Building shall be stored on a drip or proper chemical storage.

3. Chemical was removed.

December 2022

06 December 2022

1. Black water puddles were found near the temporary backfilling stockpile and rest area near the Subcontractor office. The Contractor is reminded to provide the proper treatment to remove the black water.

1. The water removed to nearest wastewater treatment system and discharge after treatment.

13 December 2022

No major observation was reported on the respective day.

Nil

22 December 2022

1. Chemical containers found inside the OSCG shall be stored properly or placed on a drip tray to prevent leakage.

1. Chemical was removed.

29 December 2022

No major observation was reported on the respective day.

Nil

January 2023

03 January 2023

No major observation was reported on the respective day.

Nil

10 January 2023

17 January 2023

27 January 2023

31 January 2023

1. A chemical container found on the ground near the OSCG Building shall be stored properly. The chemical containers were removed immediately are notification.

1. The chemical containers were removed immediately.

February 2023

07 February 2023

1. The Contactors are reminded to remove the wooden beam floating on the outfall asap.

1. The wooden beam had been removed.

15 February 2023

1. Chemical containers found near the Product Water Pumping Station combined shaft and Pre-cast site (Bridge) shall be removed or stored properly.

1. The chemical had been removed.

21 February 2023

2. The chemical containers found near the rest area near the ActiDAFF and bridge area shall be removed or stored properly.

2. The chemical had been removed.

28 February 2023

2. Chemical tanks and containers found near the Chemical Building shall be properly stored on a drip tray.

2. The chemical tanks and containers had removed.

March 2023

07 March 2023

2. Chemical tanks found near the RO Building shall be properly stored or on a drip tray to

2. The chemical had been removed.

prevent leakage. The broken chemical label shall be also replaced asap.

14 March 2023

1. Chemical container found near the

Chemical Building shall be properly stored or placed on a drip tray to prevent leakage.

1. The chemical had been removed.

22 March 2023

1. The chemical containers found near mechanic workshop, combined Shaft area shall be properly stored or stored on a drip tray.

1. The chemical had been removed.

31 March 2023

No major observation was reported on the respective day.

Nil

April 2023

04 April 2023

No major observation was reported on the respective day.

Nil

11 April 2023

18 April 2023

1. Oil drums found near the shall be provided a proper storage or drip tray to prevent oil leakage.

1. Oil drums were removed.

24 April 2023

No major o

bservation was reported on the respective day.

Nil

May 2023

2 May 2023

  No     major

environmental     deficiency     was

observed.

N/A

9 May 2023

No        major observed.

environmental     deficiency     was

N/A

16 May 2023

No        major observed.

environmental     deficiency     was

N/A

23 May 2023

Chemical containers found near the South end of the site near the slope shall be provided with a proper storage or drip tray to prevent leakage.

Chemical was removed.

30 May 2023

No        major    environmental deficiency               was observed.

N/A

June 2023

6 Jun 2023

No        major    environmental deficiency               was observed.

N/A

13 Jun 2023

No        major    environmental deficiency               was observed.

N/A

20 Jun 2023

The Contractors are reminded to remove the chemical containers along the haul road of the open channel either proper storage or disposed to avoid possible leakage or contamination.

The chemical along the haul road was removed.

27 Jun 2023

Chemical containers found near the Chemical Building shall be stored on a drip tray to prevent leakage.

The      chemical             was removed.

July 2023

4 Jul 2023

No        major    environmental deficiency               was observed.

N/A

11 Jul 2023

No        major    environmental deficiency               was observed.

N/A

18 Jul 2023

The Chemical containers found near the R.O. Building shall be stored on a drip tray or proper storage.

Chemical container near the R.O. Building was removed.

25 Jul 2023

The chemical containers found near the R.O. Building shall store on a drip tray or provide proper storage to prevent leakage.

the       R.O. removed.

Chemical container near

Building

was

August 2023

1 Aug 2023

No        major observed.

environmental

deficiency

was

N/A

8 Aug 2023

No        major observed.

environmental

deficiency

was

N/A

15 Aug 2023

No        major observed.

environmental

deficiency

was

N/A

22 Aug 2023

No        major observed.

environmental

deficiency

was

N/A

29 Aug 2023

No        major observed.

environmental

deficiency

was

N/A

September 2023

5 Sept 2023

No        major observed.

environmental

deficiency

was

N/A

12 Sept 2023

No        major    environmental deficiency               was observed.

N/A

19 Sept 2023

No        major    environmental deficiency               was observed.

N/A

26 Sept 2023

Chemical container found near the OSCG shall be properly storage.

Chemical was removed.

October 2023

3 Oct 2023

No        major observed.

environmental     deficiency     was

N/A

10 Oct 2023

No        major observed.

environmental     deficiency     was

N/A

17 Oct 2023

No        major observed.

environmental     deficiency     was

N/A

27 Oct 2023

No        major observed.

environmental     deficiency     was

N/A

31 Oct 2023

Chemical containers found near the OSCG shall be store on a drip tray to prevent leakage.

   Chemical       removed

proper storage area

to

November 2023

7 Nov 2023

No        major observed.

environmental

deficiency

was

N/A

14 Nov 2023

No        major observed.

environmental

deficiency

was

N/A

21 Nov 2023

No        major observed.

environmental

deficiency

was

N/A

27 Nov 2023

No        major observed.

environmental

deficiency

was

N/A

December 2023

5 Dec 2023

No        major observed.

environmental

deficiency

was

N/A

12 Dec 2023

No        major observed.

environmental

deficiency

was

N/A

19 Dec 2023

No        major observed.

environmental

deficiency

was

N/A

27 Dec 2023

No        major observed.

environmental

deficiency

was

N/A

January 2024

2 Jan 2024

No        major observed.

environmental

deficiency

was

N/A

9 Jan 2024

No        major observed.

environmental

deficiency

was

N/A

16 Jan 2024

A chemical container found near RO Building without a drip tray, the contractors are reminded to provide a drip tray or proper storage for the chemical containers.

The      chemical was removed.

container

25 Jan 2024

No        major observed.

environmental

deficiency

was

N/A

29 Jan 2024

No        major observed.

environmental

deficiency

was

N/A

February 2024

7 Feb 2024

No        major observed.

environmental

deficiency

was

N/A

16 Feb 2024

No        major observed.

environmental

deficiency

was

N/A

20 Feb 2024

No        major observed.

environmental

deficiency

was

N/A

28 Feb 2024

No        major observed.

environmental

deficiency

was

N/A

March 2024

5 Mar 2024

No        major observed.

environmental

deficiency

was

N/A

12 Mar 2024

No        major observed.

environmental

deficiency

was

N/A

19 Mar 2024

No        major observed.

environmental

deficiency

was

N/A

25 Mar 2024

No        major observed.

environmental

deficiency

was

N/A

April 2024

2 Apr 2024

No        major observed.

environmental

deficiency

was

N/A

9 Apr 2024

No        major observed.

environmental

deficiency

was

N/A

16 Apr 2024

No        major observed.

environmental

deficiency

was

N/A

23 Apr 2024

No        major observed.

environmental

deficiency

was

N/A

29 Apr 2024

No        major observed.

environmental

deficiency

was

N/A

May 2024

7 May 2024

The contractor is reminded to maintain the landscape works after the adverse weather near RO building.

The greening works is maintained regularly.

14 May 2024

The contractor is reminded to maintain the landscape works (ie: vertical greening).

The greening works is maintained regularly.

21 May 2024

No        major observed.

environmental     deficiency     was

N/A

28 May 2024

No        major observed.

environmental     deficiency     was

N/A

June 2024

4 Jun 2024

No        major observed.

environmental     deficiency     was

N/A

11 Jun 2024

No        major observed.

environmental     deficiency     was

N/A

18 Jun 2024

Water spra breaking.

y should be provided during

Water spray was provided.

24 Jun 2024

No        major observed.

environmental

deficiency

was

N/A

July 2024

2 Jul 2024

No        major observed.

environmental

deficiency

was

N/A

9 Jul 2024

No        major observed.

environmental

deficiency

was

N/A

16 Jul 2024

No        major observed.

environmental

deficiency

was

N/A

23 Jul 2024

No        major observed.

environmental

deficiency

was

N/A

29 Jul 2024

No        major observed.

environmental

deficiency

was

N/A

August 2024

6 Aug 2024

No        major observed.

environmental

deficiency

was

N/A

13 Aug 2024

No        major observed.

environmental

deficiency

was

N/A

20 Aug 2024

No        major observed.

environmental

deficiency

was

N/A

26 Aug 2024

No        major observed.

environmental

deficiency

was

N/A

September 2024

3 Sep 2024

No        major observed.

environmental

deficiency

was

N/A

10 Sep 2024

No        major observed.

environmental

deficiency

was

N/A

17 Sep 2024

No        major    environmental deficiency               was observed.

N/A

24 Sep 2024

The chemical container should be stored properly.

The      chemical was removed.

container

October 2024

3 Oct 2024

No        major observed.

environmental

deficiency

was

N/A

8 Oct2024

No        major observed.

environmental

deficiency

was

N/A

15 Oct 2024

No        major observed.

environmental

deficiency

was

N/A

22 Oct2024

No        major observed.

environmental

deficiency

was

N/A

28 Oct2024

No        major observed.

environmental

deficiency

was

N/A

November 2024

5 Nov2024

No        major observed.

environmental

deficiency

was

N/A

14 Nov 2024

No        major observed.

environmental

deficiency

was

N/A

18 Nov2024

No        major observed.

environmental

deficiency

was

N/A

26 Nov 2024

No        major observed.

environmental

deficiency

was

N/A

December 2024

3 Dec 2024

No        major observed.

environmental

deficiency

was

N/A

10 Dec 2024

No        major observed.

environmental

deficiency

was

N/A

18 Dec 2024

No        major observed.

environmental

deficiency

was

N/A

23 Dec 2024

No        major observed.

environmental

deficiency

was

N/A

31 Dec 2024

No        major observed.

environmental

deficiency

was

N/A

January 2025

7 Jan 2025

No        major observed.

environmental

deficiency

was

N/A

14 Jan 2025

No        major observed.

environmental

deficiency

was

N/A

21 Jan 2025

No        major observed.

environmental

deficiency

was

N/A

27 Jan 2025

No        major observed.

environmental

deficiency

was

N/A

February 2025

5 Feb 2025

No        major observed.

environmental

deficiency

was

N/A

11 Feb 2025

No        major observed.

environmental

deficiency

was

N/A

18 Feb 2025

No        major observed.

environmental

deficiency

was

N/A

25 Feb 2025

No        major observed.

environmental

deficiency

was

N/A

March 2025

5 Mar 2025

No        major observed.

environmental

deficiency

was

N/A

11 Mar 2025

No        major observed.

environmental

deficiency

was

N/A

18 Mar 2025

No        major observed.

environmental

deficiency

was

N/A

25 Mar 2025

No        major observed.

environmental

deficiency

was

N/A

31 Mar 2025

No        major observed.

environmental

deficiency

was

N/A

April 2025

9 Apr 2025

No        major observed.

environmental

deficiency

was

N/A

17 Apr 2025

No        major observed.

environmental

deficiency

was

N/A

24 Apr 2025

No        major observed.

environmental

deficiency

was

N/A

29 Apr 2025

No        major observed.

environmental

deficiency

was

N/A

May 2025

7 May 2025

No        major observed.

environmental

deficiency

was

N/A

13 May 2025

No        major observed.

environmental

deficiency

was

N/A

20 May 2025

No        major observed.

environmental

deficiency

was

N/A

30 May 2025

No        major observed.

environmental

deficiency

was

N/A

June 2025

3 Jun 2025

No        major observed.

environmental

deficiency

was

N/A

10 Jun 2025

No        major observed.

environmental

deficiency

was

N/A

17 Jun 2025

No        major observed.

environmental

deficiency

was

N/A

23 Jun 2025

No        major observed.

environmental

deficiency

was

N/A

July 2025

3 July 2025

No        major observed.

environmental

deficiency

was

N/A

10 July 2025

No        major observed.

environmental

deficiency

was

N/A

17 July 2025

No        major observed.

environmental

deficiency

was

N/A

24 July 2025

No        major observed.

environmental

deficiency

was

N/A

31 July 2025

No        major observed.

environmental

deficiency

was

N/A

EM&A Review Report

Appendix F

Waste Flow Table

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

Contract No. 13/WSD/17

Environmental Management Plan for Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant

Appendix F - Monthly Summary Waste Flow Table

Name of Department: WSD                                                                                           Contract No.: 13/WSD/17

Monthly Summary Waste Flow Table for 2020 (year)

Month

Actual Quantities of Inert C&D Materials Generated Monthly

Actual Quantities of C&D Wastes Generated Monthly

Total Quantity Generated

Hard Rock and

Large Broken Concrete

Reused in the Contract

Reused in other Projects

Disposed as Public Fill

Imported Fill

Metals

Paper/ cardboard packaging

Plastics (see Note 3)

Chemical Waste

Others, e.g. general refuse

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000 kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

Jan

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

Feb

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

Mar

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.420

Apr

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

2.400

May

0.000

0.000

0.000

0.000

0.000

0.000

5.900

0.000

0.000

0.000

12.570

Jun

1081.950

0.000

0.000

0.000

1081.950

0.000

0.000

0.000

0.000

0.000

34.160

Sub-total

1081.950

0.000

0.000

0.000

1081.950

0.000

5.900

0.000

0.000

0.000

49.550

Jul

724.360

0.000

0.000

0.000

724.360

0.000

0.000

0.000

0.000

0.000

33.760

Aug

161.080

0.000

0.000

0.000

161.080

0.000

0.000

0.000

0.000

0.000

42.070

Sep

0.000

0.000

0.000

0.000

0.000

0.000

22.766

0.000

0.010

0.000

83.150

Oct

0.000

0.000

0.000

0.000

0.000

0.000

12.170

0.040

0.020

0.000

39.210

Nov

0.000

0.000

0.000

0.000

0.000

0.000

5.351

0.030

0.014

0.000

66.420

Dec

13791.930

0.000

0.000

13791.930

0.000

0.000

9.912

0.030

0.018

0.000

63.920

Total

15759.320

0.000

0.000

13791.930

1967.390

0.000

56.099

0.100

0.062

0.000

378.080

Notes:                                        (1) The performance targets are given in Section 1.69 of Specification B

(2) The waste flow table shall also include C&D materials that are specified in the Contract to be imported for use at the Site. (3) Plastics refer to plastic bottles/containers, plastic sheets/ foam from packaging material

第 1 頁,共 1 頁

Contract No. 13/WSD/17

Environmental Management Plan for Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant

Appendix F - Monthly Summary Waste Flow Table

Name of Department: WSD                                                                        Contract No.: 13/WSD/17

Monthly Summary Waste Flow Table for 2021 (year)

Month

Actual Quantities of Inert C&D Materials Generated Monthly

Actual Quantities of C&D Wastes Generated Monthly

Total Quantity

Generated

Hard Rock and

Large Broken

Concrete

Reused in the

Contract

Reused in other

Projects

Disposed as

Public Fill

Imported Fill

Metals

Paper/ cardboard packaging

Plastics (see Note 3)

Chemical Waste

Others, e.g. general refuse

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000 kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

Jan

11823.060

0.000

0.000

11816.130

6.930

0.000

0.000

0.000

0.000

0.000

73.960

Feb

434.090

0.000

0.000

434.090

0.000

0.000

14.767

0.123

0.008

0.000

45.080

Mar

91.710

0.000

0.000

0.000

91.710

0.000

0.002

0.155

0.010

0.000

122.940

Apr

0.000

0.000

0.000

0.000

0.000

0.000

28.931

0.057

0.002

0.000

89.450

May

1557.500

0.000

0.000

0.000

1557.500

0.000

0.005

0.108

0.009

0.000

70.750

Jun

4278.380

0.000

0.000

0.000

4278.380

0.000

0.001

0.088

0.005

0.000

91.540

Sub-total

18184.740

0.000

0.000

12250.220

5934.520

0.000

43.706

0.530

0.034

0.000

493.720

Jul

365.150

0.000

0.000

0.000

365.150

0.000

0.003

0.120

0.005

0.000

65.770

Aug

42.340

0.000

0.000

0.000

42.340

0.000

0.000

0.001

0.006

0.000

74.070

Sep

66.690

0.000

0.000

0.000

66.690

0.000

0.004

0.002

0.003

0.000

75.880

Oct

578.870

0.000

0.000

0.000

578.870

0.000

0.006

0.510

0.018

0.000

88.390

Nov

470.660

0.000

0.000

0.000

470.660

0.000

0.000

0.000

0.000

0.000

162.500

Dec

457.090

0.000

0.000

0.000

457.090

0.000

0.000

0.130

0.030

0.000

131.270

Total

20165.540

0.000

0.000

12250.220

7915.320

0.000

43.718

1.293

0.096

0.000

1091.600

Notes:                                            (1) The performance targets are given in Section 1.69 of Specification B

(2) The waste flow table shall also include C&D materials that are specified in the Contract to be imported for use at the Site. (3) Plastics refer to plastic bottles/containers, plastic sheets/ foam from packaging material * The data will be reviewed in next month.

第 1 頁,共 1 頁

Monthly Summary Waste Flow Table for 2022 (year)

Month

Actual Quantities of Inert C&D Materials Generated Monthly

Actual Quantities of C&D Wastes Generated Monthly

Total Quantity

Genertaed

Hard Rock and

Large Broken

Concrete

Reused in the

Contract

Reused in other Projects

Disposed as

Public Fill

Imported Fill

Metals

Paper/ carboard packaging

Plastics

Chemcial

Waste

Other, e.g. general refuse

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

Jan

233.850

0.000

0.000

0.000

233.850

0.000

0.000

0.069

0.005

0.000

109.020

Feb

175.850

0.000

0.000

0.000

175.850

0.000

0.000

0.000

0.000

0.296

293.110

Mar

68.790

0.000

0.000

0.000

68.790

0.000

0.000

0.000

0.000

0.000

54.140

Apr

29.050

0.000

0.000

0.000

29.050

0.000

0.001

0.165

0.004

0.000

113.780

May

6.300

0.000

0.000

0.000

6.300

0.000

0.000

0.000

0.000

0.000

139.130

Jun

80.960

0.000

0.000

0.000

80.960

0.000

0.000

0.124

0.004

0.000

271.000

Sub-total

594.800

0.000

0.000

0.000

594.800

0.000

0.001

0.357

0.013

0.296

980.180

Jul

2794.730

0.000

0.000

0.000

2794.730

0.000

0.000

0.000

0.000

0.000

252.740

Aug

10429.730

0.000

0.000

0.000

10429.730

0.000

0.000

0.000

0.090

0.000

240.470

Sep

13842.840

0.000

0.000

0.000

13842.840

0.000

0.000

0.170

0.090

0.000

196.910

Oct

20945.100

0.000

0.000

0.000

20945.100

0.000

0.000

0.000

0.000

0.000

230.900

Nov

7273.940

0.000

0.000

0.000

7273.940

0.000

0.020

0.230

0.020

0.000

195.360

Dec

16080.660

0.000

0.000

0.000

16080.660

0.000

0.000

0.000

0.000

0.000

211.410

Total

71961.800

0.000

0.000

0.000

71961.800

0.000

0.021

0.758

0.213

0.296

2307.970

           Notes:                               (1) Plastics refer to plastic bottles/ containers, plastic sheets / foam from packaging material

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

Contract No. 13/WSD/17

Environmental Management Plan for Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant

Appendix F - Monthly Summary Waste Flow Table

Name of Department: WSD                                                                                           Contract No.: 13/WSD/17

Monthly Summary Waste Flow Table for 2023 (year)

w

Month

Actual Quantities of Inert C&D Materials Generated Monthly

Actual Quantities of C&D Wastes Generated Monthly

Total Quantity Generated

Hard Rock and

Large Broken Concrete

Reused in the Contract

Reused in other Projects

Disposed as Public Fill

Imported Fill

Metals

Paper/ cardboard packaging

Plastics (see Note 3)

Chemical Waste

Others, e.g. general refuse

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000 kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

Jan

3383.820

0.000

0.000

0.000

3383.820

0.000

0.000

0.000

0.000

0.000

143.690

Feb

0.000

0.000

0.000

0.000

0.000

0.000

0.002

0.138

0.010

0.000

115.880

Mar

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

205.410

Apr

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

255.720

May

2088.990

0.000

0.000

0.000

2088.990

0.000

0.000

0.000

0.000

0.000

202.270

Jun

1955.240

0.000

0.000

0.000

1955.240

0.000

0.000

0.000

0.0017

0.000

189.680

Sub-total

7428.050

0.000

0.000

0.000

7428.050

0.000

0.002

0.138

0.012

0.000

1112.650

Jul

121.060

0.000

0.000

0.000

121.060

0.000

0.008

0.150

0.042

0.000

186.110

Aug

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

168.220

Sep

762.550

0.000

0.000

0.000

762.550

0.000

0.000

148.944

0.000

0.000

172.440

Oct

568.600

0.000

0.000

0.000

568.600

0.000

0.000

18.574

0.010

0.000

185.010

Nov

15.430

0.000

0.000

0.000

15.430

0.000

0.000

0.000

0.000

0.000

116.960

Dec

215.220

0.000

0.000

0.000

215.220

0.000

0.000

0.000

0.000

0.000

79.680

Total

9110.910

0.000

0.000

0.000

9110.910

0.000

0.010

167.806

0.064

0.000

2021.070

Notes:                                        (1) The performance targets are given in Section 1.69 of Specification B

(2) The waste flow table shall also include C&D materials that are specified in the Contract to be imported for use at the Site. (3) Plastics refer to plastic bottles/containers, plastic sheets/ foam from packaging material

第 1 頁,共 1 頁

Contract No. 13/WSD/17

Environmental Management Plan for Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant

Appendix F - Monthly Summary Waste Flow Table

Name of Department: WSD                                                                                           Contract No.:    13/WSD/17

Monthly Summary Waste Flow Table for 2024 (year)

w

Month

Actual Quantities of Inert C&D Materials Generated Monthly

Actual Quantities of C&D Wastes Generated Monthly

Total Quantity Generated

Hard Rock and

Large Broken Concrete

Reused in the Contract

Reused in other Projects

Disposed as Public Fill

Imported Fill

Metals

Paper/ cardboard packaging

Plastics (see Note 3)

Chemical Waste

Others, e.g. general refuse

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000 kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

Jan

4978.345

0.000

0.000

4667.745

310.600

0.000

0.000

0.000

0.000

0.000

77.800

Feb

22561.796

0.000

0.000

21883.006

678.790

0.000

0.000

0.000

0.000

0.000

53.480

Mar

81.140

0.000

0.000

0.000

81.140

0.000

0.000

0.000

0.000

0.000

52.260

Apr

57.130

0.000

0.000

0.000

57.130

0.000

0.000

0.000

0.000

0.000

47.390

May

91.370

0.000

0.000

0.000

91.370

0.000

0.000

0.000

0.000

0.000

77.260

Jun

61.590

0.000

0.000

0.000

61.590

0.000

0.000

0.000

0.002

0.000

59.320

Sub-total

27831.371

0.000

0.000

26550.751

1280.620

0.000

0.000

0.000

0.002

0.000

367.510

Jul

60378.440

0.000

0.000

0.000

60378.440

0.000

0.000

0.000

0.000

0.000

66.800

Aug

163.330

0.000

0.000

0.000

163.330

0.000

0.000

0.000

0.000

2.460

42.260

Sep

834.890

0.000

0.000

0.000

834.890

0.000

0.000

0.000

0.000

0.805

27.020

Oct

78.140

0.000

0.000

0.000

78.140

0.000

0.000

0.000

0.000

0.000

71.810

Nov

237.790

0.000

0.000

0.000

237.790

0.000

0.000

0.000

0.000

0.000

62.300

Dec

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

1.000

31.470

Total

89523.961

0.000

0.000

26550.751

62973.210

0.000

0.000

0.000

0.002

4.265

669.170

Notes:                                          (1) The performance targets are given in Section 1.69 of Specification B

(2) The waste flow table shall also include C&D materials that are specified in the Contract to be imported for use at the Site. (3) Plastics refer to plastic bottles/containers, plastic sheets/ foam from packaging material

第 1 頁,共 1 頁

Name of Department: WSD                                                             Contract No.: 13/WSD/17

Monthly Summary Waste Flow Table for 2025 (year)

Month

Actual Quantities of Inert C&D Materials Generated Monthly

Actual Quantities of C&D Wastes Generated Monthly

Total Quantity

Generated

Hard Rock and

Large Broken

Concrete

Reused in the

Contract

Reused in other

Projects

Disposed as

Public Fill

Imported Fill

Metals

Paper/ cardboard packaging

Plastics (see Note 3)

Chemical

Waste

Others, e.g. general refuse

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000 kg)

(in '000kg)

(in '000kg)

(in '000kg)

(in '000kg)

Jan

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

38.740

Feb

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

18.330

Mar

30.520

0.000

0.000

0.000

30.520

0.000

0.000

0.000

0.000

0.000

29.050

Apr

21.290

0.000

0.000

0.000

21.290

0.000

0.000

0.000

0.000

0.000

73.450

May

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

35.720

Jun

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

28.950

Sub-total

51.810

0.000

0.000

0.000

51.810

0.000

0.000

0.000

0.000

0.000

224.240

Jul

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

0.000

1.434

13.330

Aug

Sep

Oct

Nov

Dec

Total

51.810

0.000

0.000

0.000

51.810

0.000

0.000

0.000

0.000

1.434

237.570

Notes:                              (1) The performance targets are given in Section 1.69 of Specification B

(2)  The waste flow table shall also include C&D materials that are specified in the Contract to be imported for use at the Site.

(3)  Plastics refer to plastic bottles/containers, plastic sheets/ foam from packaging material

Appendix G

Summary of Exceedances

Table G1              Cumulative Statistics on Exceedances

Environmental Monitoring

Parameter

No. of non-Project related exceedance in the reporting period

Total No. of non-

Project related exceedance in the reporting period

No. of Project related exceedance in the reporting period

Total No. of Project related exceedance in the reporting period

Total No. recorded since the project commencement

AL

LL

AL

LL

Noise

Leq (30min)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

Water Quality

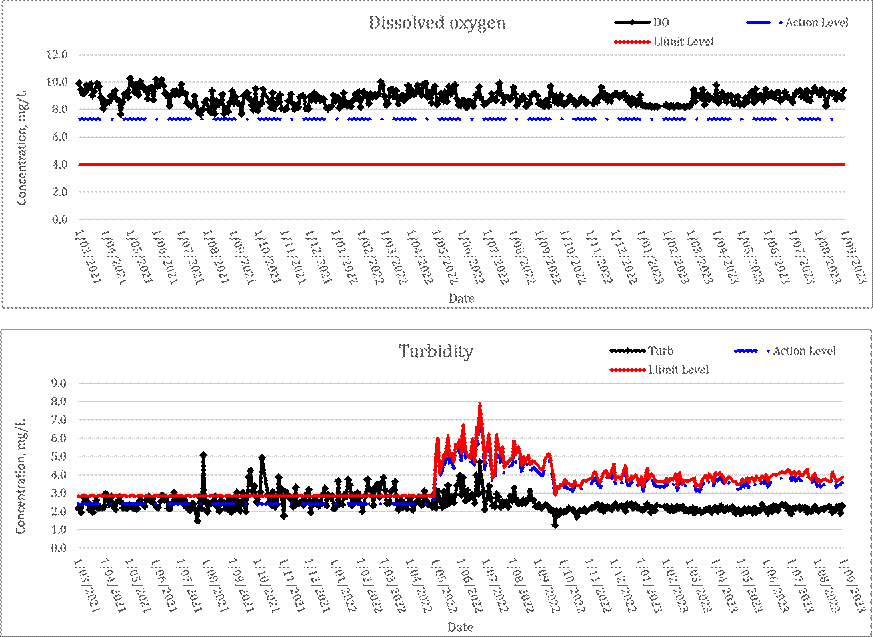

DO

0

0

0

0

0

0

0

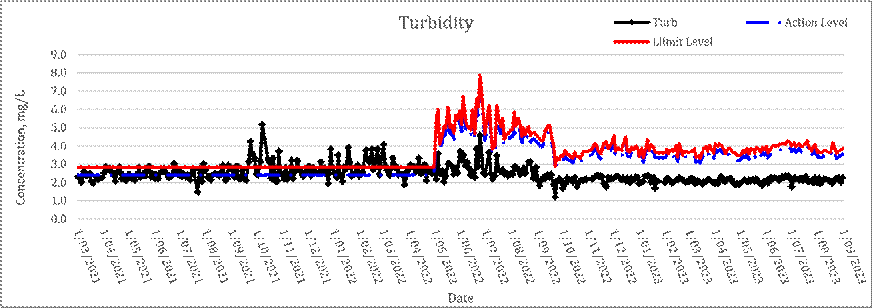

Turbidity

0

0

0

0

0

0

0

SS

1725

1560

3285

0

0

0

3285

pH

0

0

0

0

0

0

0

Landfill Gas

O2

0

0

0

0

0

0

0

CH4

0

0

0

0

0

0

0

CO2

0

0

0

0

0

0

0

Coral

Mortality

0

0

0

0

0

0

0

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

Appendix H

Complaint Log

Contract No. 13/WSD/17

Design, Build and Operate First Stage of

Tseung Kwan O Desalination Plant Final EM&A Review Report

*Remark: The complaint received on 22 July 2022 were included both air and water parameters, the total number of complaints is counted as one.

Statistical Summary of Environmental Summons and Prosecutions

The copyright of this document is owned by Acuity Sustainability Consulting Limited. It may not be reproduced except with prior written approval from the Company.

Acuity Sustainability Consulting Limited

Appendix I

Event / Action Plan for Noise,

Water Quality and Coral

Monitoring Exceedance

Event and Action Plan for Construction Noise Monitoring

Event and Action Plan for Water Quality Monitoring

Event and Action Plan for Ecology during Construction Phase

                          Event and Action Plan for Coral Monitoring
