CONTENTS
6.
SUMMARY OF
MONITORING EXCEEDANCE, COMPLAINTS, NOTIFICATION OF SUMMONS AND
PROSECUTIONS................................................................................................................................................................ 20

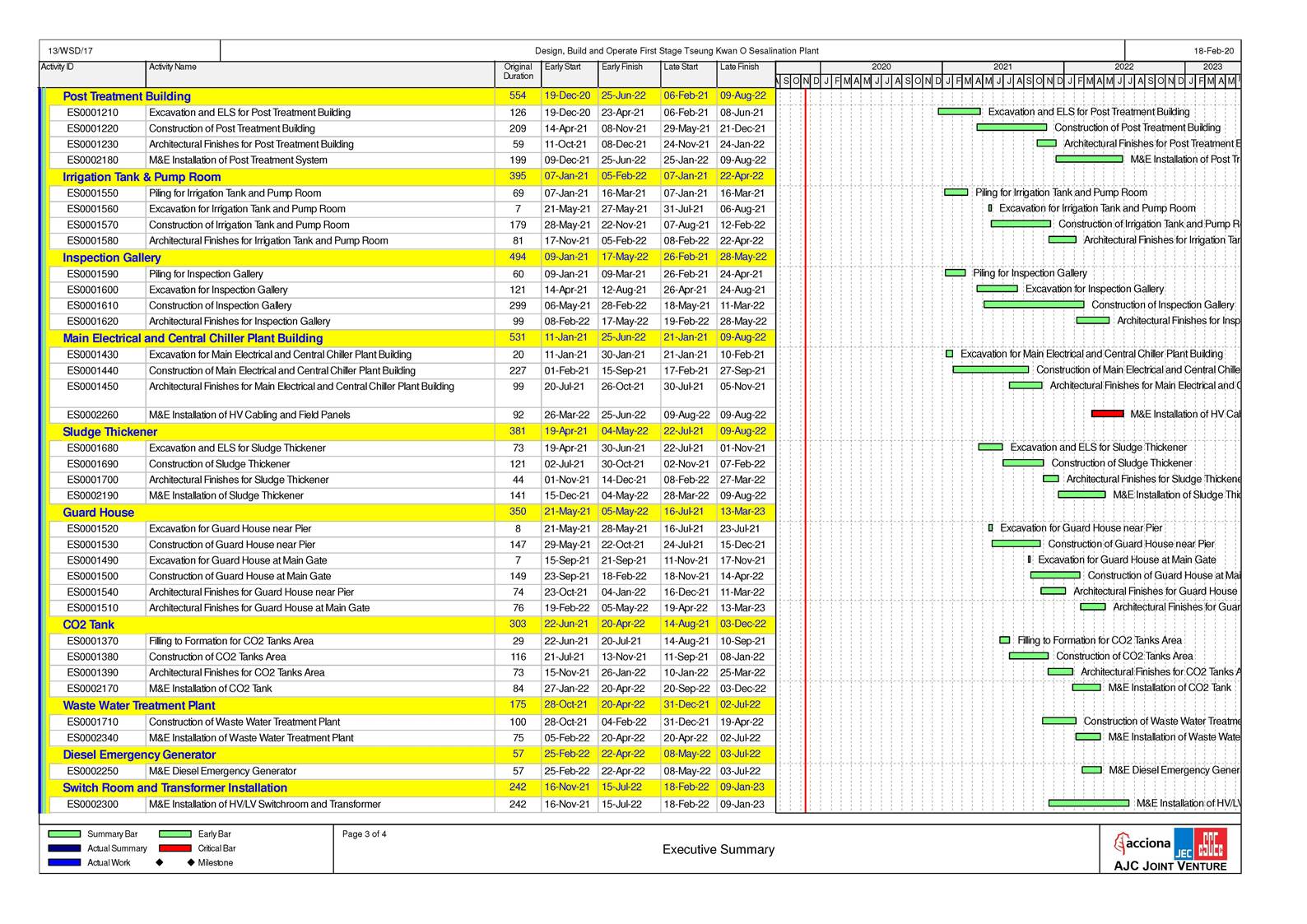

Appendix A Master Programme
Appendix B Overview of Desalination Plant in Tseung Kwan O
Appendix C              Summary of Implementation Status of
Environmental Mitigation
Appendix D Impact Monitoring Schedule of the Reporting Month (Blank)
Appendix E Event/Action Plan for Noise Exceedance
Appendix F Noise Monitoring Equipment Calibration Certificate (Blank)
Appendix G Event/Action Plan for Water Quality Exceedance
Appendix H Waste Flow Table
Appendix I Site Inspection Proforma
Appendix J Complaint Log
Appendix K Impact Monitoring Schedule of Next Reporting Month (Blank)
¡¥
INTRODUCTION
A1. The Project, Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (TKODP), is a Designated Project under the Environmental Impact Assessment Ordinance (Cap. 499) (EIAO) and is currently governed by a Further Environmental Permit (EP No. FEP - 01/503/2015/A) for the construction and operation of the Project.
A2. In accordance with the Updated Environmental Monitoring and Audit (EM&A) Manual for the Project, EM&A works for marine water quality, noise, waste management and ecology should be carried out by Environmental Team (ET), Acuity Sustainability Consulting Limited (ASCL), during the construction phase of the Project.
A3. This is the 6th Monthly EM&A Report, prepared by ASCL, for the Project summarizing the monitoring results and audit findings of the EM&A programme at and around Tseung Kwan O Area 137 (TKO 137) during the reporting period from 1 August 2020 to 31 August 2020.
A4. The EM&A programme for this contract has covered environmental monitoring on construction noise level at selected NSRs and Contractor¡¦s environmental performance auditing in the aspects of construction dust, construction noise, water quality, waste management, Landscape and Visual and Ecology.
SUMMARY OF MAIN WORKS UNDERTAKEN & KEY MITIGATION MEASURES IMPLEMENTED
A5. Key activities carried out in this reporting period for the Project included the following:
- Land Survey;
- Ground Levelling;
- Access Road Construction;
- Site office¡¦s roof waterproofing and internal E&M installation;
- Construction of 132kV substation;
- Construction of Temp 11kV substation and drawpits / ducting;
- Pre-boring and installation of sheetpiles for combine shafet;
- Excavation and formation for ActiDAFF and RO;
- Erection of hoarding around site office;
- Installation of temporary watermain;
- Excavation and installation of temporary soil nail for Product Water Tank;
- Installation of tower cranes.
A6. The major environmental impacts brought by the above construction works include:
- Construction dust and noise generation from the ground investigation works, access road construction and site office formation;
- Waste generation from the construction activities
A7. The key environmental mitigation measures implemented for the Project in this reporting period associated with the above construction works include:
- Dust suppression by regular wetting and water spraying for construction works
- Reduction of noise from equipment and machinery on-site
- Sorting and storage of general refuse and construction waste
SUMMARY OF EXCEEDANCE & INVESTIGATION & FOLLOW-UP
A8. No noise monitoring was conducted during the reporting period since there are no project- related construction activities undertaken within a radius of 300m from the monitoring locations. No project-related exceedance of the Action Level was recorded during the reporting period.
A9. No water quality monitoring was conducted in the reporting month since the commencement of marine construction and dredging activities for the Project are scheduled in November 2020 the earliest. No project-related exceedance of the Action Level was recorded during the reporting period.

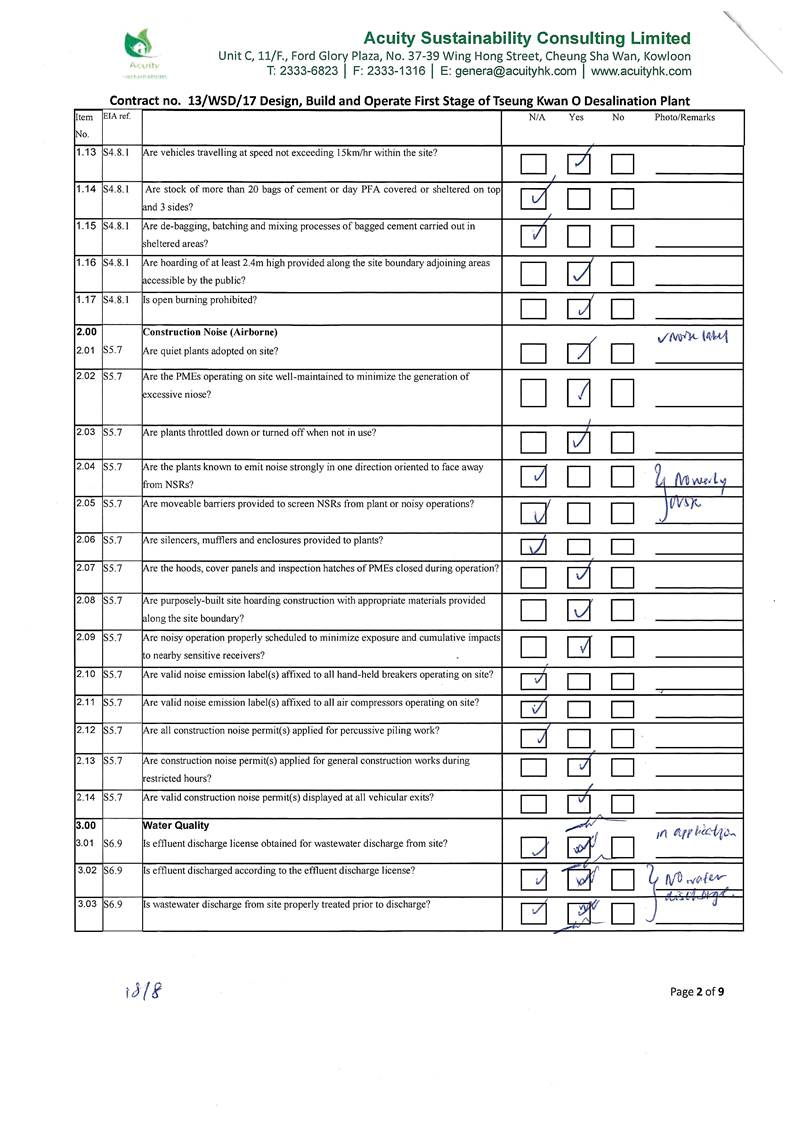

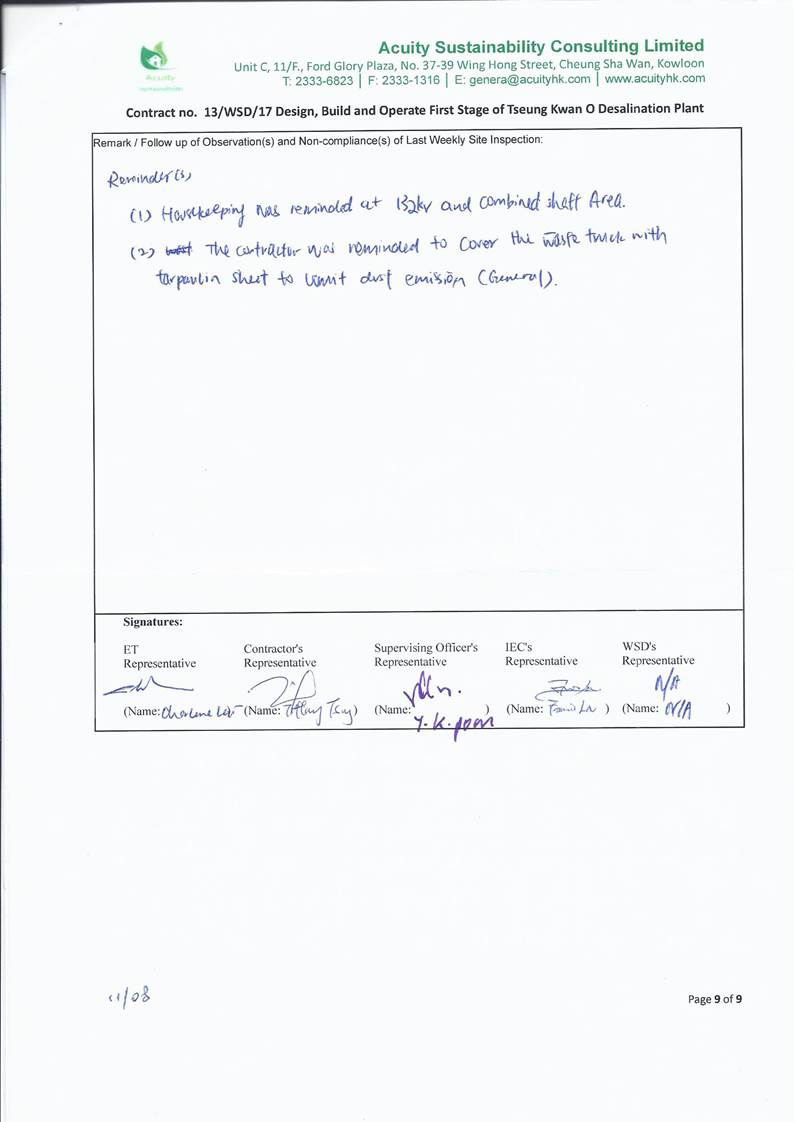

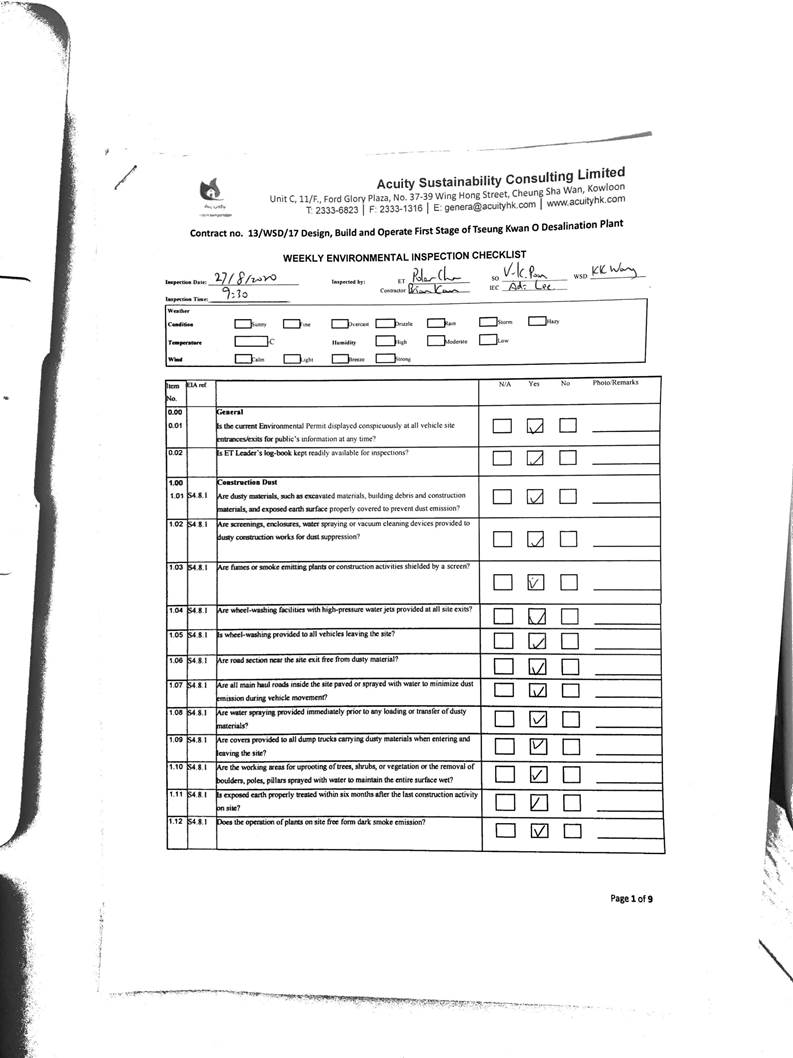

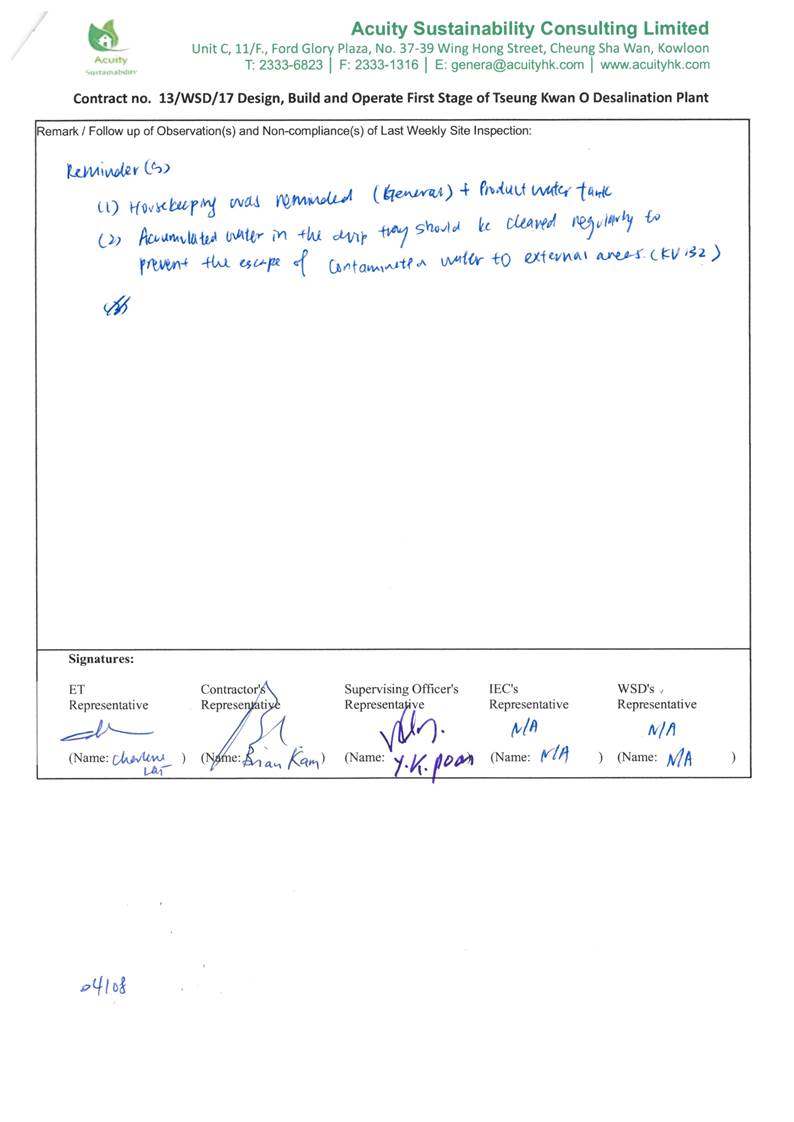

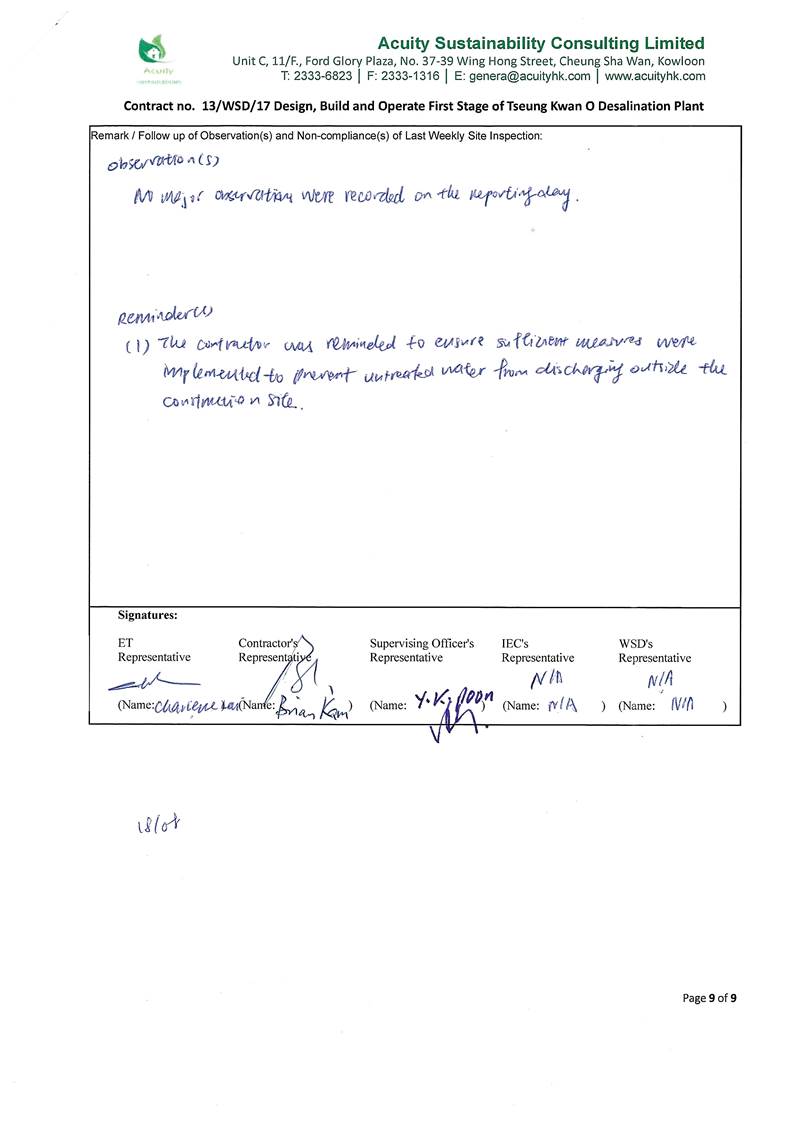

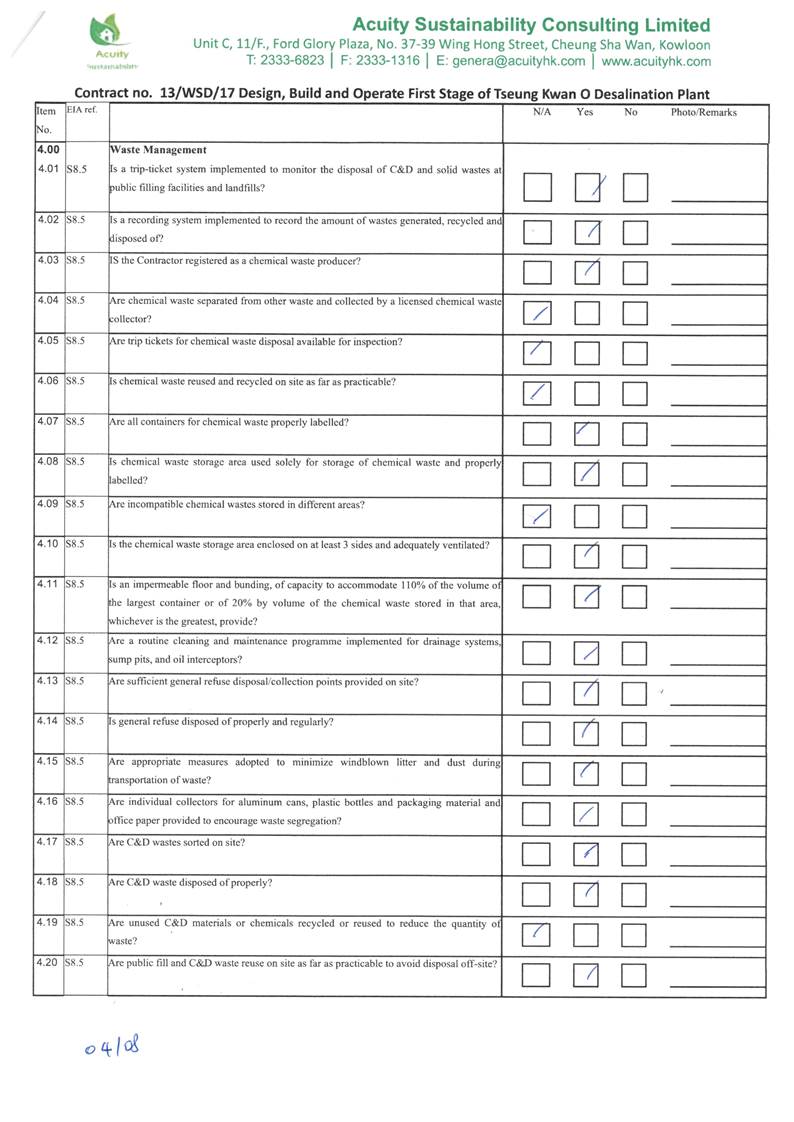

A10. Weekly site inspections of the construction work by ET were carried out on 4, 11, 18 & 27 August 2020 to audit the mitigation measures implementation status. Bi-weekly joint site inspection was carried out on 11 & 27 August 2020 by ET and IEC. Observations were recorded in the site inspection checklists and provided to the contractors together with the appropriate follow-up actions where necessary.
COMPLAINT HANDLING AND PROSECUTION
A11. No project-related environmental complaint was received during the reporting period. A12.Neither notifications of summons nor prosecution was received for the Project.
REPORTING CHANGE
A13. There was no change to be reported that may affect the on-going EM&A programme.
SUMMARY OF UPCOMING KEY ISSUES AND KEY MITIGATION MEASURES
A14. Key activities anticipated in the next reporting period for the Project will include the following:
- Land Survey;
- Access Road Construction;
- Construction of 132kV substation (G/F to 1st floor)
- Pre-boring and installation of sheetpiles for combine shaft;
- Construction of ActiDAFF footing;
- Construction for RO foundation;
- Excavation for Product Water Storage Tank footing;
- Installation of temporary soil nail at Product Water Storage Tank;
- Excavation and ELS installation for combine shaft.
A15. The major environmental impacts brought by the above construction works will include:
- Construction dust and noise generation from GI works, access road construction and site office formation work;
- Waste generation from construction activities
A16. The key environmental mitigation measures for the Project in the coming reporting period associated with the above construction works will include:
- Dust suppression by regular wetting and water spraying for construction works
- Reduction of noise from equipment and machinery on-site
- Sorting and storage of general refuse and construction waste
1.1.
BACKGROUND
The Jardine Engineering Corporation, Limited, China State Construction Engineering (Hong Kong) Limited and Acciona Agua, S.A. Trading As AJC Joint Venture (AJCJV) is contracted to carry out the Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (DPTKO) under Contract No. 13/WSD/17 (the Project).
Acuity Sustainability Consulting Limited (ASCL) is commissioned by AJCJV to undertake the Environmental Team (ET) services as required and/or implied, both explicitly and implicitly, in the Environmental Permit (EP), Environmental Impact Assessment Report (EIA Report) (Register No. AEIAR-192/2015) and Environmental Monitoring and Audit Manual (EM&A Manual) for the Project; and to carry out the Environmental Monitoring and Audit (EM&A) programme in fulfillment of the EIA Report¡¦s EM&A requirements and Contract No. 13/WSD/17 Specification requirements.
Pursuant to the Environmental Impact Assessment Ordinance (EIAO), the Director of Environmental Protection granted the Environmental Permit (No. EP-01/503/2015) and Variation of Environmental Permit (No. EP-01/503/2015/A) to Water Supplies Department (WSD); and granted the Further Environmental Permit (No. FEP-01/503/2015/A) to AJCJV for the Project.
1.2.
THE REPORTING SCOPE
This is the 6th Monthly EM&A Report for the Project which summarizes the key findings of the EM&A programme during the reporting period from 1 August to 31 August 2020.
1.3.
PROJECT ORGANIZATION

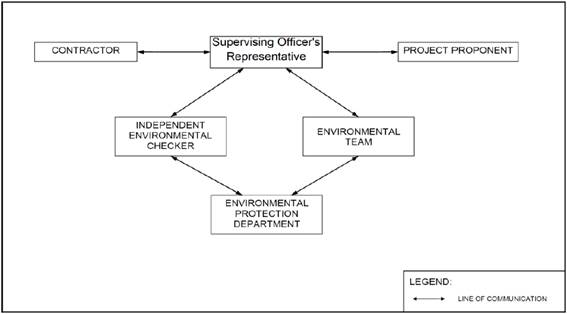

The Project Organization structure for Construction Phase is presented in Figure 1.1.

Figure 1.1     Project
Organization Chart
Contact details of the key personnel are presented in Table 1.1 below:
Table 1.1      Contact
Details of Key Personnel
| Party | Position | Name | Telephone
  no. |
| Project Proponent | SE/CM2 | Benny Lam | 2634-3573 |
| Supervising Officer (Black & Veatch) | Project Manager | Christina Ko | 2608-7302 |
| Chief Resident Engineer | Roger Wu | 6343-1002 | |
| The Jardine Engineering Corporation, Limited, China State Construction Engineering (Hong Kong) Limited and Acciona Agua, S.A. Trading | Project Manager | Stephen Yeung | 2807-4665 |
| Environmental Monitoring Manager | Brian Kam | 9456-9541 | |
| Acuity Sustainability Consulting Limited | Environmental Team Leader | Jacky Leung | 2698-6833 |
| ANewR Consulting Limited | Independent Environmental Checker (IEC) | Adi Lee | 2618-2831 |
1.4.
SUMMARY OF CONSTRUCTION WORKS
Details of the major construction activities undertaken in this reporting period are shown in below. The construction programme is presented in Appendix A.
Key activities carried out in this reporting period for the Project included the following:
- Land Survey;
- Ground Levelling;
- Access Road Construction;
- Site office¡¦s roof waterproofing and internal E&M installation;
- Construction of 132kV substation;
- Construction of Temp 11kV substation and drawpits / ducting;
- Pre-boring and installation of sheetpiles for combine shafet;
- Excavation and formation for ActiDAFF and RO;
- Erection of hoarding around site office;
- Installation of temporary watermain;
- Excavation and installation of temporary soil nail for Product Water Tank;
- Installation of tower cranes.
1.5.
SUMMARY OF ENVIRONMENTAL STATUS
A summary of the valid permits, licences, and /or notifications on environmental protection for this Project is presented in Table 1.2.
Table 1.2      Summary
of the Status of Valid Environmental Licence,
Notification, Permit and
Documentations
| Permit/
  Licenses/ Notification | Reference | Validity
  Period | Remarks |
| Environmental Permit | FEP
  - 01/503/2015/A | Throughout the Contract |  |
| Notification
  of Construction Works under the Air Pollution Control (Construction Dust)
  Regulation (Form NA) | Ref. No.: 451539 | 30/12/2019
  - 30/03/2023 |  |
| Wastewater Discharge Licence | WT00035775-2020 | 24/07/2020
  - 31/07/2025 |  |
| Chemical Waste Producer Registration | 5213-839-A2987-01 | Throughout the Contract |  |
| Construction Noise Permit (24 hours) | GW-RE0474-20 | 04/06/2020
  - 03/12/2020 |  |
| Billing Account for Disposal of Construction Waste | 7036276 | Throughout
  the Contract |  |
The status for all environmental aspects is presented in Table 1.3.
Table 1.3      Summary
of Status for Key Environmental Aspects under the Updated EM&A Manual
| Parameters | Status |
| Water
  Quality | |
| Baseline Monitoring under EM&A Manual | The baseline water quality monitoring was conducted between 12 May 2020 to 6 Jun 2020 |
| Impact Monitoring | The impact water quality monitoring has been scheduled after the commencement of marine construction works |
| Noise | |
| Baseline Monitoring | The baseline noise monitoring result has been reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4 |
| Impact Monitoring | On-going |

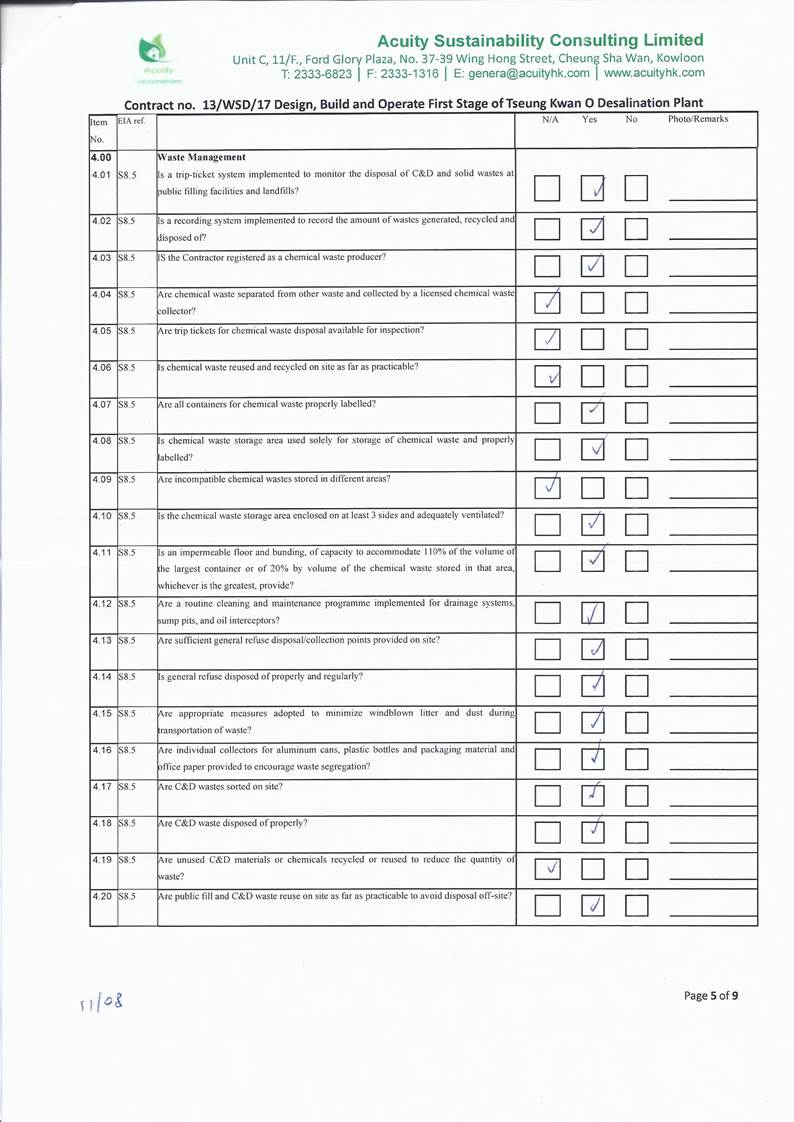

| Waste Management | |
| Mitigation Measures in Waste Monitoring Plan | On-going |

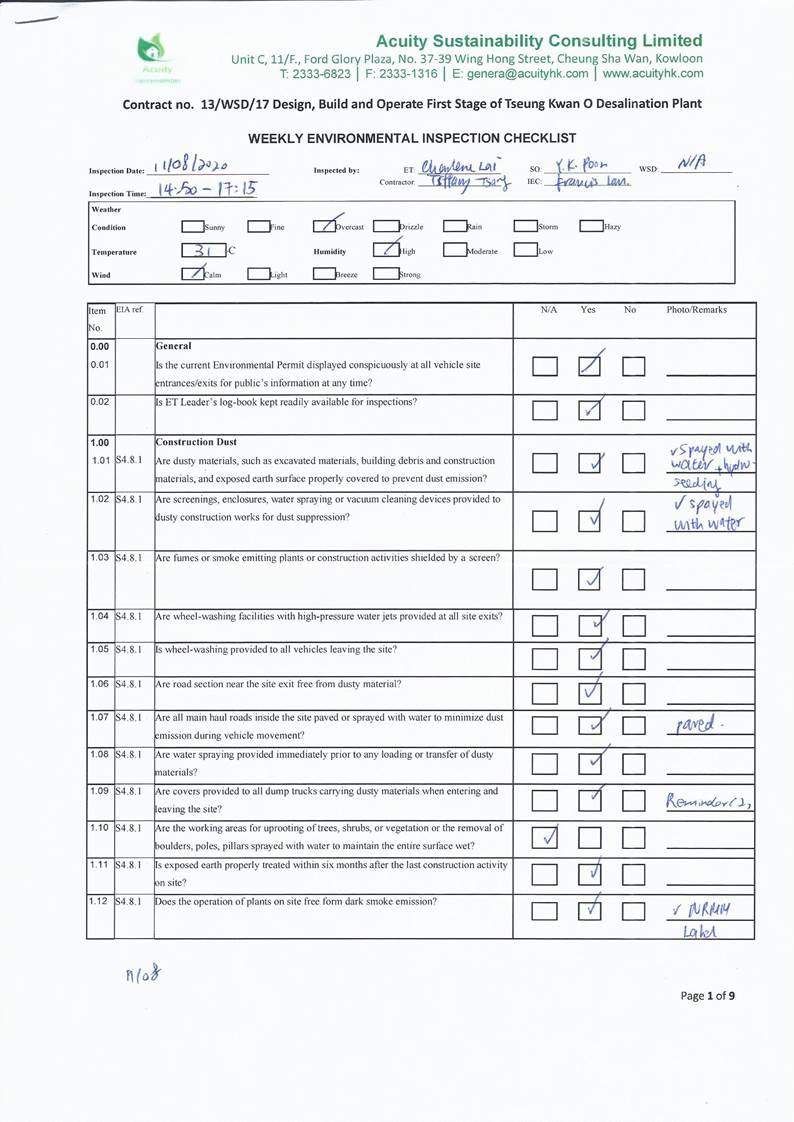

| Environmental Audit | |
| Site Inspection covering Measures of Air Quality, Noise Impact, Water Quality, Waste, Ecological Quality, Fisheries, Landscape and Visual | On-going |
The impact monitoring schedule for the reporting month to be shown at Appendix D is intentionally left blank since no impact monitoring was conducted in the reporting month.
Other than the EM&A work by ET, environmental briefings, trainings and regular environmental management meetings were conducted, in order to enhance environmental awareness and closely monitor the environmental performance of the contractors.
The EM&A programme has been implemented in accordance with the recommendations presented in the approved EIA Report and the EM&A Manual. A summary of implementation status of the environmental mitigation measures for the construction phase of the Project during the reporting period is provided in Appendix C.
2.1.
MONITORING REQUIREMENTS
To ensure no adverse noise impact, noise monitoring is recommended to be carried out within 300m radius from the nearby noise sensitive receivers (NSRs), during construction phase. The NSRs selected as monitoring station are (i) NSR4 - Creative Secondary School, (ii) NSR24 - PLK Laws Foundation College, and (iii) NSR31 - School of Continuing and Professional Studies - CUHK respectively.
In accordance with the EM&A Manual, baseline noise level at the noise monitoring stations were established as presented in the Baseline Monitoring Report. Impact noise monitoring will be conducted once per week in the form of 30-minutes measurements Leq, L10 and L90 levels recorded at each monitoring station between 0700 and 1900 hours on normal weekdays.
Referring to EM&A manual Section 4.1.2, the impact noise monitoring should be carried out at all the designated monitoring stations when there are project-related construction activities undertaken within a radius of 300m from the monitoring stations.
No impact monitoring for noise impact was conducted in the reporting month due to the overly distant monitoring station from the works location, where they were farther than 1 km from the closet monitoring station NSR4 to the works location.
Impact noise monitoring will be conducted weekly in the reporting period between 0700-1900 hours on normal weekdays. No construction works were carried out during 1900-0700 hours in all days or any time on Sundays or general holidays during the reporting period.
Construction noise level measured in terms of the A-weighted equivalent continuous sound pressure level (LAeq). Leq 30min was used as the monitoring parameter for the time period between 0700 and 1900 hours on normal weekdays. Table 2.1 summarizes the monitoring parameters, frequency and duration of the impact noise monitoring.
Table
2.1 Noise Monitoring Parameters, Time, Frequency and Duration
| Time | Duration | Interval | Parameters | ||||
| Daytime: 0700-1900 hrs | Day
  time: 0700-1900 hrs (during weekdays) | normal | Continuously in Leq 5min/Leq 30min (average of 6 consecutive
  Leq 5min) | Leq L10 | 30min
  30min | & L90 | 30min |
2.2.
MONITORING LOCATIONS
The monitoring locations should normally be made at a point 1m from the exterior of the NSRs building façade and be at a position 1.2m above the ground. A correction of +3dB(A) should be made to the free-field measurements.
According to the environmental findings detailed in the EIA report and Baseline Monitoring Report, the designated locations for the construction noise monitoring are listed in Table 2.2 below.
Table
2.2 Noise Sensitive Receivers
| NSR ID | Noise Sensitive Receivers | Monitoring Location | Position |
| NSR 4 | Creative
  Secondary School | Roof
  Floor | 1
  m from facade |
| NSR 24 | PLK

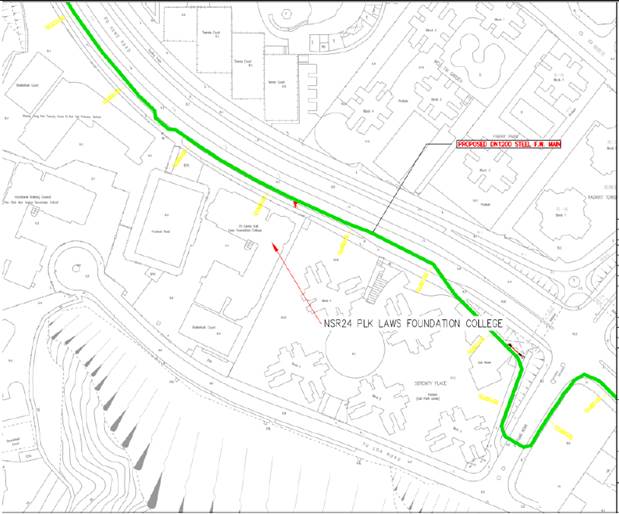

  Laws Foundation College | Pedestrian Road on
  Ground Floor | Free-field |
| NSR 31 | School of Continuing
  and Professional Studies - CUHK | Roof
  Floor | 1
  m from facade |
The monitoring locations should normally be made at a point 1m from the exterior of the NSRs building façade and be at a position 1.2m above the ground. A correction of +3dB(A) should be made to the free-field measurements. Three noise monitoring locations for impact monitoring at the nearby sensitive receivers are shown in Figure 2.1-2.3.
|  |
 |  |

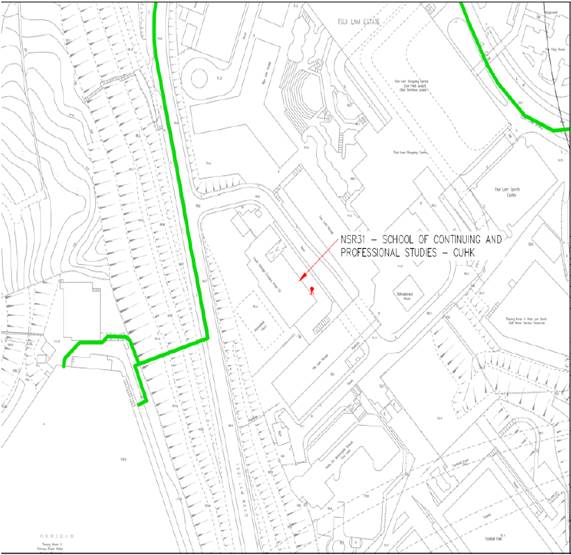

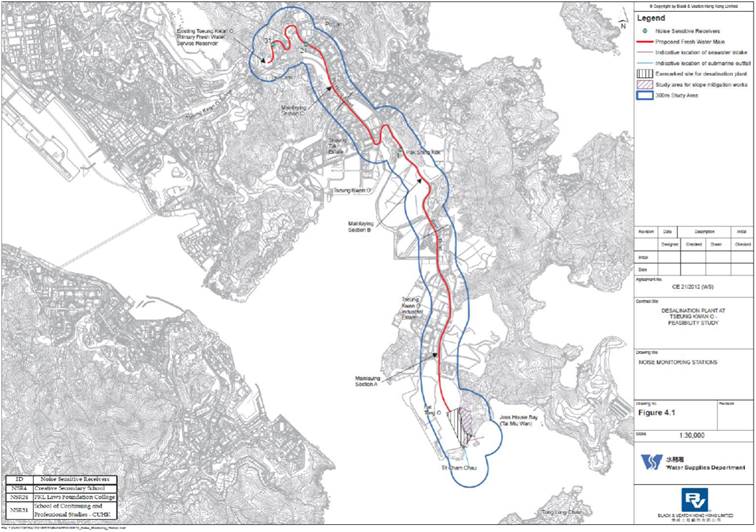

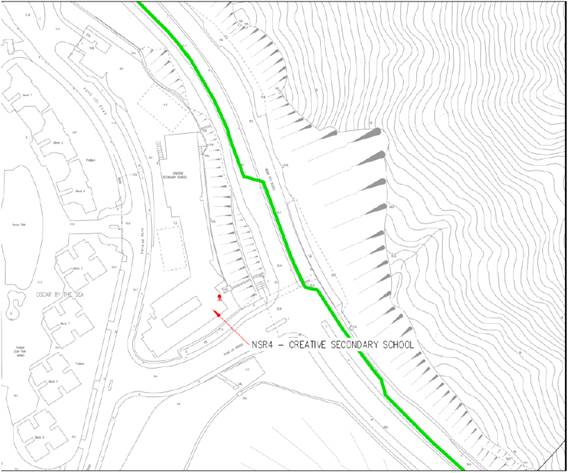

|  | Figure 2.1 NSR4 Creative Secondary
  School |  |
|  |
 | |
|  | Figure 2.2 NSR24 PLK Laws Foundation
  College | |
|  |
 |  | ||
|  | Figure 2.3
  NSR31 School of Continuing
  and Professional Studies - CUHK |  |
 | |
2.3.
IMPACT MONITORING METHODOLOGY
2.4.1 Integrated sound level meter shall be used for the noise monitoring. The meter shall be in compliance with the International Electrotechnical Commission Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications. Immediately prior to and following each noise measurement the accuracy of the sound level meter shall be checked using an acoustic calibrator generating a known sound pressure level at a known frequency. Measurements may be accepted as valid only if the calibration level before and after the noise measurements agree to within 1.0 dB(A). Calibration certificates of the instruments used to be shown at Appendix F is intentionally left blank since no impact monitoring equipment was used in the reporting month.
Noise measurements shall not be made in the presence of fog, rain, wind with a steady speed exceeding 5 m/s or wind with gusts exceeding 10 m/s. The wind speed shall be checked with a portable wind speed meter capable of measuring the wind speed in m/s.
Table 2.3       Impact Noise
Monitoring Equipment
| Equipment | Brand and Model | Detection Limit |
| Sound Level Meter | Nti
  XL2 | 30-130 dB(A) |
| Sound Level Meter Calibrator | Rion
  NC-74 | Nil |
| Pocket Wind Meter Anemometer | Kestrel 1000 Wind Meter | Nil |
2.4.
ACTION AND LIMIT LEVELS
The Action/Limit Levels in line with the criteria of Practice Note for Professional Persons (ProPECC PN 2/93) ¡§Noise from Construction Activities - Non-statutory Controls¡¨ and Technical Memorandum on Environmental Impact Assessment Process issued by HKSAR Environmental Protection Department [¡§EPD¡¨] under the Environmental Impact Assessment Ordinance, Cap 499, S.16 are presented in Table 2.4.
Table 3.4         Action
and Limit Levels for Noise per Updated EM&A Manual
| Time Period | Action | Limit (dB(A)) |
| 0700-1900
  hours on normal weekdays | When one documented complaint is
  received from any one of the noise sensitive receivers | ¡P
  70
  dB(A) for school and ¡P
  65
  dB(A) during examination period |
Notes: Limits
specified in the GW-TM and IND-TM for construction and operation noise,
respectively.

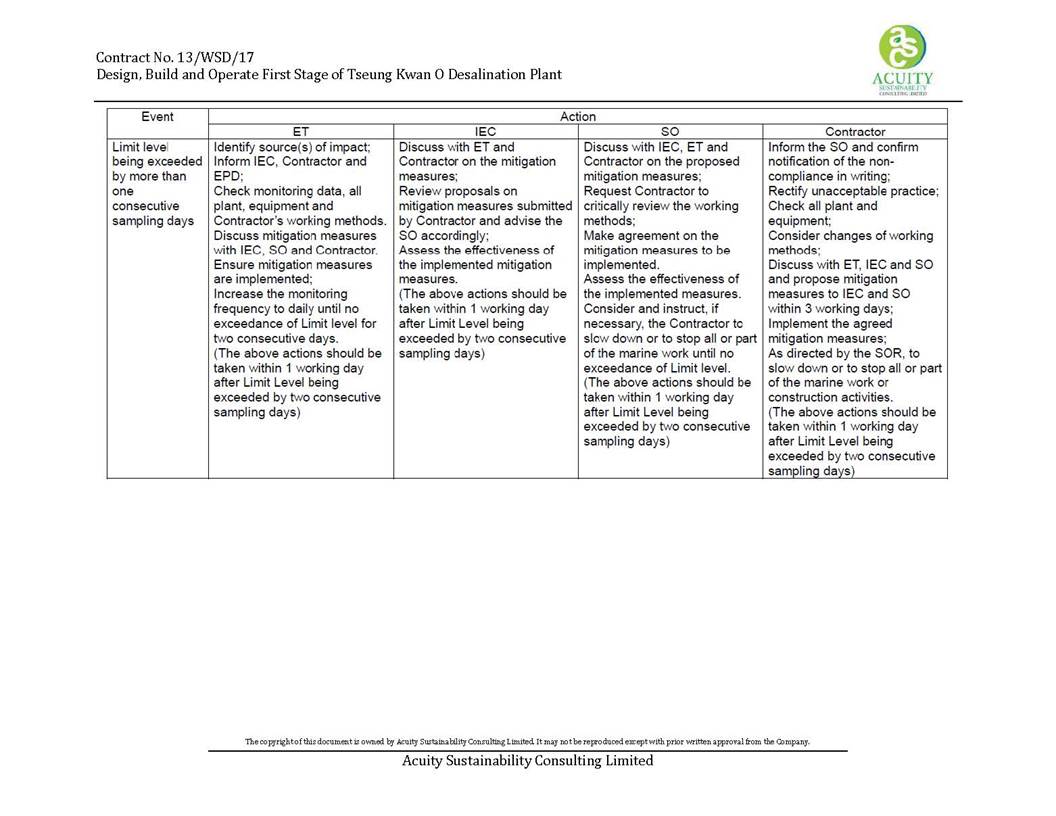

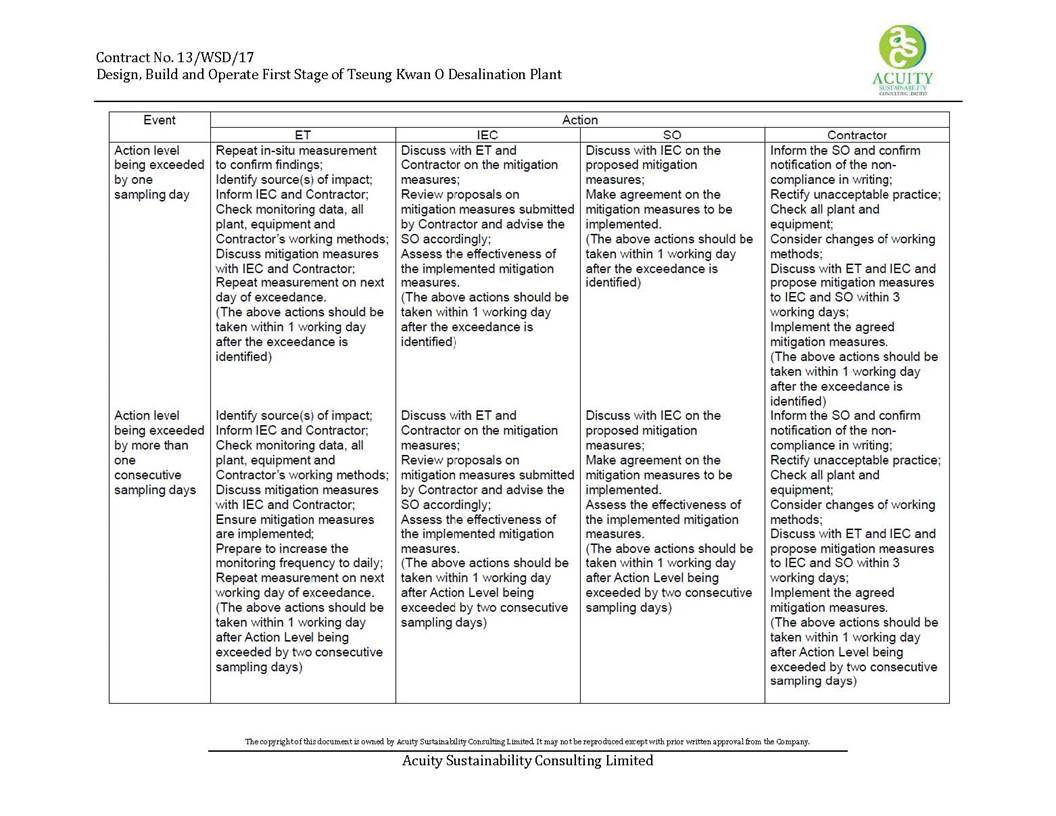

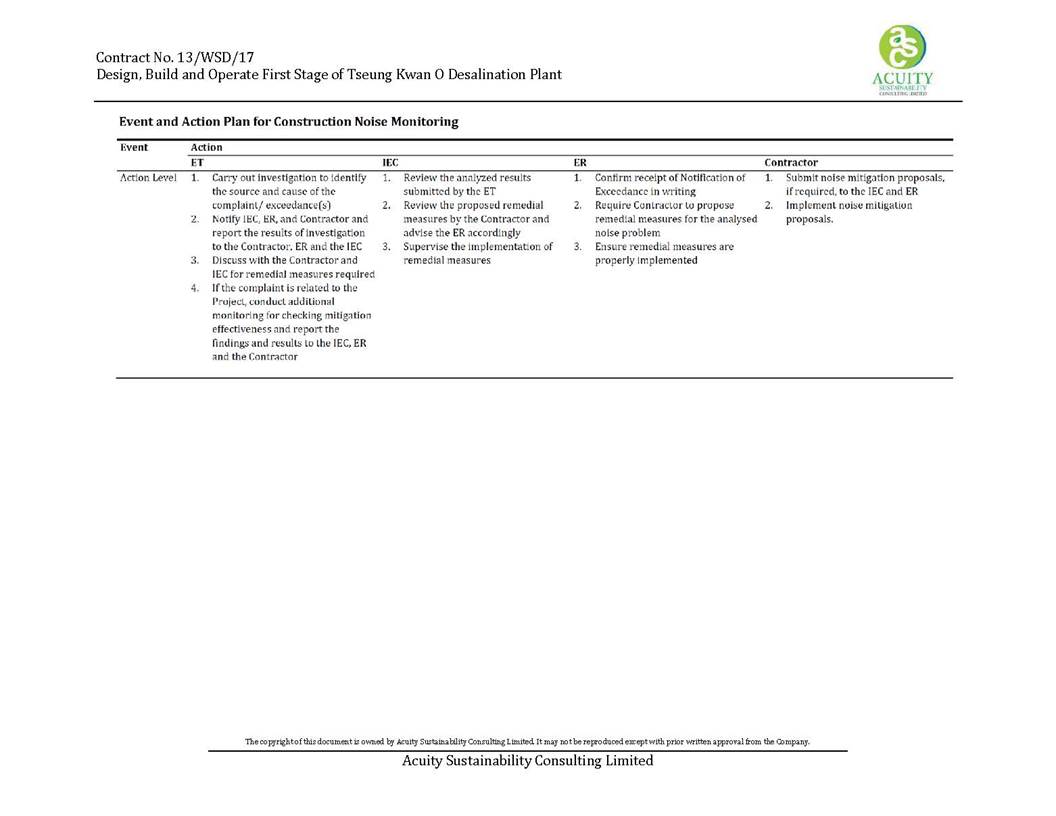

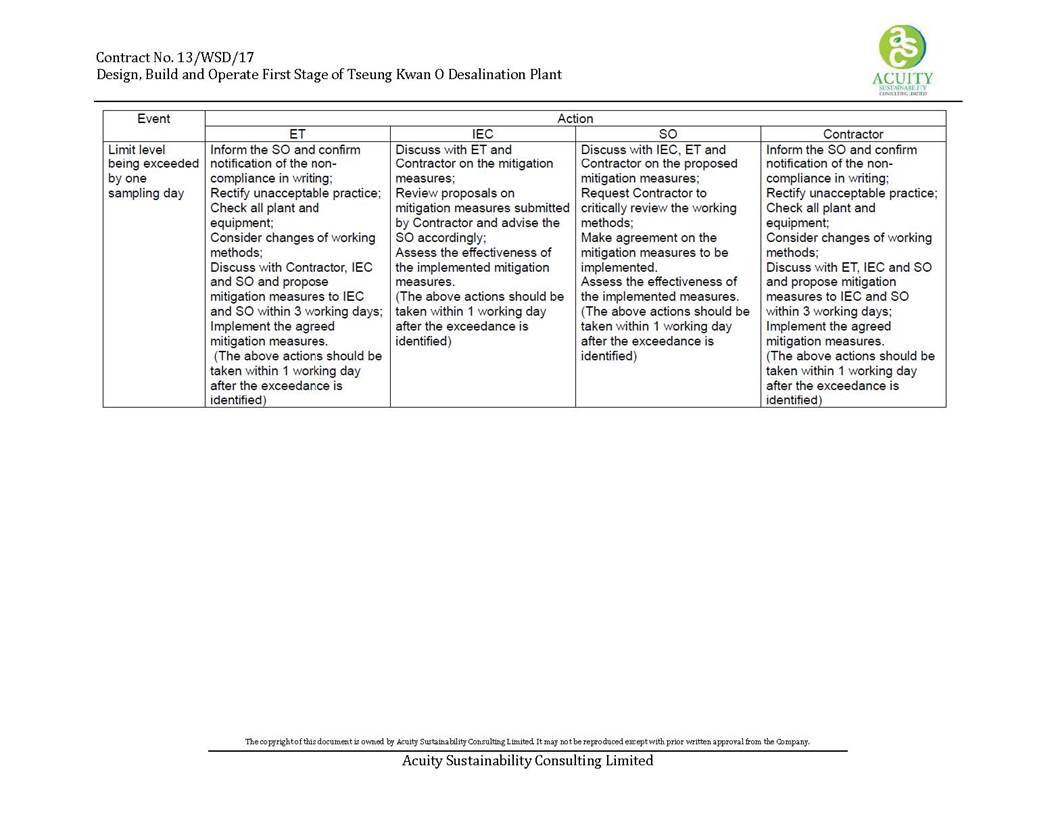

If exceedances were found during noise monitoring, the actions in accordance with the Event and Action Plan shall be carried out according to Appendix E.
2.5.
MONITORING RESULTS AND
OBSERVATIONS
Referring to EM&A manual Section 4.1.2, the impact noise monitoring should be carried out when there are project-related construction activities undertaken within a radius of 300m from the monitoring stations. No monitoring station was located within a radius of 300m of the Project site as shown in Figure 2.4, no impact monitoring for noise impact was conducted in the reporting period.

Figure 2.4     Site
Layout Plan with Noise Sensitive Receivers and Desalination Plant
3.
WATER QUALITY
In accordance with the recommendations of the EIA, water quality EM&A is required during dredging for the submarine pipelines and, during operation phase. In addition, baseline water quality monitoring will be required prior to the commencement of marine construction activities. The following Section provides details of the water quality monitoring to be undertaken by the Environmental Team (ET) to verify the distance of sediment and brine plume dispersion and to identify whether the potential exists for any indirect impacts to occur to ecological sensitive receivers. The water quality monitoring programme will be carried out to allow any deteriorating water quality to be readily detected and timely action taken to rectify the situation. The status and locations of water quality sensitive receivers and the marine works location may change after issuing this Document. If required, the ET in consultation with IEC will propose updated monitoring locations and seek approval from EPD.
Water quality monitoring for the Project can be divided into the following stages:
-
Dredging
activities during construction phase;
-
Discharge
of effluent from main disinfection during construction phase;
-
Operation
phase - first year upon commissioning; and,
-
Continuous
monitoring of effluent quality.
In addition, the marine works contractor is required to complete a silt curtain efficiency test for the combined use of floating silt curtain type and cage type silt curtain for dredging at seawater intake to confirm the silt curtain reduction efficiency assumptions of the assessment. The details of testing plan together with the silt curtain deployment plan updated testing plan shall be submitted by the ET to seek approval from the IEC and EPD.
3.1.
IMPACT MONITORING METHODOLOGY
3.1.1.      WATER QUALITY PARAMETERS
The parameters that have been selected for measurement in situ and in the laboratory are those that were either determined in the EIA to be those with the most potential to be affected by the construction works or are a standard check on water quality conditions. Parameters to be measured in the baseline monitoring are listed in Table 3.1.
Table 3.1       Parameters
measured in the baseline marine water quality monitoring
| Parameters | Unit | Abbreviation |
| In-situ measurements | ||
| Dissolved
  oxygen | mg/L | DO |
| Temperature | oC | - |
| pH | - | - |
| Turbidity | NTU | - |
| Salinity | 0/00 | - |
| Total
  Residual Chlorine NOTE1 | mg/L | TRC |
| Laboratory measurements | ||
| Suspended
  Solids | mg/L | SS |
| Iron-Soluble
  NOTE2 | mg/L | Fe |
| Anti-scalant as Reactive Phosphorus NOTE2 | mg/L | PO4 as P- |
NOTE 1: Monitoring of TRC will be conducted when cleaning and sterilization of the new freshwater main is carried out.
NOTE 2: The testing methods shall be submitted to EPD for approval prior to the commencement of monitoring programme
In addition to the water quality parameters, other relevant data will also be measured and recorded in Water Quality Monitoring Logs, including the location of the sampling stations, water depth, time, weather conditions, sea conditions, tidal stage, current direction and velocity, special phenomena and work activities undertaken around the monitoring and works area that may influence the monitoring results.
3.1.2.      MONITORING EQUIPMENT
For water quality monitoring, the following equipment will be used:
Dissolved Oxygen and Temperature Measuring Equipment - The instrument will be a portable, weatherproof dissolved oxygen measuring instrument complete with cable, sensor, comprehensive operation manuals, and will be operable from a DC power source. It will be capable of measuring: dissolved oxygen levels in the range of 0 - 20 mg/L and 0 - 200% saturation; and a temperature of 0
- 45 degrees Celsius. It shall have a membrane electrode with automatic temperature compensation complete with a cable of not less than 35 m in length. Sufficient stocks of spare electrodes and
cables shall be available for replacement where necessary (e.g. YSI model 59 DO meter, YSI 5739 probe, YSI 5795A submersible stirrer with reel and cable or an approved similar instrument).
Turbidity Measurement Equipment - The instrument will be a portable, weatherproof turbidity- measuring unit complete with cable, sensor and comprehensive operation manuals. The equipment will be operated from a DC power source, it will have a photoelectric sensor capable of measuring turbidity between 0 - 1000 NTU and will be complete with a cable with at least 35 m in length (for example Hach 2100P or an approved similar instrument).
Salinity Measurement Instrument - A portable salinometer capable of measuring salinity in the range of 0 - 40 ppt will be provided for measuring salinity of the water at each monitoring location.
Water Depth Gauge - A portable, battery-operated echo sounder (for example Seafarer 700 or a similar approved instrument) will be used for the determination of water depth at each designated monitoring station. This unit will preferably be affixed to the bottom of the work boat if the same vessel is to be used throughout the monitoring programme. The echo sounder should be suitably calibrated. The ET shall seek approval for their proposed equipment with the client prior to deployment.
Current Velocity and Direction - No specific equipment is recommended for measuring the current velocity and direction. The environmental contractor shall seek approval of their proposed equipment with the client prior to deployment.
Positioning Device - A Global Positioning System (GPS) shall be used during monitoring to allow accurate recording of the position of the monitoring vessel before taking measurements. The Differential GPS, or equivalent instrument, should be suitably calibrated at appropriate checkpoint (e.g. Quarry Bay Survey Nail) to verify that the monitoring station is at the correct position before the water quality monitoring commence.
Water Sampling Equipment - A water sampler, consisting of a PVC or glass cylinder of not less than two litres, which can be effectively sealed with cups at both ends, will be used (e.g. Kahlsico Water Sampler 13SWB203 or an approved similar instrument). The water sampler will have a positive latching system to keep it open and prevent premature closure until released by a messenger when the sampler is at the selected water depth.
Total
Residual Chlorine for Discharge of Sterilization Water -
Total residual chlorine (TRC) shall be measured in-situ using a handheld
colorimeter with its testing toolkits.
3.1.3.      SAMPLING / TESTING PROTOCOLS
All in situ monitoring instruments will be checked, calibrated and certified by a laboratory accredited under HOKLAS or any other international accreditation scheme before use, and subsequently re-calibrated at monthly intervals throughout the stages of the water quality monitoring. Responses of sensors and electrodes will be checked with certified standard solutions before each use.
On-site calibration of field equipment shall follow the ¡§Guide to On-Site Test Methods for the Analysis of Waters¡¨, BS 1427: 2009. Sufficient stocks of spare parts shall be maintained for replacements when necessary. Backup monitoring equipment shall also be made available so that monitoring can proceed uninterrupted even when equipment is under maintenance, calibration etc.
3.1.4.      LABORATORY MEASUREMENT
AND ANALYSIS
All laboratory work shall be carried out in a HOKLAS accredited laboratory. Sufficient volume of each water sample shall be collected at the monitoring stations for carrying out the laboratory analyses. Using chain of custody forms, collected water samples will be transferred to an HOKLAS accredited laboratory for immediate processing. The determination work shall start within the next working day after collection of the water samples. The laboratory measurements shall be provided to the client within 5 working days of the sampling event. Analytical methodology and sample preservation of other parameters will be based on the latest edition of Standard Methods for the Examination of Waste and Wastewater published by APHA, AWWA and WPCF and methods by USEPA, or suitable method in accordance with requirements of HOKLAS or another internationally accredited scheme. The submitted information should include pre-treatment procedures, instrument use, Quality Assurance/Quality Control (QA/QC) details (such as blank, spike recovery, number of duplicate samples per-batch etc), detection limits and accuracy. The QA/QC details shall be in accordance with requirements of HOKLAS or another internationally accredited scheme.
Parameters for laboratory measurements, their standard methods and their detection limits are presented in Table 3.2.
Table 3.2 Laboratory measurements, standard methods and corresponding
detection limits of marine water quality monitoring
| Parameters | Standard Methods | Detection Limit | Reporting Limit | Precision | |||
| Dissolved
  oxygen (mg/L) | Instrumental,
  CTD | 0.1 | - | ¡Ó25% | |||
| Temperature
  (oC) | Instrumental,
  CTD | 0.1 | - | ¡Ó25% | |||
| pH | Instrumental,
  CTD | 0.1 | - | ¡Ó25% | |||
| Turbidity
  (NTU) | Instrumental,
  CTD | 0.1 | - | ¡Ó25% | |||
| Salinity (0/00) | Instrumental,
  CTD | 0.1 | - | ¡Ó25% | |||
| Suspended
  Solids (mg/L) | APHA
  17th Ed
  2540D | 1.0 | 2.0 | ¡Ó17% | |||
| Total
  Residual Chlorine (mg/L) | APHA 21st Ed
  4500 - Cl G NOTE1 | 0.1NOTE1 | 0.2NOTE1 | ¡Ó10% NOTE1 | |||
| Iron-soluble | USEPA
  6010C NOTE 1 | 0.2NOTE1 | 0.2NOTE1 | ¡Ó25%NOTE1 | |||
| Parameters | Standard Methods | Detection Limit | Reporting Limit | Precision | |||
| Anti-scalant as Reactive phosphorus | APHA
  4500P: B&F NOTE1 | 0.01NOTE1 | 0.01NOTE1 | ¡Ó25%NOTE1 | |||
NOTE1: The testing methods, Quality Assurance/Quality Control (QA/QC) details, detection limits and accuracy shall be submitted to EPD for approval prior to the commencement of monitoring programme.
If exceedances were found during water monitoring, the actions in accordance with the Event and Action Plan shall be carried out according to Appendix G.
3.1.5.      MONITORING LOCATION
The water quality monitoring locations for baseline in accordance to the EM&A Manual and Contract Specification are shown in Figure 3.1 and Figure 4.1 respectively, and detailed in Table 3.3 below. A schedule for water quality monitoring shall be prepared by the ET and approved by IEC and EPD prior to the commencement of the monitoring.
Table 3.3 Location of Baseline Water Quality Monitoring
Station
| Station | Easting | Northing | Description |
| CE | 843550 | 815243 | Upstream
  control station at ebb tide |
| CF | 846843 | 810193 | Upstream
  control station at flood tide |
| WSR1 | 846864 | 812014 | Ecological
  sensitive receiver at Tung Lung Chau |
| WSR2 | 847645 | 812993 | Fisheries
  sensitive receiver at Tung Lung Chau |
| WSR3 | 848023 | 813262 | Ecological
  sensitive receiver at Tung Lung Chau |
| WSR4 | 847886 | 814154 | Ecological
  sensitive receiver at Tai Miu Wan |
| WSR16 | 845039 | 815287 | Ecological
  sensitive receiver at Fat Tong Chau |
| WSR33 | 847159 | 814488 | Ecological
  sensitive receiver at Tai Miu Wan |
| WSR36 | 846878 | 814081 | Ecological
  sensitive receiver at Kwun Tsai |
| WSR37 | 846655 | 813810 | Ecological
  sensitive receiver at Tit Cham Chau |
| NF1 | 846542 | 813614 | Edge
  of mixing zone, ~ 200m west of outfall diffuser |
| NF2 | 846942 | 813614 | Edge
  of mixing zone, ~ 200m east of outfall diffuser |
| NF3 | 846742 | 813414 | Edge
  of mixing zone, ~ 200m south of outfall diffuser |
WSR1 to WSR37 were identified in accordance with Annex 14 of the EIAO-TM as well as Clause
3.4.4.2 of the Environmental Impact Assessment Study Brief for Desalination Plant at Tseung Kwan O (No. ESB-266/2013). WSR1 to WSR3 are sited near the Tung Lung Chau Fish Culture Zone; WSR16 and WSR36 are sited near the coral assemblages along the coastlines of Fat Tong Chau and Kwun Tsai respectively; WSR 4 and WSR33 are sited near the Coastal Protection Area and coral assemblages in waters of Tai Miu Wan; WSR37 is sited near the fisheries resource including spawning and nursery grounds at the coastal water of Tit Cham Chau.

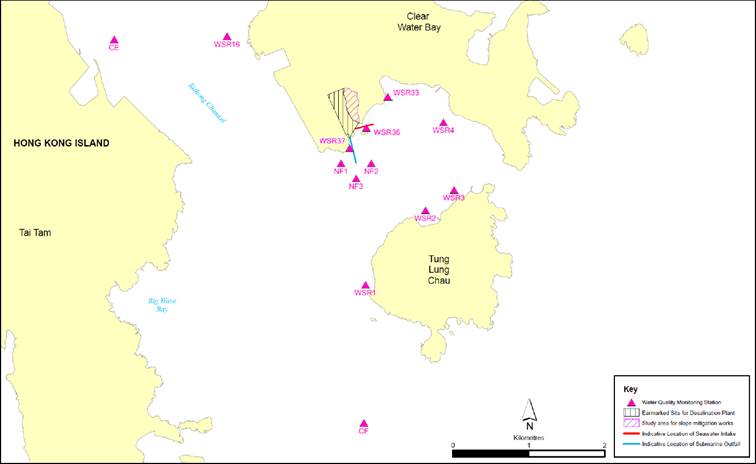

Figure 3.1      Baseline water quality
monitoring locations under EM&A Manual

3.1.6.      SAMPLING FREQUENCY
During periods when there are dredging
works, impact monitoring should be undertaken at the monitoring stations as
shown in Figure 3.1 and Table 3.3 three days per week during
the construction phase after the commencement of marine construction works and
dredging activities. Monitoring at each station would be undertaken at both
mid-ebb and mid-flood tides on the same day. The tidal range selected for the
baseline monitoring will be at least 0.5 m for both flood and ebb tides as far
as practicable. The interval between two sets of monitoring would not be less
than 36 hours. The monitoring frequency would be increased in the case of
exceedances of Action/Limit Levels if considered necessary by ET. Monitoring
frequency would be maintained as far as practicable.
The monitoring location/position, time, water depth, water temperature, salinity, weather conditions, sea conditions, tidal stage, special phenomena and work underway at the marine works site will be recorded.
3.1.7.      SAMPLING DEPTHS
& REPLICATION
For baseline monitoring, each station will be sampled and measurements/ water samples will be taken at three depths, 1 m below the sea surface, mid-depth and 1 m above the seabed. For stations that are less than 3 m in depth, only the mid depth sample shall be taken. For stations that are less than 6 m in depth, only the surface and seabed sample shall be taken. For in situ measurements, duplicate readings shall be made at each water depth at each station. Duplicate water samples shall be collected at each water depth at each station.
3.2.
MONITORING PROGRAMME
The ET of the Project had conducted the baseline water monitoring between 12 May 2020 to 6 Jun 2020 at the thirteen designated monitoring stations and the six designated monitoring at waters near TKO in accordance with the EM&A Manual and Contract Specification respectively. The monitoring results was presented in Baseline Water Quality Monitoring Report separately.
The commencement of marine construction and dredging activities for the Project are scheduled in November 2020 the earliest. The impact water monitoring shall be scheduled after the commencement of marine construction and dredging activities. Hence, no water monitoring was conducted during the reporting month.
The waste generated from
this Project includes inert construction and demolition (C&D) materials,
and non-inert C&D materials. Non- inert C&D materials are made up of
general refuse, vegetative wastes and recyclable wastes such as plastics and
paper/cardboard packaging waste. Steel materials generated from the project are
also grouped into non-inert C&D materials as the materials were not
disposed of with other inert C&D materials. With reference to relevant
handling records and trip tickets of this Project, the quantities of different
types of waste generated in the reporting month are summarised
in Table 4.1. Details of cumulative
waste management data are presented as a waste flow table in Appendix H.
Table 4.1      Quantities of
Waste Generated from the Project during August 2020
| Reporting
  Month | Actual
  Quantities of Inert C&D Materials Generated Monthly | Actual
  Quantities of C&D Wastes Generated Monthly | |||||||||
| Total Quantity Generated | Hard Rock and
  Large Broken Concrete | Reused in the
  Contract | Reused in other
  Projects | Disposed as Public Fill | Imported Fill | Metals | Paper /
  cardboard packaging | Plastics (see
  Note) | Chemical Waste | Others, e.g. general refuse | |
| (in
  ,000kg) | (in
  ,000kg) | (in
  ,000kg) | (in
  ,000kg) | (in
  ,000kg) | (in
  ,000kg) | (in
  ,000kg) | (in
  ,000kg) | (in
  ,000kg) | (in
  ,000kg) | (in
  ,000kg) | |
| August 2020 | 161.08 | 0 | 0 | 0 | 161.08 | 0 | 0 | 0 | 0 | 0 | 42.07 |
Notes:  (1)
Plastics refer to plastic bottles / containers, plastic sheets / foam from
packaging material
5.
LANDFILL GAS MONITORING
5.1.
MONITORING REQUIREMENT
In accordance with Section 11 of the EM&A Manual, monitoring of landfill gas is required for construction works within the 250m Consultation Zone. Part of the desalination plant and the indicative area of natural slope mitigation works fall within the SENT Landfill Extension Consultation Zone; and part of the 1,200 mm diameter fresh water mains along Wan Po Road falls within the SENT Landfill and SENT Landfill Extension Consultation Zones, TKO Stage II/III Restored Landfill and TKO Stage I Restored Landfill Consultation Zones.
5.2.
MONITORING LOCATION
Monitoring of oxygen, methane, carbon dioxide and barometric pressure was performed for excavations at 1m depth or more within the consultation Zone.
During construction of works within the consultation zones, excavations of 1m depth or more was monitored:
- At the ground surface before excavation commences;
- Immediately before any worker enters the excavation;
- At the beginning of each working day for the entire period the excavation remains open; and
- Periodically through the working day whilst workers are in the excavation.
For excavations between 300mm and 1m deep, measurements should be carried out:
- Directly after the excavation has been completed; and
- Periodically whilst the excavation remains open.
5.3.
MONITORING PROGRAMME
For the part of the desalination plant and the indicative area of natural slope mitigation works fall within the SENT Landfill Extension Consultation Zone in this contract. Since the SENT Landfill Extension is still under construction, the Landfill gas monitoring shall be conducted after the commencement of operation of the SENT Landfill Extension which will be 2021 Quarter 3 according to the latest construction programme shown in the monthly EM&A Report of SENT Landfill Extension. The Contractor¡¦s safety officer shall keep review the necessity of landfill gas monitoring during the construction stage. No landfill gas monitoring was conducted in the reporting period.
6.
SUMMARY OF MONITORING EXCEEDANCE, COMPLAINTS, NOTIFICATION OF SUMMONS AND PROSECUTIONS
The
Environmental Complaint Handling Procedure is shown in below Figure 6.1:

Figure 6.1     Environmental
Complaint Handling Procedures
No noise monitoring was conducted during the reporting period since there are no project-related construction activities undertaken within a radius of 300m from the monitoring locations.
No impact water quality monitoring was conducted in the reporting month since the commencement of marine construction and dredging activities for the Project are scheduled in November 2020 the earliest.
No project-related exceedance of the Action Level was recorded during the reporting period. No notification of summons and prosecution was received in the reporting period.
Statistics on complaints and regulatory compliance are summarized in Appendix J.

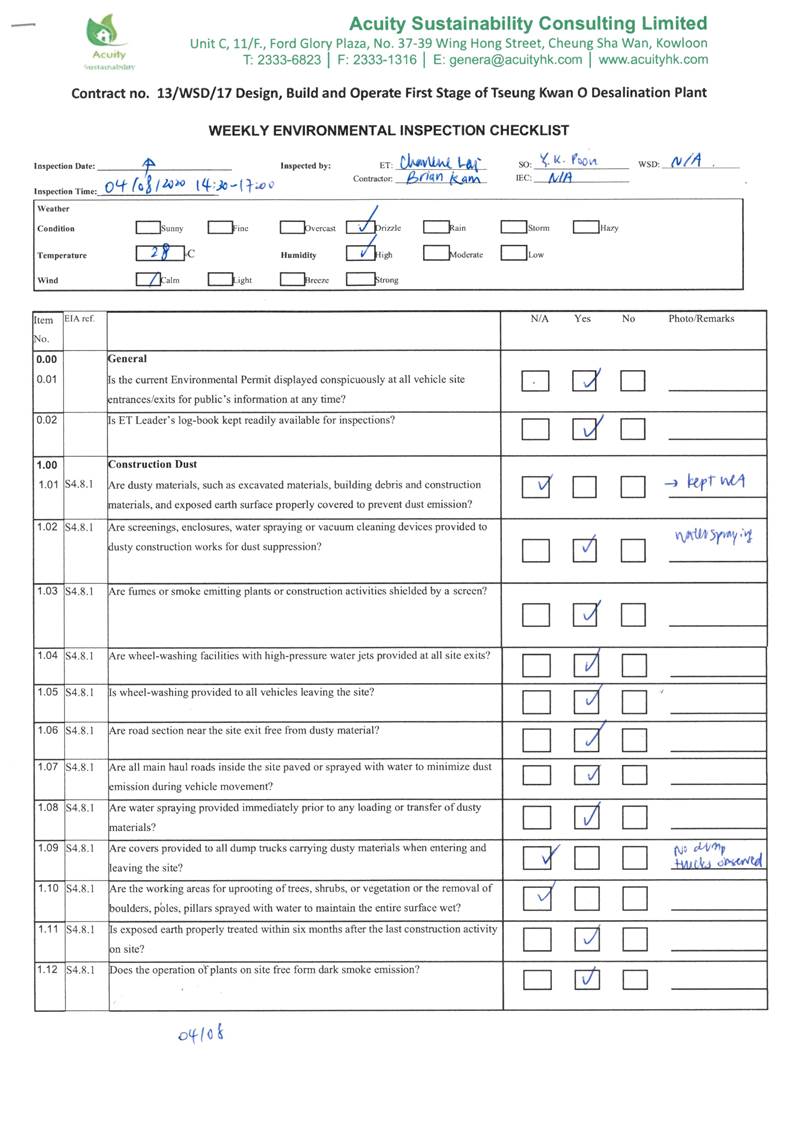

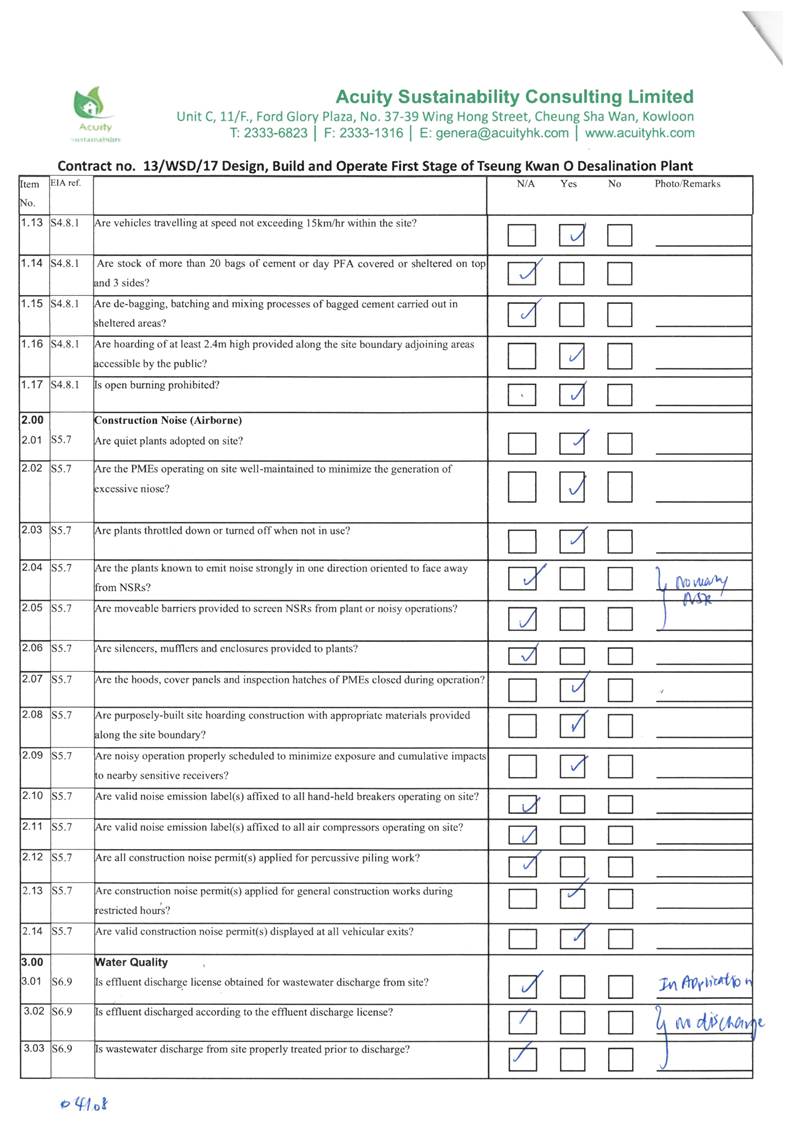

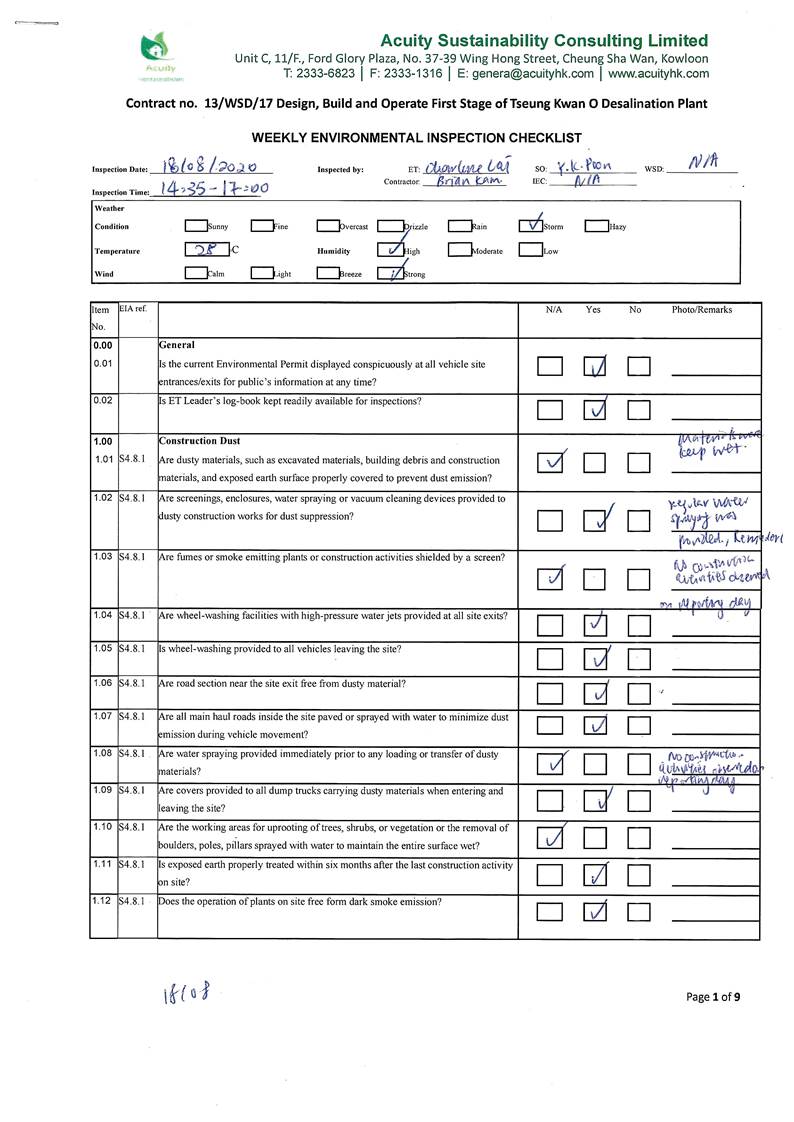

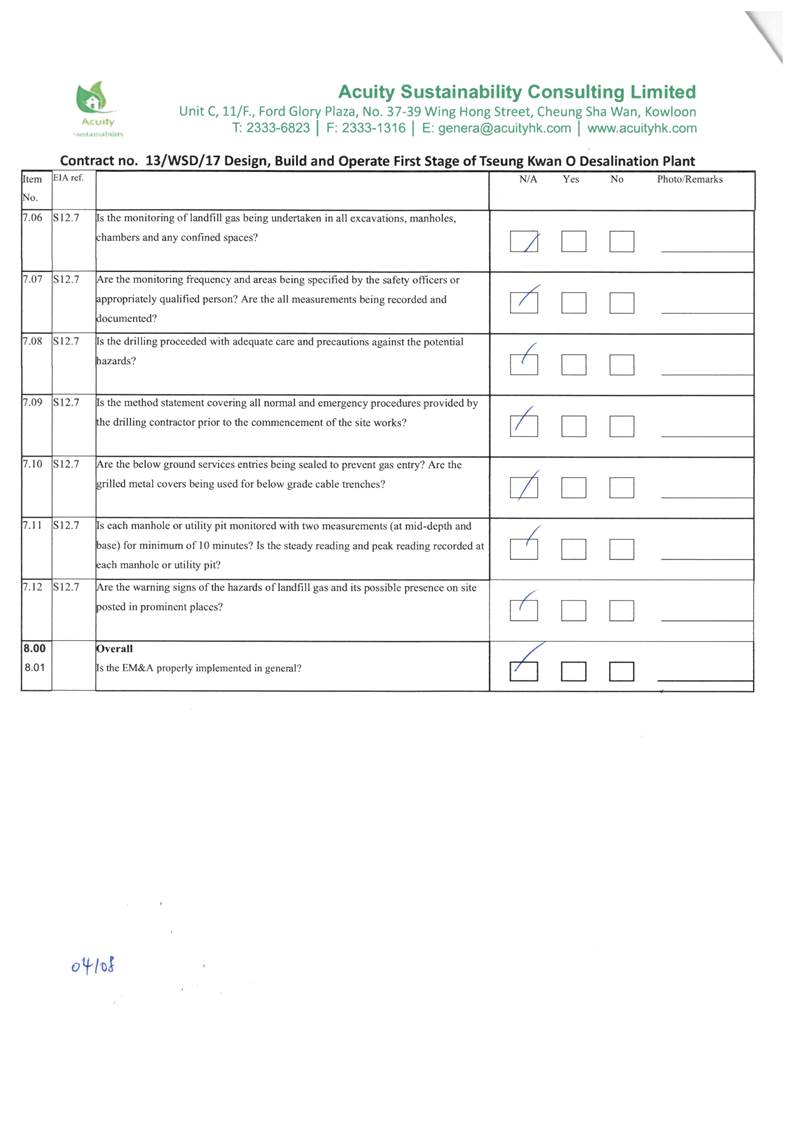

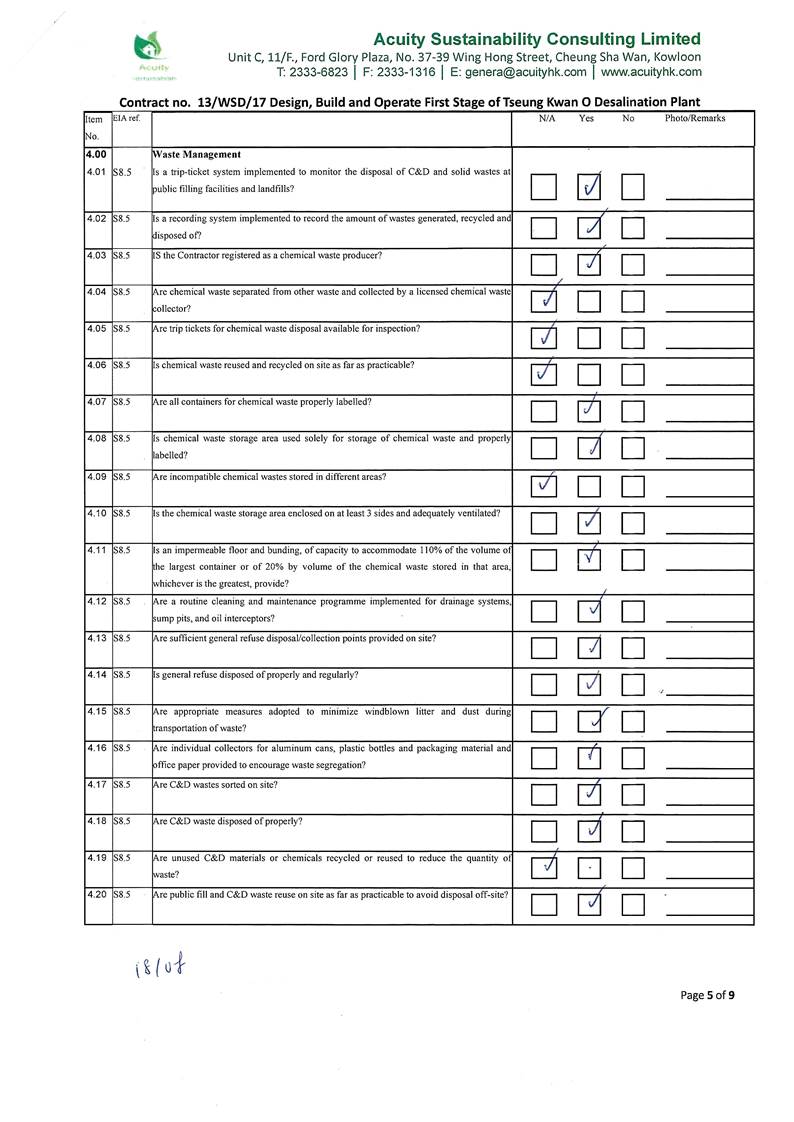

Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract. In the reporting period, site inspections were carried out on 4, 11, 18 & 27 August 2020 at the site portions list in Table 6.1 below.
Table 7.1      Summaries
of Site Inspection Record
| Date | Inspected Site Portion | Time |
| 4 August 2020 | TKO 137 | 14:30 - 17:00 PM |
| 11 August 2020 | TKO 137 | 14:50 - 17:15 PM |
| 18 August 2020 | TKO 137 | 14:35 - 17:00 PM |
| 27 August 2020 | TKO 137 | 09:30 - 11:00 AM |
Two joint site inspection with IEC were carried out on 11 & 27 August 2020.
Environmental deficiencies were observed during weekly site inspection. Key observations during the site inspections and during the reporting period are summarized in Table 7 .2.
Table 7.2      Site Observations
| Date | Environmental Observations | Follow-up Status |
| 4 August 2020 (Site inspection) | Observation(s) and Recommendation(s) 1. No major observation was observed. | Nil. |
| 11 August 2020 (Site inspection) | Observation(s) and Recommendation(s) 1. No major observation was observed. | Nil. |
| 18 August 2020 (Site inspection) | Observation(s) and Recommendation(s) 1. No major observation was observed. | Nil. |
| 27 August 2020 (Site inspection) | Observation(s) and Recommendation(s) 1. No major observation was observed. | Nil. |
According to the EIA Study Report, Environmental Permit, contract documents and EM&A Manual, the mitigation measures detailed in the documents are implemented as much as practical during the reporting period. An updated Implementation Status of Environmental Mitigation Measures (EMIS) is provided in Appendix C.

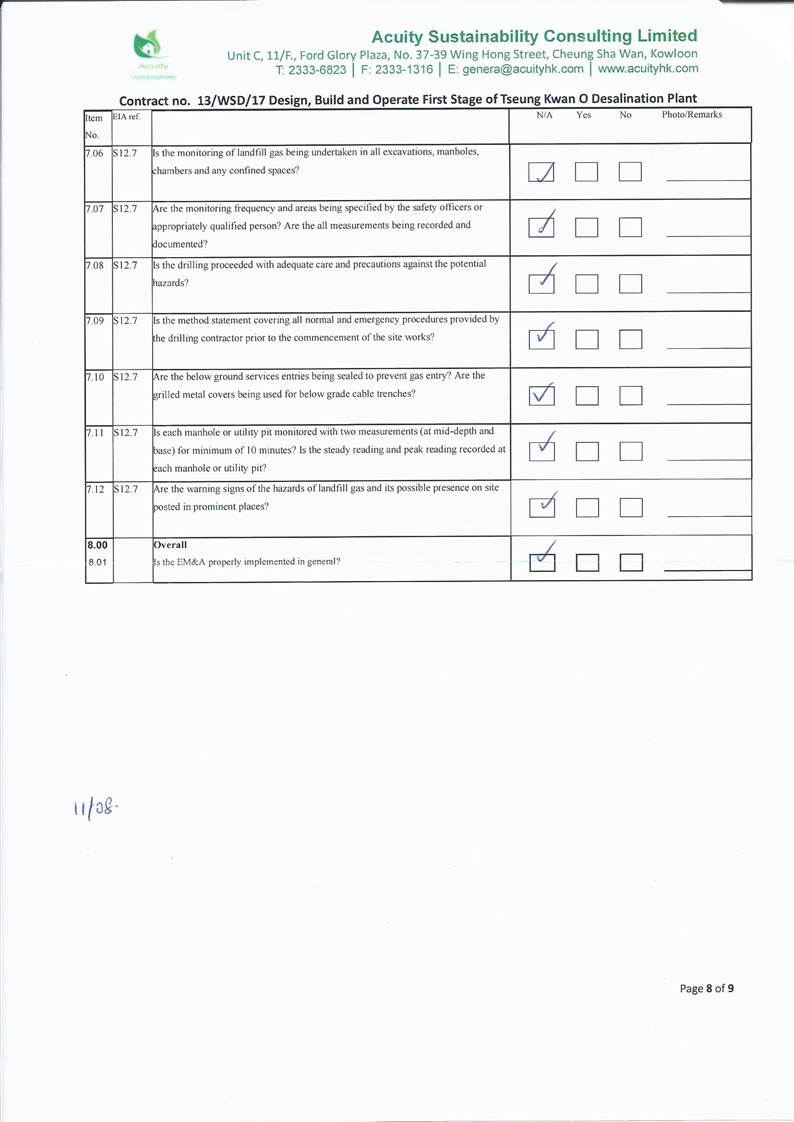

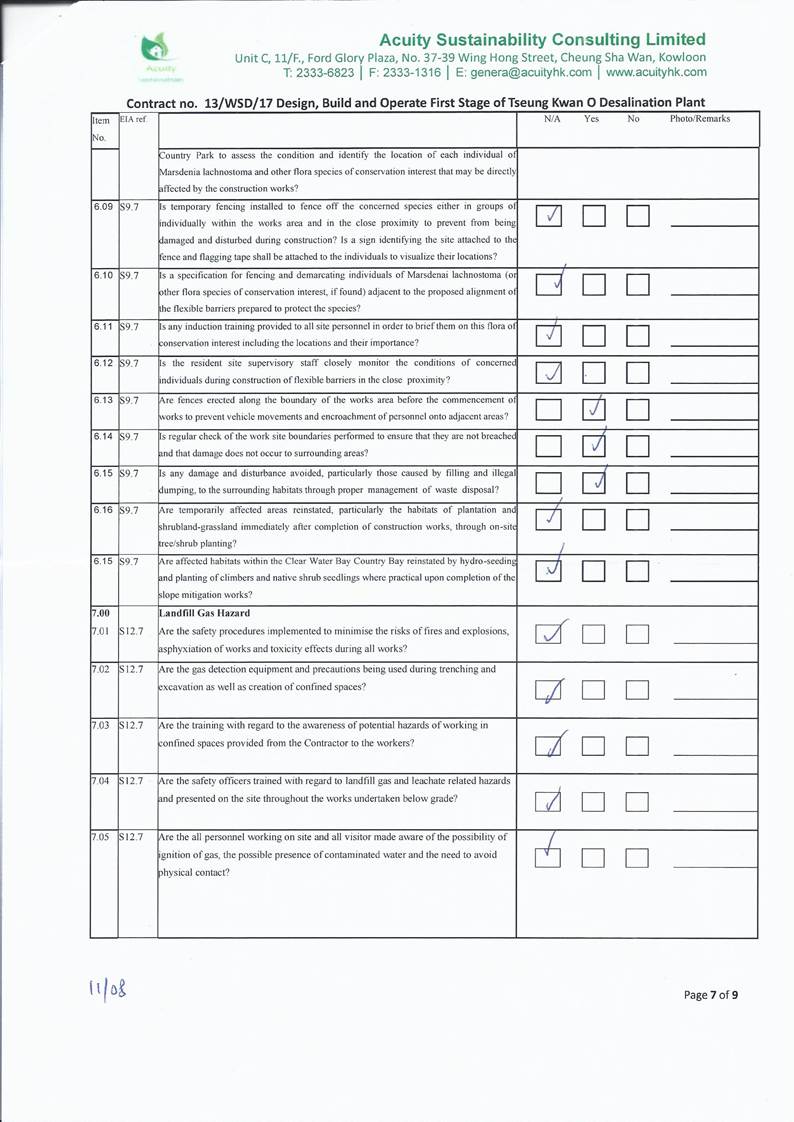

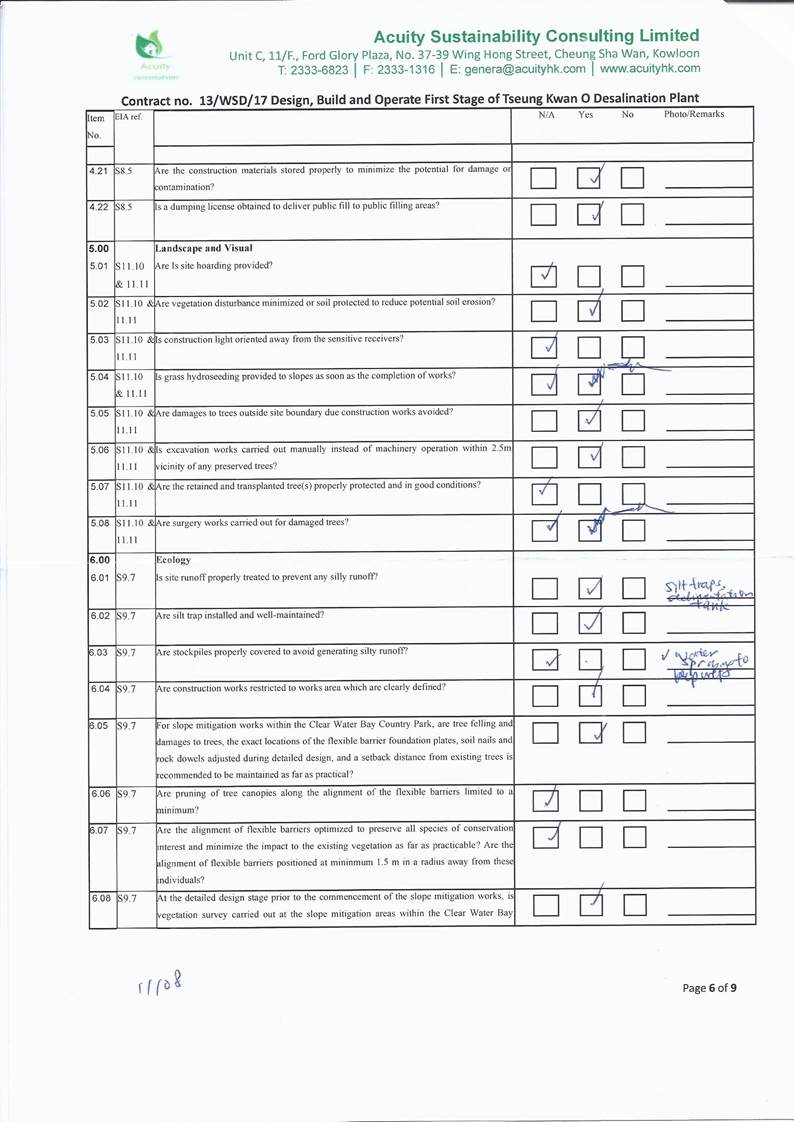

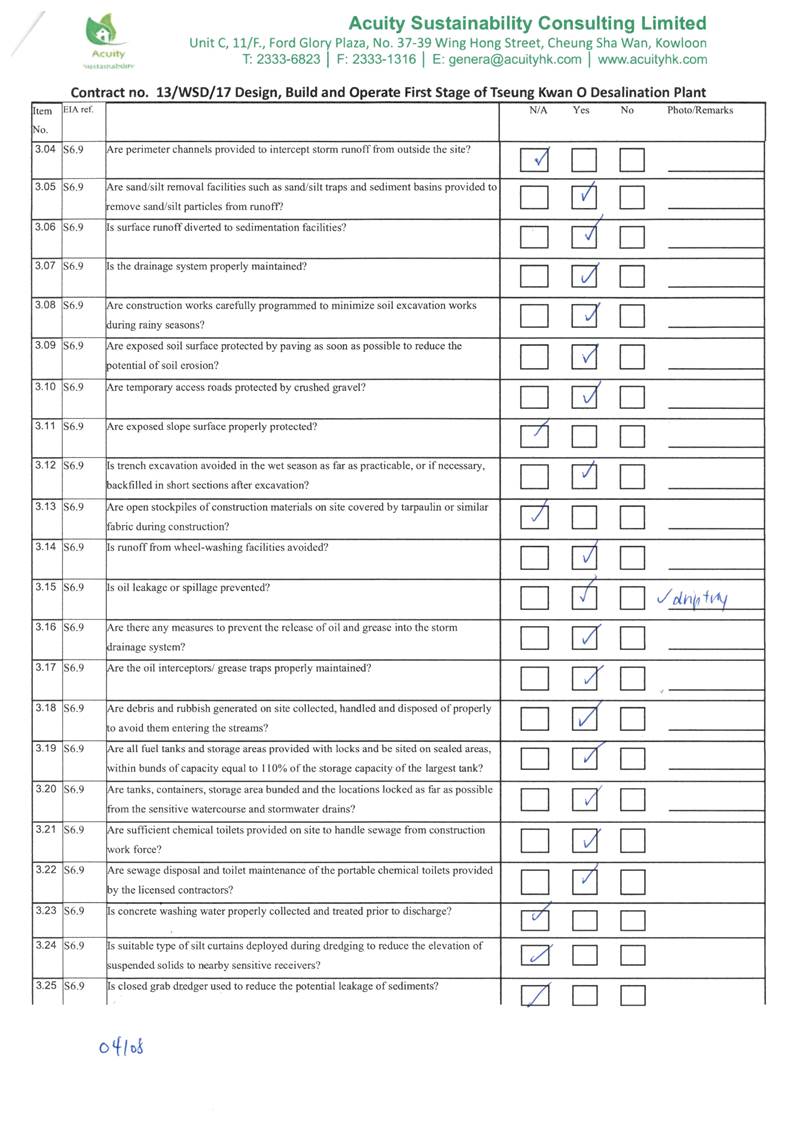

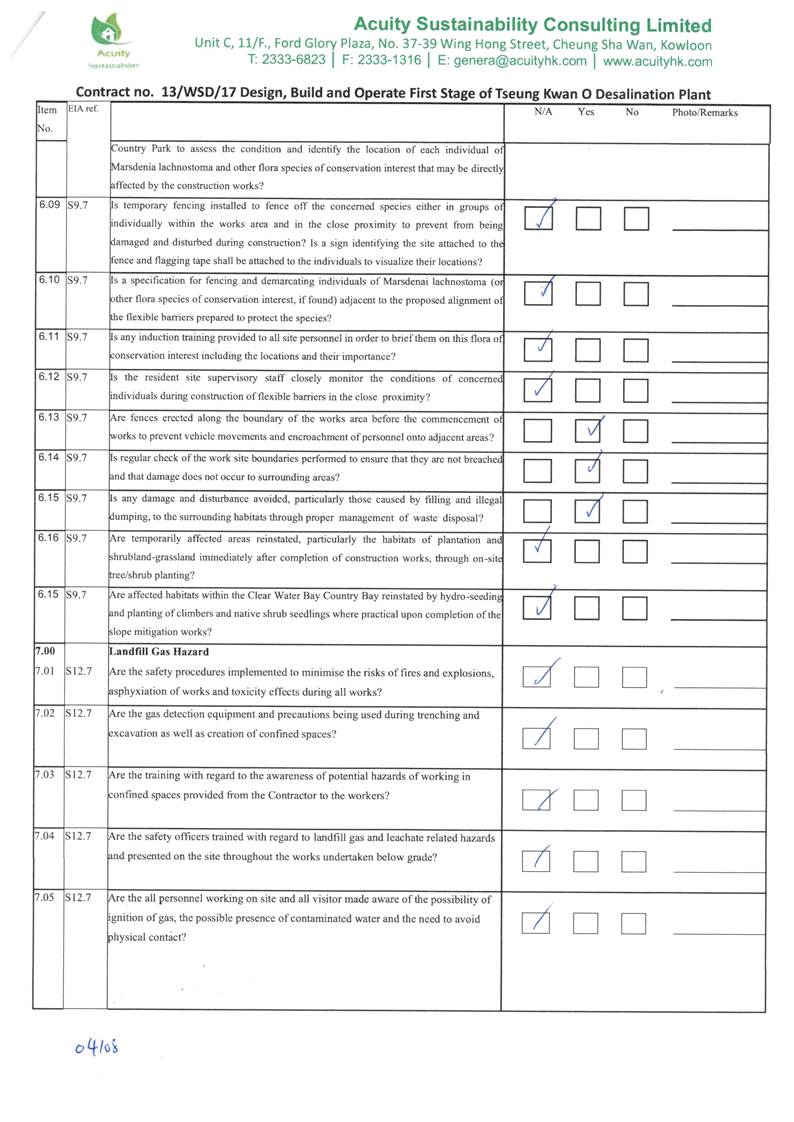

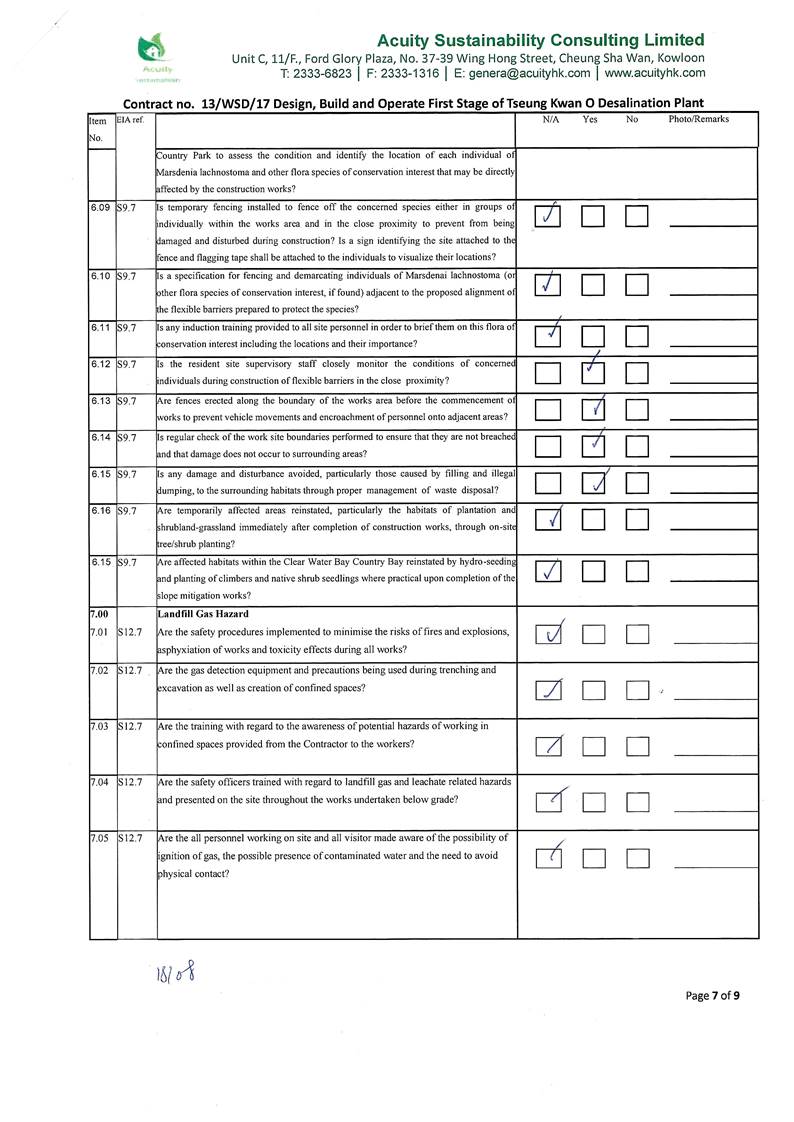

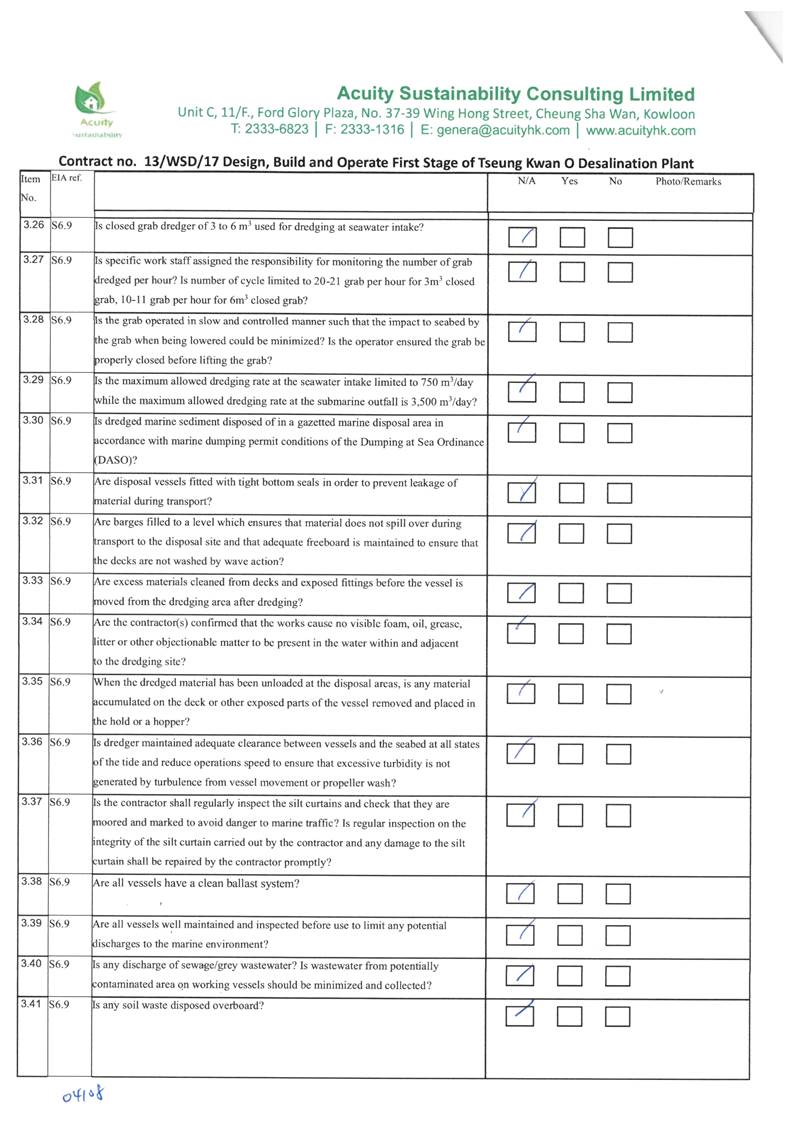

Site inspection proforma of the reporting
period is provided in Appendix I.
Works to be undertaken in the next reporting month are:
- Land Survey;
- Access Road Construction;
- Construction of 132kV substation (G/F to 1st floor)
- Pre-boring and installation of sheetpiles for combine shaft;
- Construction of ActiDAFF footing;
- Construction for RO foundation;
- Excavation for Product Water Storage Tank footing;
- Installation of temporary soil nail at Product Water Storage Tank;
- Excavation and ELS installation for combine shaft.
The major environmental impacts brought by the above construction works will include:
- Construction dust and noise generation from GI works, access road construction and site office formation work;
- Waste generation from construction activities
The key environmental mitigation measures for the Project in the coming reporting period associated with the above construction works will include:
- Dust suppression by regular wetting and water spraying for construction works
- Reduction of noise from equipment and machinery on-site
- Sorting and storage of general refuse and construction waste
Referring to EM&A Manual Section 4.1.2, the impact noise monitoring should be carried out at all the designated monitoring stations when there are project-related construction activities undertaken within a radius of 300m from the monitoring stations.
The impact monitoring schedule for the next reporting month to be shown at Appendix K is intentionally left blank since no impact monitoring will be conducted in the next reporting month.
9.
CONCLUSIONS AND RECOMMENDATIONS
This is the 6th Monthly EM&A Report for the Project which summarizes the key findings of the EM&A programme during the reporting period from 1 August to 31 August 2020, in accordance with the EM&A Manual and the requirement under FEP-01/503/2015/A.
No noise monitoring was conducted in the reporting period due to the over distant monitoring station from the works location.
construction activities undertaken within a radius of 300m from the monitoring locations.
No impact water monitoring was conducted in the reporting period due to no marine construction works and dredging activities were conducted in the reporting period.
No project-related exceedance of the Action / Limit Level was recorded during the reporting period.
Weekly environmental site inspection was conducted during the reporting period. Minor deficiency was observed during site inspection and was rectified. The environmental performance of the project was therefore considered satisfactory.
According to the environmental site inspections performed in the reporting month, the Contractor is reminded to pay attention on maintaining proper materials storage.
No environmental complaint was received in the reporting period.
No notification of summons or prosecution was received since commencement of the Contract.
The ET will keep track on the construction works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.

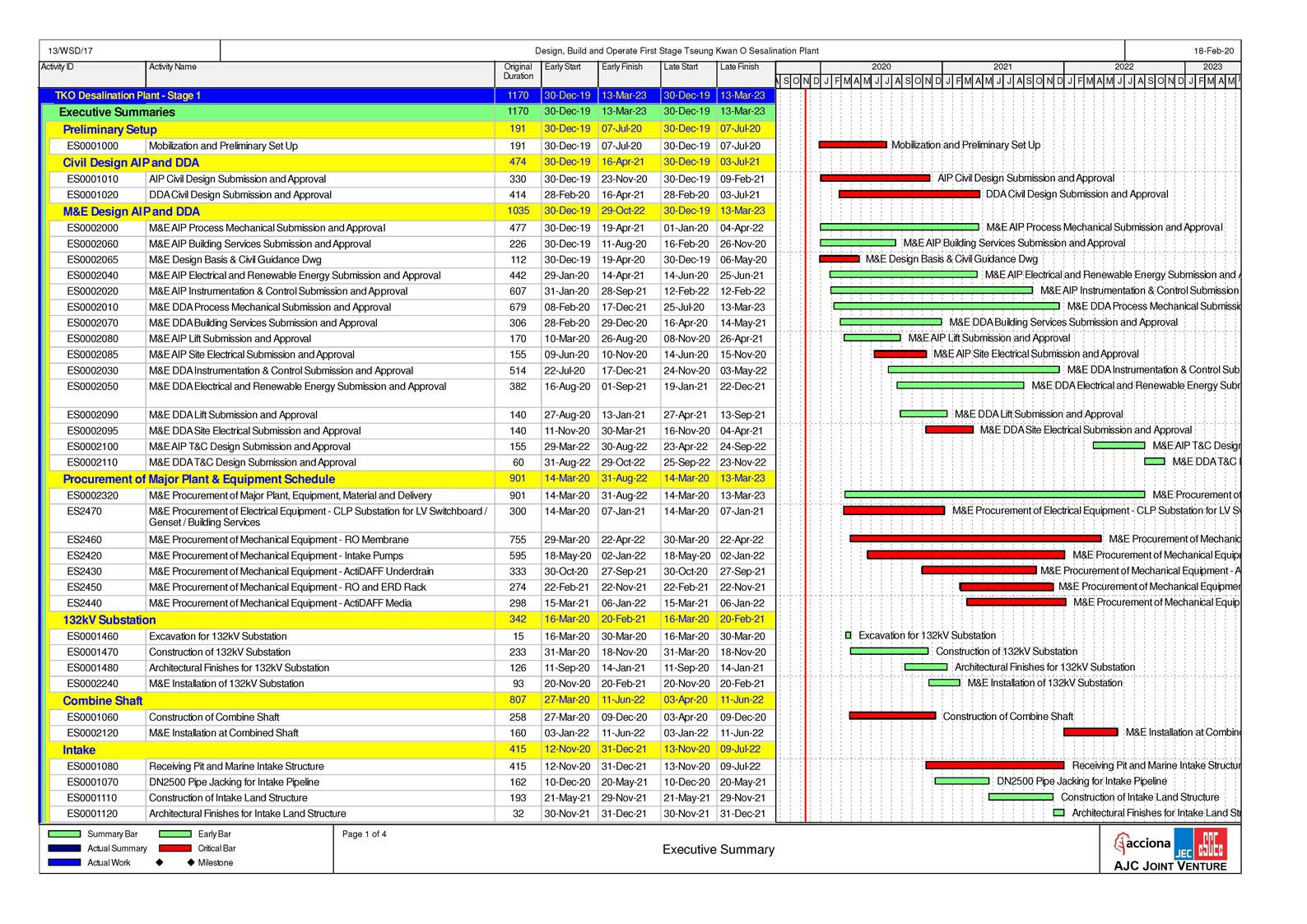

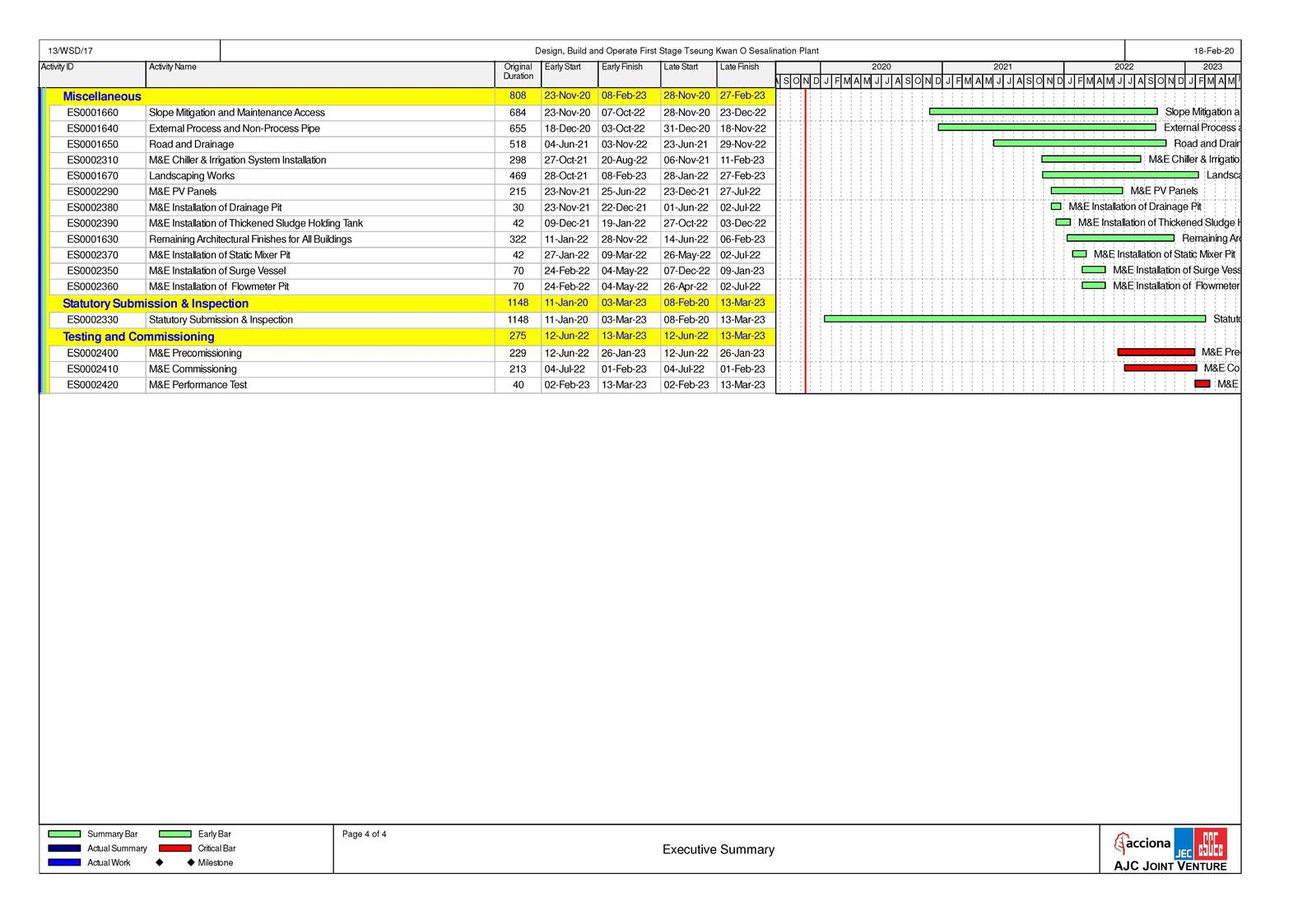

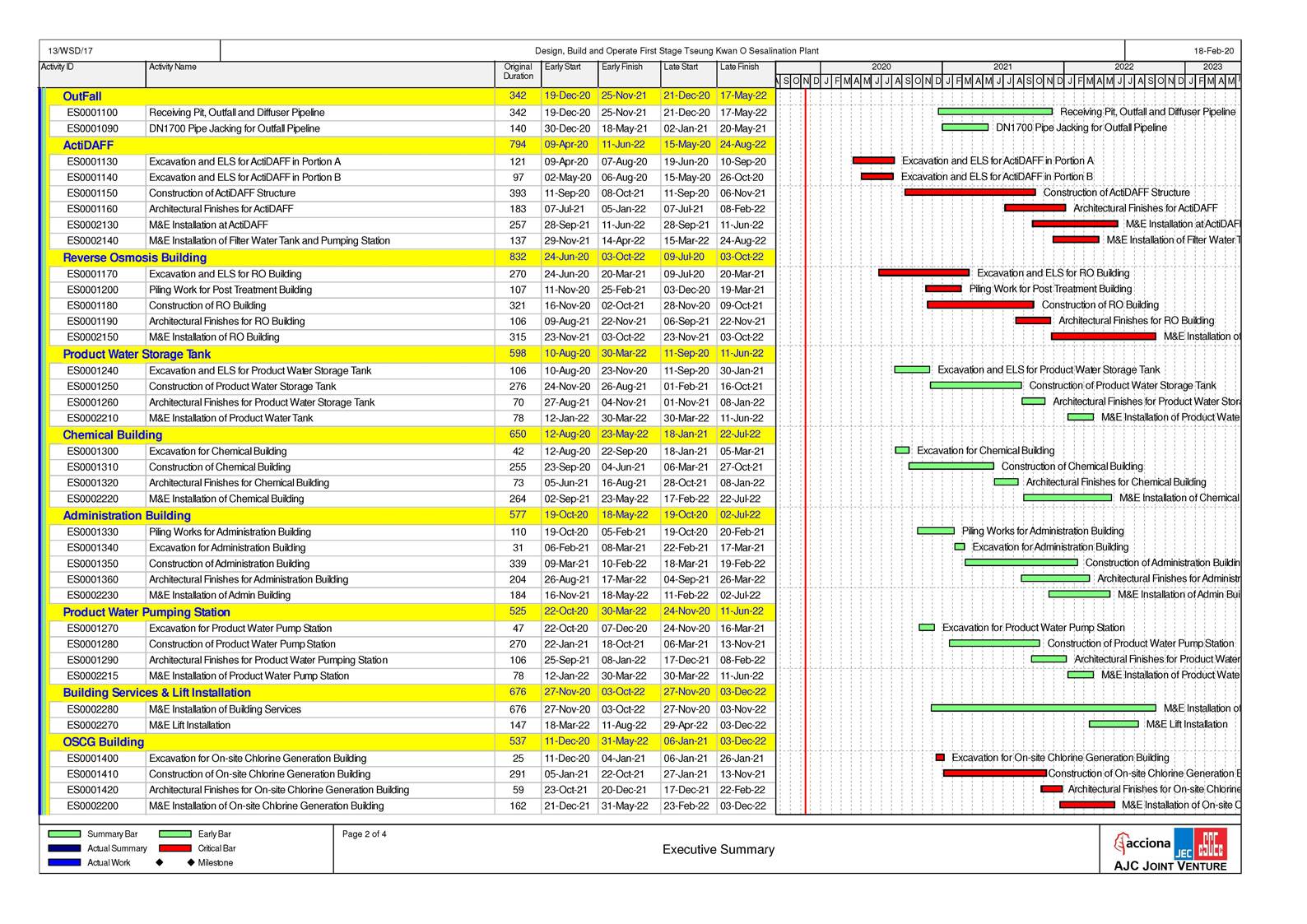

Master Programme

Overview
of Desalination Plant in Tseung Kwan O

Appendix C
Summary of
Implementation Status of Environmental Mitigation
| EIA
  Reference | Recommended
  Environmental Protection Measures/
  Mitigation Measures | Objectives of the recommended
  measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
| Air Quality |  | |||||||
| S4.8.1 | Impervious dust
  screen or sheeting will be provided to enclose scaffolding from the ground
  floor level of building for construction of superstructure of the new
  buildings. | Land site/ During
  Construction | Contractor(s) |  | ü |  | N/A | Air Pollution
  Control (Construction Dust) |
| S4.8.1 | Impervious sheet
  will be provided for skip hoist for material transport. | Land site/ During
  Construction, particularly dry season | Contractor(s) |  | ü |  | NA |  |
| S4.8.1 | The area where
  dusty work takes place should be sprayed with water or a dust suppression
  chemical immediately prior to, during and immediately after dusty activities
  as far as practicable. | Land site/ During
  Construction | Contractor(s) |  | ü |  | Implemented |  |
| S4.8.1 | All dusty
  materials should be sprayed with water
  or a dust suppression chemical immediately prior to any loading, unloading or
  transfer operation. | Land site/ During
  Construction | Contractor(s) |  | ü |  | Implemented |  |
| S4.8.1 | Dropping heights for excavated materials should be
  controlled to a practical height to minimise the
  fugitive dust arising from unloading. | Land site/ During
  Construction | Contractor(s) |  | ü |  | N/A |  |
| S4.8.1 | During transportation by truck, materials should not be
  loaded to a level higher than the side and tail boards, and should be
  dampened or covered before transport. | Land site/ During Construction | Contractor(s) |  | ü |  | N/A |  |
| S4.8.1 | Wheel washing
  device should be provided at the exits of the work sites. Immediately before
  leaving a construction site, every vehicle shall be washed to remove any
  dusty material from its body and wheels as far as practicable. | Land site/ During
  Construction | Contractor(s) |  | ü |  | N/A |  |
| EIA
  Reference | Recommended
  Environmental Protection Measures/
  Mitigation Measures | Objectives of the recommended
  measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
| S4.8.1 | Road sections between
  vehicle-wash areas and vehicular entrance will be paved. | Land site/ During
  Construction | Contractor(s) |  | ü |  | Implemented |  |
| S4.8.1 | Hoarding of not
  less than 2.4m high from ground level will be provided along the length of
  the Project Site boundary. | Land site/ During
  construction | Contractor(s) | ü | ü |  | N/A |  |
| S4.8.1 | Haul roads will
  be kept clear of dusty materials and will be sprayed with water so as to
  maintain the entire road surface wet at all times. | Land site/ During
  construction | Contractor(s) |  | ü |  | Implemented |  |
| S4.8.1 | Temporary stockpiles of dusty materials will be either
  covered entirely by impervious sheets or sprayed with water to maintain the
  entire surface wet all the time. | Land site/ During
  construction | Contractor(s) |  | ü |  | Implemented |  |
| S4.8.1 | Stockpiles of
  more than 20 bags of cement, dry pulverised fuel
  ash and dusty construction materials will be covered entirely by impervious
  sheeting sheltered on top and 3-sides. | Land site/ During
  construction | Contractor(s) |  | ü |  | N/A |  |
| S4.8.1 | All exposed areas will be kept wet always to minimise dust emission. | Land site/ During construction | Contractor(s) |  | ü |  | Implemented |  |
| S4.8.1 | Ultra-low-sulphur diesel (ULSD) will be used for all construction
  plant on-site, as defined as diesel fuel containing not more than 0.005% sulphur by weight) as stipulated in Environment,
  Transport and Works Bureau Technical Circular (ETWB-TC(W)) No 19/2005 on
  Environmental Management on Construction Sites. | Land site/ During
  construction/ During Operation | Contractor(s) |  | ü | ü | Implemented | Environment,
  Transport and Works Bureau Technical Circular (ETWB- TC(W)) No 19/2005 on Environmental Management on Construction Sites |
| EIA
  Reference | Recommended
  Environmental Protection Measures/
  Mitigation Measures | Objectives of the recommended
  measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
| S4.8.1 | The engine of the
  construction equipment during idling will be switched off. | Land site/ During
  construction | Contractor(s) |  | ü |  | Implemented |  |
| S4.8.1 | Concrete batching
  plant will be required on site. control measures recommended in the Guidance
  Note on a Best Practicable Means for Cement Works (Concrete Batching Plant)
  (BPM 3/2 (93)) will be implemented. The control measures recommended in the
  Guidance Note on a Best Practicable Means for Cement Works (Concrete Batching
  Plant) (BPM 3/2 (93)) will be | Land site/ During
  construction | Contractor(s) |  | ü |  | N/A | Guidance
  Note on a Best |
| S4.8.1 | Regular maintenance of construction equipment deployed
  on-site will be conducted to prevent black smoke emission. | Land site/ During construction | Contractor(s) |  | ü |  | Implemented |  |
| S4.10 | To ensure proper
  implementation of the recommended dust mitigation measures and good
  construction site practices during the construction phase, environmental site
  audits on weekly basis is recommended throughout the construction period. | Land site/ During
  construction | Contractor(s)/ Environmental Team (ET) & Independent Environmental Checker (IEC) |  | ü |  | Implemented |  |
Note: D - Design stage C - Construction O - Operation
| EIA
  Reference | Recommended
  Environmental Protection Measures/
  Mitigation Measures | Objectives of the recommended
  measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||

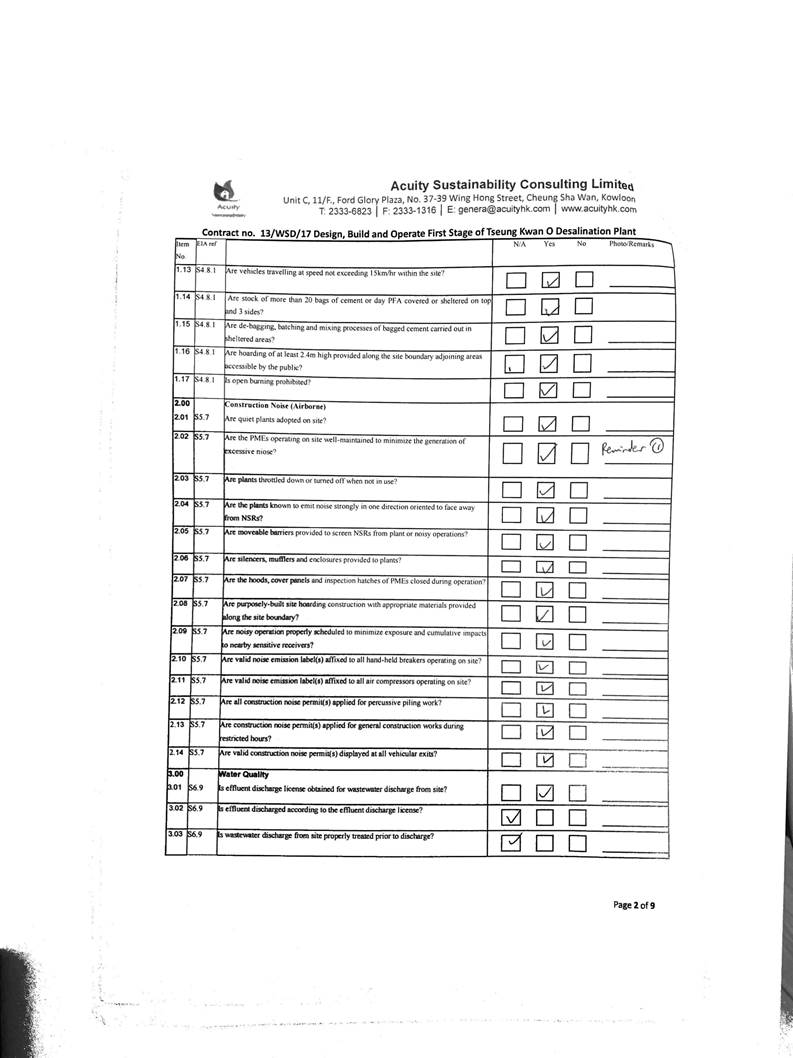

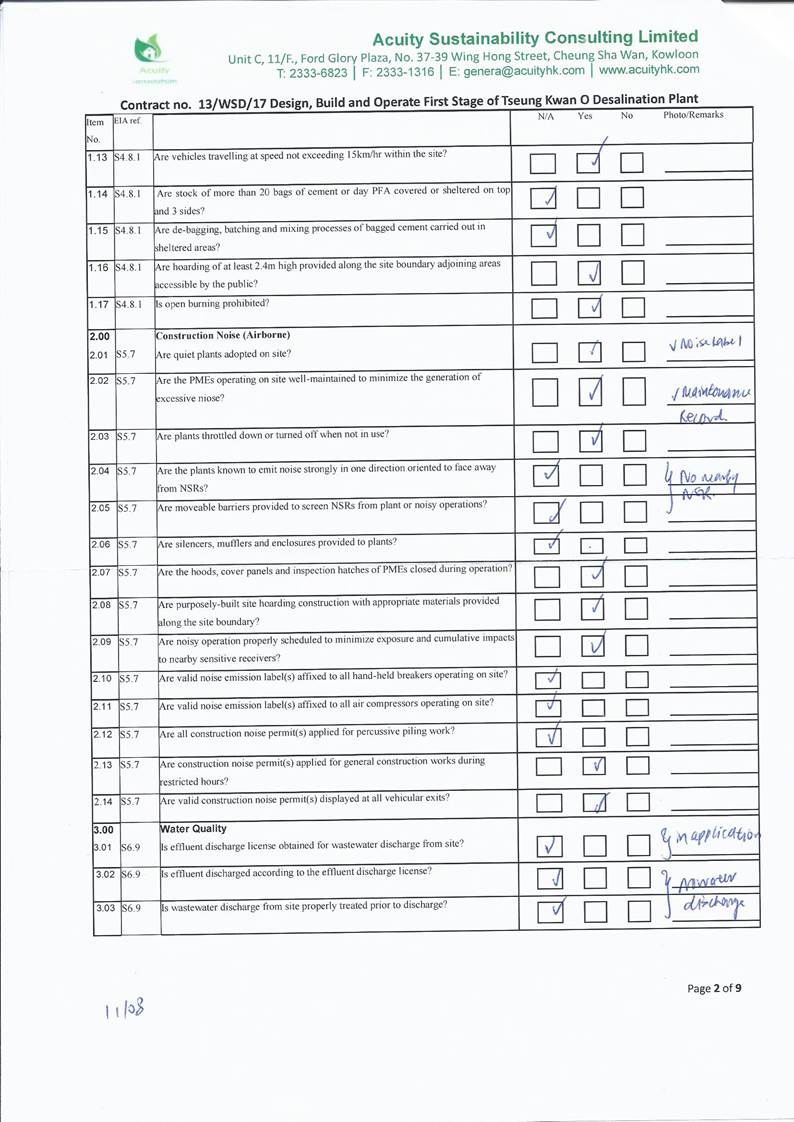

| Noise | ||||||||
| S5.7 | Only
  well-maintained plant will
  be operated on- site and plant will be serviced
  regularly during the construction phase. | All
  area/ During construction | Contractor(s) |  | ü |  | Implemented | A Practical Guide for the Reduction of
  Noise from Construction Works, |
| S5.7 | Silencers or
  mufflers on construction equipment will be utilised
  and will be properly maintained during the construction phase. | Noise control/
  During construction | Contractor(s) |  | ü |  | N/A | A Practical Guide for the Reduction of
  Noise from Construction Works, |
| S5.7 | Mobile plant, if
  any, will be sited as far away from NSRs as possible. | Noise control/
  During construction | Contractor(s) |  | ü |  | Implemented | A Practical Guide
  for the Reduction of Noise from Construction Works, |
| S5.7 | Machines and
  plant (such as trucks) that may be in intermittent use will be shut down between
  work periods or will be throttled down to a minimum. | Noise control/
  During construction | Contractor(s) |  | ü |  | Implemented | A Practical Guide
  for the Reduction of Noise from              Construction Works, |
| S5.7 | Plants known to
  emit noise strongly in one direction will, wherever possible, be orientated so
  that the noise is directed away from the nearby NSRs. | Noise control/
  During construction | Contractor(s) |  | ü |  | N/A | A Practical Guide
  for the Reduction of Noise from              Construction Works, |
| S5.7 | Material
  stockpiles and other structures will be effectively utilised,
  wherever practicable, in screening
  noise from on-site construction activities. | Noise control/
  During construction | Contractor(s) |  | ü |  | N/A | A Practical Guide
  for the Reduction of Noise from              Construction Works, |
| S5.7 | Use
  of Quite Powered Mechanical Equipment (QPME). | Noise
  control/ During construction | Contractor(s) |  | ü |  | Implemented | A Practical Guide for the Reduction of Noise from Construction Works, |
| S5.7 | Movable noise
  barriers of 3m in height with skid
  footing should be used and located within a
  few metres
  of stationary plant
  and mobile plant
  such that the line of sight to the NSR is blocked by the barriers. The length of the barrier should be at least
  five times greater than its height. The noise
  barrier material should have a superficial | Noise control/ During construction | Contractor(s) |  | ü |  | N/A | A
  Practical Guide for the Reduction of Noise from Construction Works, |
| EIA
  Reference | Recommended
  Environmental Protection Measures/
  Mitigation Measures | Objectives of the recommended
  measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
|  | surface
  density of at least 7 kg m-2 and have no openings or gaps. |  |  |  |  |  |  |  |
| S5.7 | The
  noise insulating sheet
  should be deployed such that there would be no
  opening or gaps on the joints. | Noise control/
  During construction | Contractor(s) |  | ü |  | N/A | A Practical Guide for the Reduction of
  Noise from Construction Works, |
| S5.7 | Construction activities (e.g. excavation/shoring,
  reinstatement (asphalt), and
  pipe jacking) will
  be planned and carried out
  in sequence, such that items of PME proposed for these activities will not be operated
  simultaneously. | Noise control/ During construction | Contractor(s) |  | ü |  | Implemented | A
  Practical Guide for the Reduction of Noise from Construction Works |
| S5.7 | PMEs will not be
  used at the works areas near educational institutions with residual impact (ie the ¡§influence area¡¨ within a radius of 40m) during
  school hours in order to reduce impact to the
  educational institutions. | Noise control / During construction | Contractor(s) |  | ü |  | Implemented | A Practical Guide for the Reduction of Noise from
  Construction Works |
| S5.7 | Noise enclosures
  or acoustic sheds would be used to cover stationary PME such as generators. Portable/Movable noise enclosure made of material with superficial
  surface density of at least 7 kg m-2 may be used for screening the noise from operation of
  the saw/groover, concrete. | Noise
  control/ Pre-
  construction/ During construction | Contractor(s) | ü | ü |  | N/A |  |
| S5.9 | Sawcutting pavement,
  breaking up of pavement, excavation /shoring, pipe laying, backfilling,
  reinstatement (concrete) and pipe
  jacking shall be scheduled outside the examination period. | Noise
  control/ Pre-
  construction/ During construction | Contractor(s) | ü | ü |  | N/A |  |
| EIA
  Reference | Recommended
  Environmental Protection Measures/
  Mitigation Measures | Objectives of the recommended
  measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
| S5.9 | In view the
  duration of noise exceedance at Creative Secondary School, PLK Laws
  Foundation College, TKO Kei Tak Primary School and
  School of Continuing and Professional Studies-CUHK is limited to 8 weeks, the
  construction work in the influence areas near the four schools shall be
  scheduled during long
  school holidays (eg summer holiday, Easter holiday or
  Christmas holiday, etc)
  as far as practicable. Scheduling the construction work for the four schools. | Noise control/ Pre- construction/ During construction | Contractor(s) | ü | ü |  | N/A |  |
| S5.10 | A noise
  monitoring programme shall be implemented for the
  construction phase. | Designated
  monitoring stations as defined in EM&A Manual/During construction phase | Environmental Team (ET) |  | ü |  | Implemented |  |
| S5.10 | The effectiveness
  of on-site control measures could also be evaluated through the regular site
  audits. | All facilities/
  During construction | Contractor(s)/ Environmental Team (ET) & Independent Environmental
  Checker (IEC) |  | ü |  | Implemented | - |
Note: D - Design stage C - Construction O - Operation
| EIA
  Reference | Recommended
  Environmental Protection Measures/
  Mitigation Measures | Objectives of the recommende measures & main concerns to address | Implementatio n Agent | Implementation Stage | Implementation status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||

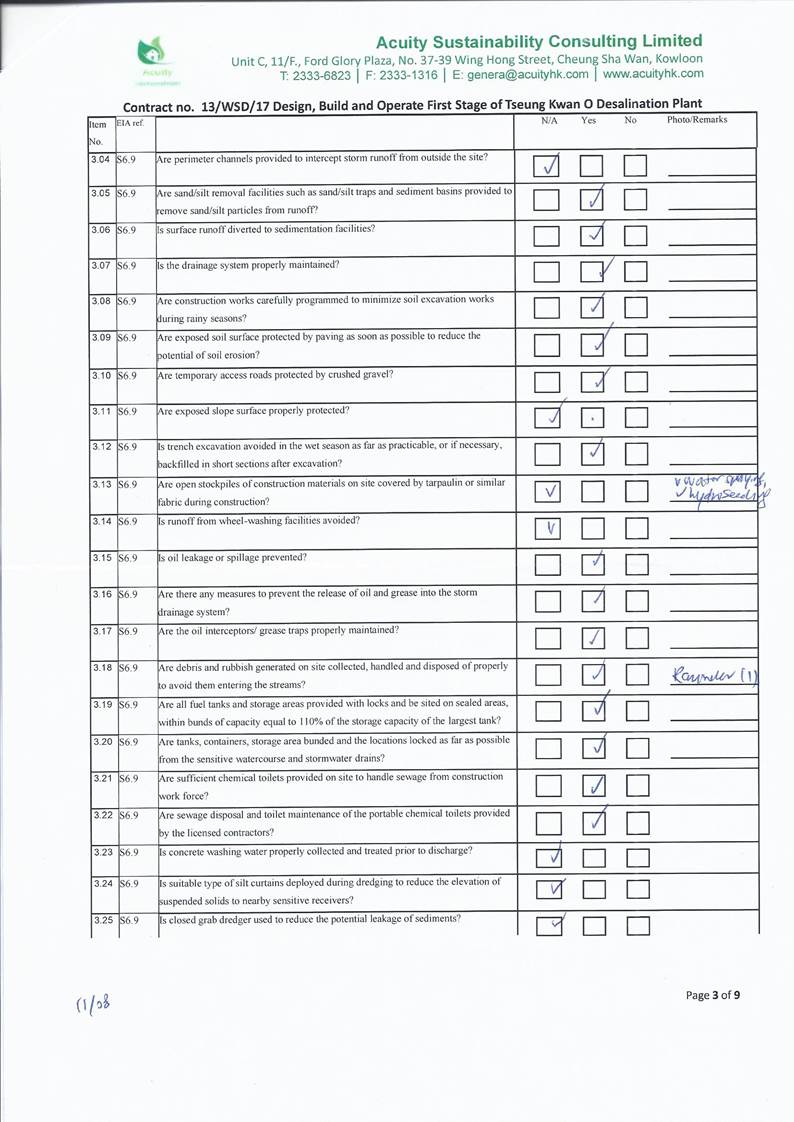

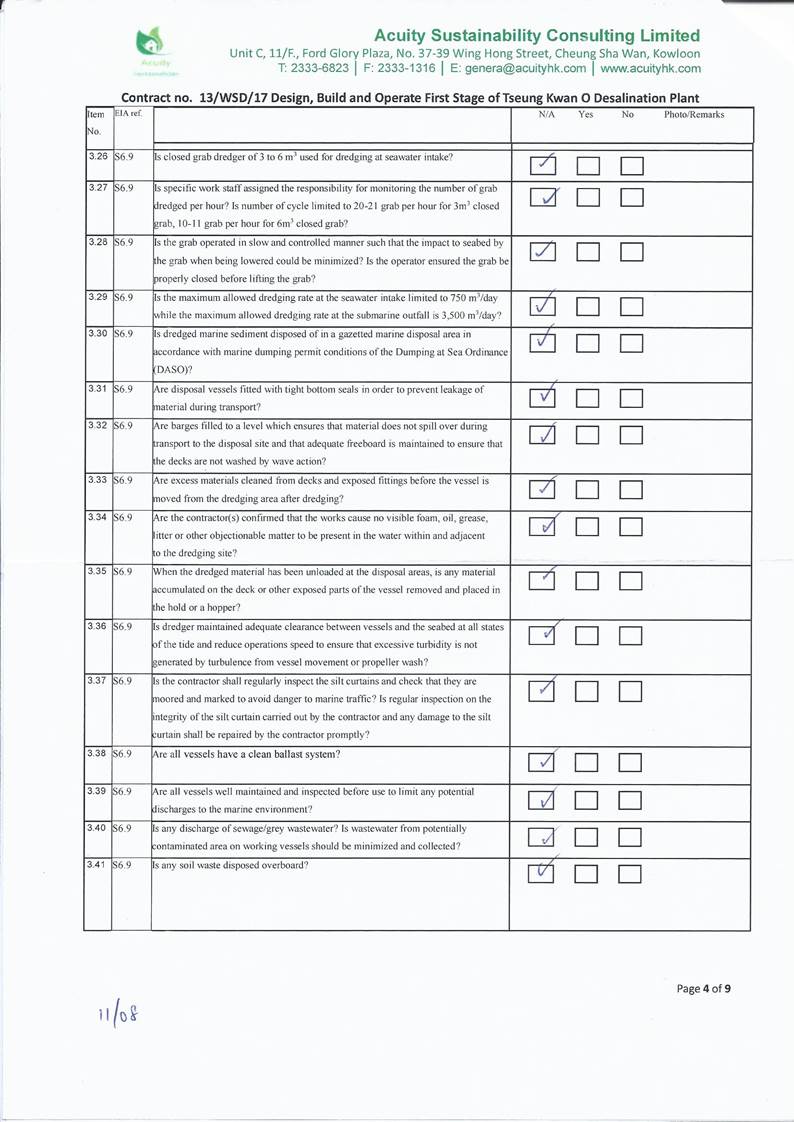

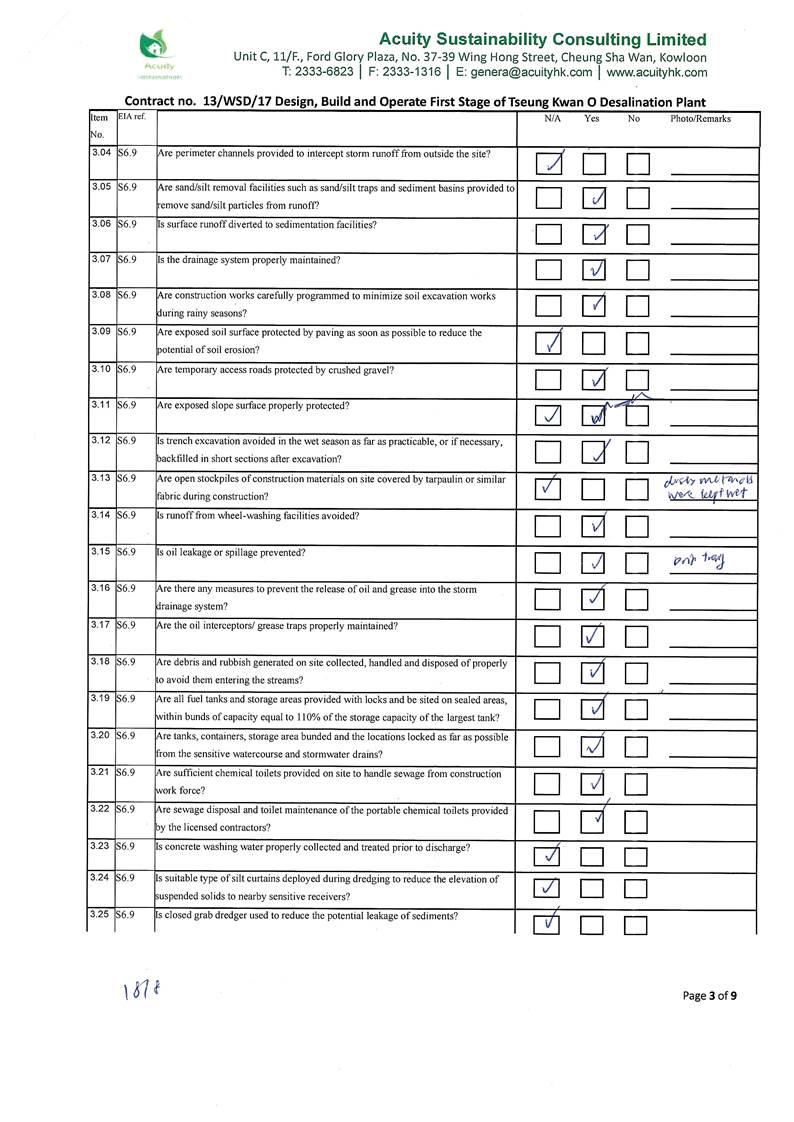

| Water Quality | ||||||||

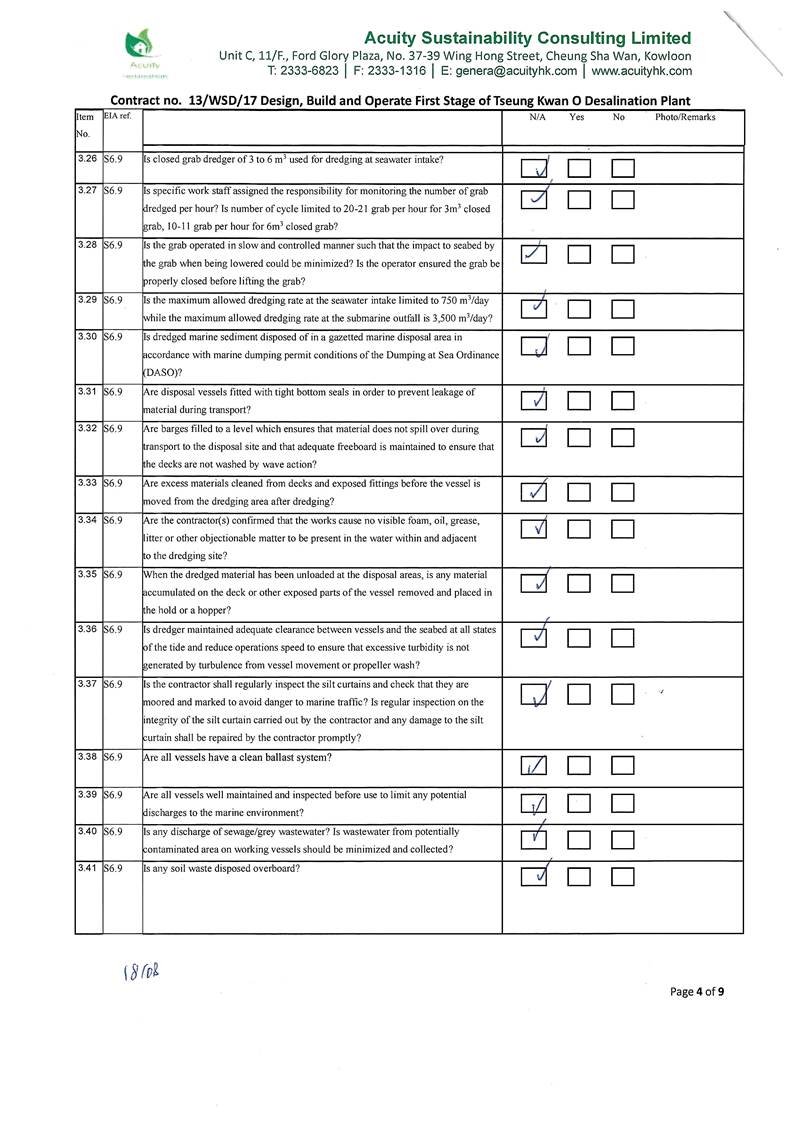

| S6.9 | Dredged marine
  sediment will be disposed of in a gazetted marine
  disposal area in accordance with marine dumping permit conditions of the
  Dumping at Sea Ordinance (DASO). | Marine Dredging/
  During construction | Contractor(s) |  | ü |  | N/A | Dumping at Sea
  Ordinance (DASO) |
| S6.9 | Disposal vessels
  will be fitted with tight bottom seals in order to prevent leakage of
  material during transport. | Marine Dredging/
  During construction | Contractor(s) |  | ü |  | N/A | - |
| S6.9 | Barges will be
  filled to a level, which ensures that material does not spill over during
  transport to the disposal site and that adequate freeboard is maintained to
  ensure that the decks are not washed by wave action. | Marine Dredging/
  During construction | Contractor(s) |  | ü |  | N/A | - |
| S6.9 | After dredging, any excess materials
  will be cleaned from decks and exposed fittings before the vessel is moved from the dredging area. | Marine Dredging/
  During construction | Contractor(s) |  | ü |  | N/A | - |
| S6.9 | All vessels
  should be well maintained and inspected before use to limit any potential
  discharges to the marine environment. | Marine Dredging/
  During construction | Contractor(s) |  | ü |  | N/A | - |
| S6.9 | All
  vessels must have a clean ballast system. | Marine Dredging/ During construction | Contractor(s) |  | ü |  | N/A | - |
| S6.9 | No
  discharge of sewage/grey wastewater should be allowed. Waste water from
  potentially contaminated area on working vessels should be minimized and
  collected.                                These
  kinds of wastewater should be brought
  back to port and discharged at appropriate collection and treatment system. | Marine Dredging/
  During construction | Contractor(s) |  | ü |  | N/A | - |
| S6.9 | No
  soil waste is allowed to be disposed overboard. | Marine Dredging/
  During construction | Contractor(s) |  | ü |  | N/A | - |
| EIA
  Reference | Recommended
  Environmental Protection Measures/
  Mitigation Measures | Objectives of the recommende measures & main concerns to address | Implementatio n Agent | Implementation Stage | Implementation status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
| S6.9 | Silt removal
  facilities such as silt traps or sedimentation facilities will be provided to remove
  silt particles from runoff to meet the requirements of the TM standard under
  the WPCO.      The
  design of silt removal facilities will be based on the guidelines provided in
  ProPECC PN 1/94.                All
  drainage facilities and erosion and sediment control structures will be
  inspected on a regular basis and maintained to confirm proper and efficient
  operation at all times and particularly during rainstorms.                Deposited
  silt and grit will be removed regularly. | Land site &
  drainage/ During construction | Contractor(s) |  | ü |  | Implemented | ProPECC
  PN 1/94 TM Standard under the WPCO |
| S6.9 | Earthworks to
  form the final surfaces will be followed up with surface protection and
  drainage works to prevent erosion caused by rainstorms. | Land site &
  drainage/ During construction | Contractor(s) |  | ü |  | Implemented | - |
| S6.9 | Appropriate surface drainage will be designed and
  provided where necessary. | Land site & drainage/ During construction | Contractor(s) |  | ü |  | N/A | - |
| S6.9 | The precautions
  to be taken at any time of year when rainstorms are likely together with the
  actions to be taken when a rainstorm is imminent or forecasted and actions to
  be taken during or after rainstorms are summarised
  in Appendix A2 of ProPECC PN 1/94. | Land site &
  drainage/ During construction | Contractor(s) |  | ü |  | Implemented | ProPECC
  PN 1/94 |
| S6.9 | Oil interceptors
  will be provided in the drainage system where necessary and regularly emptied
  to prevent the release of oil and grease into the storm water drainage system
  after accidental spillages. | Land site & drainage/ During construction | Contractor(s) |  | ü |  | Implemented | - |
| S6.9 | Temporary and
  permanent drainage pipes and culverts provided to facilitate runoff
  discharge, if any, will be adequately designed for the controlled release of
  storm flows. | Land site & drainage/ During construction | Contractor(s) |  | ü |  | N/A | - |
| EIA
  Reference | Recommended
  Environmental Protection Measures/
  Mitigation Measures | Objectives of the recommende measures & main concerns to address | Implementatio n Agent | Implementation Stage | Implementation status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
| S6.9 | The temporary diverted drainage, if any, will be
  reinstated to the original condition when the construction work has finished
  or when the temporary diversion is no longer required. | Land site & drainage/ During construction | Contractor(s) |  | ü |  | N/A | - |
| S6.9 | Appropriate numbers of portable
  toilets shall be provided by a licensed contractor to serve the
  construction workers over the construction site to prevent direct disposal of
  sewage into the water environment. | Land site & drainage/ During construction | Contractor(s) |  | ü |  | Implemented | - |
| S6.9
  and S6.12 | The sterilization
  water should be dechlorinated with total residual chlorine (TRC) level below 1 mg/L before discharge to
  public sewer. In situ testing of TRC should also be conducted for the
  discharge of chlorinated water for pipeline disinfection to ensure sufficient
  dechlorination before discharge to public sewer. | Sterilization
  of water mains prior to commissioning | Contractor(s) |  | ü | ü | N/A | Technical
  Memorandum for Effluents Discharged into Drainage and Sewerage Systems Inland
  and Coastal Waters |
| S6.9 | The cleaning and
  flushing water should also be treated and desilted to the relevant discharge
  requirement stipulated in TM-DSS before discharging. | Sterilization
  of water mains prior to commissioning | Contractor(s) |  | ü | ü | N/A | Technical
  Memorandum for Effluents Discharged into Drainage and Sewerage Systems Inland
  and Coastal Waters |
| S6.9 | Site drainage
  should be well maintained and good construction practices should be observed
  to ensure that oil, fuels, solvents and other chemicals are managed, stored
  and handled
  properly and do not enter the nearby water streams. | Land
  site & drainage/ During construction/ During operation | Contractor(s) |  | ü | ü | Implemented | - |
| EIA
  Reference | Recommended
  Environmental Protection Measures/
  Mitigation Measures | Objectives of the recommende measures & main concerns to address | Implementatio n Agent | Implementation Stage | Implementation status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
| S6.12 | Regular site
  inspections will be carried out in order to confirm that regulatory
  requirements are being met and that contractors are implementing the standard
  site practice and mitigation measures as proposed to reduce potential impacts
  to water quality. | During
  construction | Contractor(s)/
  Environmental Team (ET) & Independent Environmental
  Checker (IEC) |  | ü |  | Implemented | - |
Note: D - Design stage C - Construction O - Operation
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
| Waste Management | ||||||||
| S8.5 | Nomination of approved personnel to be responsible for
  standard site practices, arrangements for collection and effective disposal
  to an appropriate facility of all wastes generated at the
  site. | Contract mobilisation/ During
  construction | Contractor(s) |  | ü |  | Implemented | - |
| S8.5 | Training of site
  personnel in proper waste management and chemical handling procedures.
  Training will be provided to workers on the concepts of site cleanliness and
  appropriate waste management procedures, including waste reduction, reuse and
  recycling at the beginning of
  the construction works. | Contract mobilisation/ During construction | Contractor(s) |  | ü |  | Implemented | - |
| S8.5 | Provision of
  sufficient waste disposal points and regular collection for disposal. | All area/
  During construction/ During operation | Contractor(s) |  | ü | ü | Implemented | DEVB TC(W)
  No. 8/2010, Enhanced Specification for Site Cleanliness and Tidiness. |
| S8.5 | Appropriate
  measures to reduce windblown litter and         dust
  transportation of waste by either covering
  trucks or by transporting wastes in enclosed containers. | All area/ During construction | Contractor(s) |  | ü |  | Implemented | DEVB TC(W)
  No. 8/2010, Enhanced Specification for Site Cleanliness and Tidiness. |
| S8.5 | A
  waste management plan (WMP) as stated in   the ¡§ETWB TC(W) No.
  19/2005, Environmental Management on Construction Sites¡¨                          for
  the amount of waste
  generated, recycled and disposed of (including the disposal
  sites) will be established and implemented during the construction phase as
  part of the Environmental Management Plan (EMP).                          The
  Contractor will be required to prepare the EMP and submits it to the
  Architect/ Engineer under the Contract for approval
  prior to implementation. | All area/ During construction | Contractor(s) |  | ü |  | Implemented | ETWB TC(W) No.
  19/2005, Environmental Management on Construction Sites |
| S8.5 | Separation of chemical wastes for special handling and
  appropriate treatment at the Chemical Waste Treatment Centre at Tsing Yi. | All area/ During construction | Contractor(s) |  | ü |  | N/A | Chapters 2 & 3 Code of Practice on the Packaging Labelling
  & Storage of Chemical Wastes publishe |
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
|  |  |  |  |  |  |  |  | under the Waste
  Disposal Ordinance (Cap 354), Section
  35 |
| S8.5 | Regular
  cleaning and maintenance programme for drainage systems, sumps and oil interceptors. | Land site/ During construction | Contractor(s) |  | ü |  | Implemented | Waste Disposal Ordinance (Cap 354) |
| S8.5 | A recording system for the amount of wastes generated/
  recycled and disposal sites.                                    The
  trip- ticket system will be included as one of the contractual requirements and implemented by the contractor(s). | Land site/ During construction | Contractor(s) |  | ü |  | Implemented | DEVB TC(W)
  No. 6/2010, Trip Ticket System for Disposal of Construction &
  Demolition Materials |
| S8.5 | Segregation and
  storage of different types of waste in different containers, skips or
  stockpiles to enhance reuse or recycling of material
  and their proper disposal. | Land site/ During construction/ During operation | Contractor(s) |  | ü |  | Implemented | WBTC 32/92, The
  Use of Tropical Hard Wood on Construction Site |
| S8.5 | Encourage
  collection of aluminium cans and waste paper by
  individual collectors during construction with separate labelled bins
  provided to segregate these wastes from other general refuse by the
  workforce. | Land site/ During
  construction | Contractor(s) |  | ü |  | Implemented | ETWB TCW No.
  33/2002, Management of Construction and Demolition Material
  Including Rock |
| S8.5 | Any unused
  chemicals and those with remaining functional capacity will be recycled as
  far as possible. | Land site/ During
  construction | Contractor(s) |  | ü |  | N/A | - |
| S8.5 | Use of reusable non-timber formwork to reduce the amount
  of C&D materials. | All areas/ During construction | Contractor(s) |  | ü |  | N/A | WBTC
  32/92, The Use of Tropical Hard Wood on Construction Site |
| S8.5 | Prior to disposal of construction waste, wood, steel and
  other metals will be separated to the extent practical, for re-use and/or
  recycling to reduce the quantity of waste to be disposed of to
  landfill. | All areas/ During construction | Contractor(s) |  | ü |  | Implemented | DEVB TC(W)
  No. 6/2010, Trip Ticket System for Disposal of Construction &
  Demolition Materials |
| S8.5 | Proper
  storage and site practices to reduce the potential for damage or
  contamination of construction materials. | All areas/ During construction | Contractor(s) |  | ü |  | Implemented, rectified after observation | - |
| S8.5 | Plan
  and stock construction materials | All areas/ During construction | Contractor(s) |  | ü |  | Implemented | - |
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
|  | carefully
  to reduce amount of waste generated and avoid unnecessary generation of
  waste. |  |  |  |  |  |  |  |
| S8.5 | A Sediment
  Quality Report (SQR) for sampling and chemical testing of the sediment will
  be prepared and submitted to the EPD for approval. The approved detailed
  sampling and chemical testing will be carried out prior to the commencement
  of the dredging activities to confirm the sediment disposal method. | Marine works/
  During construction | Contractor(s) |  | ü |  | N/A | ETWB TC(W) No.
  34/2002 and Dumping at
  Sea Ordinance (DASO) |
| S8.5 | The
  management of dredged/ excavated sediment management requirement from ETWB TC(W) No. 34/2002
  will be incorporated in the Specification of the Contract Documents. | Marine works/
  During construction | WSD/ Contractor(s) |  | ü |  | Implemented | ETWB
  TC(W) No. 34/2002 and
  Dumping at Sea Ordinance (DASO) |
| S8.5 | The contractor will open a billing account with EPD in
  accordance with the Waste Disposal (Charges for Disposal of Construction
  Waste) Regulation for the payment of disposal charges. | Contract mobilisation/ During
  construction | Contractor(s) |  | ü |  | Implemented | Cap 354N Waste Disposal (Charges for Disposal of
  Construction Waste) Regulation |
| S8.5 | A trip-ticket
  system will be established in accordance with DEVB TC(W) No. 6/2010 to
  monitor the reuse of surplus excavated materials off-site and disposal of
  construction waste and general refuse at transfer facilities/ landfills, and to
  control fly-tipping. | Contract mobilisation/ During construction | Contractor(s) |  | ü |  | Implemented | DEVB TC(W)
  No. 6/2010, Trip Ticket System for Disposal of Construction &
  Demolition Materials |
| S8.5 | The project proponent will also conduct regular
  inspection of the waste management measures implemented on site as described
  in the Waste Management Plan. | All area/ During construction | Contractor(s )/      Environment al Team (ET) &
  Independent Environment al Checker (IEC) |  | ü |  | Implemented | ETWB TC(W) No.
  19/2005, Environmental
  Management on Construction Sites |
| S8.5 | A recording system (similar to summary table as shown in Annex 5 and Annex 6 of | All area/ During construction | Contractor(s) |  | ü |  | Implemented | Annex
  5 and Annex 6 of Appendix G of |
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
|  | Appendix G of
  ETWB TC(W) No. 19/2005) for the amount of waste generated, recycled and
  disposed of (including the disposal sites) will be
  established during the construction phase. |  |  |  |  |  |  | ETWB TC(W) No.
  19/2005 |
| S8.5 | Inert
  C&D materials (public fill) will be reused within the Project as far as
  practicable. | All area/ During construction | Contractor(s) |  | ü |  | N/A | - |
| S8.5 | Public
  fill and construction waste shall be segregated and stored in different
  containers or skips to facilitate reuse or recycling of materials and their
  proper disposal. | All area/ During construction | Contractor(s) |  | ü |  | N/A | - |
| S8.5 | Specific areas of the work
  site will be designated
  for such segregation and storage if immediate use is not practicable. | All area/ During construction | Contractor(s) |  | ü |  | N/A | - |
| S8.5 | To reduce the
  potential dust and water quality impacts of site formation works, C&D
  materials will be wetted as quickly as possible to the extent
  practice after filling. | All area/ During construction | Contractor(s) |  | ü |  | Implemented | Air Pollution
  Control (Construction Dust) Regulation (Cap 311R); WPCO
  (Cap 358) |
| S8.5 | Open
  stockpiles of excavated/ fill materials or construction wastes on-site should
  be covered with tarpaulin or similar fabric. | Land site/ During Construction, particularly dry season | Contractor(s) |  | ü |  | Implemented | Air Pollution
  Control (Construction Dust) Regulation (Cap 311R) |
| S8.5 | Chemical waste
  container shall be suitable for the substance they are holding, resistant to
  corrosion, maintained in a good condition, and securely closed. | All area/ During construction/ During operation | Contractor(s)/ WSD |  | ü | ü | NA | Waste Disposal
  (Chemical Waste) (General) Regulation; Code of Practice on the Packaging,
  Handling and Storage of Chemical Wastes |
| S8.5 | Chemical waste
  container shall have a capacity of less than 450 L unless the specifications
  have been approved by the EPD. | All area/ During construction/ During operation | Contractor(s)/ WSD |  | ü | ü | NA | Waste Disposal
  (Chemical Waste) (General) Regulation; Code of Practice on the Packaging,
  Handling and Storage
  of Chemical Wastes |
| S8.5 | A
  label in English and Chinese shall be displayed on the chemical container in
  accordance with | All area/ During construction/ During | Contractor(s)/ WSD |  | ü | ü | NA | Waste
  Disposal (Chemical Waste) |
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
|  | instructions
  prescribed in Schedule 2 of the Regulations. | operation |  |  |  |  |  | (General)
  Regulation; Code of Practice on the Packaging, Handling and Storage of
  Chemical Wastes |
| S8.5 | Storage areas for
  chemical waste shall be enclosed on at least 3 sides. | All area/ During construction/ During operation | Contractor(s)/ WSD |  | ü | ü | Implemented | Waste Disposal
  (Chemical Waste) (General) Regulation; Code of Practice on the Packaging,
  Handling and Storage of Chemical Wastes |
| S8.5 | Storage areas for
  chemical waste shall have an impermeable floor and bunding, of capacity to
  accommodate 110% of the volume of the largest container or 20% by volume of
  the chemical waste stored in that area, whichever is the greatest. | All area/ During construction/ During operation | Contractor(s)/ WSD |  | ü | ü | Implemented | Waste Disposal
  (Chemical Waste) (General) Regulation; Code of Practice on the Packaging,
  Handling and Storage of Chemical Wastes |
| S8.5 | Storage areas for
  chemical waste shall have adequate ventilation. | All area/ During construction/ During operation | Contractor(s)/ WSD |  | ü | ü | Implemented | Waste Disposal
  (Chemical Waste) (General) Regulation; Code of Practice on the Packaging,
  Handling and Storage of Chemical Wastes |
| S8.5 | Storage areas for
  chemical waste shall be covered to prevent rainfall entering (water collected
  within the bund must be tested and disposed of as chemical waste, if
  necessary). | All area/ During
  construction/ During operation | Contractor(s)/
  WSD |  | ü | ü | Implemented | Waste Disposal
  (Chemical Waste) (General) Regulation; Code of Practice on the Packaging,
  Handling and Storage
  of Chemical Wastes |
| S8.5 | Storage areas for
  chemical waste shall be arranged so that incompatible materials are appropriately
  separated. | All area/ During construction/ During operation | Contractor(s)/ WSD |  | ü | ü | Implemented | Waste Disposal
  (Chemical Waste) (General) Regulation; |
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
|  |  |  |  |  |  |  |  | Code of Practice
  on the Packaging, Handling and Storage of Chemical Wastes |
| S8.5 | General refuse
  will be stored in enclosed bins or compaction units separately from
  construction and chemical wastes. | All area/ During construction/ During operation | Contractor(s)/ WSD |  | ü | ü | Implemented | Waste Disposal
  (Chemical Waste) (General) Regulation; Code of Practice on the Packaging,
  Handling and Storage of Chemical Wastes |
| S8.5 | Adequate number
  of waste containers will be provided to avoid over-spillage of waste. | All area/ During construction/ During operation | Contractor(s)/ WSD |  | ü | ü | Implemented | DEVB
  TC(W) No. 8/2010 Enhanced Specification for Site Cleanliness and Tidiness. |
| S8.5 | A reputable waste
  collector will be employed by the Contractor to remove general refuse from
  the site, separately from construction and chemical wastes, on a daily basis
  to minimise odour, pest and
  litter impacts. | All area/ During construction/ During operation | Contractor(s)/ WSD |  | ü | ü | N/A | - |
| S8.5 | Recycling bins
  will be provided at strategic locations within the Site to facilitate
  recovery of recyclable materials (including aluminium
  can, waste paper, glass bottles and plastic bottles) from the Site. Materials
  recovered will be sold for recycling. | All area/ During
  construction/ During operation | Contractor(s)/
  WSD |  | ü | ü | Implemented | - |
| S8.5 | To avoid any odour and litter
  impact, accurate number of
  portable toilets will be provided for workers on-site. | All area/ During construction | Contractor(s) |  | ü |  | Implemented | - |
| S8.5 | The
  burning of refuse on construction sites is prohibited by law. | All area/ During construction | Contractor(s) |  | ü |  | Implemented | Air
  Pollution Control Ordinance (Cap 311) |
| S8.7 | To facilitate monitoring and control over the
  contractors¡¦ performance on waste management, a waste inspection and audit programme will be implemented throughout the construction phase. | All facilities/
  During construction | ET/ IEC |  | ü |  | Implemented | - |
Note: D - Design stage C - Construction
O - Operation
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
|  | Ecology | |||||||

| S9.7 | For slope
  mitigation works within the Clear Water
  Bay Country Park, to avoid tree felling and damages to trees, the exact
  locations of the flexible barrier foundation plates, soil nails and rock
  dowels can be adjusted during detailed design, and a setback distance from
  existing trees is recommended to be maintained as far as practical. A
  detailed specification describing the exact locations of the flexible barrier
  foundation plates, soil nails and rock  dowels will be prepared to
  illustrate how the setback distance from existing trees
  would be implemented for tree
  avoidance. | Slope
  mitigation works area/ During detailed design/ During construction | Contractor(s) | ü | ü |  | Implemented | - |
| S9.7 | Pruning
  of tree canopies along the alignment of the flexible barriers shall be
  limited to a minimum. | Slope mitigation works
  area/ During construction | Contractor(s) |  | ü |  | Implemented |  |
| S9.7 | The alignment of
  flexible barriers shall be optimized to preserve all species of conservation
  interest and minimize the impact to the existing vegetation as far as practicable.                           All
  individuals of Marsdenia lachnostoma within the slope
  mitigation areas shall be retained in- situ, by positioning the alignment of flexible barrier at a
  minimum 1.5m in a radius away from these individuals. | Slope
  mitigation works area/ During detailed design/ During construction | Contractor(s) | ü | ü |  | N/A | - |
| S9.7
  and 9.10 | At the detailed
  design stage prior to the commencement of the slope mitigation works, a
  vegetation survey shall be carried out at the slope mitigation areas within
  the Clear Water Bay Country Park to assess the condition and identify the
  location of each individual of Marsdenia lachnostoma and other flora
  species of conservation interest that may be directly affected
  by the construction works. | Slope
  mitigation works area/ During detailed design/ During construction | Contractor(s) | ü | ü |  | N/A | - |
| S9.7 | Temporary
  fencing will be installed to fence off | Slope
  mitigation works | Contractor(s) |  | ü |  | N/A | - |
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
|  | the concerned
  species either in groups of individually within the works area and in the
  close proximity to prevent from being damaged and disturbed during
  construction. A sign identifying the site shall be attached to the fence and
  flagging tape shall be attached to the individuals
  to visualize their locations. | area/
  During construction |  |  |  |  |  |  |
| S9.7
  and S9.10 | A specification
  for fencing and demarcating individuals of
  Marsdenai lachnostoma (or
  other flora species of conservation
  interest, if found) adjacent to the proposed alignment of the flexible
  barriers will be prepared to protect the species. | Slope mitigation
  works area/ During construction | Contractor(s) |  | ü |  | N/A | - |
| S9.7 | Induction training shall also be provided to all site personnel in order to brief them on this flora
  of conservation
  interest including the locations and their
  importance. | Slope mitigation works
  area/ During construction | Contractor(s) |  | ü |  | N/A | - |
| S9.7 | The
  resident site supervisory staff will closely monitor the conditions of
  concerned individuals during construction of flexible barriers in the close
  proximity. | Slope mitigation
  works area/ During construction | Contractor(s) |  | ü |  | N/A | - |
| S9.7 | Erect
  fences along the boundary of the works area before the commencement of works
  to prevent vehicle movements and encroachment of personnel onto adjacent
  areas. | All
  area/ During construction | Contractor(s) |  | ü |  | Implemented | - |
| S9.7 | Regularly check
  the work site boundaries to ensure that they are not breached and that damage
  does not occur to surrounding areas. | All
  area/ During construction | Contractor(s)/ Environmental Team (ET) |  | ü |  | Implemented | - |
| S9.7 | Avoid any damage
  and disturbance, particularly those caused by filling and illegal dumping, to the surrounding habitats through proper management of
  waste disposal. | All
  area/ During construction | Contractor(s) |  | ü |  | Implemented | - |
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
| S9.7 | Reinstate temporarily affected areas, particularly the habitats of plantation
  and shrubland- grassland immediately after completion of construction works,
  through on-site tree/shrub planting. The tree/shrub  species will be chosen with reference to those in the surrounding area. | All area/ During construction | Contractor(s) |  | ü |  | N/A | - |
| S9.7 | Affected habitats within the Clear Water Bay Country Bay
  shall be reinstated by hydro-seeding and planting of climbers and native
  shrub seedlings where practical upon completion of the slope
  mitigation works. | All area/ During construction | Contractor(s) |  | ü |  | N/A | - |
Note: D - Design stage C - Construction O - Operation
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
|  | Landscape & Visual | |||||||
| S11.10 &
  11.11 | The construction area and area allowed for temporary
  structures, such as the contractor¡¦s office, will be minimized to a practical

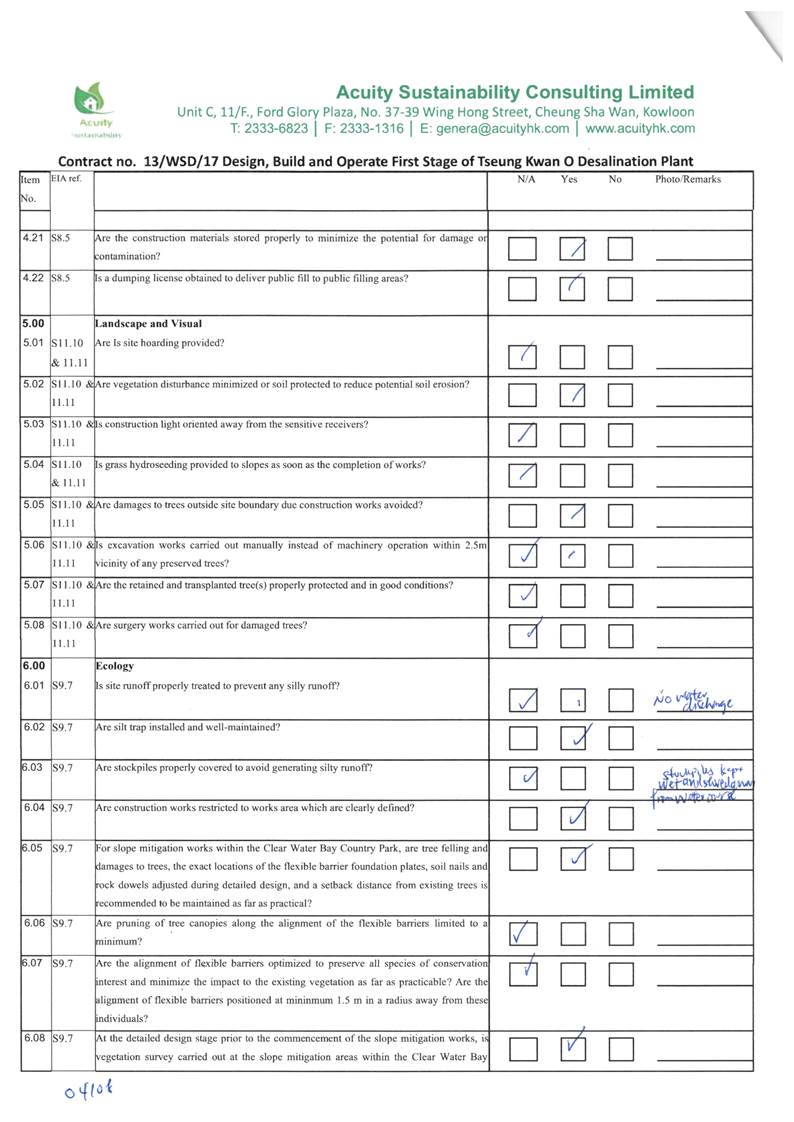

  minimum. (MM1) | All area/
  Detailed design/ During construction/ During operation | WSD/ Contractor(s) | ü | ü | ü | Implemented | - |
| S11.10 &
  11.11 | At
  the detailed design stage, the design team will seek to minimize the
  landscape footprint of the Project and above ground facilities, while
  satisfying all other requirements. (MM2) | All area/
  Detailed design/ During construction/ During operation | WSD/ Contractor(s) | ü | ü | ü | Implemented | - |
| S11.10 &
  11.11 | Design principles
  will be adopted to take into account the surrounding
  area, particularly Clear Water Bay Country Park behind and the nearby
  waterfront, with due consideration given to: -  green roofs where
  practical (ie without
  equipment on the roof); -  roadside planting; -  aesthetic
  treatment of all structures; -  vertical greening; screen
  planting along application site; and - landscape
  enhancement with amenity planting where practical including planting along
  the edge (site boundary) fence with native shrubs where feasible, - to reduce their visual impact and blend them into the surrounding landscape.                               (MM3) | All area/
  Detailed design/ During construction/ During operation | WSD/ Contractor(s) | ü | ü | ü | Implemented | - |
| S11.10 & 11.11 | All trees within the Project Site or the potential slope
  mitigation works area will be carefully protected during construction
  according to DEVB TCW No. 10/2013 - Tree Preservation (MM4) | All area/ Detailed design/ During construction/ During
  operation | WSD/ Contractor(s) | ü | ü | ü | Implemented | ETWB
  TCW No. 3/2006 - Tree Preservation. |
| S11.10 &
  11.11 | No tree within
  the Country Park will be felled. Trees within the Site unavoidably affected
  by the works will be transplanted where necessary and practical.      For trees that
  need to be felled, compensatory
  planting will be provided to the satisfaction of relevant Government
  departments. | All area/
  Detailed design/ During construction/ During operation | WSD/ Contractor(s) | ü | ü | ü | Implemented | DEVB
  TC(W) No. 10/2013 |
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
|  | A compensatory tree planting proposal including
  locations of tree compensation will be submitted to seek relevant government
  department¡¦s approval, in accordance with DEVB TC(W) No. 10/2013.      (MM5) |  |  |  |  |  |  |  |
| S11.10 &
  11.11 | Any slope
  mitigation works necessary to address natural terrain hazards, will be
  minimized to minimize any potential environmental impact to the Country Park
  e.g. soil nailing and rock stabilization will aim to avoid existing trees
  e.g. should any restoration of vegetation be necessary, the best planting
  matrix with native species will be established, with the aim of resembling the existing vegetation.                              (MM6) | All area/
  Detailed design/ During construction/ During operation | WSD/ Contractor(s) | ü | ü | ü | N/A |  |
| S11.10 & 11.11 | Dredging works
  for the installation of intake structures and outfall diffusers should be
  minimized to avoid or reduce any potential environmental impacts to as low as
  reasonably practicable (ALARP). The intake and outfall structures (e.g.
  intake openings and diffuser heads) will
  be prefabricated and
  transferred to site for installation.                           (MM7) | All area/
  Detailed design/ During construction/ During operation | WSD/ Contractor(s) | ü | ü | ü | N/A |  |
| S11.10 &
  11.11 | All night-time
  lighting will be reduced to a practical minimum both in terms of number of
  level and will be hooded and directional. (MM8)units and lux level and will be hooded and directional.
  (MM8) | All area/
  Detailed design/ During construction/ During operation | WSD/ Contractor(s) | ü | ü | ü | Implemented | - |
Note: D - Design stage C - Construction O - Operation
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
|  | Landfill Gas Hazard | |||||||

| S12.7 | During all works, safety procedures should be
  implemented to minimise the risks of fires and
  explosions, asphyxiation of workers and toxicity effects resulting from
  contact with contaminated soil
  and groundwater. | All area/ Detailed design/ During construction/ During
  operation | Contractor(s) | ü | ü | ü | Implemented | - |
| S12.7 | During trenching
  and excavation as well as creation of confined spaces at near to or below
  ground level, precautions should be clearly laid down and rigidly Gas
  detection equipment and appropriate breathing apparatus should be available
  and used when entering confined spaces
  or trenches deeper than 1 metre. | All area/ Detailed
  design/ During construction/ During operation | Contractor(s) | ü | ü | ü | Implemented |  |
| S12.7 | The Contractor
  should make the workers are aware of potential hazards of working in confined
  spaces (any chamber, manhole or culvert
  which is large enough to permit access to
  personnel).                         Such
  work in confined spaces is controlled by the Factories and Industrial
  Undertakings (Confined Spaces) Regulations of
  the Factories and Industrial Undertakings Ordinance. Following the
  Safety Guide to Working in Confined Spaces ensures compliance with the above
  regulations. | All area/
  Detailed design/ During construction/ During operation | Contractor(s) | ü | ü | ü | Implemented |  |
| S12.7 | Safety officers, specifically trained with regard to
  landfill gas and leachate related hazards and the appropriate actions to take
  in adverse circumstances, should be present on the site throughout the works,
  in particular, when works are undertaken
  below grade. | All area/ Detailed design/ During construction/ During
  operation | Contractor(s) | ü | ü | ü | Implemented |  |
| S12.7 | All personnel who
  work on site and all visitors to the site should be made aware of the
  possibility of       ignition
  of gas in the vicinity of the works, the possible presence of contaminated
  water and the
  need to avoid physical contact with it. | All area/
  Detailed design/ During construction/ During operation | Contractor(s) | ü | ü | ü | Implemented |  |
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||

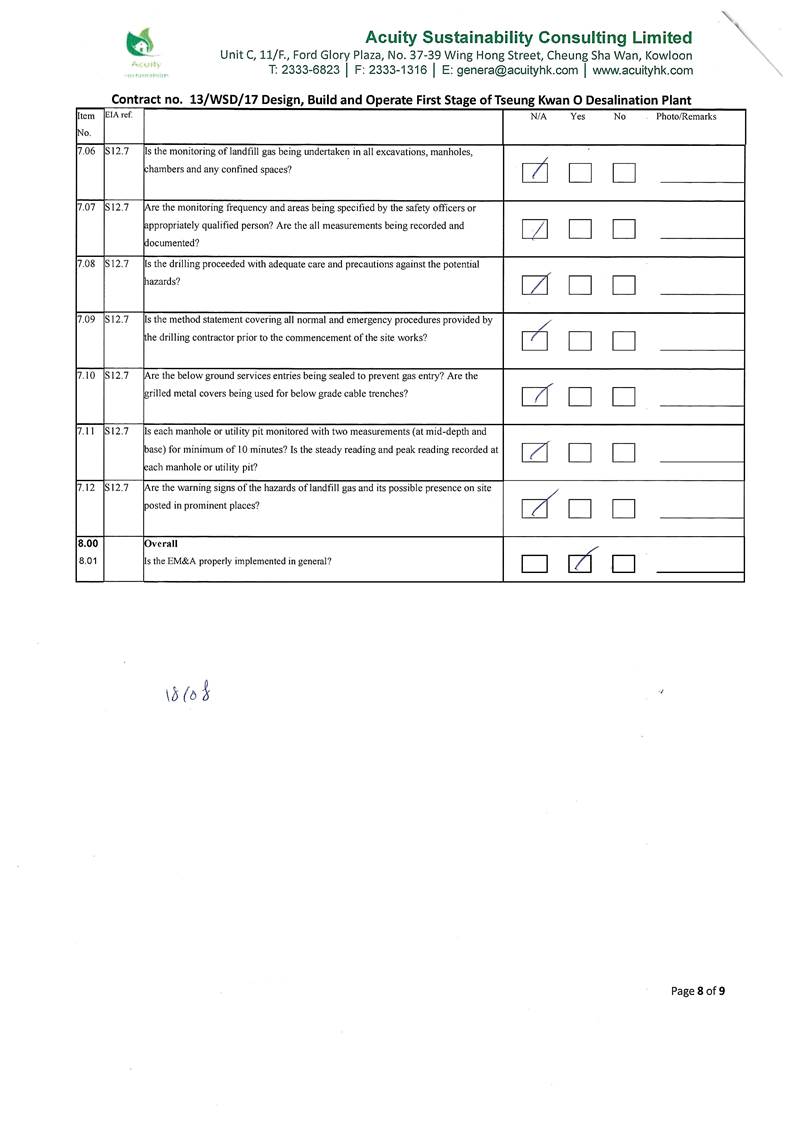

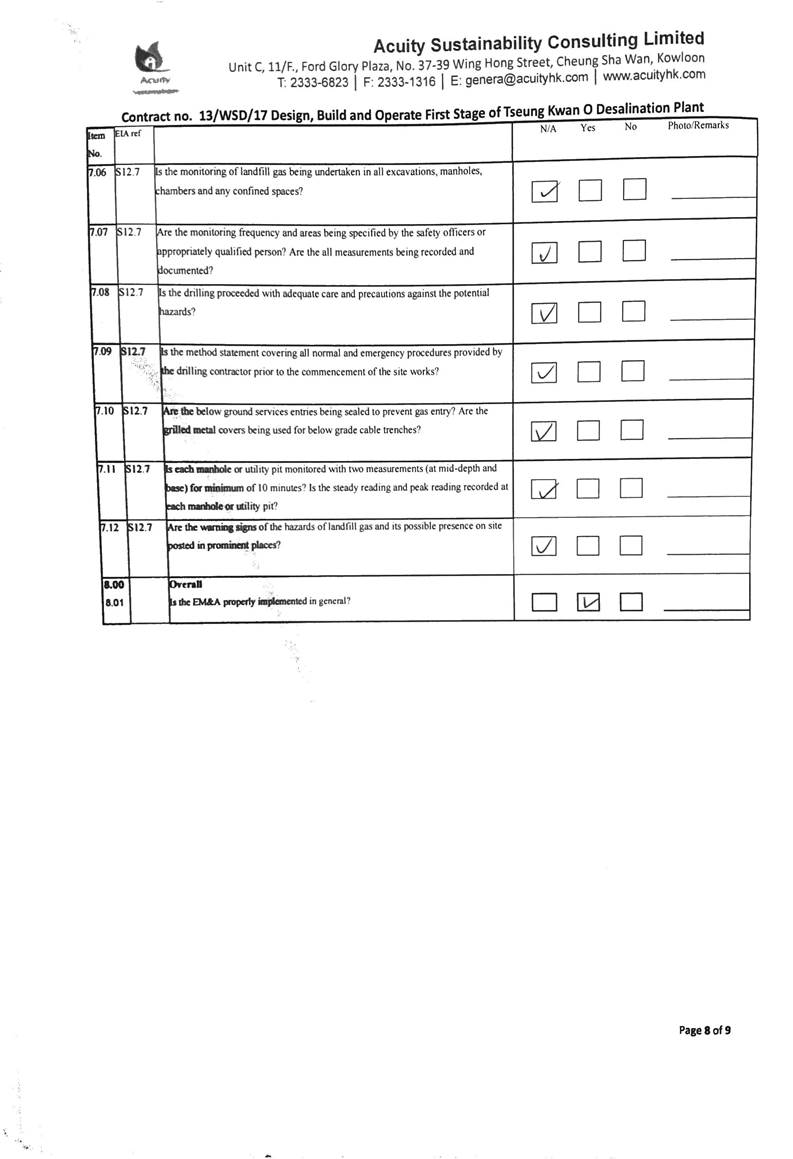

| S12.7 | Monitoring for
  landfill gas should be undertaken in all excavations, manholes, chambers
  (particularly during pipe jacking) and any confined spaces through the use of
  an intrinsically safe portable instrument, appropriately calibrated and capable of measuring
  the concentrations of methane. carbon dioxide and
  oxygen. | All area/
  Detailed design/ During construction/ During operation | Contractor(s) | ü | ü | ü | Implemented |  |
| S12.7 | Monitoring frequency and areas to be monitored should be specified prior
  to commencement of groundwork, either by the Safety Officer, or by an
  appropriately qualified person.                All
  measurements should be recorded and documented. | All area/ Detailed design/ During construction/ During
  operation | Contractor(s) | ü | ü | ü | Implemented |  |
| S12.7 | Proceed
  drilling with adequate care and precautions against the potential hazards
  which may be encountered. | All
  area/ Detailed design/ During construction/ During operation | Contractor(s) | ü | ü | ü | Implemented |  |
| S12.7 | Prior
  to the commencement of the site works, the drilling contractor should devise
  a 'method- of- working' statement covering all normal and emergency procedures (including but not limited
  to number of operatives, experience and special
  skills of operatives, normal method of operations,
  emergency procedures, supervisors responsibilities,
  storage and use of safety equipment, safety procedures and signs, barriers and
  guarding).                          The
  site supervisor and all operatives must be familiar with this statement. | All area/ During
  construction/ During operation | Contractor(s) | ü | ü | ü | N/A |  |
| S12.7 | Where below
  ground service entries are necessary to the Incoming Switchgear Room, 132 kV
  Substation and Chlorine Store (I) and (II), the entry point should be sealed
  to prevent gas entry. In addition, any below grade cable trenches entering
  the Incoming Switchgear Room and 132 kV Substation can become the pathway for landfill
  gas and hence grilled metal covers should | All area/
  Detailed design/ During construction/ During operation | Contractor(s) | ü | ü | ü | N/A |  |
| EIA
  Reference | Recommended
  Environmental Protection Measures/ Mitigation Measures | Objectives of the recommended measures & main concerns to address | Implementation Agent | Implementation Stage | Implementation Status | Relevant Legislation &
  Guidelines | ||
| D | C | O | ||||||
|  | be
  used. |  |  |  |  |  |  |  |
| S12.7 | It is recommended
  regular landfill gas monitoring should be carried out at the Incoming
  Switchgear Room, 132 kV Substation and Chlorine Store (I) and (II). The monitoring frequency will be monthly
  for the first year of operation. If the monitoring results show no sign of landfill gas migration, reduce the
  monitoring frequency to once every six months. | All area/
  Detailed design/ During construction/ During operation | Contractor(s) | ü | ü | ü | N/A |  |
| S12.7 | The manholes and
  utility pits within the Project Site and along the fresh water mains. Each
  manhole/ utility pit should be monitored with two measurements (at mid depth
  and base). Each measurement
  should be monitored for a minimum of 10 minutes. A steady reading and peak
  reading should be recorded at each manhole/ utility pit and for each
  measurement. The need for venting the manhole/ utility pit and further
  monitoring will be reviewed after the initial monitoring. | All area/
  Detailed design/ During construction/ During operation | Contractor(s) | ü | ü | ü | Impllemented |  |
| S12.7 | All construction,
  operation and maintenance
  personnel working on-site as well as visitors should be made aware of the
  hazards of landfill gas and its possible presence on-site. This should be
  achieved through a combination of posting warning signs in prominent places
  and also by access to detailed
  information on landfill gas hazards and the designs and procedural means by
  which these hazards are being minimised on-site. | All area/
  Detailed design/ During construction/ During operation | Contractor(s) | ü | ü | ü | Implemented |  |
Note: D - Design stage C - Construction O - Operation
Impact Monitoring
Schedule of the Reporting Month (BLANK)
Appendix E

Noise Monitoring
Equipment Calibration Certificate (BLANK)
Appendix G

Name of Department: WSD                                                                                            Contract
No.: 13/WSD/17
Monthly Summary Waste Flow Table for 2020 (year)
| Month | Actual Quantities of Inert C&D Materials
  Generated Monthly | Actual
  Quantities of C&D Wastes Generated Monthly | |||||||||
| Total Quantity Generated | Hard Rock and Large Broken
  Concrete | Reused in the Contract (see
  Note 6) | Reused in other Projects | Disposed as Public Fill | Imported Fill | Metals | Paper/ cardboard packaging | Plastics (see
  Note 3) | Chemical Waste | Others, e.g. general refuse | |
| (in '000kg) | (in '000kg) | (in '000kg) | (in '000kg) | (in '000kg) | (in '000kg) | (in '000 kg) | (in '000kg) | (in '000kg) | (in '000kg) | (in '000kg) | |
| Jan | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 |
| Feb | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 |
| Mar | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.420 |
| Apr | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 2.400 |
| May | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 5.900 | 0.000 | 0.000 | 0.000 | 12.570 |
| Jun | 1081.950 | 0.000 | 0.000 | 0.000 | 1081.950 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 34.160 |
| Sub-total | 1081.950 | 0.000 | 0.000 | 0.000 | 1081.950 | 0.000 | 5.900 | 0.000 | 0.000 | 0.000 | 49.550 |
| Jul | 724.360 | 0.000 | 0.000 | 0.000 | 724.360 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 33.760 |
| Aug | 161.080 | 0.000 | 0.000 | 0.000 | 161.080 | 0.000 | 0.000 | 0.000 | 0.000 | 0.000 | 42.070 |
| Sep |  |  |  |  |  |  |  |  |  |  |  |
| Oct |  |  |  |  |  |  |  |  |  |  |  |
| Nov |  |  |  |  |  |  |  |  |  |  |  |
| Dec |  |  |  |  |  |  |  |  |  |  |  |
| Total | 1967.390 | 0.000 | 0.000 | 0.000 | 1967.390 | 0.000 | 5.900 | 0.000 | 0.000 | 0.000 | 125.380 |
Notes:         (1)        The performance targets
are given in Section 1.69 of Specification B
(2)
The waste flow table shall also include
C&D materials that are specified in the Contract
to be imported for use at the Site.
(3)

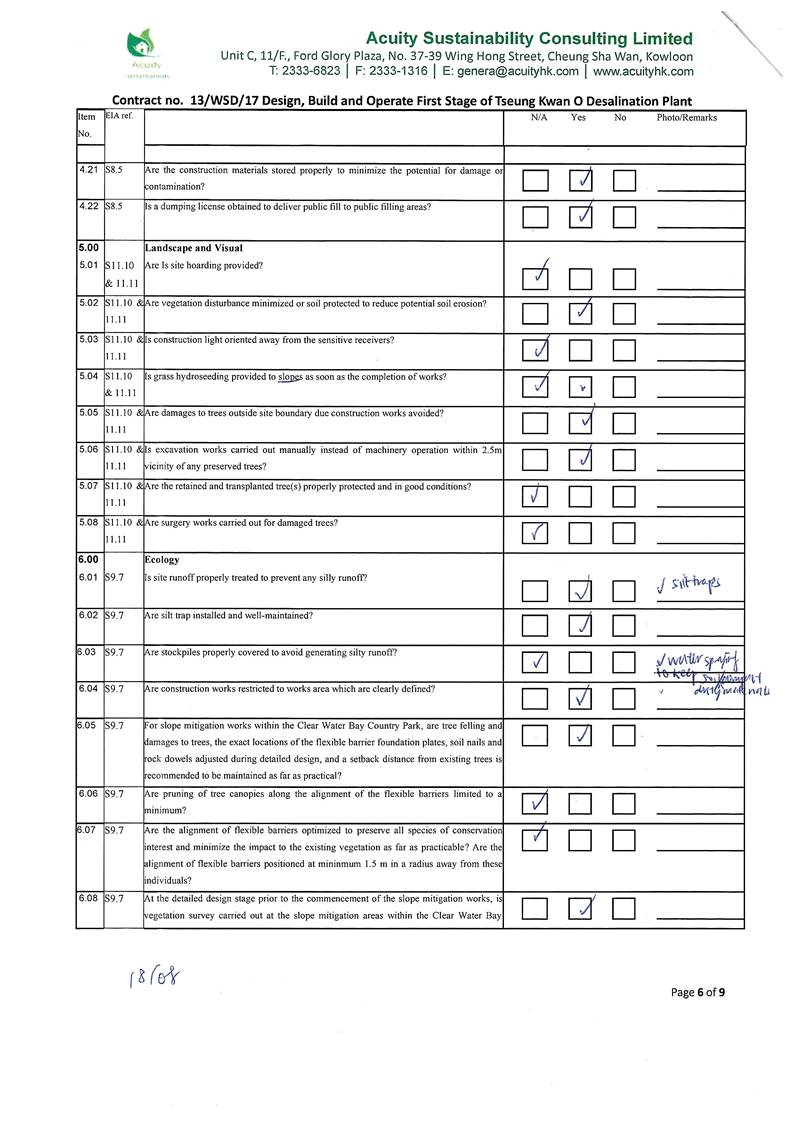

Plastics refer to plastic bottles/containers, plastic
sheets/ foam from packaging material
Site
Inspection Proforma

Page9of9
l-Hl
