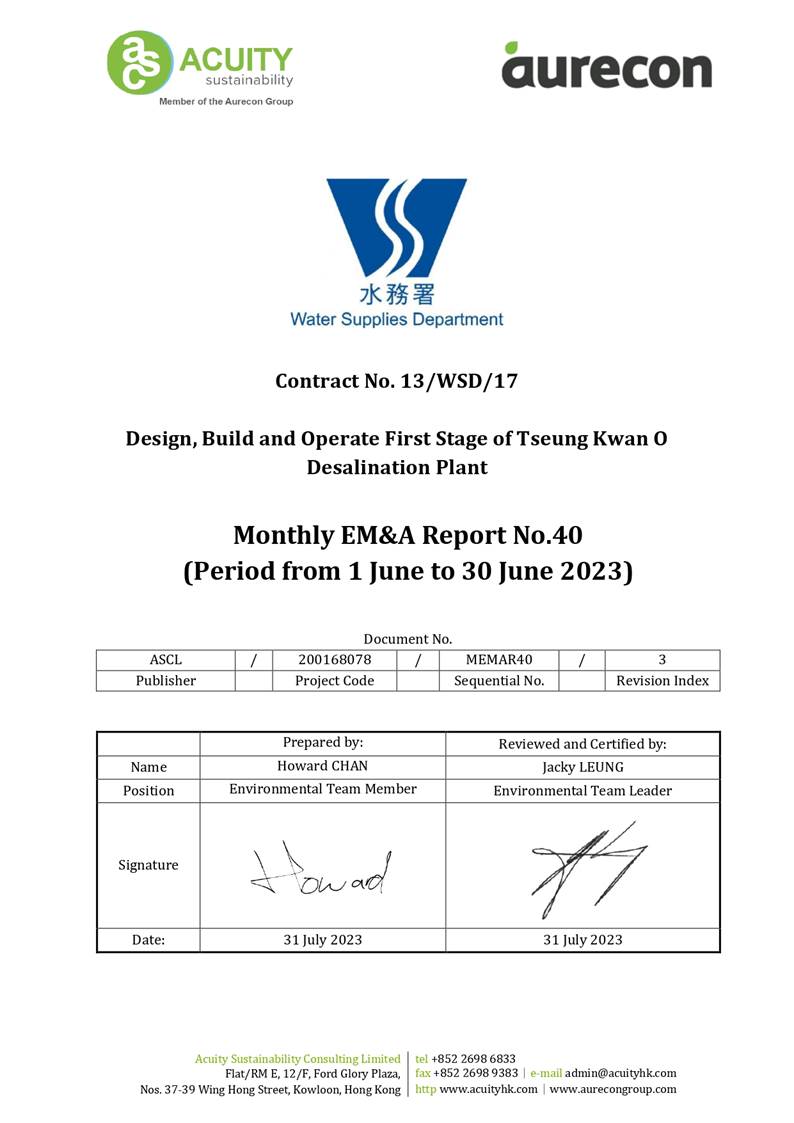

Revision History
Rev. |
Description of Modification |
Date |
1. |
First Issue for Comments |
11/07/2023 |
2. |
Second Issue for Comments |
19/07/2023 |
3. |
Updated Landfill Gas Monitoring Results |
31/07/2023 |
6. Summary of Exceedance, Complaints, Notification of Summons and Prosecutions.......... 29
Appendix B Overview of Desalination Plant in Tseung Kwan O
Appendix
C Summary
of
Implementation Status of
Environmental Mitigation

Appendix D Impact Monitoring Schedule
Appendix E Event/Action Plan
Appendix F Water
Quality
and
Landfill Gas Equipment

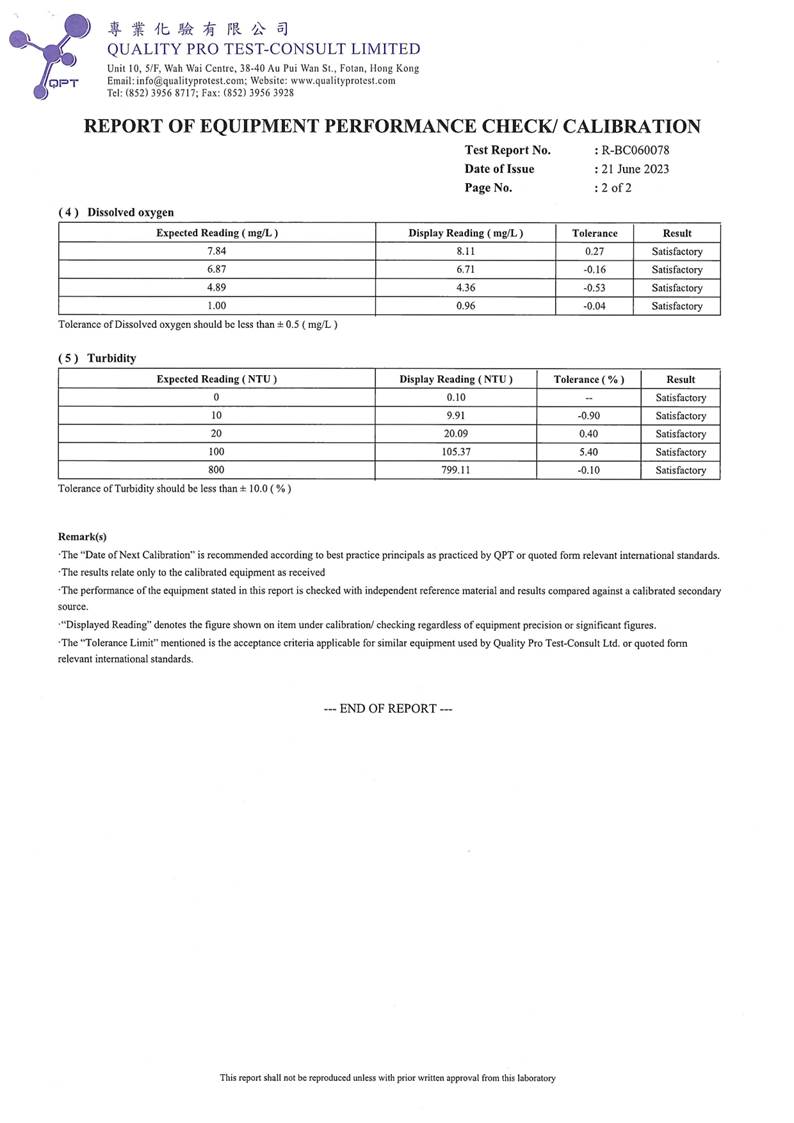

Calibration Certificate
Appendix G Water Quality and Landfill Gas Monitoring Data
Appendix H Waste Flow Table

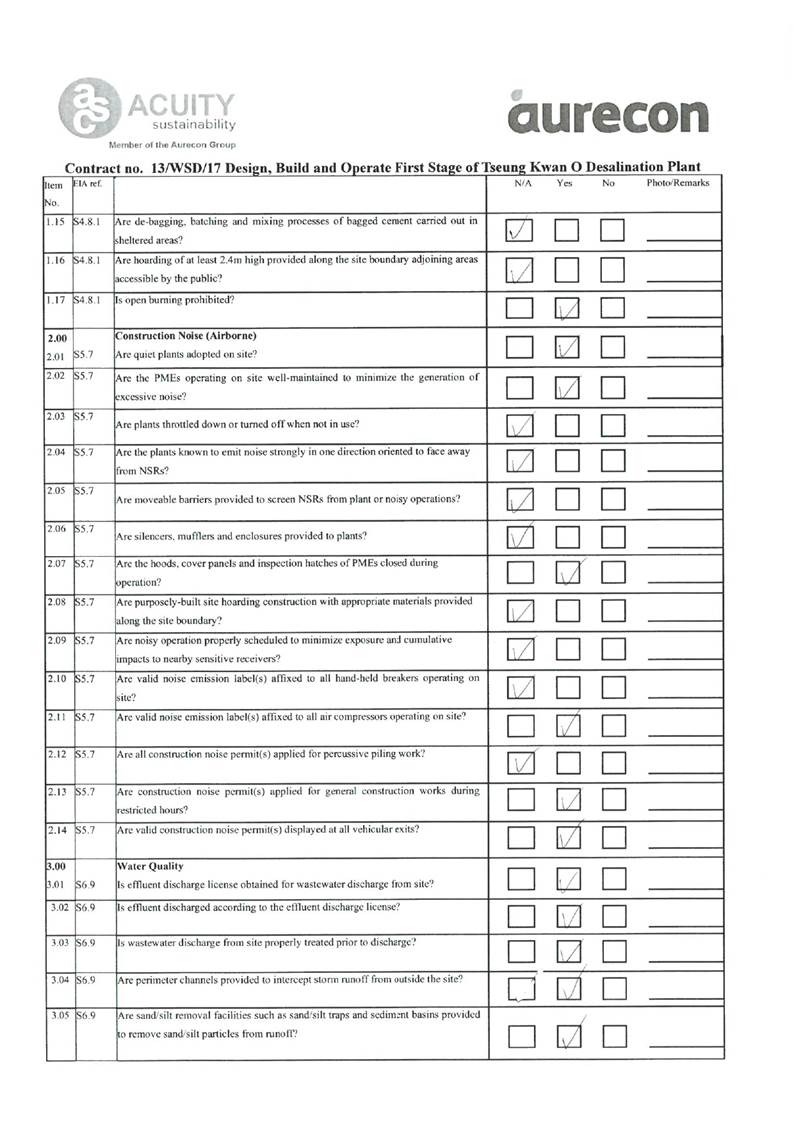

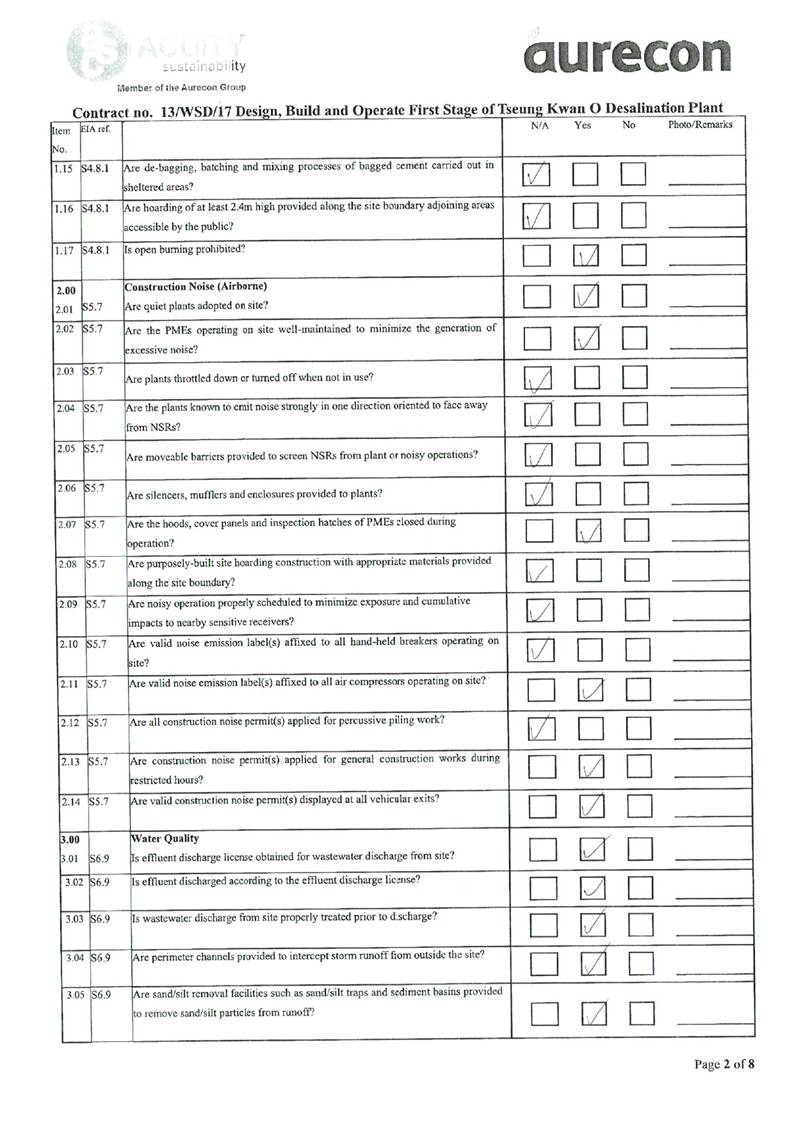

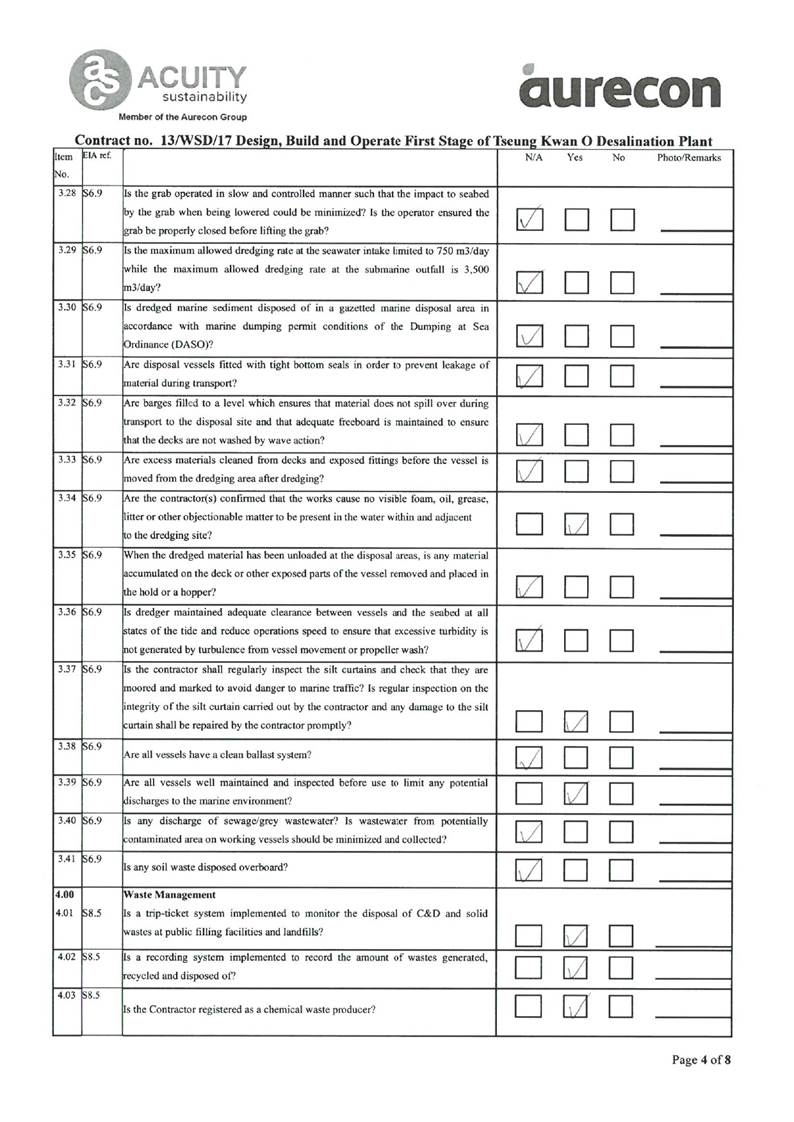

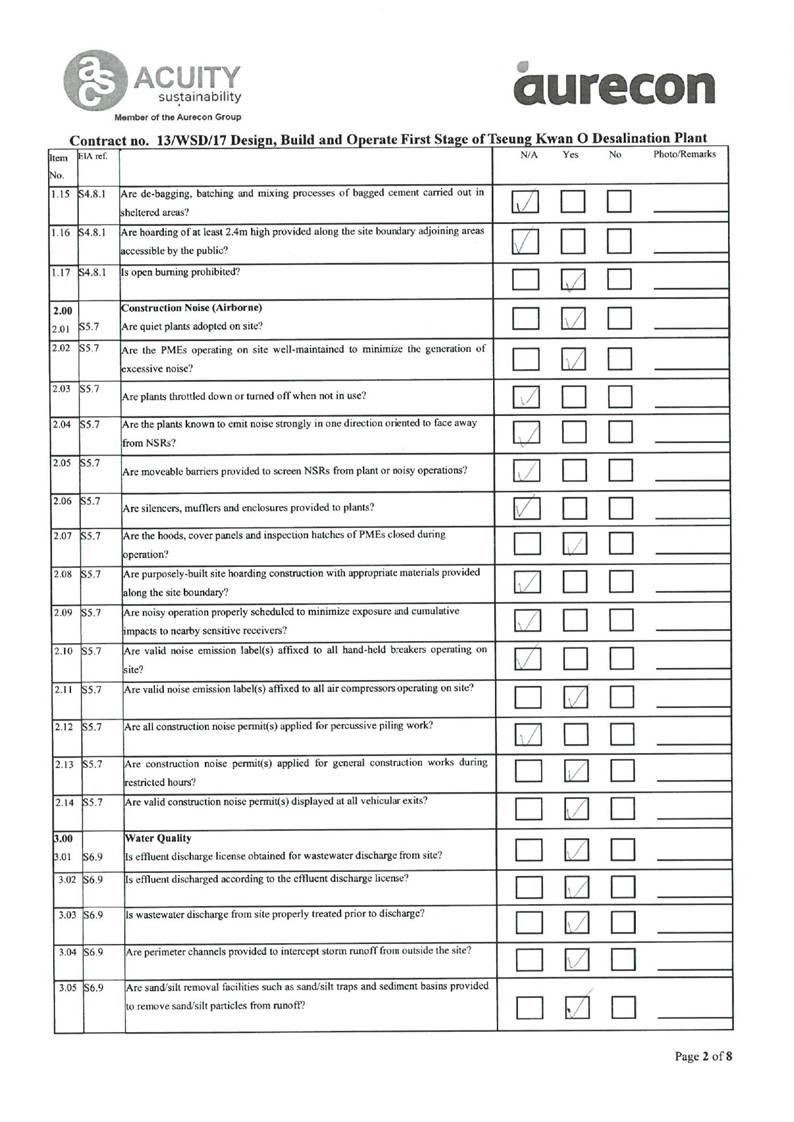

Appendix I Site Inspection Proforma
Appendix J Complaint Log
Appendix K Exceedance Report(s)
Executive Summary
Introduction
A1. The Project, Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (TKODP), is a Designated Project under the Environmental Impact Assessment Ordinance (Cap. 499) (EIAO) and is currently governed by a Further Environmental Permit (EP No. FEP - 01/503/2015/A) for the construction and operation of the Contract.
A2. In accordance with the Environmental Monitoring and Audit (EM&A) Manual for the Contract, EM&A works for marine water quality, noise, waste management and ecology should be carried out by Environmental Team (ET), Acuity Sustainability Consulting Limited (ASCL), during the construction phase of the Contract.
A3. This is the 40th Monthly EM&A Report, prepared by ASCL, for the Contract summarizing the monitoring results and audit findings of the EM&A programme at and around Tseung Kwan O Area 137 (TKO 137) during the reporting period from 1 June to 30 June 2023.
A4. The EM&A programme for this contract has covered environmental monitoring on construction noise level at selected NSRs and Contractor¡¦s environmental performance auditing in the aspects of construction dust, construction noise, water quality, waste management, Landscape and Visual and Ecology.
Summary of Main Works Undertaken & Key Mitigation Measures Implemented
A5. Key activities carried out in this reporting period for the Contract included the followings:
Administration Building - Installation of glass balustrade, metal cladding, building services, electrical switchboard, lift, cable laying - carrying out interior finishes at 2/F, 3/F and 4/F - Construction of block wall in the pipe duct. |
Chemical building -
Installation of handrail, permanent door,
building services, mechanical equipment, and cable laying -
Underground utility construction work |
Main Electrical & Central Chiller Plant Building - Construction of fuel tank room - Installation metal Doors, chillers, building services, electrical switchboard, cable laying |
ActiDAFF - Underground utility construction work - Laying of roof floor screed and tiles - Construction of plinths for saturator tanks |
- Erection and dismantling of scaffolding, installation of mechanical equipment and piping, bubble test - Installation of underdrain |
Product Water Storage Tank Building - Resin Injection Work & Water Test for 1 Water Tanks - Installation of cat ladders in Water Tanks, and door -
Installation of louvres, metal cladding, building services, cable laying, mechanical equipment, steel pipe - Underground utility construction |
OSCG Building - Installation of Design for Manufacturing and Assembly (DfMA) Panel and metal door - Underground utility construction work - Installation of building services and mechanical equipment |
Reverse Osmosis Building - Installation of Design for Manufacturing and Assembly(DfMA) Panels at East Sides - Installation of metal door, metal cladding, hand railings, Louvres & Windows - Installation of building services, electrical switchboard, mechanical equipment, steel pipe, Glass Reinforced Plastics (GRP) pipe and cable laying - Underground utility construction work |
Post Treatment Building - Installation of Louvres & Windows, metal door and cat ladders - Installation of Design for Manufacturing and Assembly(DfMA) Panels - Installation of building services, mechanical equipment and GRP pipe - Underground utility construction work |
Inspection corridor - Construction of bondek for segments 7 - construction of staircase 8 |
CO2 Tanks - Installation of pipes and building services Outfall Shaft -
GRP Diffuser Pipe
installation and rock material backfill Combined Shaft -
Installation of building services, electrical equipment, switchboard, cable
laying, mechanical equipment and pipes, stoplogs and band screens - Underground utility construction work -
Staircases and internal finishing Pump room - internal finishing and screeding |
Other -
Excavation works, access
erection, soil anchor
installation and grouting construction works at the
slope toe -
Foundation & structure construction at Elevated Walkway -
Watermain works at CLP 132 kV Substation -
Concrete Breaking, structure construction of Wave Deflector Wall at
seawall area |
A6. The major environmental impacts brought by the above construction works include:
- Construction dust and noise generation from construction works, excavation works, rock cutting works and pipe piling driving works;
- Waste generation from the construction activities; and
- Impact on water quality from marine construction works and inland construction works.
A7. The key environmental mitigation measures implemented for the Contract in this reporting period associated with the above construction works include:
- Dust suppression by regular wetting and water spraying for construction works;
- Reduction of noise from equipment and machinery on-site and regular inspection to machinery and plants/vehicles on-site to ensure proper functioning;
- Deployment of temporary silt curtain in the area where marine construction works were conducted and deployment of water sedimentation tanks for treatment of wastewater at inland and marine areas before discharge; and
- Sorting and storage of general refuse and construction waste; and
Summary of exceedance & investigation & follow-up
A8. No noise monitoring was conducted during the reporting period since there are no Contract -related construction activities undertaken within a radius of 300m from the monitoring locations. No exceedance of the action Level was recorded during the reporting period.

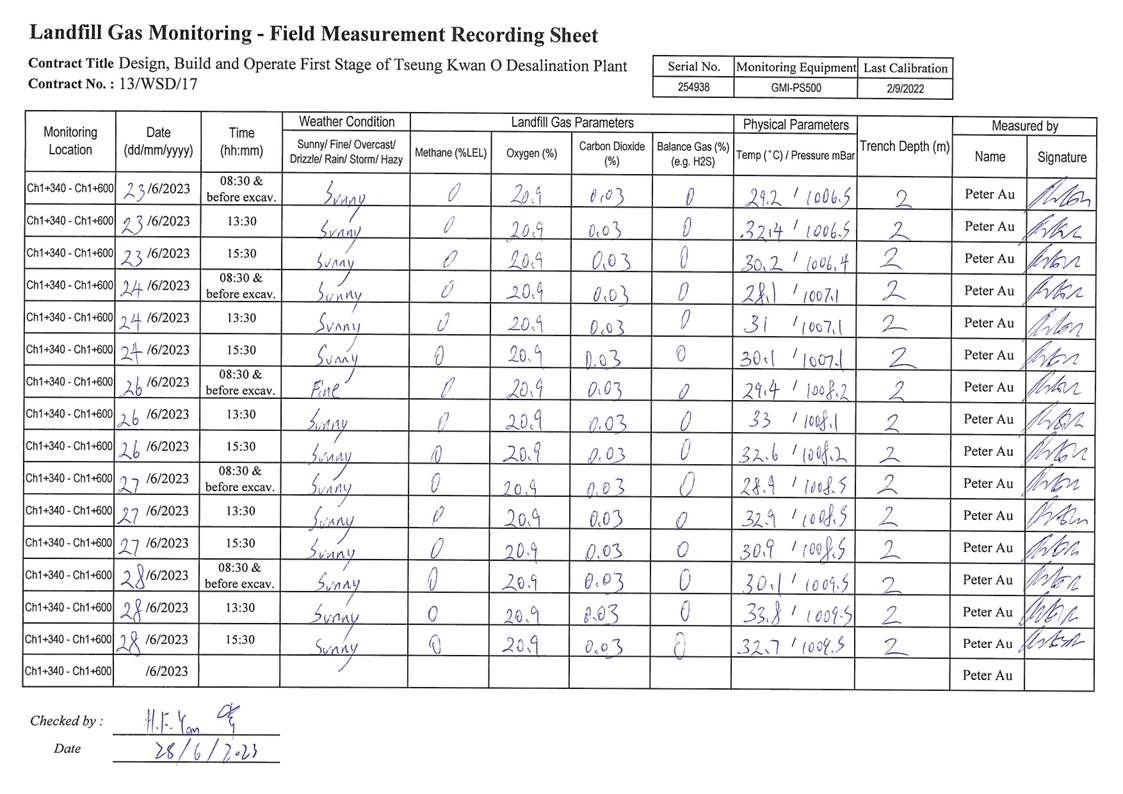

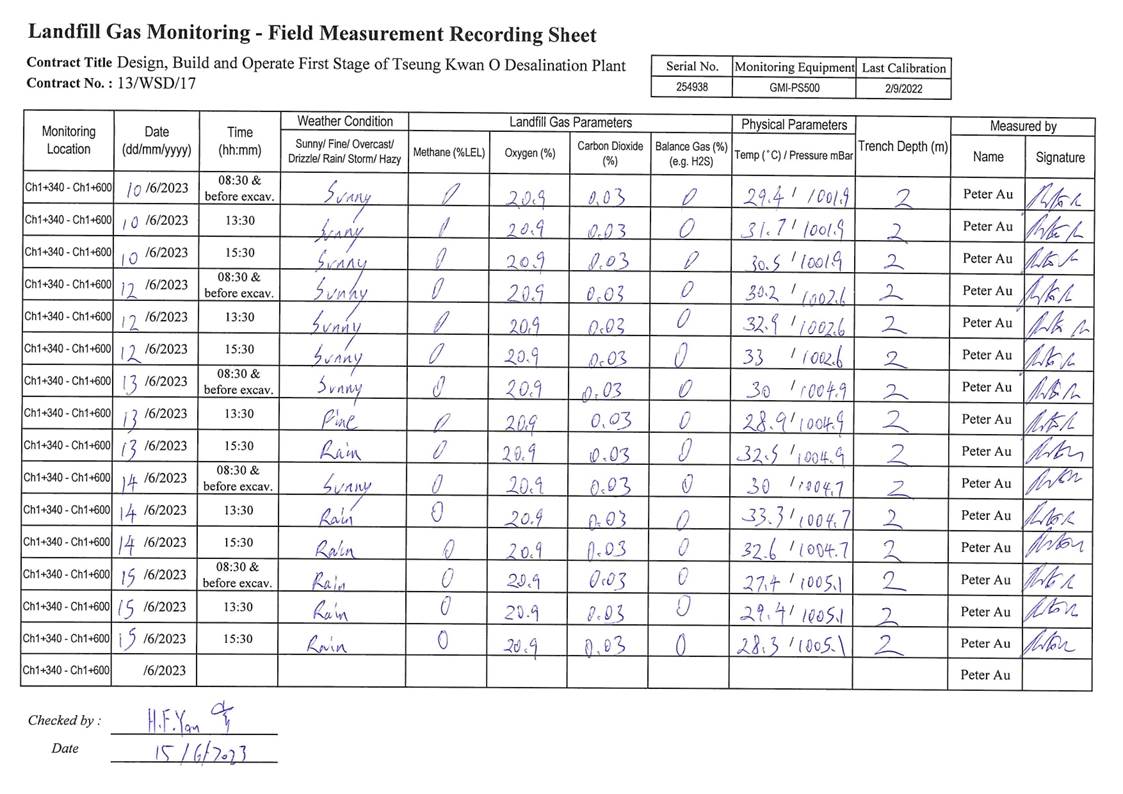

A9. The EM&A works for water quality were conducted during the reporting period in accordance with the EM&A Manual.
A10. Twenty-two (22) of the general water quality monitoring results of Suspended Solids (SS) obtained had exceeded the Action Level. Eighteen (18) of the general water quality monitoring results of SS obtained during the reporting period had exceeded the Limit Level.
A11. Investigation on the reason of exceedance has been carried out, where the exceedances of SS on 1, 8, 10, 13, 15 and 27 June 2023 were concluded to be unrelated to the Contract as detailed in the Incident Reports on Action Level or Limit Level Non-compliance along with supporting materials in Appendix K.

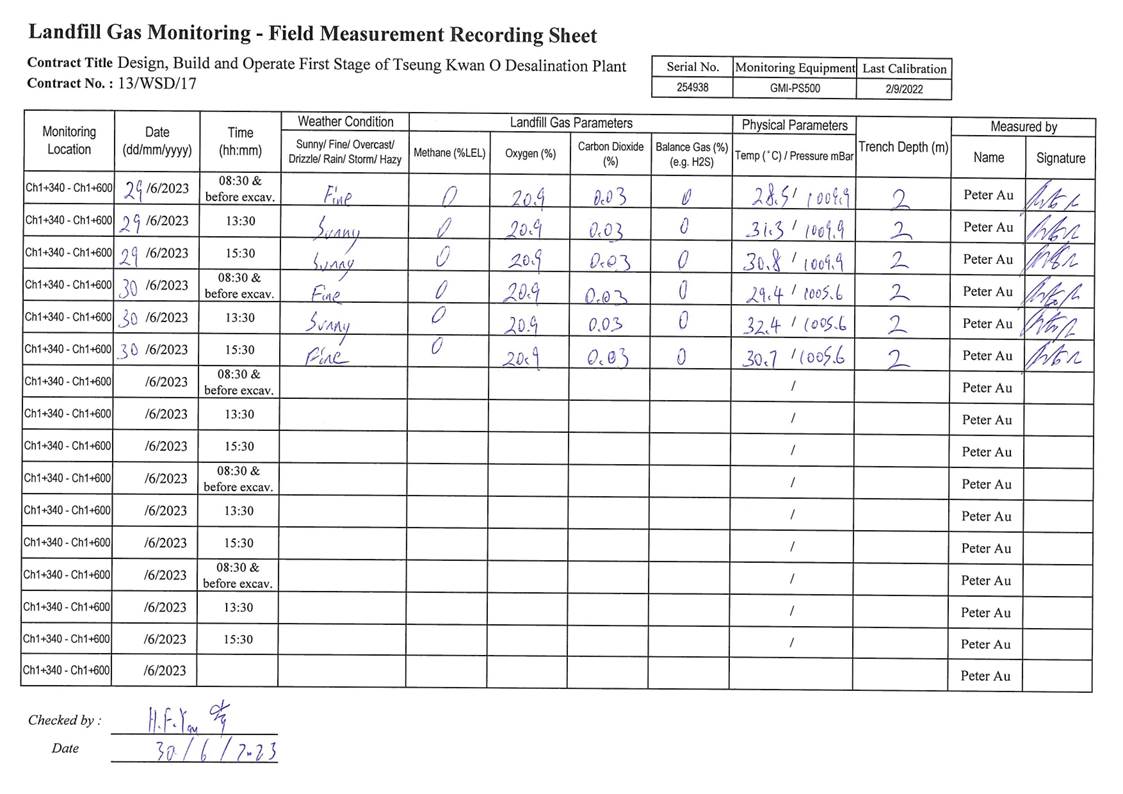

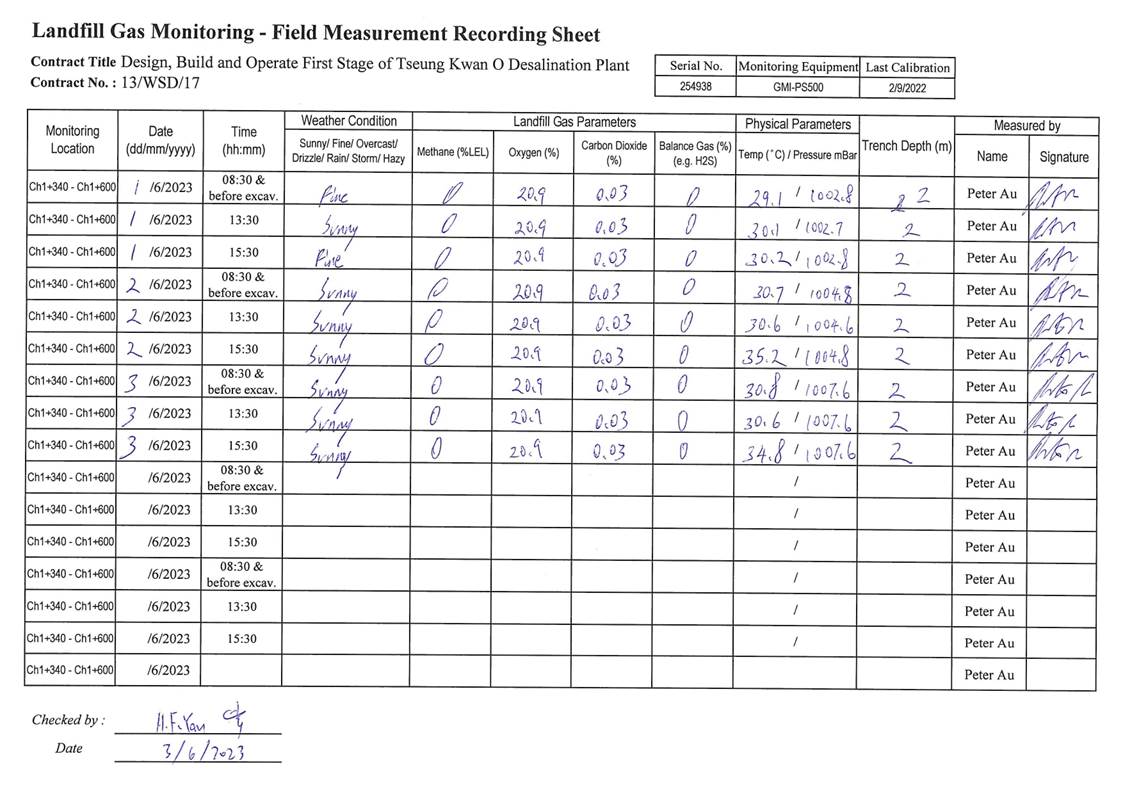

A12. In this reporting period, 75 times of landfill gas monitoring were conducted at TKO Area 137 (Ch1+340 - Ch1+600). No action or limit level exceedance was recorded during the reporting period.

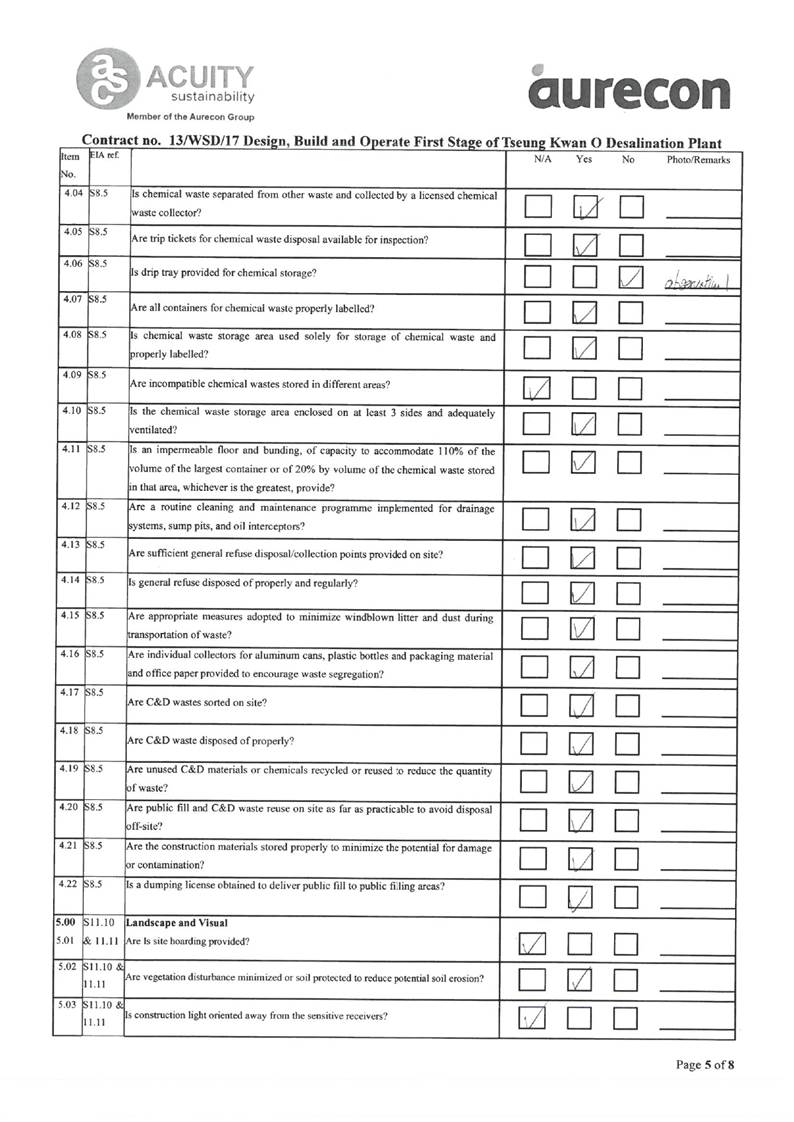

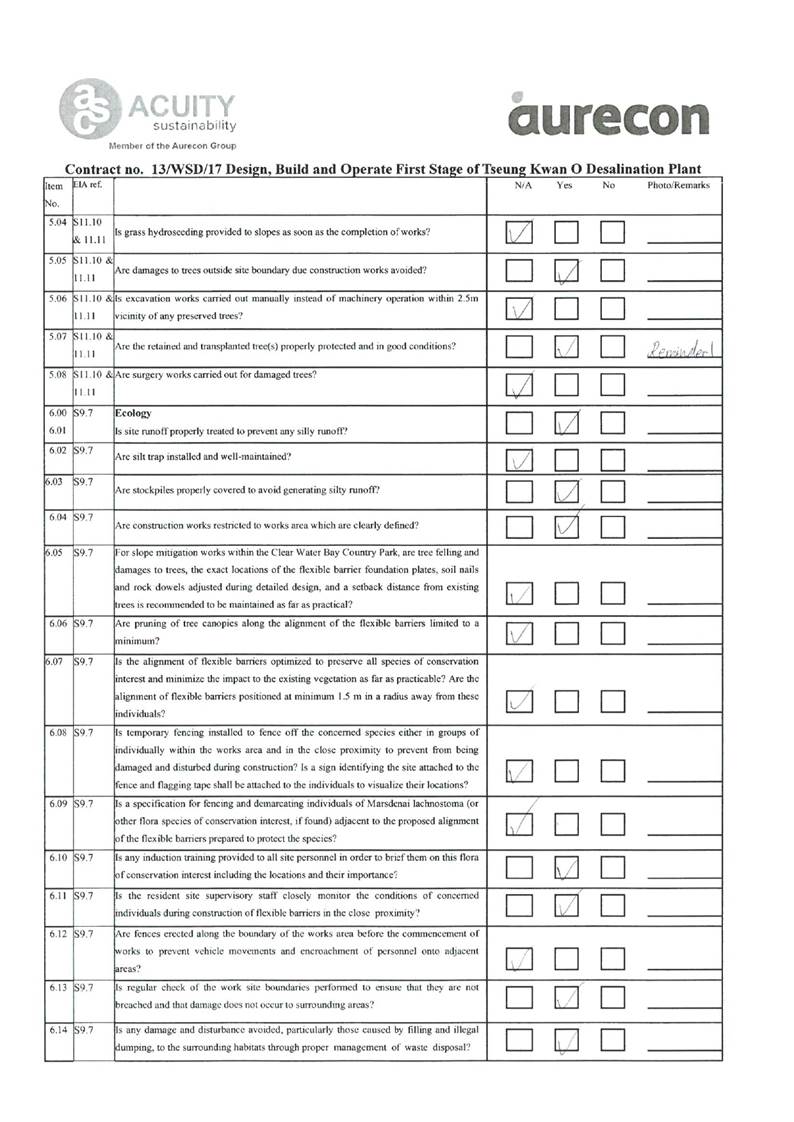

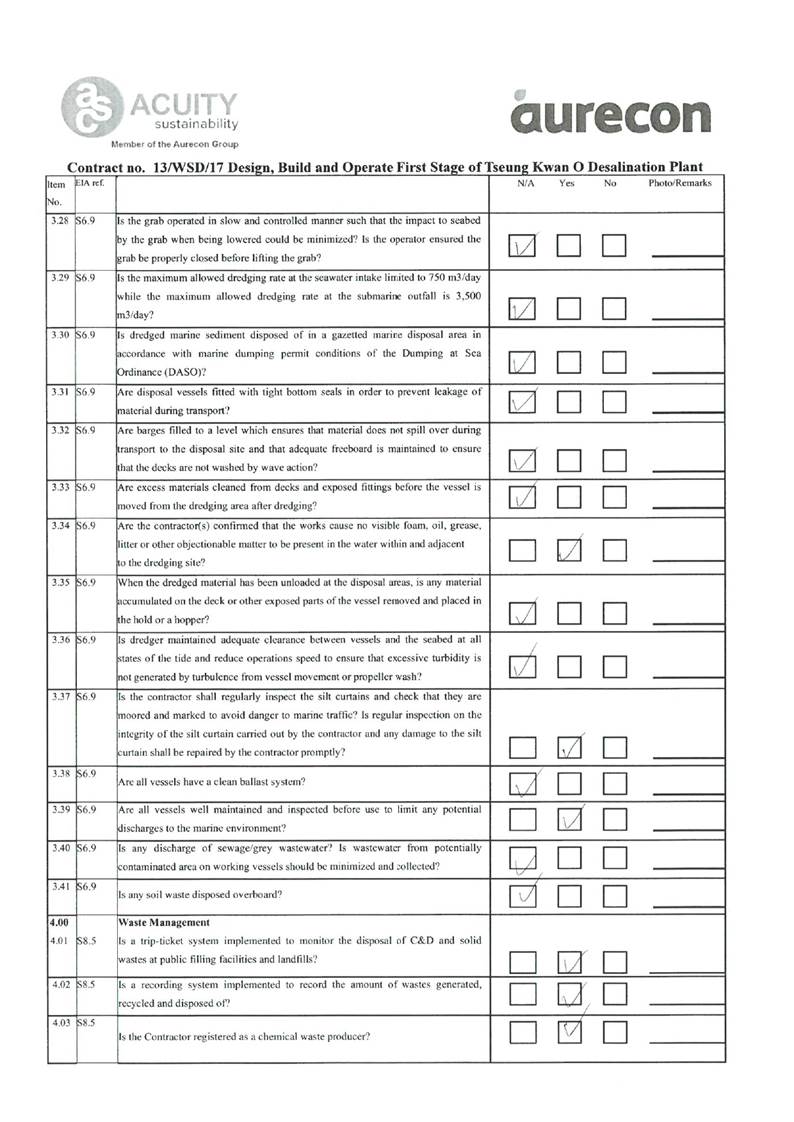

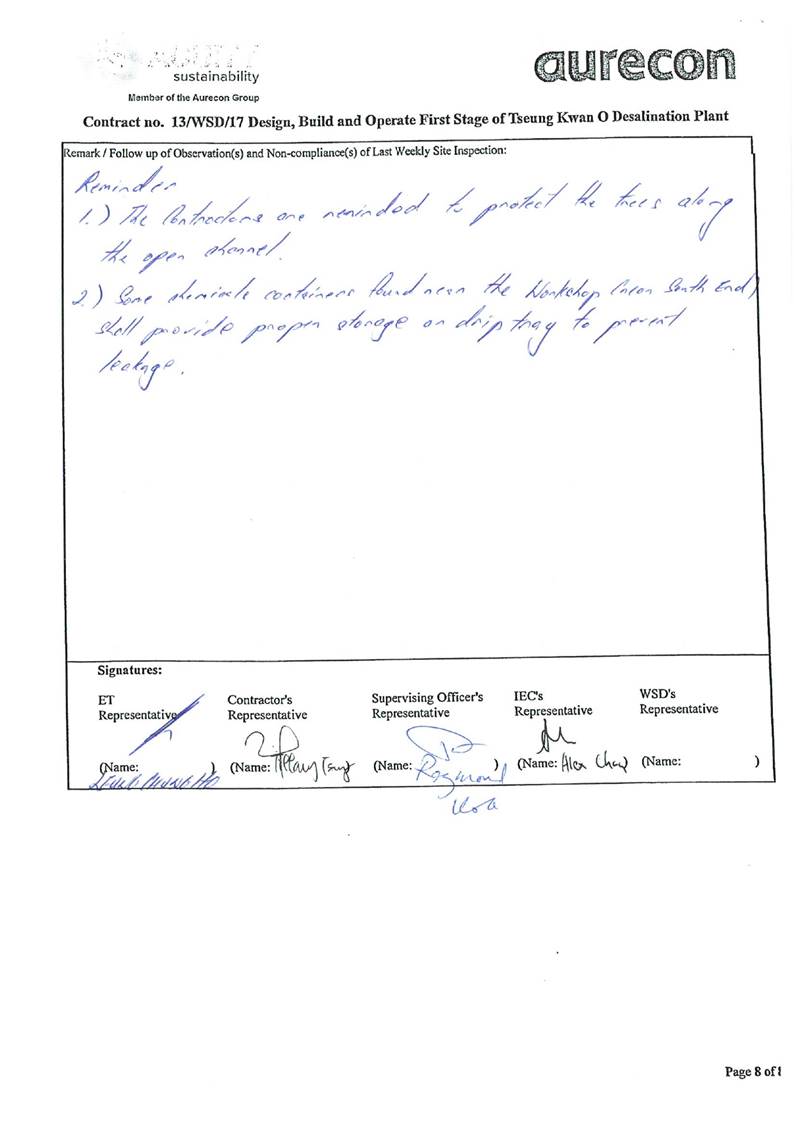

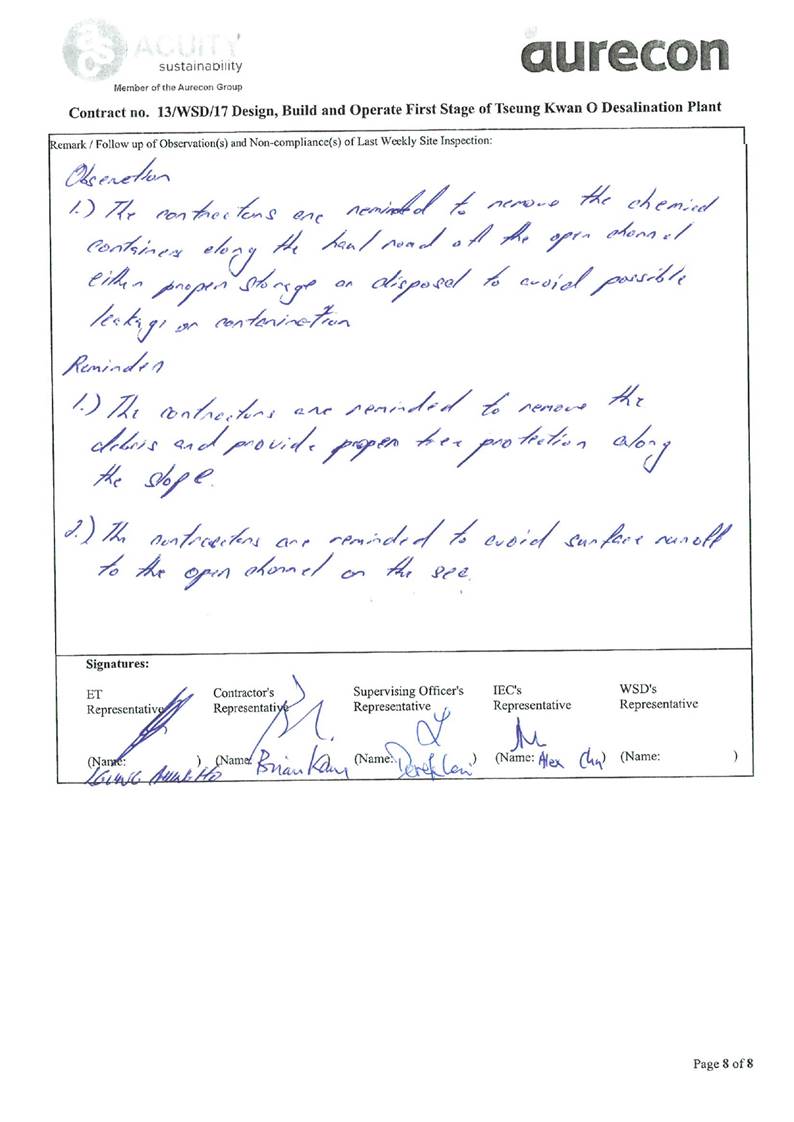

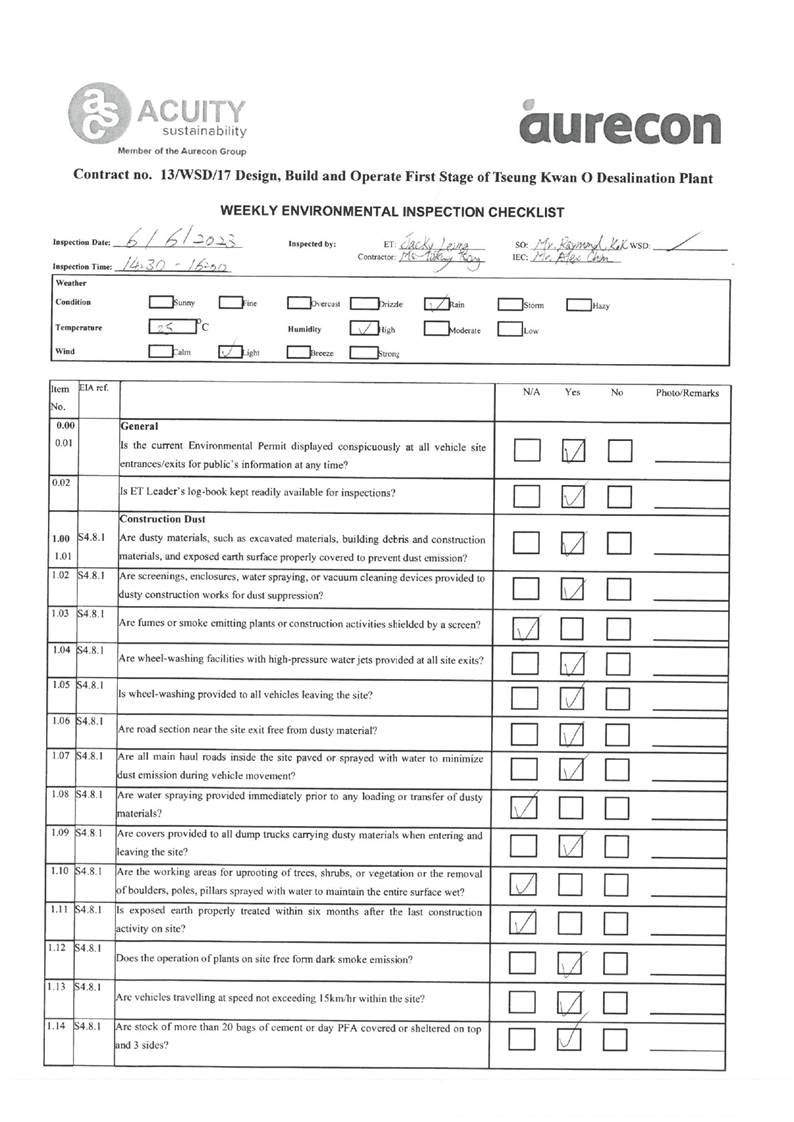

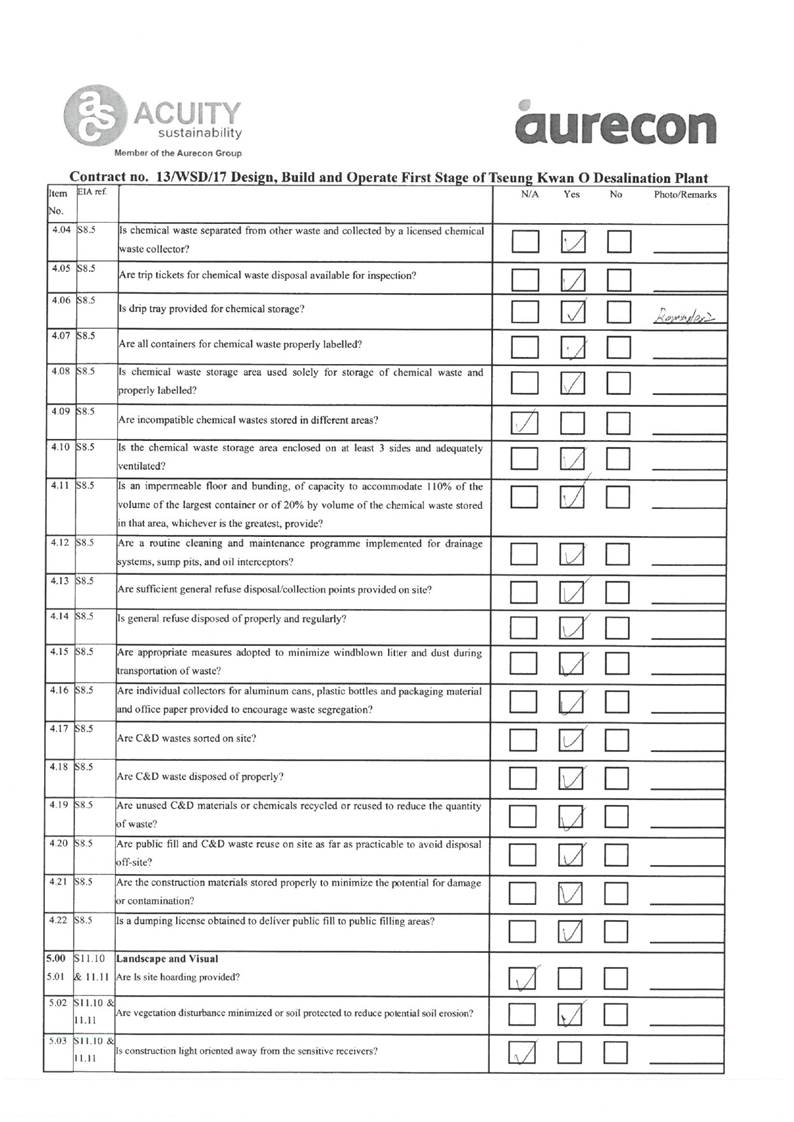

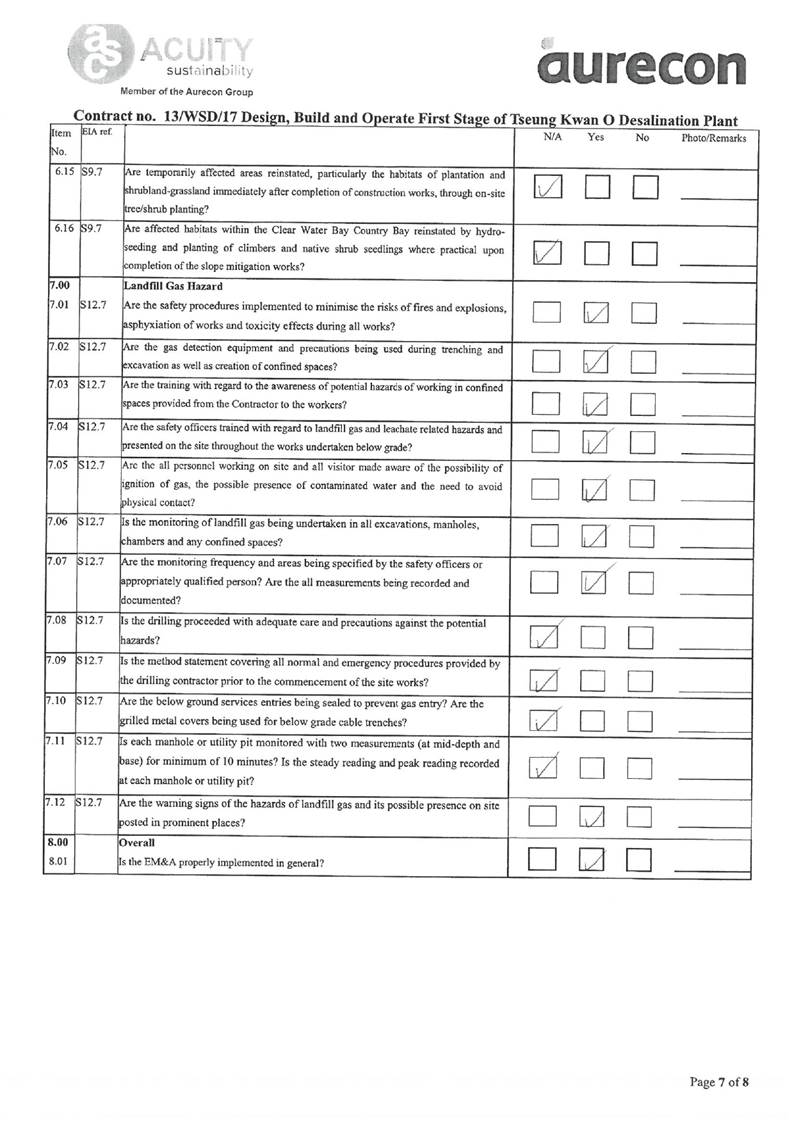

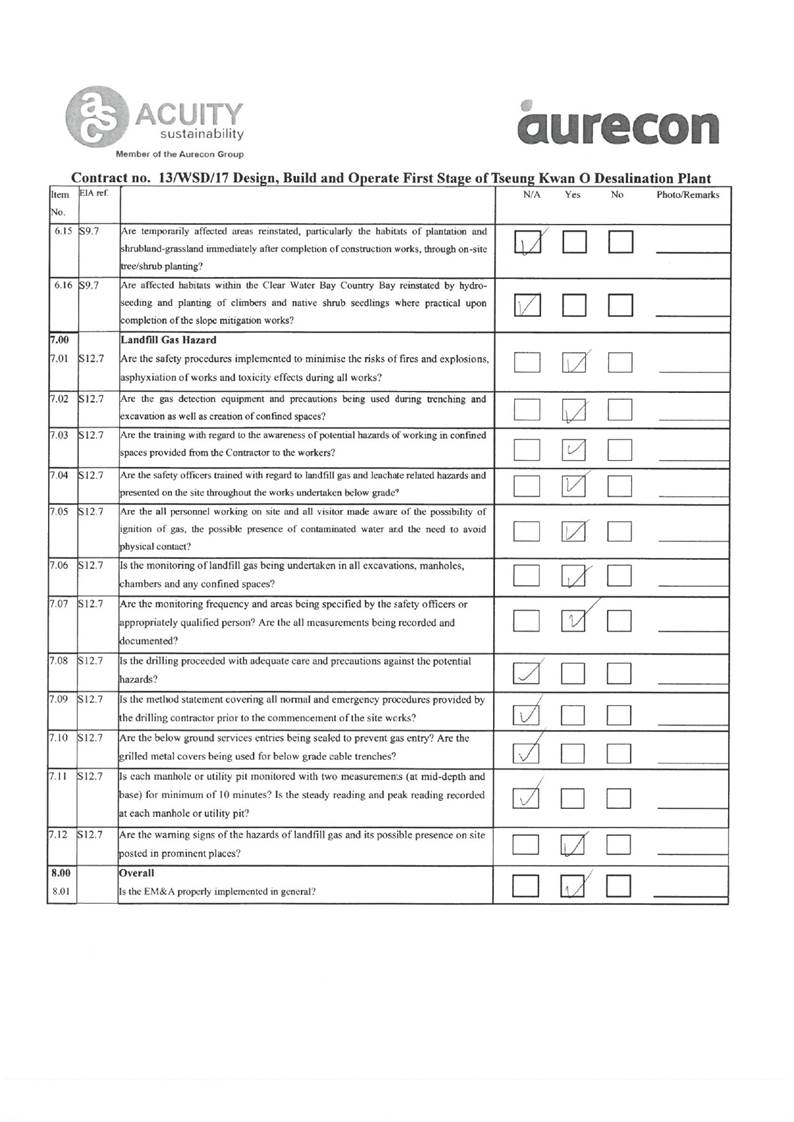

A13. Joint site inspections of the construction work by ET and IEC were carried out on 6, 13, 20 and 27 June 2023 to audit the mitigation measures implementation status. Observations and reminders were recorded in the site inspection checklists and provided to the contractors together with the appropriate follow-up actions where necessary.
Complaint Handling and Prosecution
A14. No environmental complaint, notification of summons and prosecution was received in the reporting period.
Reporting Change
A15. There was no change to be reported that may affect the on-going EM&A programme.
Summary of Upcoming Key Issues and Key Mitigation Measures
A16. Key activities anticipated in the next reporting period for the Contract will include the followings:
Administration Building - Installation of glass balustrade, metal cladding, building services, electrical switchboard, lift, cable laying - carrying out interior finishes at 2/F, 3/F and 4/F - Construction of block wall in the pipe duct. |
Chemical building - Installation of handrail, permanent doors, building services, mechanical equipment, and cable laying - Underground utility construction work |
Main Electrical & Central Chiller Plant Building - Construction of fuel tank room - Installation metal Doors, chillers, building services, electrical switchboard, cable laying |
ActiDAFF - Underground utility construction work - Laying of roof floor screed and tiles - Construction of plinths for saturator tanks |
- Erection and dismantling of scaffolding, installation of mechanical equipment and piping, bubble test - Installation of underdrain |
Product Water Storage Tank Building - Resin Injection Work & Water Test for 1 Water Tanks - Installation of cat ladders in Water Tanks, and door -
Installation of louvres, metal cladding, building services, cable laying, mechanical equipment, steel pipe - Underground utility construction |
OSCG Building - Installation of Design for Manufacturing and Assembly (DfMA) Panel and metal door - Underground utility construction work - Installation of building services and mechanical equipment |
Reverse Osmosis Building - Installation of Design for Manufacturing and Assembly (DfMA) Panels at East Sides - Installation of metal door, metal cladding, hand railings, Louvres & Windows - Installation of building services, electrical switchboard, mechanical equipment, steel pipe, Glass Reinforced Plastics (GRP) pipe and cable laying - Underground utility construction work |
Post Treatment Building - Installation of Louvres & Windows, metal door and cat ladders - Installation of Design for Manufacturing and Assembly (DfMA) Panels - Installation of building services, mechanical equipment and GRP pipe - Underground utility construction work |
Inspection corridor - Construction of bondek for segments 7 - construction of staircase 8 |
CO2 Tanks - Installation of pipes and building services Outfall Shaft -
GRP Diffuser Pipe
installation and rock material backfill Combined Shaft -
Installation of building services, electrical equipment, switchboard, cable
laying, mechanical equipment and pipes, stoplogs and band screens - Underground utility construction work -
Staircases and internal finishing Pump room - internal finishing and screeding |
Other -
Excavation works, access
erection, soil anchor
installation and grouting construction works at the
slope toe -
Foundation & structure construction at Elevated Walkway - Watermain works at CLP 132 kV Substation -
Concrete Breaking, structure construction of Wave Deflector Wall at
seawall area |
A17. The major environmental impacts brought by the above construction works will include:
- Construction dust and noise generation from excavation and construction works;
- Waste generation from construction activities; and
- Impact on water quality from marine construction works and inland construction works.
A18. The key environmental mitigation measures for the Contract in the coming reporting period associated with the above construction works will include:
- Reduction of noise from equipment and machinery on-site;
- Dust suppression by regular wetting and water spraying for construction works and at main haul road;
- Sorting and storage of general refuse and construction waste; and
- Deployment of temporary silt curtain in the area where marine construction works were conducted and deployment of water sedimentation tanks for treatment of wastewater at inland and marine areas before discharge.
1.
Basic Contract Information
Background
1.1. The Acciona Agua, S.A. Trading, Jardine Engineering Corporation, Limited and China State Construction Engineering (Hong Kong) Limited as AJC Joint Venture (AJCJV) is contracted to carry out the Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (DPTKO) under Contract No. 13/WSD/17 (the Contract).
1.2. Acuity Sustainability Consulting Limited (ASCL) is commissioned by AJCJV to undertake the Environmental Team (ET) services as required and/or implied, both explicitly and implicitly, in the Environmental Permit (EP), Environmental Impact Assessment Report (EIA Report) (Register No. AEIAR-192/2015) and Environmental Monitoring and Audit Manual (EM&A Manual) for the Contract; and to carry out the Environmental Monitoring and Audit (EM&A) programme in fulfillment of the EIA Report¡¦s EM&A requirements and Contract No. 13/WSD/17 Specification requirements.
1.3. Pursuant to the Environmental Impact Assessment Ordinance (EIAO), the Director of Environmental Protection granted the Environmental Permit (No. EP-01/503/2015) and Variation of Environmental Permit (No. EP-01/503/2015/A) to Water Supplies Department (WSD); and granted the Further Environmental Permit (No. FEP- 01/503/2015/A) to AJCJV for the Contract.
The Reporting Scope
1.4. This is the 40th Monthly EM&A Report for the Contract which summarizes the key findings of the EM&A programme during the reporting period from 1 June to 30 June 2023.
Contract Organization
1.5. The Contract Organization structure for Construction Phase is presented in Figure 1.1.
Figure 1.1 Contract
Organization Chart
1.6. Contact details of the key personnel are presented in Table 1.1 below:
Table 1.1 Contact Details of Key Personnel
Party |
Position |
Name |
Telephone no. |
Contract Proponent (Water Supplies Department) |
SE/CM2 |
Milton Law |
2634-3573 |
Supervising Officer (Binnies Hong Kong Limited) |
Project Manager |
Christina Ko |
2608-7302 |
Chief Resident Engineer |
Roger Wu |
6343-1002 |
|
The Jardine Engineering Corporation, Limited, China State Construction Engineering (Hong Kong) Limited and Acciona Agua, S.A. Trading |
Project Manager |
Stephen Yeung |
2807-4665 |
Environmental Monitoring Manager |
Brian Kam |
9456-9541 |
|
Acuity Sustainability Consulting Limited |
Environmental Team Leader |
Jacky Leung |
2698-6833 |
ANewR Consulting Limited |
Independent Environmental Checker (IEC) |
Mr. CHAN Yi Chun, Alex |
2618-2831 |
Summary of Construction Works

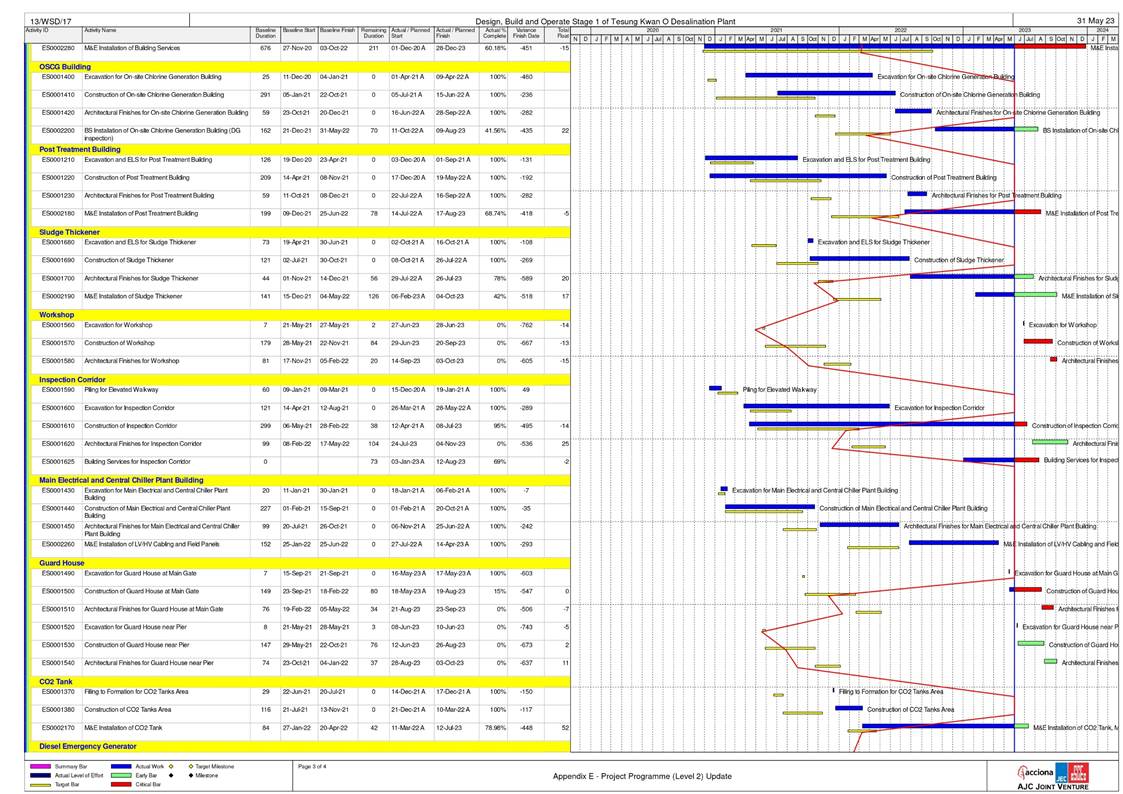

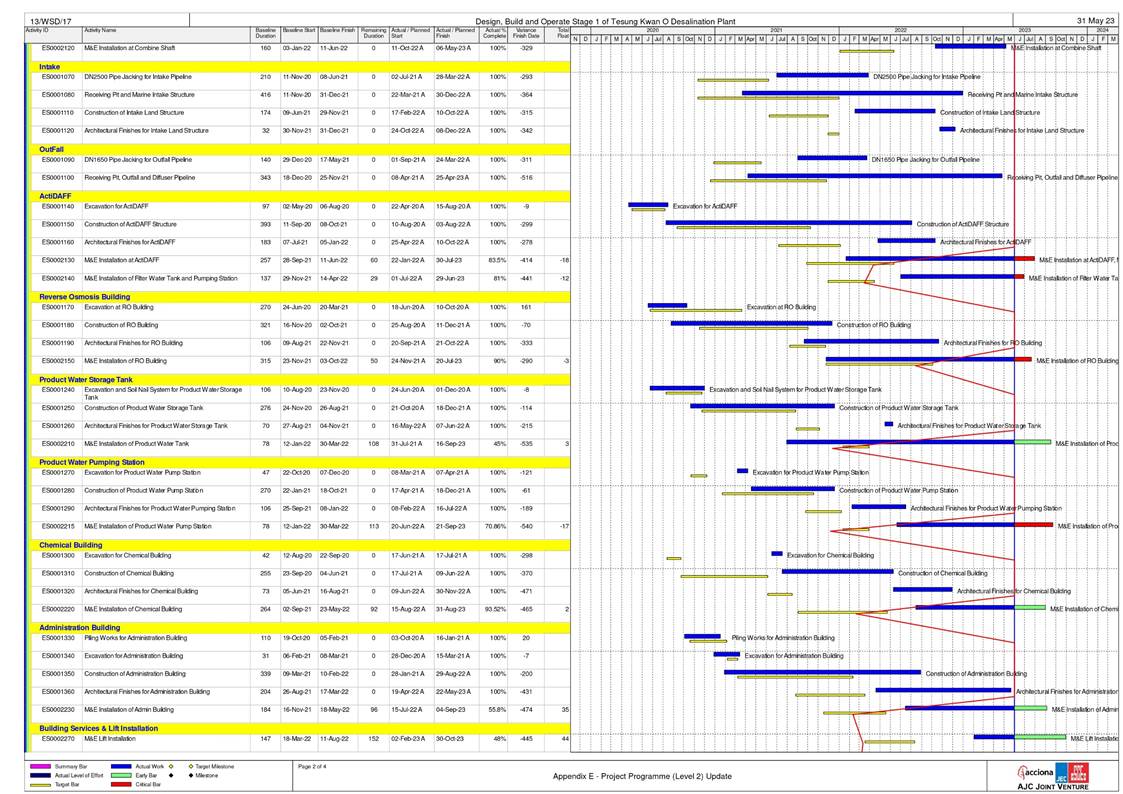

1.7. Details of the major construction activities undertaken in this reporting period are shown below. The master programme is presented in Appendix A.
1.8. Key activities carried out in this reporting period for the Contract included the followings:
Administration Building - Installation of glass balustrade, metal cladding, building services, electrical switchboard, lift, cable laying - carrying out interior finishes at 2/F, 3/F and 4/F - Construction of block wall in the pipe duct. |
||||
Chemical building - Installation of handrail, permanent equipment, and cable laying - Underground utility construction work |
doors, |
building |
services, |
mechanical |
Main Electrical & Central Chiller Plant Building - Construction of fuel tank room - Installation metal Doors, chillers, building services, electrical switchboard, cable laying |
ActiDAFF - Underground utility construction work - Laying of roof floor screed and tiles - Construction of plinths for saturator tanks - Erection and dismantling of scaffolding, installation of mechanical equipment and piping, bubble test - Installation of underdrain |
Product Water Storage Tank Building - Resin Injection Work & Water Test for 1 Water Tanks - Installation of cat ladders in Water Tanks, and door -
Installation of louvres, metal cladding, building services, cable laying, mechanical equipment, steel pipe - Underground utility construction |
OSCG Building - Installation of Design for Manufacturing and Assembly (DfMA) Panel and metal door - Underground utility construction work - Installation of building services and mechanical equipment |
Reverse Osmosis Building - Installation of Design for Manufacturing and Assembly (DfMA) Panels at East Sides - Installation of metal door, metal cladding, hand railings, Louvres & Windows - Installation of building services, electrical switchboard, mechanical equipment, steel pipe, Glass Reinforced Plastics (GRP) pipe and cable laying - Underground utility construction work |
Post Treatment Building - Installation of Louvres & Windows, metal door and cat ladders - Installation of Design for Manufacturing and Assembly (DfMA) Panels - Installation of building services, mechanical equipment and GRP pipe - Underground utility construction work |
Inspection corridor - Construction of bondek for segments 7 - construction of staircase 8 |
CO2 Tanks - Installation of pipes and building services Outfall Shaft -
GRP Diffuser Pipe
installation and rock material backfill Combined Shaft -
Installation of building services, electrical equipment, switchboard, cable
laying, mechanical equipment and pipes, stoplogs and band screens - Underground utility construction work |
-
Staircases and internal finishing Pump room - internal finishing and screeding Other -
Excavation works, access erection, soil anchor installation and grouting construction works
at the slope
toe -
Foundation & structure construction at Elevated Walkway - Watermain works at CLP 132 kV Substation -
Concrete Breaking, structure construction of Wave Deflector Wall at
seawall area |
1.9. A summary of the valid permits, licences, and/or notifications on environmental protection for this Contract is presented in Table 1.2.
Table 1.2 Summary of
the Status of Valid Environmental Licence, Notification, Permit and Documentations
Permit/ Licences |
Valid Period |
Status |
Remark |
|
From |
To |
|||
Environmental Permit |
||||
EP-503/2015/A |
Throughout the Contract |
Valid |
- |
|
FEP - 01/503/2015/A |
Throughout the Contract |
Valid |
- |
|
Notification of Construction Works under the Air Pollution Control (Construction Dust) Regulation (Form NA) |
||||
451539 |
Throughout the Contract |
Valid |
- |
|
Billing Account for Disposal of Construction Waste |
||||
7036276 |
Throughout the Contract |
Valid |
- |
|
Chemical Waste Producer Registration |
||||
5213-839-A2987-01 |
Throughout the Contract |
Valid |
- |
|
Wastewater Discharge Licence (Land and Marine works) |
||||
WT00035775-2020 |
23/08/2021 |
31/07/2025 |
Valid |
- |
WT00044188-2023 |
16/06/2023 |
30/06/2028 |
Valid |
For Plant T&C and operation |
Marine Dumping Permits |
||||
EP/MD/23-122 |
31/03/2023 |
30/06/2023 |
Expired in the reporting period |
- |
Construction Noise Permit |
||||
GW-RE1338-22 |
22/12/2022 |
21/06/2023 |
Expired in the reporting period |
- |
Permit/ Licences |
Valid Period |
Status |
Remark |
|
From |
To |
|||
GW-RE0640-23 |
22/06/2023 |
21/12/2023 |
Valid |
- |
1.10. The status for all environmental aspects is presented in Table 1.3.
Table 1.3 Summary of
Status for Key Environmental Aspects under the EM&A Manual
Parameters |
Status |
Water Quality |
|
Baseline Monitoring under EM&A Manual |
The baseline water quality monitoring was conducted between 12 May 2020 to 6 Jun 2020. |
Impact Monitoring |
On-going |
Noise |
|
Baseline Monitoring |
The baseline noise monitoring result has been reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4 |
Impact Monitoring |
On-going |
Waste Management |
|
Mitigation Measures in Waste Management Plan |
On-going |
Landfill Gas |
|
Regular Monitoring when construction works are within the 250 m Consultation Zone |
On-going |
Environmental Audit |
|

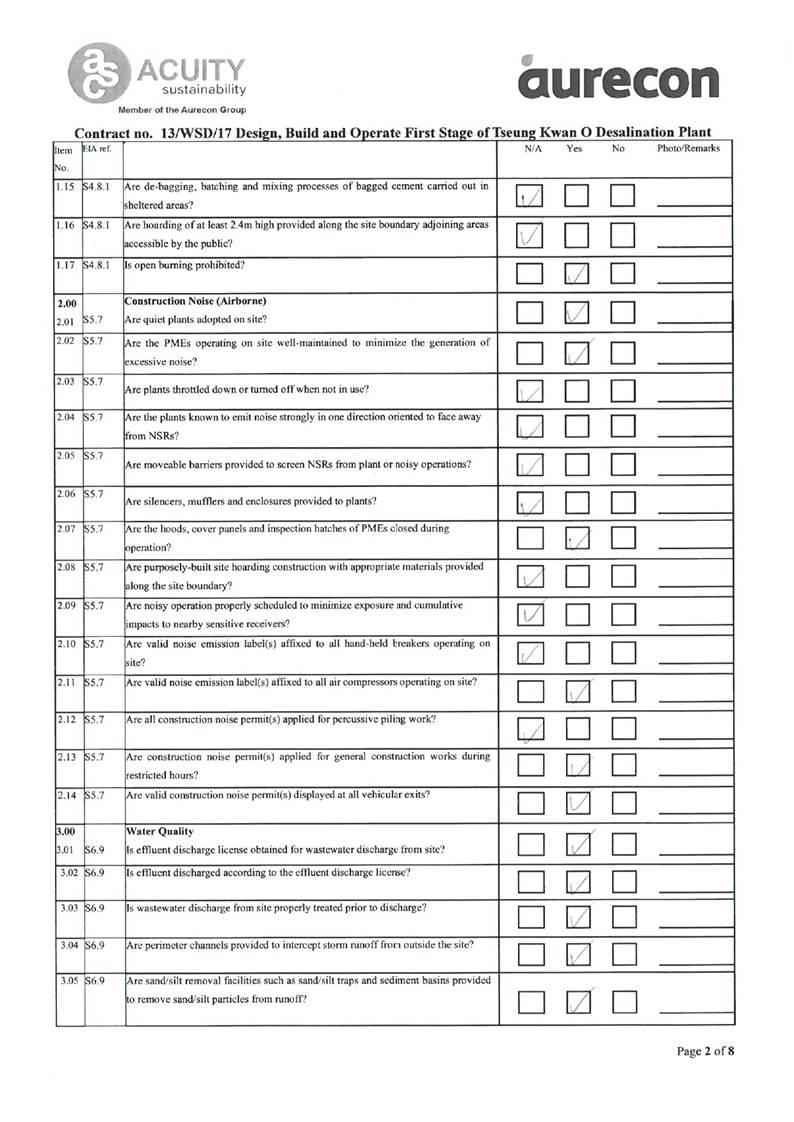

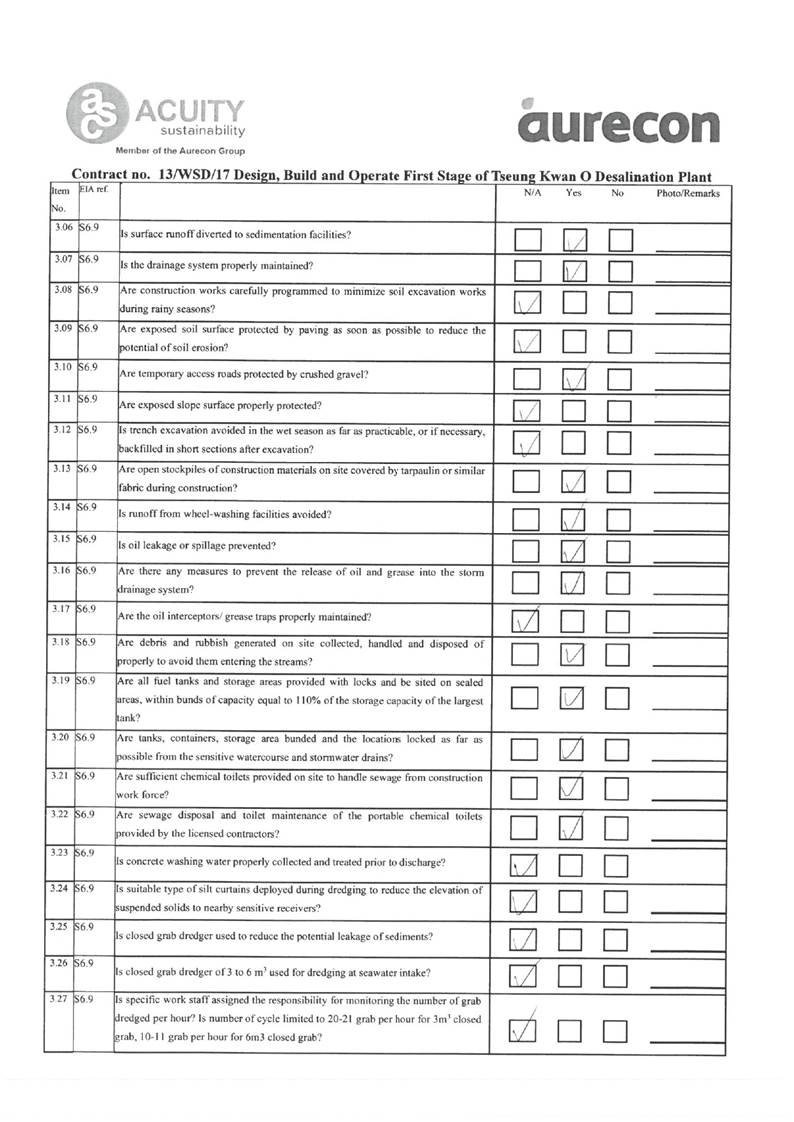

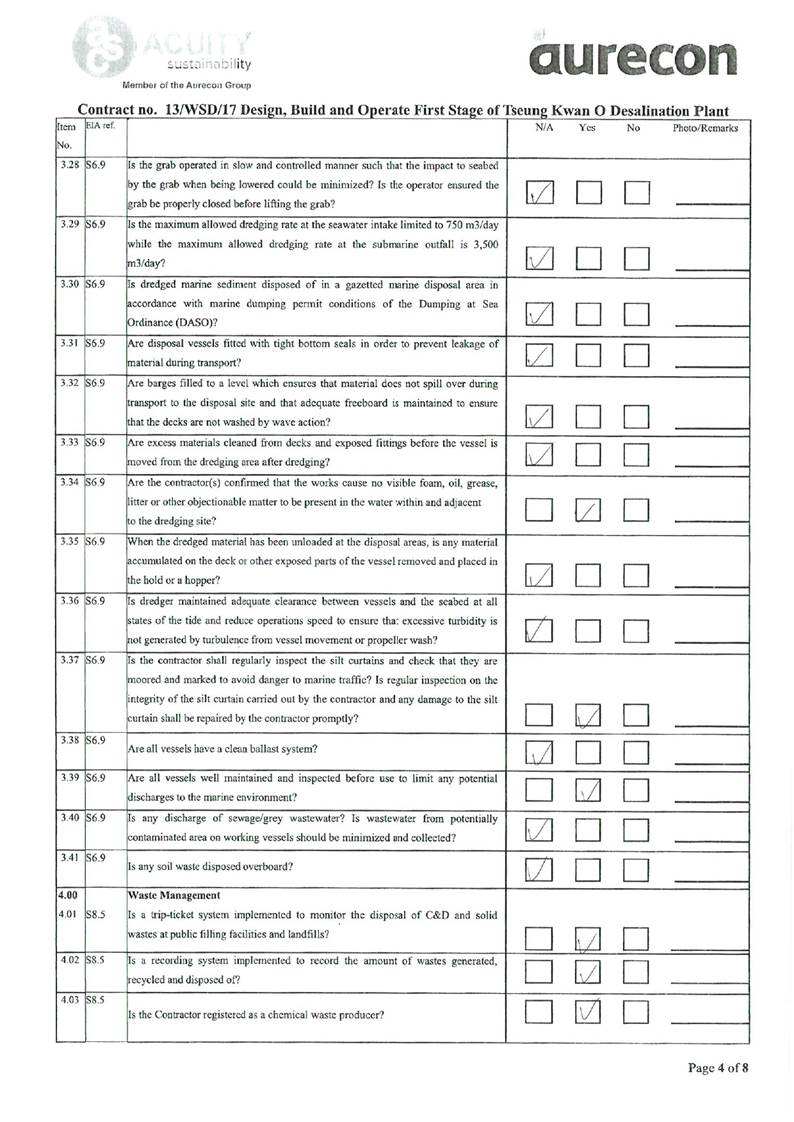

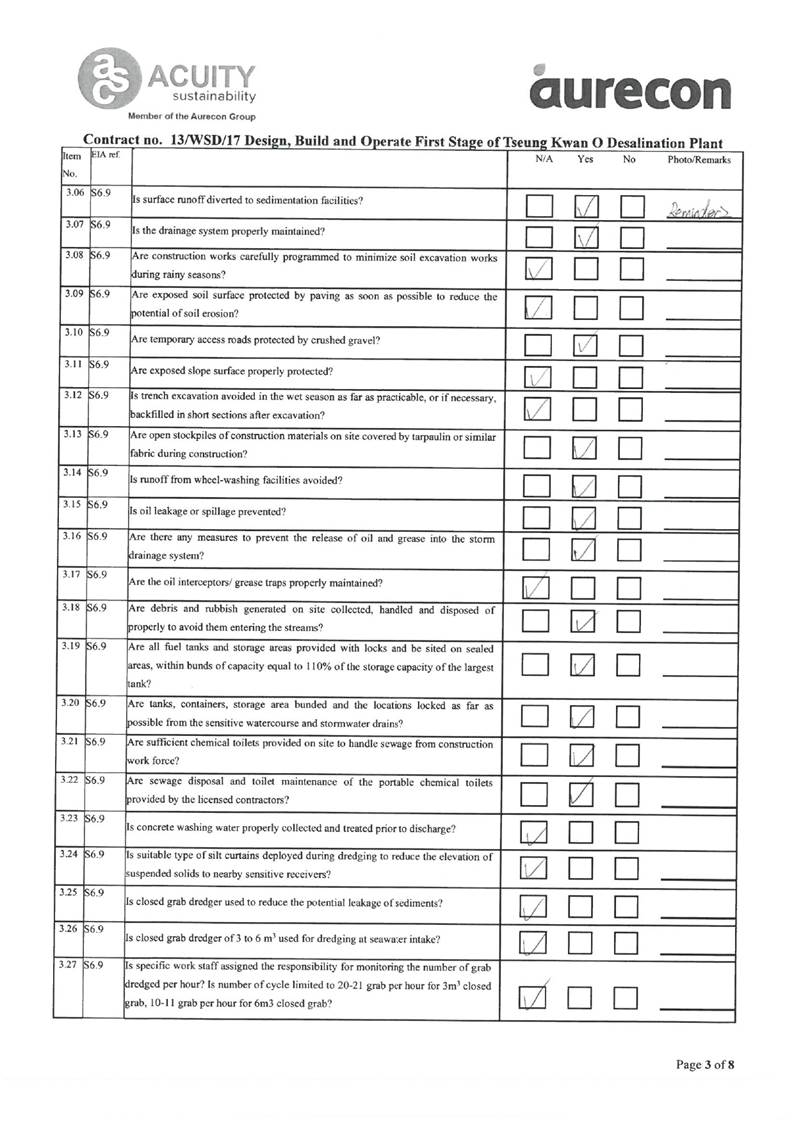

Site Inspection covering Measures of Air Quality, Noise Impact, Water Quality, Waste, Ecological Quality, Fisheries, Landscape and Visual |
On-going |
1.11. Other than the EM&A work by ET, environmental briefings, trainings, and regular environmental management meetings were conducted, in order to enhance environmental awareness and closely monitor the environmental performance of the contractors.
1.12. The EM&A programme has been implemented in accordance with the recommendations presented in the approved EIA Report and the EM&A Manual. A summary of implementation status of the environmental mitigation measures for the construction phase of the Contract during the reporting period is provided in Appendix C.
2.
Noise
Monitoring Requirements
2.1. To ensure no adverse noise impact, noise monitoring is recommended to be carried out within 300m radius from the nearby noise sensitive receivers (NSRs), during construction phase. The NSRs selected as monitoring station are (i) NSR4 - Creative Secondary School, (ii) NSR24 - PLK Laws Foundation College, and (iii) NSR31 - School of Continuing and Professional Studies - CUHK respectively.
2.2. Construction noise level were measured in terms of the A-weighted equivalent continuous sound pressure level (LAeq). Leq 30min was used as the monitoring parameter for the time period between 0700 and 1900 on normal weekdays. Construction works would follow stipulations of the valid Construction Noise Permits if works had to be conducted during restricted hours or public holidays. Table 2.1 summarizes the monitoring parameters, frequency, and duration of the impact noise monitoring.
Table
2.1 Noise Monitoring Parameters, Time, Frequency and Duration
Time |
Duration |
Interval |
Parameters |
Daytime: 0700-1900 |
Day time: 0700-1900 (during normal weekdays) |
Continuously in Leq 5min/Leq 30min (average of 6 consecutive Leq 5min) |
Leq 30min L10 30min & L90 30min |
Monitoring Locations
2.3. The monitoring locations were normally made at a point 1m from the exterior of the NSRs building façade and be at a position 1.2m above the ground. A correction of +3dB(A) should be made to the free-field measurements.
2.4. According to the environmental findings detailed in the EIA report and Baseline Monitoring Report, the designated locations for the construction noise monitoring are listed in Table 2.2 below.
Table
2.2 Noise
Sensitive Receivers
NSR ID |
Noise Sensitive Receivers |
Monitoring Location |
Position |
NSR 4 |
Creative Secondary School |
Roof Floor |
1 m from facade |
NSR 24 |
PLK Laws Foundation College |
Pedestrian Road on Ground Floor |
Free-field |
NSR 31 |
School of Continuing and Professional Studies - CUHK |
Roof Floor |
1 m from facade |
2.5. Three noise monitoring locations for impact monitoring at the nearby sensitive receivers are shown in Figure 2.1-2.3.
|
Figure 2.1 NSR4 Creative Secondary School |
|
Figure 2.2 NSR24 PLK Laws Foundation College |
|
Figure 2.3 NSR31 School of Continuing and Professional Studies - CUHK |
Impact Monitoring Methodology
2.6. Integrated sound level meter will be used for the noise monitoring. The meter will be in compliance with the International Electrotechnical Commission Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications. Immediately prior to and following each noise measurement the accuracy of the sound level meter will be checked using an acoustic calibrator generating a known sound pressure level at a known frequency. Measurements will be accepted as valid only if the calibration levels before and after the noise measurements agree to within 1.0 dB(A).
2.7. Noise measurements were not made in the presence of fog, rain, wind with a steady speed exceeding 5 m/s or wind with gusts exceeding 10 m/s. The wind speed shall be checked with a portable wind speed meter capable of measuring the wind speed in m/s.
Action and Limit Levels
2.8. The Action/Limit Levels are in line with the criteria of Practice Note for Professional Persons (ProPECC PN 2/93) ¡§Noise from Construction Activities - Non-statutory Controls¡¨ and Technical Memorandum on Environmental Impact Assessment Process issued by HKSAR Environmental Protection Department [¡§EPD¡¨] under the Environmental Impact Assessment Ordinance, Cap 499, S.16 are presented in Table 2.3.
Table 2.3 Action and Limit Levels for Noise per EM&A Manual
Time Period |
Action |
Limit (dB(A)) |
0700-1900 on normal weekdays |
When one documented complaint is received from any one of the noise sensitive receivers |
- 70 dB(A) for school and - 65 dB(A) during examination period |
Note:
Limits
specified
in
the
GW-TM
and
IND-TM
for
construction
and
operation
noise,
respectively.
2.9.
If exceedances were found during noise monitoring, the actions in accordance with the Event and Action Plan shall be carried out according to Appendix E.
Monitoring Results and Observations
2.10. Referring to EM&A Manual Section 4.1.2, the impact noise monitoring should be carried out when there are Contract-related construction activities undertaken within a radius of 300m from the monitoring stations. No monitoring station was located within a radius of 300m of the Contract site as shown in Figure 2.4, no impact noise monitoring was conducted in the reporting period.
Figure 2.4 Site Layout Plan with Noise Sensitive Receivers and Desalination Plant
3.
Water Quality
3.1.
In accordance with
the
recommendations of the
EIA,
water
quality
monitoring is required during
dredging for the
submarine pipelines and,
during
operation phase. The
following Section provides details of the water quality monitoring
