Revision History
Rev. |
Description of Modification |
Date |
A. |
First Issue for Comments |
09/05/2023 |
B. |
Revised according to IEC’s and SOR’s comments |
16/05/2023 |
6. Summary of Exceedance, Complaints, Notification of Summons and Prosecutions.......... 29
Appendix B Overview of Desalination Plant in Tseung Kwan O
Appendix C Summary of Implementation Status of Environmental Mitigation Appendix D Impact Monitoring Schedule
Appendix E Event/Action Plan
Appendix F Water Quality and Landfill Gas Equipment Calibration Certificate Appendix G Water Quality and Landfill Gas Monitoring Data
Appendix H Waste Flow Table
Appendix I Site Inspection Proforma
Appendix J Complaint Log
Appendix K Exceedance Report(s)
Executive Summary
Introduction
A1. The Project, Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (TKODP), is a Designated Project under the Environmental Impact Assessment Ordinance (Cap. 499) (EIAO) and is currently governed by a Further Environmental Permit (EP No. FEP - 01/503/2015/A) for the construction and operation of the Contract.
A2. In accordance with the Environmental Monitoring and Audit (EM&A) Manual for the Contract, EM&A works for marine water quality, noise, waste management and ecology should be carried out by Environmental Team (ET), Acuity Sustainability Consulting Limited (ASCL), during the construction phase of the Contract.
A3. This is the 38th Monthly EM&A Report, prepared by ASCL, for the Contract summarizing the monitoring results and audit findings of the EM&A programme at and around Tseung Kwan O Area 137 (TKO 137) during the reporting period from 1 April to 30 April 2023.
A4. The EM&A programme for this contract has covered environmental monitoring on construction noise level at selected NSRs and Contractor’s environmental performance auditing in the aspects of construction dust, construction noise, water quality, waste management, Landscape and Visual and Ecology.
Summary of Main Works Undertaken & Key Mitigation Measures Implemented
A5. Key activities carried out in this reporting period for the Contract included the followings:
Administration Building - Installation of glass balustrade, metal cladding, building services, electrical switchboard, lift, cable laying - carrying out interior finishes at 2/F, 3/F and 4/F - Construction of block wall in the pipe duct. |
||||
Chemical building - Installation of handrail, permanent euipment, and cable laying - Underground utility construction work |
doors, |
building |
services, |
mechanical |
Main Electrical & Central Chiller Plant Building - Construction of fuel tank room - Installation metal Doors, chillers, building services, electrical switchboard, cable laying |
||||
ActiDAFF - Underground utility construction work - Laying of roof floor screed and tiles - Construction of plinths for saturator tanks |
- Erection and dismantling of scaffolding, installation of mechanical equipment and piping, bubble test - Installation of underdrain |
Product Water Storage Tank Building - Resin Injection Work & Water Test for 1 Water Tanks - Installation of cat ladders in Water Tanks, and door -
Installation of louvres, metal cladding, building services, cable laying, mechanical equipment, steel pipe - Underground utility construction |
OSCG Building - Installation of Design for Manufacturing and Assembly Panel and metal door - Underground utility construction work - Installation of building services and mechanical equipment |
Reverse Osmosis Building - Installation of Design for Manufacturing and Assembly Panels at East Sides - Installation of metal door, metal cladding, hand railings, Louvres & Windows - Installation of building services, electrical switchboard, mechanical equipment, steel pipe, Glass Reinforced Plastics (GRP) pipe and cable laying - Underground utility construction work |
Post Treatment Building - Installation of Louvres & Windows, metal door and cat ladders - Installation of Design for Manufacturing and Assembly Panels - Installation of building services, mechanical equipment and GRP pipe - Underground utility construction work |
Inspection corridor - Construction of bondek for segments 7 - construction of staircase 8 |
CO2 Tanks - Installation of pipes and building services Outfall Shaft -
GRP Diffuser Pipe
installation and rock material back fill Combined Shaft -
Installation of building services, electrical equipment, switchboard, cable
laying, mechanical equipment and pipes, stoplogs and band screens - Underground utility construction work -
Staircases and internal finishing Pump room - internal finishing and screeding Other -
Excavation at slope toe and access erection, Soil anchor and grouting construction |
-
Foundation & structure construction at Elevated Walkway - Watermain works at 132 kV -
Concrete Breaking, Structure Construction at Seawall |
A6. The major environmental impacts brought by the above construction works include:
- Construction dust and noise generation from construction works, excavation works, rock cutting works and pipe piling driving works;
- Waste generation from the construction activities; and
- Impact on water quality from marine construction works and inland construction works.
A7. The key environmental mitigation measures implemented for the Contract in this reporting period associated with the above construction works include:
- Dust suppression by regular wetting and water spraying for construction works;
- Reduction of noise from equipment and machinery on-site and regular inspection to machinery and plants/vehicles on-site to ensure proper functioning;
- Deployment of temporary silt curtain in the area where marine construction works were conducted and deployment of water sedimentation tanks for treatment of wastewater at inland and marine areas before discharge; and
- Sorting and storage of general refuse and construction waste; and
Summary of exceedance & investigation & follow-up
A8. No noise monitoring was conducted during the reporting period since there are no Contract -related construction activities undertaken within a radius of 300m from the monitoring locations. No exceedance of the action Level was recorded during the reporting period.

A9. The EM&A works for water quality were conducted during the reporting period in accordance with the EM&A Manual.

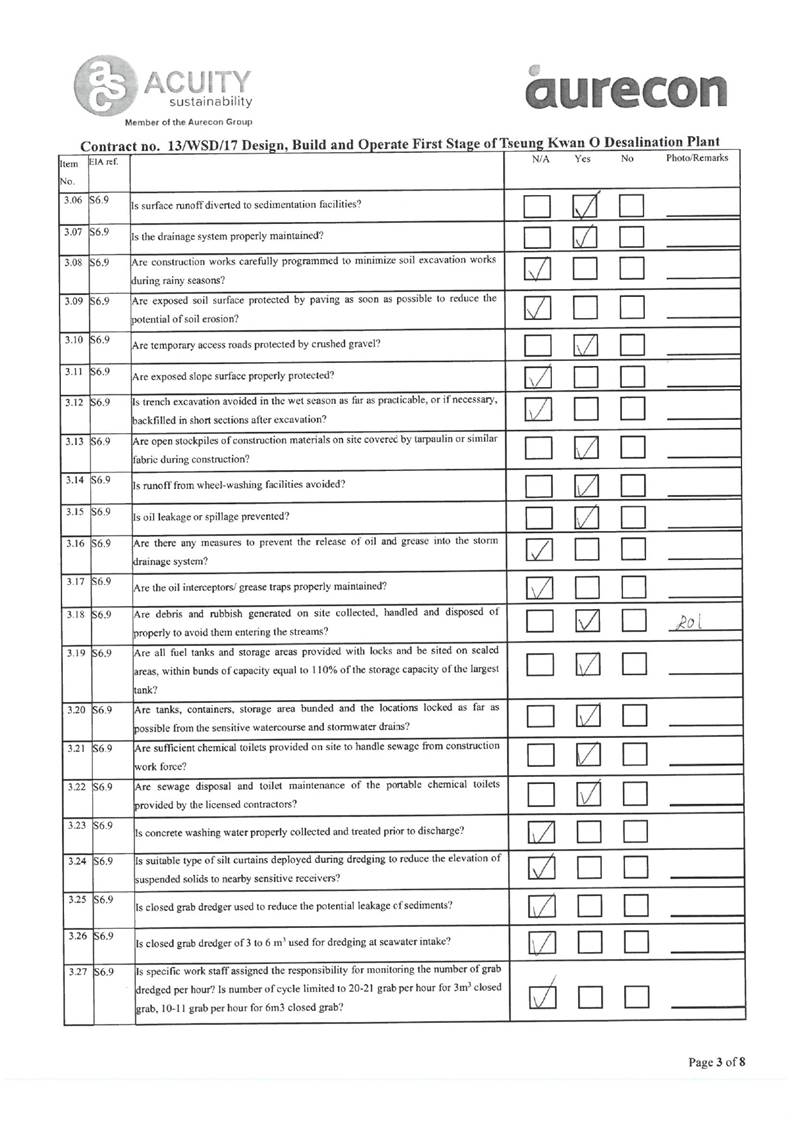

A10. Thirty-two (32) of the general water quality monitoring results of Suspended Solids (SS) obtained had exceeded the Action Level. Twenty-three (23) of the general water quality monitoring results of SS obtained during the reporting period had exceeded the Limit Level.
A11. Investigation on the reason of exceedance has been carried out, where the exceedances of SS on 1, 4, 6, 8, 11, 13, 15, 18 and 20 April 2023 were concluded to be unrelated to the Contract as detailed in the Incident Reports on Action Level or Limit Level Non- compliance along with supporting materials in Appendix K.

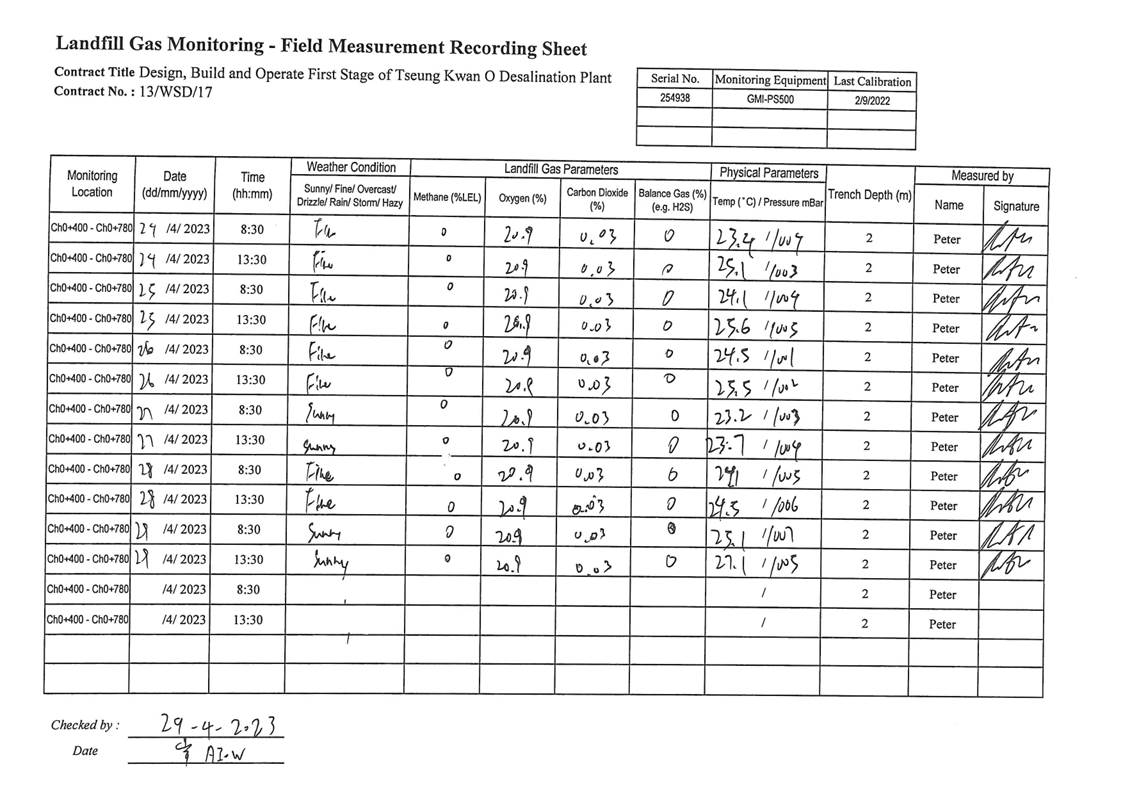

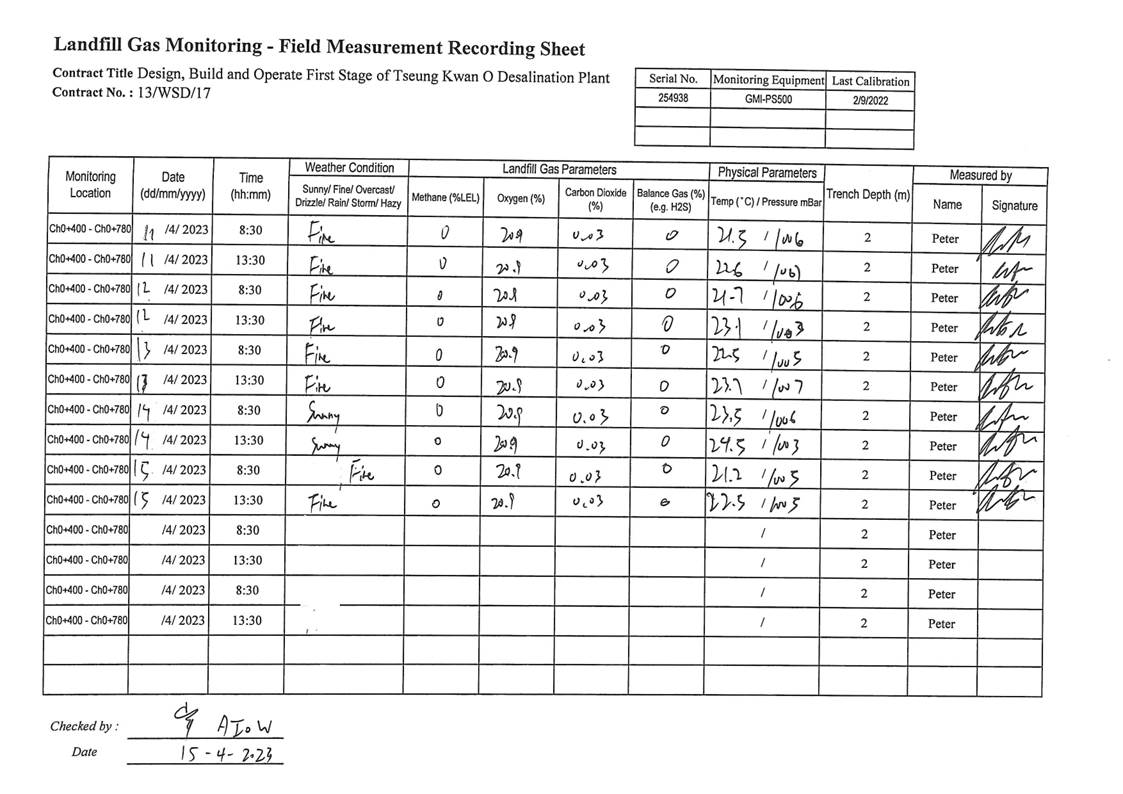

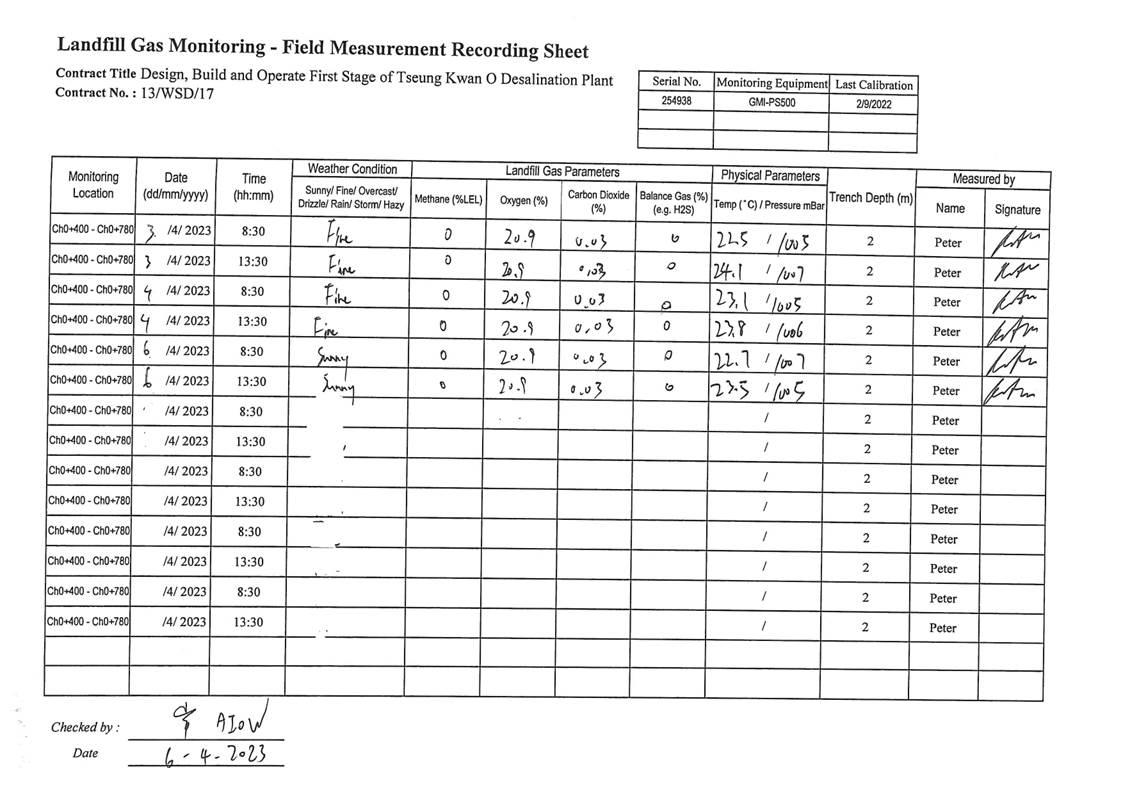

A12. In this reporting period, 40 times of landfill gas monitoring were conducted at TKO Area 137 (Ch0+400 - Ch0+780). No action or limit level exceedance was recorded during the reporting period.

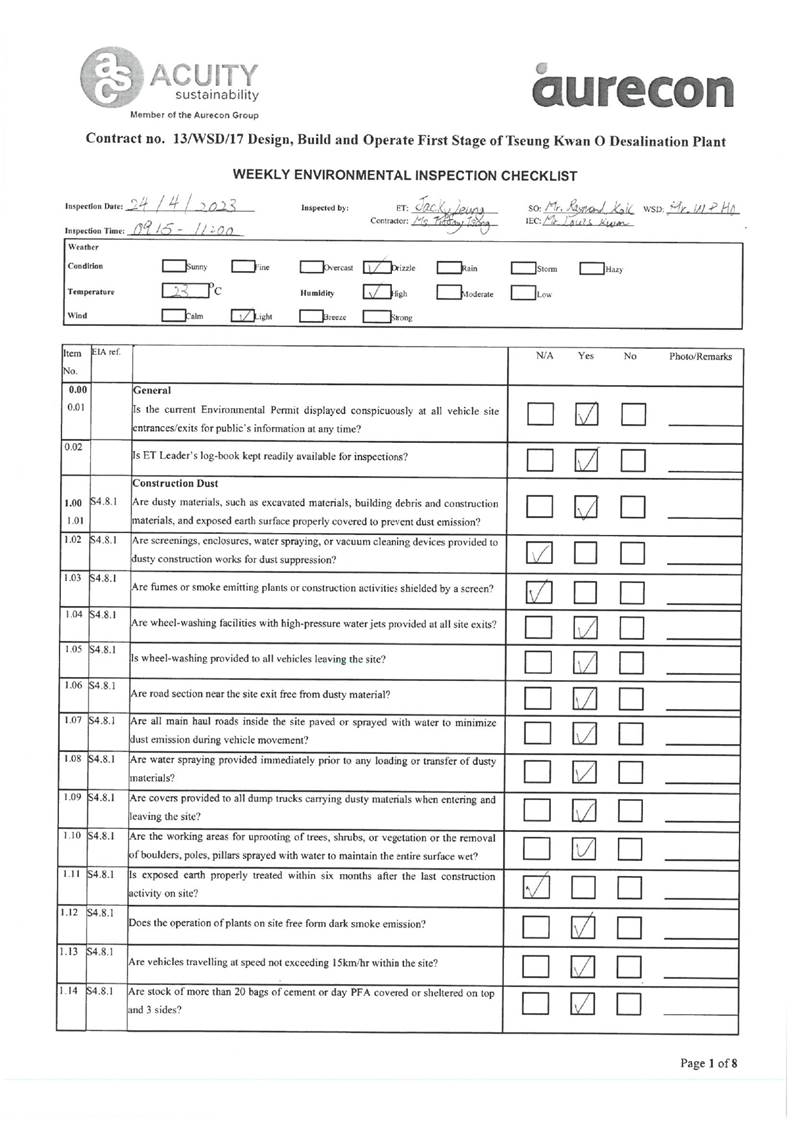

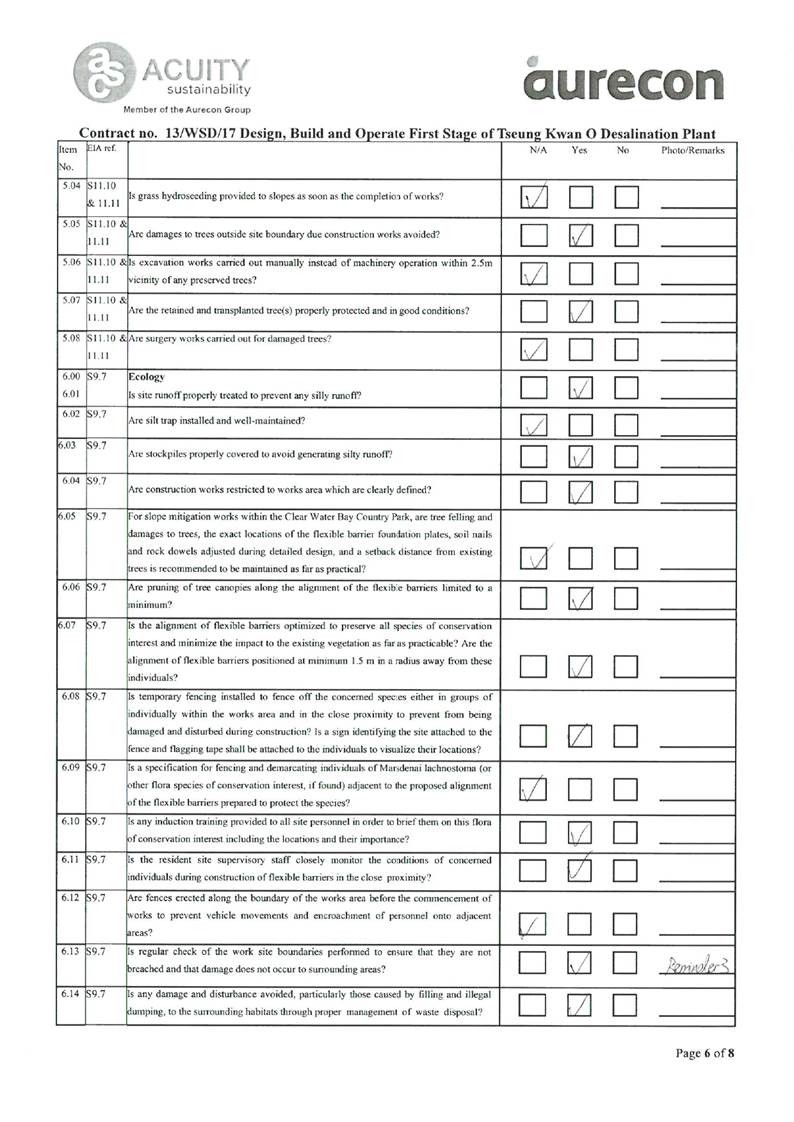

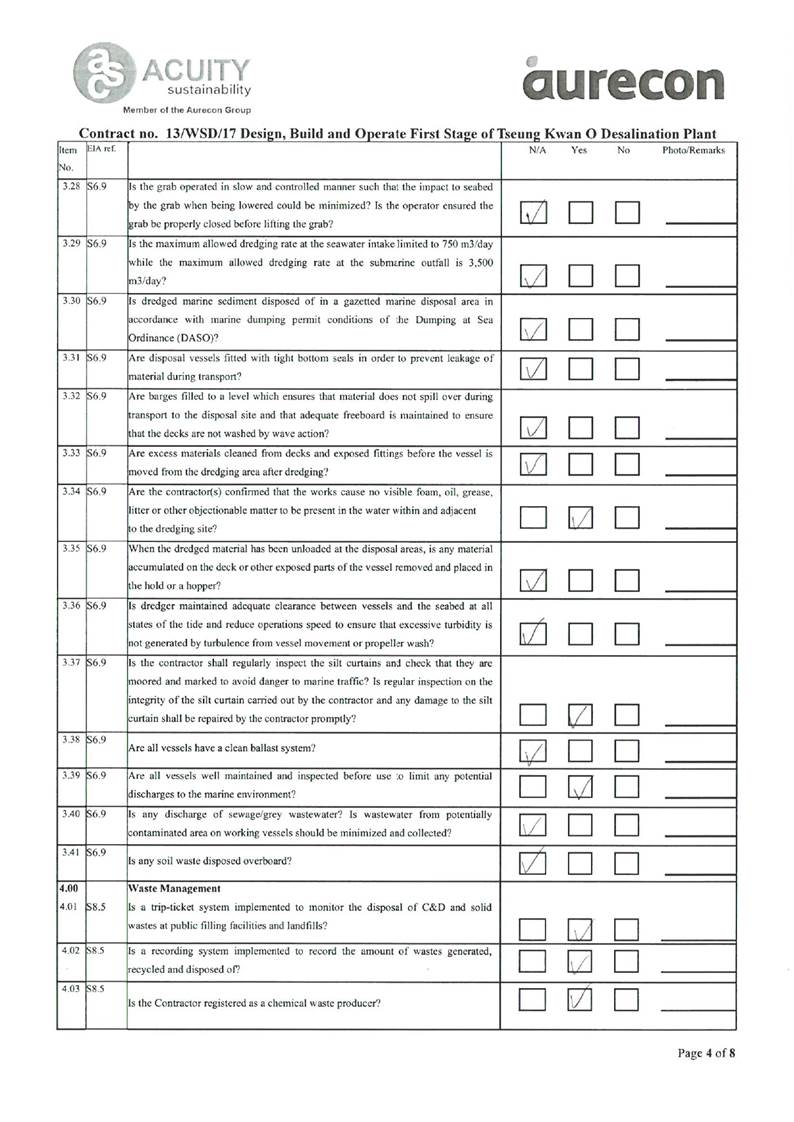

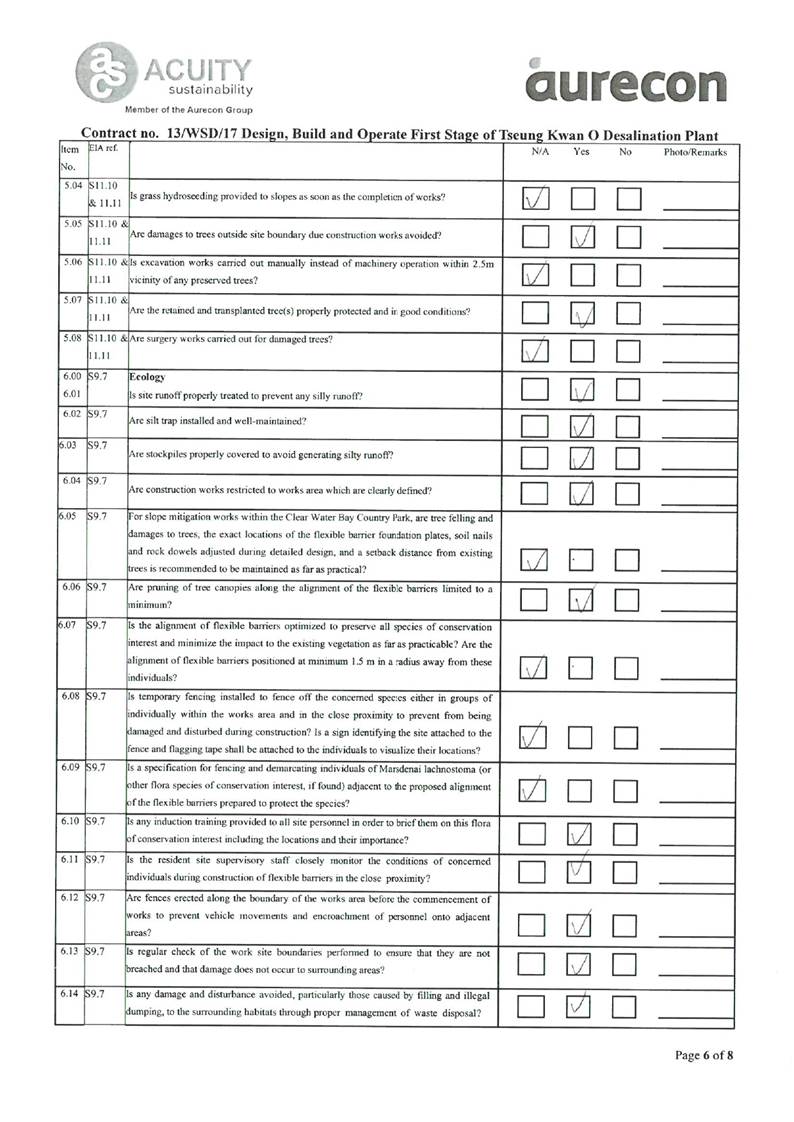

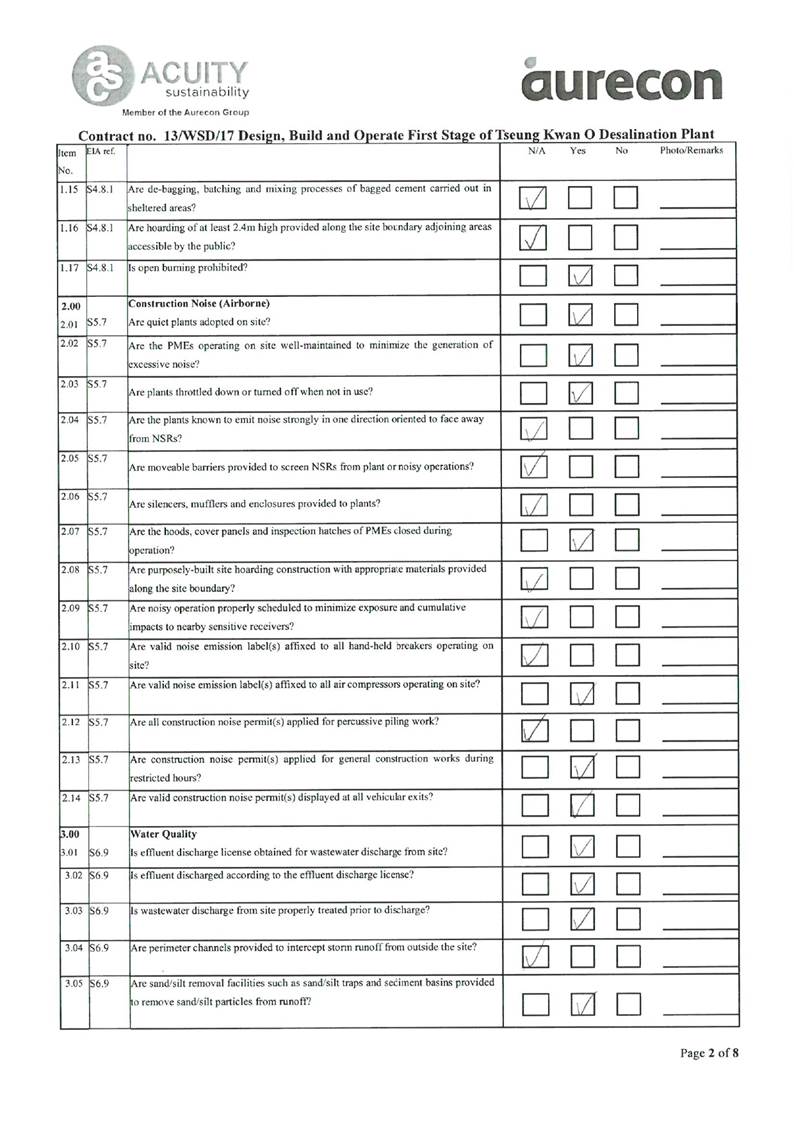

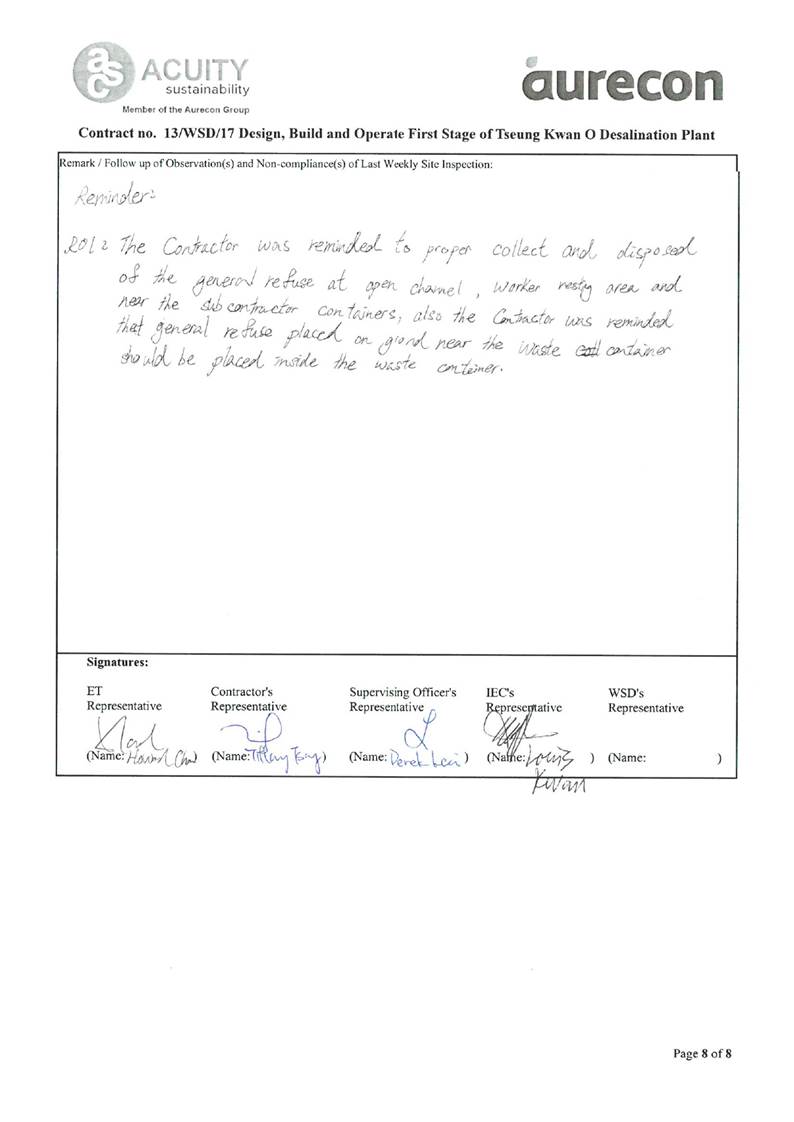

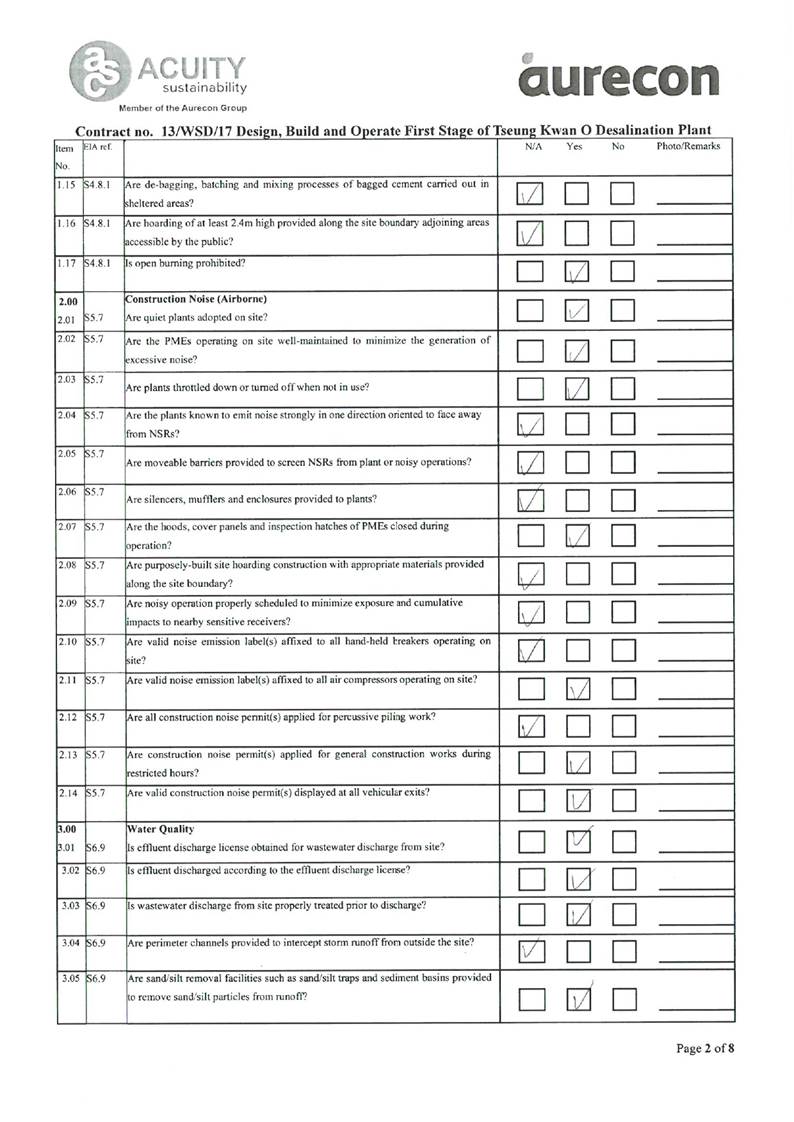

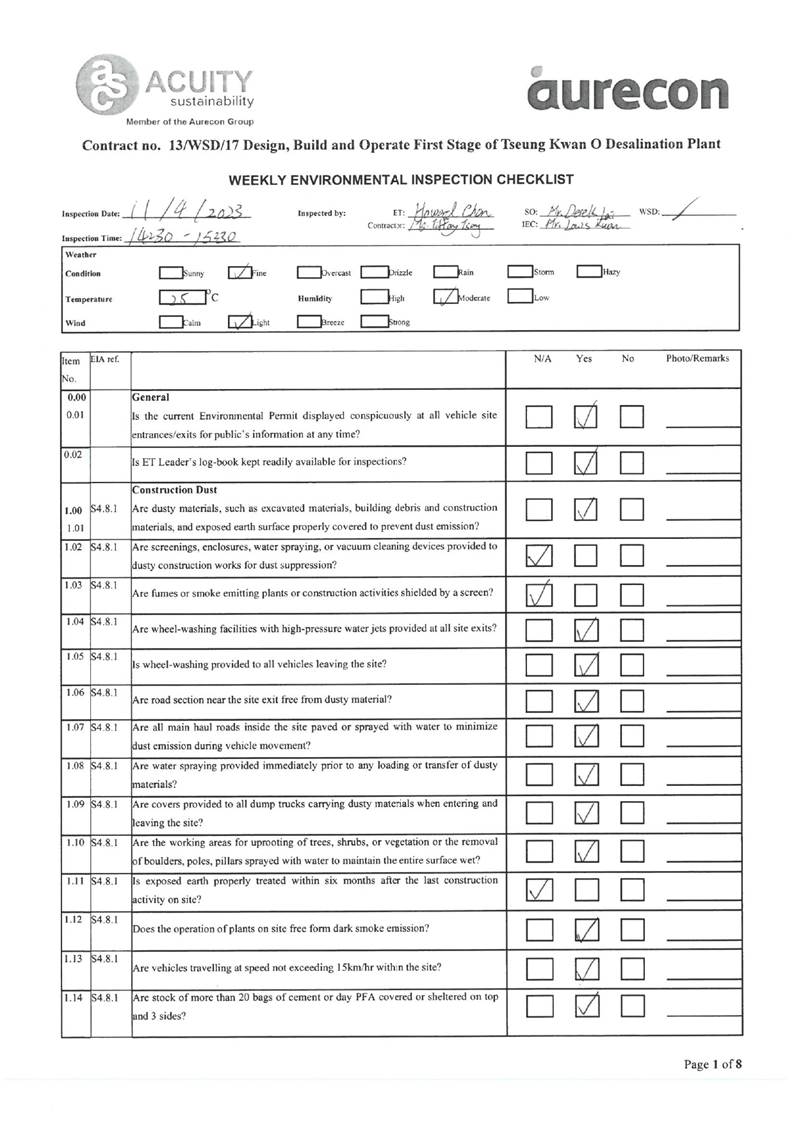

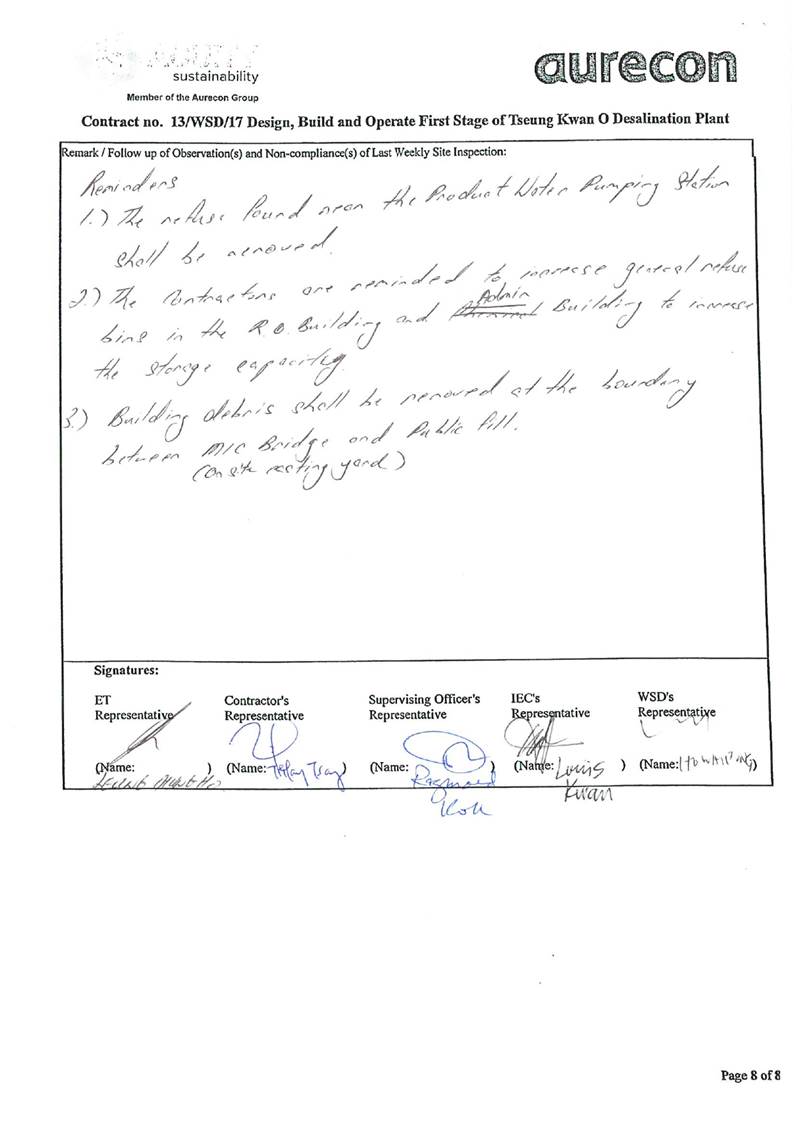

A13. Joint site inspections of the construction work by ET and IEC were carried out on 4, 11,
18 and 24 April 2023 to audit the mitigation measures implementation status. Observations and recommendations were recorded in the site inspection checklists and provided to the contractors together with the appropriate follow-up actions where necessary.

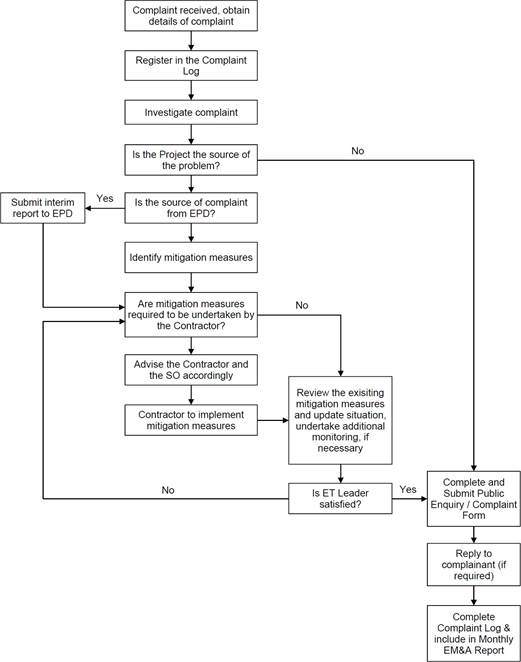

Complaint Handling and Prosecution
A14. No environmental complaint, notification of summons and prosecution was received in the reporting period.
Reporting Change
A15. There was no change to be reported that may affect the on-going EM&A programme.
Summary of Upcoming Key Issues and Key Mitigation Measures
A16. Key activities anticipated in the next reporting period for the Contract will include the followings:
Administration Building - Installation of glass balustrade, metal cladding, building services, electrical switchboard, lift, cable laying - carrying out interior finishes at 2/F, 3/F and 4/F - Construction of block wall in the pipe duct. |
Chemical building - Installation of handrail, permanent doors, building services, mechanical equipment, and cable laying - Underground utility construction work |
Main Electrical & Central Chiller Plant Building - Construction of fuel tank room - Installation metal Doors, chillers, building services, electrical switchboard, cable laying |
ActiDAFF - Underground utility construction work - Laying of roof floor screed and tiles - Construction of plinths for saturator tanks - Erection and dismantling of scaffolding, installation of mechanical equipment and piping, bubble test - Installation of underdrain |
Product Water Storage Tank Building - Resin Injection Work & Water Test for 1 Water Tanks - Installation of cat ladders in Water Tanks, and door - Installation of louvres, metal cladding, building services, cable laying, mechanical equipment, steel pipe - Underground utility construction |
OSCG Building - Installation of Design for Manufacturing and Assembly Panel and metal door - Underground utility construction work - Installation of building services and mechanical equipment |
Reverse Osmosis Building - Installation of Design for Manufacturing and Assembly Panels at East Sides - Installation of metal door, metal cladding, hand railings, Louvres & Windows - Installation of building services, electrical switchboard, mechanical equipment, steel pipe, Glass Reinforced Plastics (GRP) pipe and cable laying - Underground utility construction work |
Post Treatment Building - Installation of Louvres & Windows, metal door and cat ladders - Installation of Design for Manufacturing and Assembly Panels - Installation of building services, mechanical equipment and GRP pipe - Underground utility construction work |
Inspection corridor - Construction of bondek for segments 7 - construction of staircase 8 |
CO2 Tanks - Installation of pipes and building services Outfall Shaft -
GRP Diffuser Pipe
installation and rock material back fill Combined Shaft -
Installation of building services, electrical equipment, switchboard, cable
laying, mechanical equipment and pipes, stoplogs and band screens - Underground utility construction work -
Staircases and internal finishing Pump room - internal finishing and screeding Other -
Excavation at slope toe and access erection, Soil anchor and grouting construction -
Foundation & structure construction at Elevated Walkway - Watermain works at 132 kV -
Concrete Breaking, Structure Construction at Seawall |
A17. The major environmental impacts brought by the above construction works will include:
- Construction dust and noise generation from excavation and construction works;
- Waste generation from construction activities; and
- Impact on water quality from marine construction works and inland construction works.
A18. The key environmental mitigation measures for the Contract in the coming reporting period associated with the above construction works will include:
- Reduction of noise from equipment and machinery on-site;
- Dust suppression by regular wetting and water spraying for construction works and at main haul road;
- Sorting and storage of general refuse and construction waste; and
- Deployment of temporary silt curtain in the area where marine construction works were conducted and deployment of water sedimentation tanks for treatment of wastewater at inland and marine areas before discharge.
1.
Basic Contract Information
Background
1.1. The Acciona Agua, S.A. Trading, Jardine Engineering Corporation, Limited and China State Construction Engineering (Hong Kong) Limited as AJC Joint Venture (AJCJV) is contracted to carry out the Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (DPTKO) under Contract No. 13/WSD/17 (the Contract).
1.2. Acuity Sustainability Consulting Limited (ASCL) is commissioned by AJCJV to undertake the Environmental Team (ET) services as required and/or implied, both explicitly and implicitly, in the Environmental Permit (EP), Environmental Impact Assessment Report (EIA Report) (Register No. AEIAR-192/2015) and Environmental Monitoring and Audit Manual (EM&A Manual) for the Contract; and to carry out the Environmental Monitoring and Audit (EM&A) programme in fulfillment of the EIA Report’s EM&A requirements and Contract No. 13/WSD/17 Specification requirements.
1.3. Pursuant to the Environmental Impact Assessment Ordinance (EIAO), the Director of Environmental Protection granted the Environmental Permit (No. EP-01/503/2015) and Variation of Environmental Permit (No. EP-01/503/2015/A) to Water Supplies Department (WSD); and granted the Further Environmental Permit (No. FEP- 01/503/2015/A) to AJCJV for the Contract.
The Reporting Scope
1.4. This is the 38th Monthly EM&A Report for the Contract which summarizes the key findings of the EM&A programme during the reporting period from 1 April to 30 April 2023.
Contract Organization

1.5. The Contract Organization structure for Construction Phase is presented in Figure 1.1.

Figure 1.1 Contract
Organization Chart
1.6. Contact details of the key personnel are presented in Table 1.1 below:
Table 1.1 Contact Details of Key Personnel
Party |
Position |
Name |
Telephone no. |
Contract Proponent (Water Supplies Department) |
SE/CM2 |
Milton Law |
2634-3573 |
Supervising Officer (Binnies Hong Kong Limited) |
Project Manager |
Christina Ko |
2608-7302 |
Chief Resident Engineer |
Roger Wu |
6343-1002 |
|
The Jardine Engineering Corporation, Limited, China State Construction Engineering (Hong Kong) Limited and Acciona Agua, S.A. Trading |
Project Manager |
Stephen Yeung |
2807-4665 |
Environmental Monitoring Manager |
Brian Kam |
9456-9541 |
|
Acuity Sustainability Consulting Limited |
Environmental Team Leader |
Jacky Leung |
2698-6833 |
ANewR Consulting Limited |
Independent Environmental Checker (IEC) |
Louis Kwan |
2618-2831 |
Summary of Construction Works

1.7. Details of the major construction activities undertaken in this reporting period are shown below. The master programme is presented in Appendix A.
1.8. Key activities carried out in this reporting period for the Contract included the followings:
Administration Building - Installation of glass balustrade, metal cladding, building services, electrical switchboard, lift, cable laying - carrying out interior finishes at 2/F, 3/F and 4/F - Construction of block wall in the pipe duct. |
||||
Chemical building - Installation of handrail, permanent equipment, and cable laying - Underground utility construction work |
doors, |
building |
services, |
mechanical |
Main Electrical & Central Chiller Plant Building - Construction of fuel tank room - Installation metal Doors, chillers, building services, electrical switchboard, cable laying |
ActiDAFF - Underground utility construction work - Laying of roof floor screed and tiles - Construction of plinths for saturator tanks - Erection and dismantling of scaffolding, installation of mechanical equipment and piping, bubble test - Installation of underdrain |
Product Water Storage Tank Building - Resin Injection Work & Water Test for 1 Water Tanks - Installation of cat ladders in Water Tanks, and door -
Installation of louvres, metal cladding, building services, cable laying, mechanical equipment, steel pipe - Underground utility construction |
OSCG Building - Installation of Design for Manufacturing and Assembly Panel and metal door - Underground utility construction work - Installation of building services and mechanical equipment |
Reverse Osmosis Building - Installation of Design for Manufacturing and Assembly Panels at East Sides - Installation of metal door, metal cladding, hand railings, Louvres & Windows - Installation of building services, electrical switchboard, mechanical equipment, steel pipe, Glass Reinforced Plastics (GRP) pipe and cable laying - Underground utility construction work |
Post Treatment Building - Installation of Louvres & Windows, metal door and cat ladders - Installation of Design for Manufacturing and Assembly Panels - Installation of building services, mechanical equipment and GRP pipe - Underground utility construction work |
Inspection corridor - Construction of bondek for segments 7 - construction of staircase 8 |
CO2 Tanks - Installation of pipes and building services Outfall Shaft -
GRP Diffuser Pipe
installation and rock material back fill Combined Shaft -
Installation of building services, electrical equipment, switchboard, cable
laying, mechanical equipment and pipes, stoplogs and band screens - Underground utility construction work -
Staircases and internal finishing |
Pump room - internal finishing and screeding Other -
Excavation at slope
toe and access
erection, Soil anchor
and grouting construction -
Foundation & structure construction at Elevated Walkway - Watermain works at 132 kV -
Concrete Breaking, Structure Construction at Seawall |

1.9. A summary of the valid permits, licences, and/or notifications on environmental protection for this Contract is presented in Table 1.2.
Table 1.2 Summary of
the Status of Valid Environmental Licence, Notification, Permit and Documentations
Permit/ Licences |
Valid Period |
Status |
Remark |
|
From |
To |
|||
Environmental Permit |
||||
EP-503/2015/A |
Throughout the Contract |
Valid |
- |
|
FEP - 01/503/2015/A |
Throughout the Contract |
Valid |
- |
|
Notification of Construction Works under the Air Pollution Control (Construction Dust) Regulation (Form NA) |
||||
451539 |
Throughout the Contract |
Valid |
- |
|
Billing Account for Disposal of Construction Waste |
||||
