Revision History
Rev. |
Description of Modification |
Date |
A |
First Issue for Comments |
10/10/2022 |
B |
Revised according to IEC and SOR¡¦s comment |
19/10/2022 |
C |
Updated Waste Flow Table |
20/10/2022 |
6. Summary of Exceedance, Complaints, Notification of Summons and Prosecutions.......... 29
Appendix B Overview of Desalination Plant in Tseung Kwan O
Appendix
C Summary
of
Implementation Status of
Environmental Mitigation

Appendix D Impact Monitoring Schedule of the Reporting Month

Appendix E Event/Action Plan for Noise Exceedance
Appendix F Noise
Monitoring Equipment Calibration
Certificate (Blank)
Appendix G Event/Action Plan for Water Quality Exceedance
Appendix H Waste Flow Table
Appendix I Site Inspection Proforma
Appendix J Complaint Log
Appendix
K Impact
Monitoring Schedule of
Next
Reporting Month
Appendix L Water Quality and Landfill Gas Monitoring Data
Appendix M HOKLAS Laboratory Certificate
Appendix
N Water
Quality
and
Landfill Gas Equipment
Calibration Certificate
Appendix O Exceedance Report(s)
Executive Summary
Introduction
A1. The Project, Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (TKODP), is a Designated Project under the Environmental Impact Assessment Ordinance (Cap. 499) (EIAO) and is currently governed by a Further Environmental Permit (EP No. FEP - 01/503/2015/A) for the construction and operation of the Contract.
A2. In accordance with the Environmental Monitoring and Audit (EM&A) Manual for the Contract, EM&A works for marine water quality, noise, waste management and ecology should be carried out by Environmental Team (ET), Acuity Sustainability Consulting Limited (ASCL), during the construction phase of the Contract.
A3. This is the 31st Monthly EM&A Report, prepared by ASCL, for the Contract summarizing the monitoring results and audit findings of the EM&A programme at and around Tseung Kwan O Area 137 (TKO 137) during the reporting period from 1 September 2022 to 30 September 2022.
A4. The EM&A programme for this contract has covered environmental monitoring on construction noise level at selected NSRs and Contractor¡¦s environmental performance auditing in the aspects of construction dust, construction noise, water quality, waste management, Landscape and Visual and Ecology.
Summary of Main Works Undertaken & Key Mitigation Measures Implemented
A5. Key activities carried out in this reporting period for the Contract included the followings:
- Adjacent Chemical Building Underground utility (UU) Construction Work
- Adjacent ActiDAFF UU Construction Work
- Adjacent RO Building UU Construction Work
- 132 kV temporary emergency vehicular access (eva) Construction
- Product Water Storage Tank (PWST) UU construction work
- Adjacent PWST carbon steel pipe installation work
- Adjacent PWST UU construction work
- 132 kV Substation (Hill Side) Backfill
- Post Treatment Building (PTB) UU Construction Work
- Construction of parapet and internal finishes at 2/F, 3/F and 4/F and Construction of roof of lift shaft at Administration Building
- Installation of hoarding on 2/F and waterproofing works at 1/F at Administration Building
- Steel fixing works for segment 6, segment 4 and segment 3 and construction of stair tower at Inspection corridor
- Water proofing work on roof of Cartridge Filter Plant Room and Construction of kiosks and installation of louvre at ActiDAFF
- Covering the wall opening and water proofing works at the roof of Chemical building

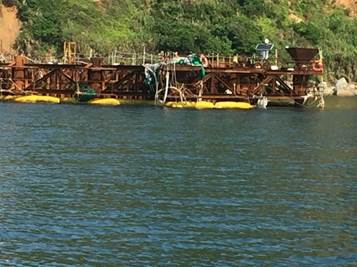

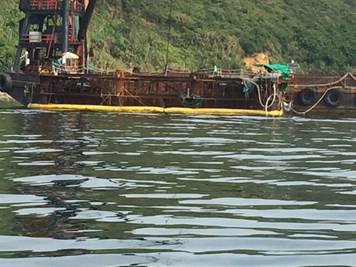

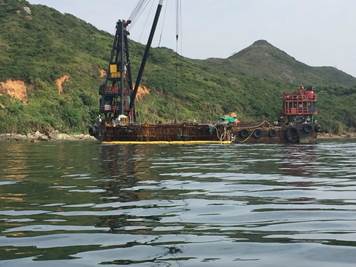

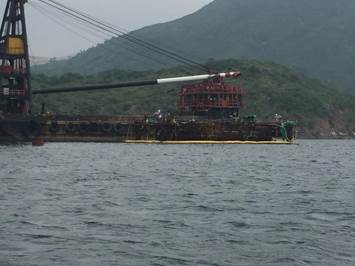

- Dredging for diffuser pipe caisson removal and Glass Reinforced Plastics (GRP) Pipe installation at Outfall Shaft
- Shaft backfill rock and excavation and lateral support (ELS) removal at Intake Shaft
- Staircases and internal finishing, puddle pipe installation at Combined Shaft
- Staircases and internal finishing, overhead crane installation at Pump room
- Excavation at slope toe and access erection, mini piles construction at Clear Water Bay Country Park
- Trench excavation, structure installation, Grouting and backfill at Open Channel
- E&M works - ActiDAFF (cell 1, 3, 5, 6, 7) - Scaffolding, installation of mechanical equipment and piping
- E&M works - PWST - Installation of building services, Installation of mechanical equipment, steel pipe
- E&M works - PTB - Installation of building services, Lifting of lime silo, filter press
- E&M works - Administration Building - Installation of building services
- E&M works - Chemical Building - Installation of building services, Lifting of steel tanks
- E&M works - RO building - Installation of building services, electrical switchboard, Installation of mechanical equipment, steel pipe, GRP pipe, Lifting of electrical switchboard
- E&M works - MECCP - Installation of chillers, building services, electrical switchboard
A6. The major environmental impacts brought by the above construction works include:
- Construction dust and noise generation from construction works, excavation works, rock cutting works and pipe piling driving works
- Waste generation from the construction activities; and
- Impact on water quality from marine construction works and inland construction works.
A7. The key environmental mitigation measures implemented for the Contract in this reporting period associated with the above construction works include:
- Dust suppression by regular wetting and water spraying for construction works;
- Reduction of noise from equipment and machinery on-site and regular inspection to machinery and plants/vehicles on-site to ensure proper functioning;
- Sorting and storage of general refuse and construction waste; and
- Deployment of temporary silt curtain in the area where marine construction works were conducted and deployment of water sedimentation tanks for treatment of wastewater at inland and marine areas before discharge.
Summary of exceedance & investigation & follow-up
A8. No noise monitoring was conducted during the reporting period since there are no Contract -related construction activities undertaken within a radius of 300m from the monitoring locations. No exceedance of the Action Level was recorded during the reporting period.
A9. The EM&A works for water quality were conducted during the reporting period in accordance with the EM&A Manual.
A10. One hundred and five (105) of the general water quality monitoring results of suspended solids (SS) obtained had exceeded the Action Level. Eighty-five (85) of the general water quality monitoring results of SS obtained during the reporting period had exceeded the Limit Level.
A11. Investigation on the reason of exceedance has been carried out, where the exceedances of SS on 1, 3, 6, 8, 10, 13, 15, 17, 20, 22, 24, 27 and 29 September 2022 were concluded to be unrelated to the Contract as detailed in the Incident Reports on Action Level or Limit Level Non-compliance along with supporting materials in Appendix O.

A12. In this reporting period, 46 times of landfill gas monitoring were conducted at Wan Po Road (Ch1+513 - Ch1+625). No action and limit level exceedance was recorded in the reporting period.

A13. Joint site inspections of the construction work by ET and IEC were carried out on 6, 13, 20 and 30 September 2022 to audit the mitigation measures implementation status. Recommendations and observations were recorded in the site inspection checklists and provided to the contractors together with the appropriate follow-up actions where necessary.

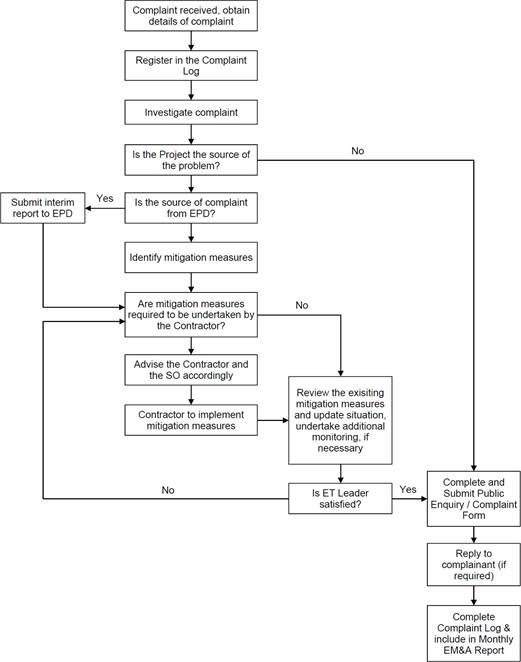

Complaint Handling and Prosecution

A14. No environmental complaint, notification of summons and prosecution was received in the reporting period.
Reporting Change
A15. There was no change to be reported that may affect the on-going EM&A programme.
Summary of Upcoming Key Issues and Key Mitigation Measures
A16. Key activities anticipated in the next reporting period for the Contract will include the followings:
- Adjacent Chemical Building Underground utility (UU) Construction Work
- Adjacent ActiDAFF UU Construction Work
- Adjacent RO Building UU Construction Work
- 132 kV temporary emergency vehicular access (eva) Construction
- Product Water Storage Tank (PWST) UU construction work
- Adjacent PWST carbon steel pipe installation work
- Adjacent PWST UU construction work
- 132 kV Substation (Hill Side) Backfill
- Post Treatment Building (PTB) UU Construction Work
- Construction of parapet and internal finishes at 2/F, 3/F and 4/F and Construction of roof of lift shaft at Administration Building
- Installation of hoarding on 2/F and waterproofing works at 1/F at Administration Building
- Steel fixing works for segment 6, segment 4 and segment 3 and construction of stair tower at Inspection corridor
- Water proofing work on roof of Cartridge Filter Plant Room and Construction of kiosks and installation of louvre at ActiDAFF
- Covering the wall opening and water proofing works at the roof of Chemical building
- Dredging for diffuser pipe caisson removal and Glass Reinforced Plastics (GRP) Pipe installation at Outfall Shaft
- Shaft backfill rock and excavation and lateral support (ELS) removal at Intake Shaft
- Staircases and internal finishing, puddle pipe installation at Combined Shaft
- Staircases and internal finishing, overhead crane installation at Pump room
- Excavation at slope toe and access erection, mini piles construction at Clear Water Bay Country Park
- Trench excavation, structure installation, Grouting and backfill at Open Channel
- E&M works - ActiDAFF (cell 1, 3, 5, 6, 7) - Scaffolding, installation of mechanical equipment and piping
- E&M works - PWST - Installation of building services, Installation of mechanical equipment, steel pipe
- E&M works - PTB - Installation of building services, Lifting of lime silo, filter press
- E&M works - Administration Building - Installation of building services
- E&M works - Chemical Building - Installation of building services, Lifting of steel tanks
- E&M works - RO building - Installation of building services, electrical switchboard, Installation of mechanical equipment, steel pipe, GRP pipe, Lifting of electrical switchboard
- E&M works - MECCP - Installation of chillers, building services, electrical switchboard
A17. The major environmental impacts brought by the above construction works will include:
- Construction dust and noise generation from excavation and construction works;
- Waste generation from construction activities; and
- Impact on water quality from marine construction works and inland construction works.
A18. The key environmental mitigation measures for the Contract in the coming reporting period associated with the above construction works will include:
- Reduction of noise from equipment and machinery on-site;
- Dust suppression by regular wetting and water spraying for construction works and at main haul road;
- Sorting and storage of general refuse and construction waste; and
- Deployment of temporary silt curtain in the area where marine construction works were conducted and deployment of water sedimentation tanks for treatment of wastewater at inland and marine areas before discharge.
1.
Basic Contract Information
Background
1.1. The Acciona Agua, S.A. Trading, Jardine Engineering Corporation, Limited and China State Construction Engineering (Hong Kong) Limited as AJC Joint Venture (AJCJV) is contracted to carry out the Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (DPTKO) under Contract No. 13/WSD/17 (the Contract).
1.2. Acuity Sustainability Consulting Limited (ASCL) is commissioned by AJCJV to undertake the Environmental Team (ET) services as required and/or implied, both explicitly and implicitly, in the Environmental Permit (EP), Environmental Impact Assessment Report (EIA Report) (Register No. AEIAR-192/2015) and Environmental Monitoring and Audit Manual (EM&A Manual) for the Contract; and to carry out the Environmental Monitoring and Audit (EM&A) programme in fulfillment of the EIA Report¡¦s EM&A requirements and Contract No. 13/WSD/17 Specification requirements.
1.3. Pursuant to the Environmental Impact Assessment Ordinance (EIAO), the Director of Environmental Protection granted the Environmental Permit (No. EP-01/503/2015) and Variation of Environmental Permit (No. EP-01/503/2015/A) to Water Supplies Department (WSD); and granted the Further Environmental Permit (No. FEP- 01/503/2015/A) to AJCJV for the Contract.
The Reporting Scope
1.4. This is the 31st Monthly EM&A Report for the Contract which summarizes the key findings of the EM&A programme during the reporting period from 1 September to 30 September 2022.
Contract Organization
1.5. The Contract Organization structure for Construction Phase is presented in Figure 1.1.

Figure 1.1 Contract
Organization Chart
1.6. Contact details of the key personnel are presented in Table 1.1 below:
Table 1.1 Contact Details of Key Personnel
Party |
Position |
Name |
Telephone no. |
Contract Proponent (Water Supplies Department) |
SE/CM2 |
Benny Lam |
2634-3573 |
Supervising Officer (Binnies Hong Kong Limited) |
Project Manager |
Christina Ko |
2608-7302 |
Chief Resident Engineer |
Roger Wu |
6343-1002 |
|
The Jardine Engineering Corporation, Limited, China State Construction Engineering (Hong Kong) Limited and Acciona Agua, S.A. Trading |
Project Manager |
Stephen Yeung |
2807-4665 |
Environmental Monitoring Manager |
Brian Kam |
9456-9541 |
|
Acuity Sustainability Consulting Limited |
Environmental Team Leader |
Jacky Leung |
2698-6833 |
ANewR Consulting Limited |
Independent Environmental Checker (IEC) |
Louis Kwan |
2618-2831 |

Summary of Construction Works

1.7. Details of the major construction activities undertaken in this reporting period are shown as below. The construction programme is presented in Appendix A.
1.8. Key activities carried out in this reporting period for the Contract included the followings:
- Adjacent Chemical Building Underground utility (UU) Construction Work
- Adjacent ActiDAFF UU Construction Work
- Adjacent RO Building UU Construction Work
- 132 kV temporary emergency vehicular access (eva) Construction
- Product Water Storage Tank (PWST) UU construction work
- Adjacent PWST carbon steel pipe installation work
- Adjacent PWST UU construction work
- 132 kV Substation (Hill Side) Backfill
- Post Treatment Building (PTB) UU Construction Work
- Construction of parapet and internal finishes at 2/F, 3/F and 4/F and Construction of roof of lift shaft at Administration Building
- Installation of hoarding on 2/F and waterproofing works at 1/F at Administration Building
- Steel fixing works for segment 6, segment 4 and segment 3 and construction of stair tower at Inspection corridor
- Water proofing work on roof of Cartridge Filter Plant Room and Construction of kiosks and installation of louvre at ActiDAFF
- Covering the wall opening and water proofing works at the roof of Chemical building
- Dredging for diffuser pipe caisson removal and Glass Reinforced Plastics (GRP) Pipe installation at Outfall Shaft
- Shaft backfill rock and excavation and lateral support (ELS) removal at Intake Shaft
- Staircases and internal finishing, puddle pipe installation at Combined Shaft
- Staircases and internal finishing, overhead crane installation at Pump room
- Excavation at slope toe and access erection, mini piles construction at Clear Water Bay Country Park
- Trench excavation, structure installation, Grouting and backfill at Open Channel
- E&M works - ActiDAFF (cell 1, 3, 5, 6, 7) - Scaffolding, installation of mechanical equipment and piping
- E&M works - PWST - Installation of building services, Installation of mechanical equipment, steel pipe
- E&M works - PTB - Installation of building services, Lifting of lime silo, filter press
- E&M works - Administration Building - Installation of building services
- E&M works - Chemical Building - Installation of building services, Lifting of steel tanks
- E&M works - RO building - Installation of building services, electrical switchboard, Installation of mechanical equipment, steel pipe, GRP pipe, Lifting of electrical switchboard
- E&M works - MECCP - Installation of chillers, building services, electrical switchboard
-
1.9. A summary of the valid permits, licences, and/or notifications on environmental protection for this Contract is presented in Table 1.2.
Table 1.2 Summary of
the Status of Valid Environmental Licence, Notification, Permit and Documentations
Permit/ Licences |
Valid Period |
Status |
Remark |
|
From |
To |
|||
Environmental Permit |
||||
FEP - 01/503/2015/A |
Throughout the Contract |
Valid |
- |
|
Notification of Construction Works under the Air Pollution Control (Construction Dust) Regulation (Form NA) |
||||
451539 |
Throughout the Contract |
Valid |
- |
|
Billing Account for Disposal of Construction Waste |
||||
7036276 |
Throughout the Contract |
Valid |
- |
|
Permit/ Licences |
Valid Period |
Status |
Remark |
|
From |
To |
|||
Chemical Waste Producer Registration |
||||
5213-839-A2987-01 |
Throughout the Contract |
Valid |
- |
|
Wastewater Discharge Licence (Land and Marine works) |
||||
WT00035775-2020 |
23/08/2021 |
31/07/2025 |
Valid |
- |
Construction Noise Permit |
||||
GW-RE0627-22 |
29/06/2022 |
21/12/2022 |
Valid |
- |

1.10. The status for all environmental aspects is presented in Table 1.3.

Table 1.3 Summary of
Status for Key Environmental Aspects under the EM&A Manual
Parameters |

Status |
Water Quality |
|
Baseline Monitoring under EM&A Manual |
The baseline water quality monitoring was conducted between 12 May 2020 to 6 Jun 2020 |
Impact Monitoring |
On-going |
Noise |
|
Baseline Monitoring |
The baseline noise monitoring result has been reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4 |
Impact Monitoring |
On-going |
Waste Management |
|
Mitigation Measures in Waste Management Plan |
On-going |

Landfill Gas |
|
Regular Monitoring when Construction Works are within the 250m Consultation Zone |

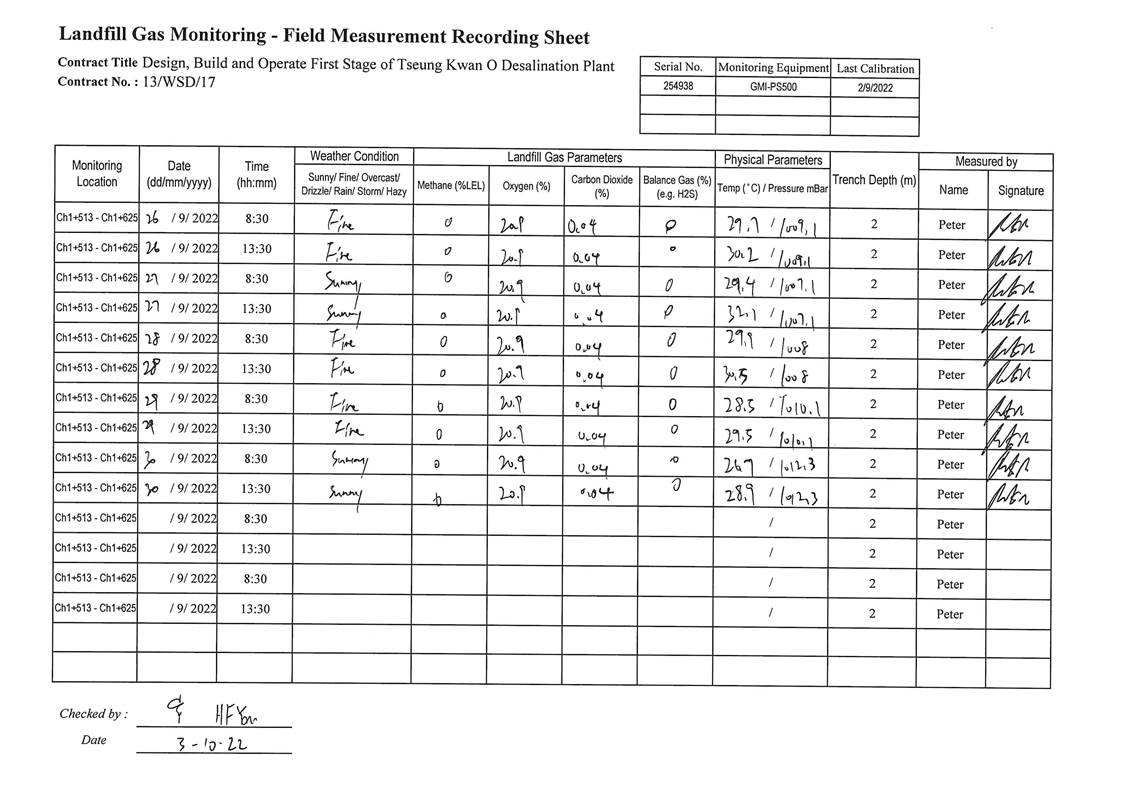

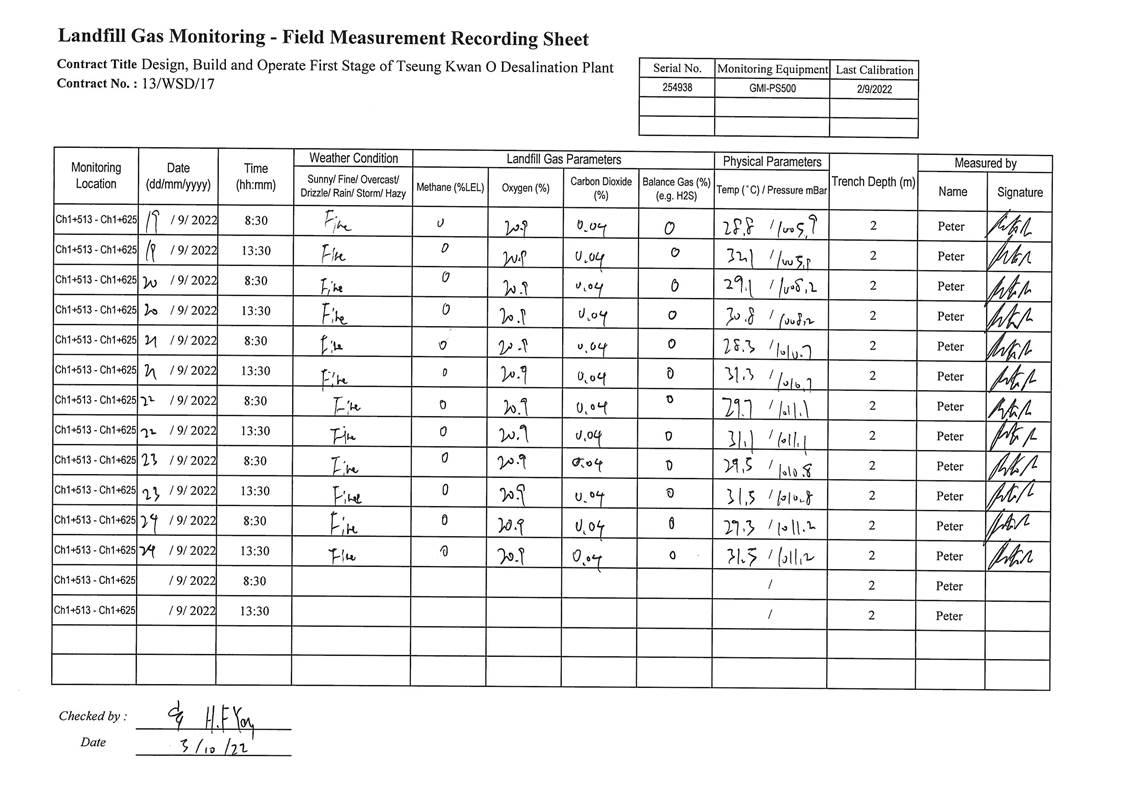

In this reporting period, 46 times of landfill gas monitoring was conducted at Wan Po Road (Ch1+513 - Ch1+625). |

Environmental Audit |
|

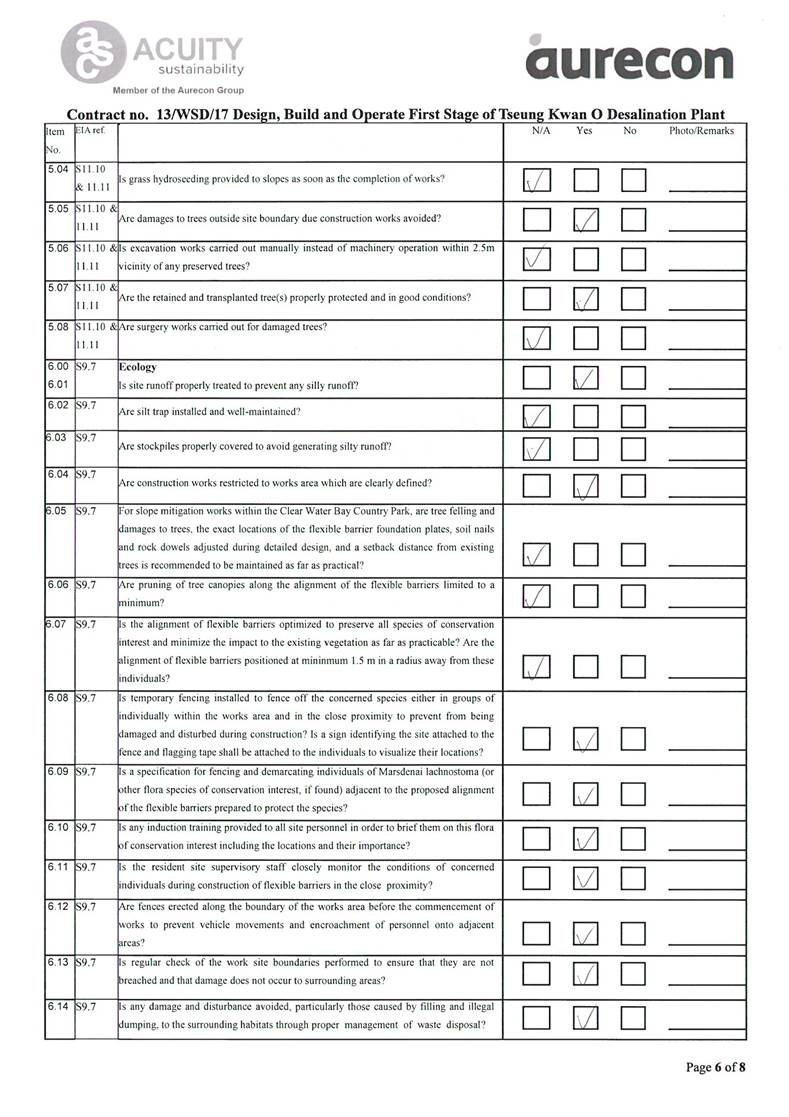

Site Inspection covering Measures of Air Quality, Noise Impact, Water Quality, Waste, Ecological Quality, Fisheries, Landscape and Visual |
On-going |
1.11. Other than the EM&A work by ET, environmental briefings, trainings, and regular environmental management meetings were conducted, in order to enhance environmental awareness and closely monitor the environmental performance of the contractors.
1.12. The EM&A programme has been implemented in accordance with the recommendations presented in the approved EIA Report and the EM&A Manual. A summary of implementation status of the environmental mitigation measures for the construction phase of the Contract during the reporting period is provided in Appendix C.
2.
Noise
Monitoring Requirements

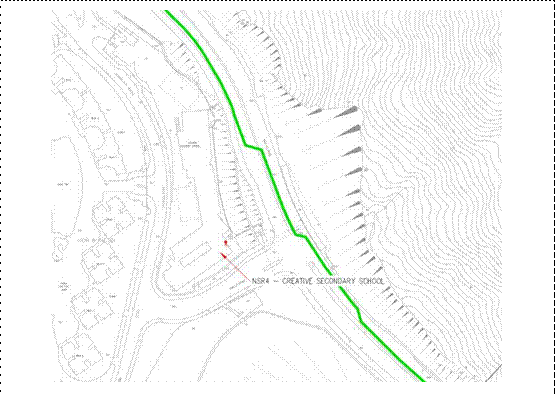

2.1. To ensure no adverse noise impact, noise monitoring is recommended to be carried out within 300m radius from the nearby noise sensitive receivers (NSRs), during construction phase. The NSRs selected as monitoring station are (i) NSR4 - Creative Secondary School, (ii) NSR24 - PLK Laws Foundation College, and (iii) NSR31 - School of Continuing and Professional Studies - CUHK respectively.
2.2. In accordance with the EM&A Manual, baseline noise level at the noise monitoring stations were established as presented in the Baseline Monitoring Report. Impact noise monitoring will be conducted once per week in the form of 30-minutes measurements Leq, L10 and L90 levels recorded at each monitoring station between 0700 and 1900 on normal weekdays.
2.3. Referring to EM&A manual Section 4.1.2, the impact noise monitoring should be carried out at all the designated monitoring stations when there are contract-related construction activities undertaken within a radius of 300m from the monitoring stations.
2.4. No impact monitoring for noise impact was conducted in the reporting month due to the overly distant monitoring station from the works location, where they were farther than 1 km from the closest monitoring station NSR4 to the works location.
2.5. Impact noise monitoring will be conducted weekly in the reporting period between 0700- 1900 on normal weekdays. Construction works would follow stipulations of the valid Construction Noise Permits if works had to be conducted during restricted hours or public holidays.
2.6. Construction noise level were measured in terms of the A-weighted equivalent continuous sound pressure level (LAeq). Leq 30min was used as the monitoring parameter for the time period between 0700 and 1900 on normal weekdays. Table 2.1 summarizes the monitoring parameters, frequency, and duration of the impact noise monitoring.
Table
2.1 Noise Monitoring Parameters, Time, Frequency and Duration
Time |
Duration |
Interval |
Parameters |
Daytime: 0700-1900 |
Day time: 0700-1900 (during normal weekdays) |
Continuously in Leq 5min/Leq 30min (average of 6 consecutive Leq 5min) |
Leq 30min L10 30min & L90 30min |
Monitoring Locations
2.7. The monitoring locations were normally made at a point 1m from the exterior of the NSRs building façade and be at a position 1.2m above the ground. A correction of +3dB(A) should be made to the free-field measurements.

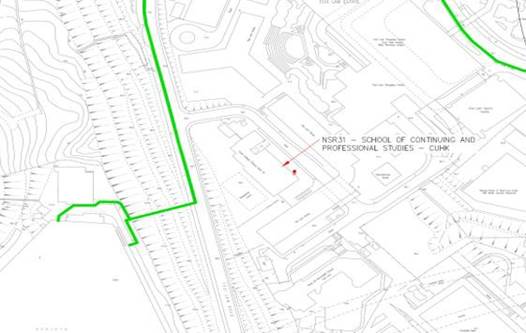

2.8. According to the environmental findings detailed in the EIA report and Baseline Monitoring Report, the designated locations for the construction noise monitoring are listed in Table 2.2 below.
Table
2.2 Noise
Sensitive Receivers
NSR ID |
Noise Sensitive Receivers |
Monitoring Location |
