CONTENTS
6.
SUMMARY OF
MONITORING EXCEEDANCE, COMPLAINTS, NOTIFICATION OF SUMMONS AND
PROSECUTIONS............................................................................................................................................................. 20
Appendix A Master Programme
Appendix B Overview of Desalination Plant in Tseung Kwan O
Appendix C Summary of Implementation Status of Environmental
Mitigation
Appendix D Impact Monitoring Schedule of the Reporting Month (Blank)
Appendix E Event/Action Plan for Noise Exceedance
Appendix F Noise Monitoring Equipment Calibration Certificate (Blank)
Appendix G Event/Action Plan for Water Quality Exceedance
Appendix H Waste Flow Table
Appendix I Site Inspection Proforma
Appendix J Complaint Log
Appendix K Impact Monitoring Schedule of Next Reporting Month (Blank)
INTRODUCTION
A1. The Project, Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (TKODP), is a Designated Project under the Environmental Impact Assessment Ordinance (Cap. 499) (EIAO) and is currently governed by a Further Environmental Permit (EP No. FEP - 01/503/2015/A) for the construction and operation of the Project.
A2. In accordance with the Updated Environmental Monitoring and Audit (EM&A) Manual for the Project, EM&A works for marine water quality, noise, waste management and ecology should be carried out by Environmental Team (ET), Acuity Sustainability Consulting Limited (ASCL), during the construction phase of the Project.
A3. This is the 7th Monthly EM&A Report, prepared by ASCL, for the Project summarizing the monitoring results and audit findings of the EM&A programme at and around Tseung Kwan O Area 137 (TKO 137) during the reporting period from 1 September 2020 to 30 September 2020.
A4. The EM&A programme for this contract has covered environmental monitoring on construction noise level at selected NSRs and Contractor¡¦s environmental performance auditing in the aspects of construction dust, construction noise, water quality, waste management, Landscape and Visual and Ecology.
SUMMARY OF MAIN WORKS UNDERTAKEN & KEY MITIGATION MEASURES IMPLEMENTED
A5. Key activities carried out in this reporting period for the Project included the following:
- Land Survey;
- Access Road Construction;
- Construction of 132kV substation;
- Pre-boring and installation of sheetpiles for combine shaft;
- Construction of ActifDAFF footing;
- Construction of RO footing;
- Excavation for Product Water Storage Tank footing;
- Installation of temporary soil nail at Product Water Storage Tank;
- Excavation and ELS installation for combine shaft.
A6. The major environmental impacts brought by the above construction works include:
- Construction dust and noise generation from the ground investigation works, access road construction and site office formation;
- Waste generation from the construction activities
A7. The key environmental mitigation measures implemented for the Project in this reporting period associated with the above construction works include:
- Dust suppression by regular wetting and water spraying for construction works
- Reduction of noise from equipment and machinery on-site
- Sorting and storage of general refuse and construction waste
SUMMARY OF EXCEEDANCE & INVESTIGATION & FOLLOW-UP
A8. No noise monitoring was conducted during the reporting period since there are no project- related construction activities undertaken within a radius of 300m from the monitoring locations. No project-related exceedance of the Action Level was recorded during the reporting period.
A9. No water quality monitoring was conducted in the reporting month since the commencement of marine construction and dredging activities for the Project are scheduled in November 2020 the earliest. No project-related exceedance of the Action Level was recorded during the reporting period.
A10. Weekly site inspections of the construction work by ET were carried out on 1, 8, 16, 25 & 29 September 2020 to audit the mitigation measures implementation status. Bi-weekly joint site inspection was carried out on 8 & 25 September 2020 by ET and IEC. Observations were recorded in the site inspection checklists and provided to the contractors together with the appropriate follow-up actions where necessary.
COMPLAINT HANDLING AND PROSECUTION
A11. No project-related environmental complaint was received during the reporting period.
A12. Neither notifications of summons nor prosecution was received for the Project.
REPORTING CHANGE
A13. There was no change to be reported that may affect the on-going EM&A programme.
SUMMARY OF UPCOMING KEY ISSUES AND KEY MITIGATION MEASURES
A14. Key activities anticipated in the next reporting period for the Project will include the following:
- Land Survey;
- Access Road Construction;
- ELS installation and bulk excavation at combine shaft;
- Construction of 132kV substation;
- Construction of ActifDAFF footing and perimeter wall;
- Construction of RO footing and excavation;
- Construction for Product Water Storage Tank footing;
- Excavation and Installation of temporary soil nail at Product Water Storage Tank.
A15. The major environmental impacts brought by the above construction works will include:
- Construction dust and noise generation from GI works, access road construction and site office formation work;
- Waste generation from construction activities
A16. The key environmental mitigation measures for the Project in the coming reporting period associated with the above construction works will include:
- Dust suppression by regular wetting and water spraying for construction works
- Reduction of noise from equipment and machinery on-site
- Sorting and storage of general refuse and construction waste
1.1.
BACKGROUND
The Jardine Engineering Corporation, Limited, China State Construction Engineering (Hong Kong) Limited and Acciona Agua, S.A. Trading As AJC Joint Venture (AJCJV) is contracted to carry out the Design, Build and Operate First Stage of Tseung Kwan O Desalination Plant (DPTKO) under Contract No. 13/WSD/17 (the Project).
Acuity Sustainability Consulting Limited (ASCL) is commissioned by AJCJV to undertake the Environmental Team (ET) services as required and/or implied, both explicitly and implicitly, in the Environmental Permit (EP), Environmental Impact Assessment Report (EIA Report) (Register No. AEIAR-192/2015) and Environmental Monitoring and Audit Manual (EM&A Manual) for the Project; and to carry out the Environmental Monitoring and Audit (EM&A) programme in fulfillment of the EIA Report¡¦s EM&A requirements and Contract No. 13/WSD/17 Specification requirements.
Pursuant to the Environmental Impact Assessment Ordinance (EIAO), the Director of Environmental Protection granted the Environmental Permit (No. EP-01/503/2015) and Variation of Environmental Permit (No. EP-01/503/2015/A) to Water Supplies Department (WSD); and granted the Further Environmental Permit (No. FEP-01/503/2015/A) to AJCJV for the Project.
1.2.
THE REPORTING SCOPE
This is the 7th Monthly EM&A Report for the Project which summarizes the key findings of the EM&A programme during the reporting period from 1 September to 30 September 2020.
1.3.
PROJECT ORGANIZATION
The Project Organization structure for Construction Phase is presented in Figure 1.1.
Figure 1.1 Project
Organization Chart
Contact details of the key personnel are presented in Table 1.1 below:
Table 1.1 Contact
Details of Key Personnel
Party |
Position |
Name |
Telephone
no. |
Project Proponent |
SE/CM2 |
Benny Lam |
2634-3573 |
Supervising Officer (Black & Veatch) |
Project Manager |
Christina Ko |
2608-7302 |
Chief Resident Engineer |
Roger Wu |
6343-1002 |
|
The Jardine Engineering Corporation, Limited, China State Construction Engineering (Hong Kong) Limited and Acciona Agua, S.A. Trading |
Project Manager |
Stephen Yeung |
2807-4665 |
Environmental Monitoring Manager |
Brian Kam |
9456-9541 |
|
Acuity Sustainability Consulting Limited |
Environmental Team Leader |
Jacky Leung |
2698-6833 |
ANewR Consulting Limited |
Independent Environmental Checker (IEC) |
Adi Lee |
2618-2831 |
1.4.
SUMMARY OF CONSTRUCTION WORKS
Details of the major construction activities undertaken in this reporting period are shown in below. The construction programme is presented in Appendix A.
Key activities carried out in this reporting period for the Project included the following:
- Land Survey;
- Ground Levelling;
- Access Road Construction;
- Site office¡¦s roof waterproofing and internal E&M installation;
- Construction of 132kV substation;
- Construction of Temp 11kV substation and drawpits / ducting;
- Pre-boring and installation of sheetpiles for combine shafet;
- Excavation and formation for ActiDAFF and RO;
- Erection of hoarding around site office;
- Installation of temporary watermain;
- Excavation and installation of temporary soil nail for Product Water Tank;
- Installation of tower cranes.
1.5.
SUMMARY OF ENVIRONMENTAL STATUS
A summary of the valid permits, licences, and /or notifications on environmental protection for this Project is presented in Table 1.2.
Table 1.2 Summary
of the Status of Valid Environmental Licence, Notification, Permit and Documentations
Permit/
Licenses/ Notification |
Reference |
Validity
Period |
Remarks |
Environmental Permit |
FEP
- 01/503/2015/A |
Throughout the Contract |
|
Notification
of Construction Works under the Air Pollution Control (Construction Dust)
Regulation (Form NA) |
Ref. No.: 451539 |
30/12/2019
- 30/03/2023 |
|
Wastewater Discharge Licence |
WT00035775-2020 |
24/07/2020
- 31/07/2025 |
|
Chemical Waste Producer Registration |
5213-839-A2987-01 |
Throughout the Contract |
|
Construction Noise Permit (24 hours) |
GW-RE0474-20 |
04/06/2020
- 03/12/2020 |
|
Billing Account for Disposal of Construction Waste |
7036276 |
Throughout
the Contract |
|
The status for all environmental aspects is presented in Table 1.3.
Table 1.3 Summary
of Status for Key Environmental Aspects under the Updated EM&A Manual
Parameters |
Status |
Water
Quality |
|
Baseline Monitoring under EM&A Manual |
The baseline water quality monitoring was conducted between 12 May 2020 to 6 Jun 2020 |
Impact Monitoring |
The impact water quality monitoring has been scheduled after the commencement of marine construction works |
Noise |
|
Baseline Monitoring |
The baseline noise monitoring result has been reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4 |
Impact Monitoring |
On-going |
Waste Management |
|
Mitigation Measures in Waste Monitoring Plan |
On-going |
Environmental Audit |
|
Site Inspection covering Measures of Air Quality, Noise Impact, Water Quality, Waste, Ecological Quality, Fisheries, Landscape and Visual |
On-going |
The impact monitoring schedule for the reporting month to be shown at Appendix D is intentionally left blank since no impact monitoring was conducted in the reporting month.
Other than the EM&A work by ET, environmental briefings, trainings and regular environmental management meetings were conducted, in order to enhance environmental awareness and closely monitor the environmental performance of the contractors.
The EM&A programme has been implemented in accordance with the recommendations presented in the approved EIA Report and the EM&A Manual. A summary of implementation status of the environmental mitigation measures for the construction phase of the Project during the reporting period is provided in Appendix C.
2.1.
MONITORING REQUIREMENTS
To ensure no adverse noise impact, noise monitoring is recommended to be carried out within 300m radius from the nearby noise sensitive receivers (NSRs), during construction phase. The NSRs selected as monitoring station are (i) NSR4 - Creative Secondary School, (ii) NSR24 - PLK Laws Foundation College, and (iii) NSR31 - School of Continuing and Professional Studies - CUHK respectively.
In accordance with the EM&A Manual, baseline noise level at the noise monitoring stations were established as presented in the Baseline Monitoring Report. Impact noise monitoring will be conducted once per week in the form of 30-minutes measurements Leq, L10 and L90 levels recorded at each monitoring station between 0700 and 1900 hours on normal weekdays.
Referring to EM&A manual Section 4.1.2, the impact noise monitoring should be carried out at all the designated monitoring stations when there are project-related construction activities undertaken within a radius of 300m from the monitoring stations.
No impact monitoring for noise impact was conducted in the reporting month due to the overly distant monitoring station from the works location, where they were farther than 1 km from the closet monitoring station NSR4 to the works location.
Impact noise monitoring will be conducted weekly in the reporting period between 0700-1900 hours on normal weekdays. No construction works were carried out during 1900-0700 hours in all days or any time on Sundays or general holidays during the reporting period.
Construction noise level measured in terms of the A-weighted equivalent continuous sound pressure level (LAeq). Leq 30min was used as the monitoring parameter for the time period between 0700 and 1900 hours on normal weekdays. Table 2.1 summarizes the monitoring parameters, frequency and duration of the impact noise monitoring.
Table
2.1 Noise Monitoring Parameters, Time, Frequency and Duration
Time |
Duration |
Interval |
Parameters |
||||
Daytime: 0700-1900 hrs |
Day
time: 0700-1900 hrs (during weekdays) |
normal |
Continuously in Leq 5min/Leq 30min (average of 6 consecutive
Leq 5min) |
Leq L10 |
30min
30min |
& L90 |
30min |
2.2.
MONITORING LOCATIONS
The monitoring locations should normally be made at a point 1m from the exterior of the NSRs building façade and be at a position 1.2m above the ground. A correction of +3dB(A) should be made to the free-field measurements.
According to the environmental findings detailed in the EIA report and Baseline Monitoring Report, the designated locations for the construction noise monitoring are listed in Table 2.2 below.
Table 2.2 Noise
Sensitive Receivers
NSR ID |
Noise Sensitive Receivers |
Monitoring Location |
Position |
NSR 4 |
Creative
Secondary School |
Roof
Floor |
1
m from facade |
NSR 24 |
PLK
Laws Foundation College |
Pedestrian Road on
Ground Floor |
Free-field |
NSR 31 |
School of Continuing
and Professional Studies - CUHK |
Roof
Floor |
1
m from facade |
The monitoring locations should normally be made at a point 1m from the exterior of the NSRs building façade and be at a position 1.2m above the ground. A correction of +3dB(A) should be made to the free-field measurements. Three noise monitoring locations for impact monitoring at the nearby sensitive receivers are shown in Figure 2.1-2.3.
|
|
|
|
Figure 2.1 NSR4 Creative Secondary
School |
|
|
|
|
|
Figure 2.2 NSR24 PLK Laws Foundation
College |
|
|
|
|
||
|
Figure 2.3
NSR31 School of Continuing
and Professional Studies - CUHK |
|
|
|
2.3.
IMPACT MONITORING METHODOLOGY
2.4.1 Integrated sound level meter shall be used for the noise monitoring. The meter shall be in compliance with the International Electrotechnical Commission Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications. Immediately prior to and following each noise measurement the accuracy of the sound level meter shall be checked using an acoustic calibrator generating a known sound pressure level at a known frequency. Measurements may be accepted as valid only if the calibration level before and after the noise measurements agree to within 1.0 dB(A). Calibration certificates of the instruments used to be shown at Appendix F is intentionally left blank since no impact monitoring equipment was used in the reporting month.
Noise measurements shall not be made in the presence of fog, rain, wind with a steady speed exceeding 5 m/s or wind with gusts exceeding 10 m/s. The wind speed shall be checked with a portable wind speed meter capable of measuring the wind speed in m/s.
Table 2.3 Impact
Noise Monitoring Equipment
Equipment |
Brand and Model |
Detection Limit |
Sound Level Meter |
Nti XL2 |
30-130 dB(A) |
Sound Level Meter Calibrator |
Rion NC-74 |
Nil |
Pocket Wind Meter Anemometer |
Kestrel 1000 Wind Meter |
Nil |
2.4.
ACTION AND LIMIT LEVELS
The Action/Limit Levels in line with the criteria of Practice Note for Professional Persons (ProPECC PN 2/93) ¡§Noise from Construction Activities - Non-statutory Controls¡¨ and Technical Memorandum on Environmental Impact Assessment Process issued by HKSAR Environmental Protection Department [¡§EPD¡¨] under the Environmental Impact Assessment Ordinance, Cap 499,
S.16
are presented in Table 2.4.
Table 3.4 Action
and Limit Levels for Noise per Updated EM&A Manual
Time Period |
Action |
Limit (dB(A)) |
0700-1900
hours on normal weekdays |
When one documented complaint is
received from any one of the noise sensitive receivers |
¡P
70
dB(A) for school and ¡P
65
dB(A) during examination period |
Notes: Limits
specified in the GW-TM and IND-TM for construction and operation noise,
respectively.
If exceedances were found during noise monitoring, the actions in accordance with the Event and Action Plan shall be carried out according to Appendix E.
2.5.
MONITORING RESULTS AND
OBSERVATIONS
Referring to EM&A manual Section 4.1.2, the impact noise monitoring should be carried out when there are project-related construction activities undertaken within a radius of 300m from the monitoring stations. No monitoring station was located within a radius of 300m of the Project site as shown in Figure 2.4, no impact monitoring for noise impact was conducted in the reporting period.
Figure 2.4 Site
Layout Plan with Noise Sensitive Receivers and Desalination Plant
In accordance with the recommendations of the EIA, water quality EM&A is required during dredging for the submarine pipelines and, during operation phase. In addition, baseline water quality monitoring will be required prior to the commencement of marine construction activities. The following Section provides details of the water quality monitoring to be undertaken by the Environmental Team (ET) to verify the distance of sediment and brine plume dispersion and to identify whether the potential exists for any indirect impacts to occur to ecological sensitive receivers. The water quality monitoring programme will be carried out to allow any deteriorating water quality to be readily detected and timely action taken to rectify the situation. The status and locations of water quality sensitive receivers and the marine works location may change after issuing this Document. If required, the ET in consultation with IEC will propose updated monitoring locations and seek approval from EPD.
Water quality monitoring for the Project can be divided into the following stages:
-
Dredging
activities during construction phase;
-
Discharge
of effluent from main disinfection during construction phase;
-
Operation
phase - first year upon commissioning; and,
-
Continuous
monitoring of effluent quality.
In addition, the marine works contractor is required to complete a silt curtain efficiency test for the combined use of floating silt curtain type and cage type silt curtain for dredging at seawater intake to confirm the silt curtain reduction efficiency assumptions of the assessment. The details of testing plan together with the silt curtain deployment plan updated testing plan shall be submitted by the ET to seek approval from the IEC and EPD.
3.1.
IMPACT MONITORING METHODOLOGY
3.1.1. WATER QUALITY PARAMETERS
The parameters that have been selected for measurement in situ and in the laboratory are those that were either determined in the EIA to be those with the most potential to be affected by the construction works or are a standard check on water quality conditions. Parameters to be measured in the baseline monitoring are listed in Table 3.1.
Table 3.1 Parameters
measured in the baseline marine water quality monitoring
Parameters |
Unit |
Abbreviation |
In-situ measurements |
||
Dissolved
oxygen |
mg/L |
DO |
Temperature |
oC |
- |
pH |
- |
- |
Turbidity |
NTU |
- |
Salinity |
0/00 |
- |
Total
Residual Chlorine NOTE1 |
mg/L |
TRC |
Laboratory measurements |
||
Suspended
Solids |
mg/L |
SS |
Iron-Soluble
NOTE2 |
mg/L |
Fe |
Anti-scalant
as Reactive Phosphorus NOTE2 |
mg/L |
PO4 as P- |
NOTE 1: Monitoring of TRC will be conducted when cleaning and sterilization of the new freshwater main is carried out.
NOTE 2: The testing methods shall be submitted to EPD for approval prior to the commencement of monitoring programme.
In addition to the water quality parameters, other relevant data will also be measured and recorded in Water Quality Monitoring Logs, including the location of the sampling stations, water depth, time, weather conditions, sea conditions, tidal stage, current direction and velocity, special phenomena and work activities undertaken around the monitoring and works area that may influence the monitoring results.
3.1.2. MONITORING EQUIPMENT
For water quality monitoring, the following equipment will be used:
Dissolved Oxygen and Temperature Measuring Equipment - The instrument will be a portable, weatherproof dissolved oxygen measuring instrument complete with cable, sensor, comprehensive operation manuals, and will be operable from a DC power source. It will be capable of measuring: dissolved oxygen levels in the range of 0 - 20 mg/L and 0 - 200% saturation; and a temperature of 0 - 45 degrees Celsius. It shall have a membrane electrode with automatic temperature compensation complete with a cable of not less than 35 m in length. Sufficient stocks of spare electrodes and cables shall be available for replacement where necessary (e.g. YSI model 59 DO meter, YSI 5739 probe, YSI 5795A submersible stirrer with reel and cable or an approved similar instrument).
Turbidity Measurement Equipment - The instrument will be a portable, weatherproof turbidity- measuring unit complete with cable, sensor and comprehensive operation manuals. The equipment will be operated from a DC power source, it will have a photoelectric sensor capable of measuring turbidity between 0 - 1000 NTU and will be complete with a cable with at least 35 m in length (for example Hach 2100P or an approved similar instrument).
Salinity Measurement Instrument - A portable salinometer capable of measuring salinity in the range of 0 - 40 ppt will be provided for measuring salinity of the water at each monitoring location.
Water Depth Gauge - A portable, battery-operated echo sounder (for example Seafarer 700 or a similar approved instrument) will be used for the determination of water depth at each designated monitoring station. This unit will preferably be affixed to the bottom of the work boat if the same vessel is to be used throughout the monitoring programme. The echo sounder should be suitably calibrated. The ET shall seek approval for their proposed equipment with the client prior to deployment.
Current Velocity and Direction - No specific equipment is recommended for measuring the current velocity and direction. The environmental contractor shall seek approval of their proposed equipment with the client prior to deployment.
Positioning Device - A Global Positioning System (GPS) shall be used during monitoring to allow accurate recording of the position of the monitoring vessel before taking measurements. The Differential GPS, or equivalent instrument, should be suitably calibrated at appropriate checkpoint (e.g. Quarry Bay Survey Nail) to verify that the monitoring station is at the correct position before the water quality monitoring commence.
Water Sampling Equipment - A water sampler, consisting of a PVC or glass cylinder of not less than two litres, which can be effectively sealed with cups at both ends, will be used (e.g. Kahlsico Water Sampler 13SWB203 or an approved similar instrument). The water sampler will have a positive latching system to keep it open and prevent premature closure until released by a messenger when the sampler is at the selected water depth.
Total
Residual Chlorine for Discharge of Sterilization Water -
Total residual chlorine (TRC) shall be measured in-situ using a handheld
colorimeter with its testing toolkits.
3.1.3. SAMPLING / TESTING PROTOCOLS
All in situ monitoring instruments will be checked, calibrated and certified by a laboratory accredited under HOKLAS or any other international accreditation scheme before use, and subsequently re-calibrated at monthly intervals throughout the stages of the water quality monitoring. Responses of sensors and electrodes will be checked with certified standard solutions before each use.
On-site calibration of field equipment shall follow the ¡§Guide to On-Site Test Methods for the Analysis of Waters¡¨, BS 1427: 2009. Sufficient stocks of spare parts shall be maintained for replacements when necessary. Backup monitoring equipment shall also be made available so that monitoring can proceed uninterrupted even when equipment is under maintenance, calibration etc.
3.1.4. LABORATORY MEASUREMENT
AND ANALYSIS
All laboratory work shall be carried out in a HOKLAS accredited laboratory. Sufficient volume of each water sample shall be collected at the monitoring stations for carrying out the laboratory analyses. Using chain of custody forms, collected water samples will be transferred to an HOKLAS accredited laboratory for immediate processing. The determination work shall start within the next working day after collection of the water samples. The laboratory measurements shall be provided to the client within 5 working days of the sampling event. Analytical methodology and sample preservation of other parameters will be based on the latest edition of Standard Methods for the Examination of Waste and Wastewater published by APHA, AWWA and WPCF and methods by USEPA, or suitable method in accordance with requirements of HOKLAS or another internationally accredited scheme. The submitted information should include pre-treatment procedures, instrument use, Quality Assurance/Quality Control (QA/QC) details (such as blank, spike recovery, number of duplicate samples per-batch etc), detection limits and accuracy. The QA/QC details shall be in accordance with requirements of HOKLAS or another internationally accredited scheme.
Parameters for laboratory measurements, their standard methods and their detection limits are presented in Table 3.2.
Table 3.2 Laboratory
measurements, standard methods and corresponding detection limits of marine water quality
monitoring
Parameters |
Standard Methods |
Detection Limit |
Reporting Limit |
Precision |
Dissolved
oxygen (mg/L) |
Instrumental,
CTD |
0.1 |
- |
¡Ó25% |
Temperature
(oC) |
Instrumental,
CTD |
0.1 |
- |
¡Ó25% |
pH |
Instrumental,
CTD |
0.1 |
- |
¡Ó25% |
Turbidity
(NTU) |
Instrumental,
CTD |
0.1 |
- |
¡Ó25% |
Salinity (0/00) |
Instrumental,
CTD |
0.1 |
- |
¡Ó25% |
Suspended
Solids (mg/L) |
APHA
17th Ed
2540D |
1.0 |
2.0 |
¡Ó17% |
Total
Residual Chlorine (mg/L) |
APHA 21st Ed
4500 - Cl G NOTE1 |
0.1NOTE1 |
0.2NOTE1 |
¡Ó10% NOTE1 |
Iron-soluble |
USEPA
6010C NOTE 1 |
0.2NOTE1 |
0.2NOTE1 |
¡Ó25%NOTE1 |
Parameters |
Standard Methods |
Detection Limit |
Reporting Limit |
Precision |
Anti-scalant
as Reactive phosphorus |
APHA
4500P: B&F NOTE1 |
0.01NOTE1 |
0.01NOTE1 |
¡Ó25%NOTE1 |
NOTE1: The testing methods, Quality Assurance/Quality Control (QA/QC) details, detection limits and accuracy shall be submitted to EPD for approval prior to the commencement of monitoring programme.
If exceedances were found during water monitoring, the actions in accordance with the Event and Action Plan shall be carried out according to Appendix G.
3.1.5. MONITORING LOCATION
The water quality monitoring locations for baseline in accordance to the EM&A Manual and Contract Specification are shown in Figure 3.1 and Figure 4.1 respectively, and detailed in Table 3.3 below. A schedule for water quality monitoring shall be prepared by the ET and approved by IEC and EPD prior to the commencement of the monitoring.
Table 3.3 Location of
Baseline Water Quality Monitoring Station
Station |
Easting |
Northing |
Description |
CE |
843550 |
815243 |
Upstream
control station at ebb tide |
CF |
846843 |
810193 |
Upstream
control station at flood tide |
WSR1 |
846864 |
812014 |
Ecological
sensitive receiver at Tung Lung Chau |
WSR2 |
847645 |
812993 |
Fisheries
sensitive receiver at Tung Lung Chau |
WSR3 |
848023 |
813262 |
Ecological
sensitive receiver at Tung Lung Chau |
WSR4 |
847886 |
814154 |
Ecological
sensitive receiver at Tai Miu Wan |
WSR16 |
845039 |
815287 |
Ecological
sensitive receiver at Fat Tong Chau |
WSR33 |
847159 |
814488 |
Ecological
sensitive receiver at Tai Miu Wan |
WSR36 |
846878 |
814081 |
Ecological
sensitive receiver at Kwun Tsai |
WSR37 |
846655 |
813810 |
Ecological
sensitive receiver at Tit Cham Chau |
NF1 |
846542 |
813614 |
Edge
of mixing zone, ~ 200m west of outfall diffuser |
NF2 |
846942 |
813614 |
Edge
of mixing zone, ~ 200m east of outfall diffuser |
NF3 |
846742 |
813414 |
Edge
of mixing zone, ~ 200m south of outfall diffuser |
WSR1 to WSR37 were identified in accordance with Annex 14 of the EIAO-TM as well as Clause 3.4.4.2 of the Environmental Impact Assessment Study Brief for Desalination Plant at Tseung Kwan O (No. ESB-266/2013). WSR1 to WSR3 are sited near the Tung Lung Chau Fish Culture Zone; WSR16 and WSR36 are sited near the coral assemblages along the coastlines of Fat Tong Chau and Kwun Tsai respectively; WSR 4 and WSR33 are sited near the Coastal Protection Area and coral assemblages in waters of Tai Miu Wan; WSR37 is sited near the fisheries resource including spawning and nursery grounds at the coastal water of Tit Cham Chau.
Figure 3.1 Baseline water quality
monitoring locations under EM&A Manual
3.1.6. SAMPLING FREQUENCY
During periods when there are dredging
works, impact monitoring should be undertaken at the monitoring stations as
shown in Figure 3.1 and Table 3.3 three days per week during
the construction phase after the commencement of marine construction works and
dredging activities. Monitoring at each station would be undertaken at both
mid-ebb and mid-flood tides on the same day. The tidal range selected for the
baseline monitoring will be at least 0.5 m for both flood and ebb tides as far
as practicable. The interval between two sets of monitoring would not be less
than 36 hours. The monitoring frequency would be increased in the case of
exceedances of Action/Limit Levels if considered necessary by ET. Monitoring
frequency would be maintained as far as practicable.
The monitoring location/position, time, water depth, water temperature, salinity, weather conditions, sea conditions, tidal stage, special phenomena and work underway at the marine works site will be recorded.
3.1.7. SAMPLING DEPTHS
& REPLICATION
For baseline monitoring, each station will be sampled and measurements/ water samples will be taken at three depths, 1 m below the sea surface, mid-depth and 1 m above the seabed. For stations that are less than 3 m in depth, only the mid depth sample shall be taken. For stations that are less than 6 m in depth, only the surface and seabed sample shall be taken. For in situ measurements, duplicate readings shall be made at each water depth at each station. Duplicate water samples shall be collected at each water depth at each station.
3.2.
MONITORING PROGRAMME
The ET of the Project had conducted the baseline water monitoring between 12 May 2020 to 6 Jun 2020 at the thirteen designated monitoring stations and the six designated monitoring at waters near TKO in accordance with the EM&A Manual and Contract Specification respectively. The monitoring results was presented in Baseline Water Quality Monitoring Report separately.
The commencement of marine construction and dredging activities for the Project are scheduled in November 2020 the earliest. The impact water monitoring shall be scheduled after the commencement of marine construction and dredging activities. Hence, no water monitoring was conducted during the reporting month.
The waste generated from
this Project includes inert construction and demolition (C&D) materials,
and non-inert C&D materials. Non- inert C&D materials are made up of
general refuse, vegetative wastes and recyclable wastes such as plastics and
paper/cardboard packaging waste. Steel materials generated from the project are
also grouped into non-inert C&D materials as the materials were not
disposed of with other inert C&D materials. With reference to relevant
handling records and trip tickets of this Project, the quantities of different
types of waste generated in the reporting month are summarised in Table 4.1. Details of cumulative waste
management data are presented as a waste flow table in Appendix H.
Table 4.1 Quantities of
Waste Generated from the Project during September 2020
Reporting
Month |
Actual
Quantities of Inert C&D Materials Generated Monthly |
Actual
Quantities of C&D Wastes Generated Monthly |
|||||||||
Total Quantity Generated |
Hard Rock and
Large Broken Concrete |
Reused in the
Contract |
Reused in other
Projects |
Disposed as Public Fill |
Imported Fill |
Metals |
Paper /
cardboard packaging |
Plastics (see
Note) |
Chemical Waste |
Others, e.g. general refuse |
|
(in
,000kg) |
(in
,000kg) |
(in
,000kg) |
(in
,000kg) |
(in
,000kg) |
(in
,000kg) |
(in
,000kg) |
(in
,000kg) |
(in
,000kg) |
(in
,000kg) |
(in
,000kg) |
|
September 2020 |
0 |
0 |
0 |
0 |
0 |
0 |
14.975 |
0 |
0 |
0 |
83.15 |
Notes: (1) Plastics refer to plastic bottles /
containers, plastic sheets / foam from packaging material
5.
LANDFILL GAS MONITORING
5.1.
MONITORING REQUIREMENT
In accordance with Section 11 of the EM&A Manual, monitoring of landfill gas is required for construction works within the 250m Consultation Zone. Part of the desalination plant and the indicative area of natural slope mitigation works fall within the SENT Landfill Extension Consultation Zone; and part of the 1,200 mm diameter fresh water mains along Wan Po Road falls within the SENT Landfill and SENT Landfill Extension Consultation Zones, TKO Stage II/III Restored Landfill and TKO Stage I Restored Landfill Consultation Zones.
5.2.
MONITORING LOCATION
Monitoring of oxygen, methane, carbon dioxide and barometric pressure was performed for excavations at 1m depth or more within the consultation Zone.
During construction of works within the consultation zones, excavations of 1m depth or more was monitored:
- At the ground surface before excavation commences;
- Immediately before any worker enters the excavation;
- At the beginning of each working day for the entire period the excavation remains open; and
- Periodically through the working day whilst workers are in the excavation.
For excavations between 300mm and 1m deep, measurements should be carried out:
- Directly after the excavation has been completed; and
- Periodically whilst the excavation remains open.
5.3.
MONITORING PROGRAMME
For the part of the desalination plant and the indicative area of natural slope mitigation works fall within the SENT Landfill Extension Consultation Zone in this contract. Since the SENT Landfill Extension is still under construction, the Landfill gas monitoring shall be conducted after the commencement of operation of the SENT Landfill Extension which will be 2021 Quarter 3 according to the latest construction programme shown in the monthly EM&A Report of SENT Landfill Extension. The Contractor¡¦s safety officer shall keep review the necessity of landfill gas monitoring during the construction stage. No landfill gas monitoring was conducted in the reporting period.
6.
SUMMARY OF MONITORING
EXCEEDANCE, COMPLAINTS, NOTIFICATION OF SUMMONS AND PROSECUTIONS
The
Environmental Complaint Handling Procedure is shown in below Figure 6.1:
Figure 6.1 Environmental
Complaint Handling Procedures
No noise monitoring was conducted during the reporting period since there are no project-related construction activities undertaken within a radius of 300m from the monitoring locations.
No impact water quality monitoring was conducted in the reporting month since the commencement of marine construction and dredging activities for the Project are scheduled in November 2020 the earliest.
No project-related exceedance of the Action Level was recorded during the reporting period. No notification of summons and prosecution was received in the reporting period.
Statistics on complaints and regulatory compliance are summarized in Appendix J.

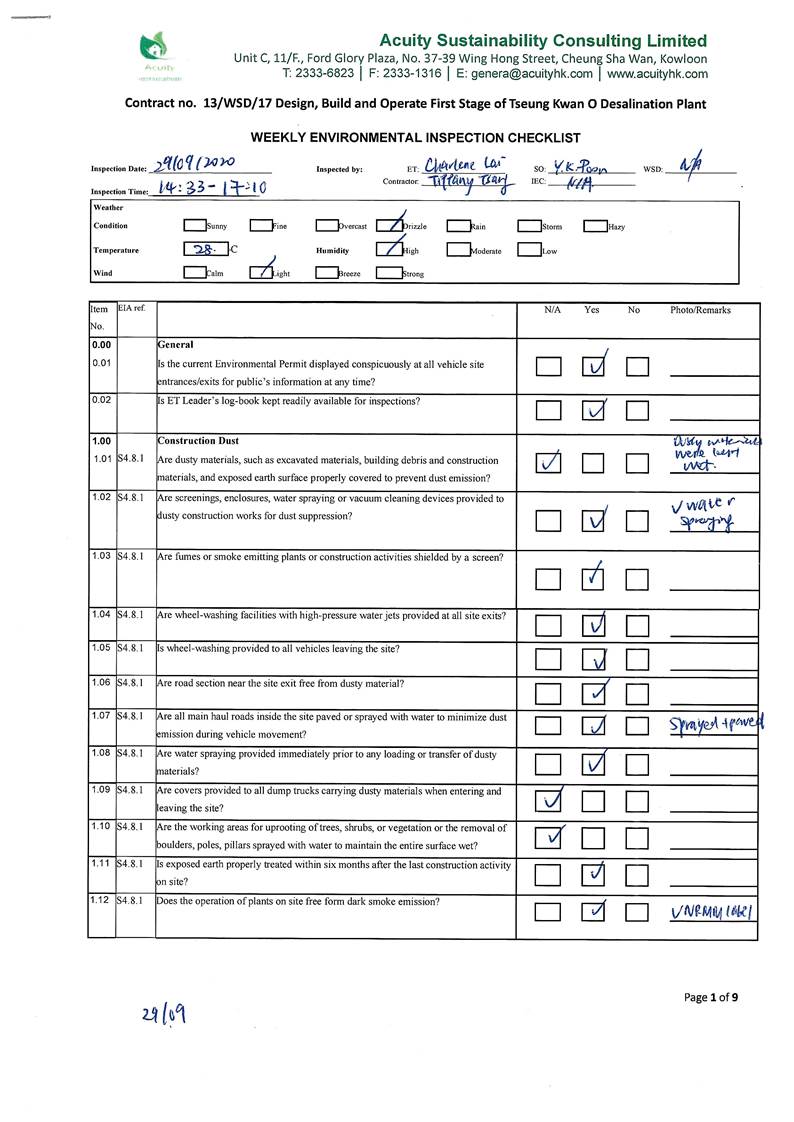

Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract. In the reporting period, site inspections were carried out on 1, 8, 16, 25 & 29 September 2020 at the site portions list in Table 6.1 below.
Table 7.1 Summaries
of Site Inspection Record
Date |
Inspected Site Portion |
Time |
1 September 2020 |
TKO 137 |
14:38 - 17:00 PM |
8 September 2020 |
TKO 137 |
14:36 - 17:15 PM |
16 September 2020 |
TKO 137 |
14:33 - 17:00 PM |
25 September 2020 |
TKO 137 |
09:30 - 12:00 AM |
29 September 2020 |
TKO 137 |
14:33 - 17:00 PM |
Two joint site inspection with IEC were carried out on 11 & 27 August 2020.
Environmental deficiencies were observed during weekly site inspection. Key observations during the site inspections and during the reporting period are summarized in Table 7 .2.
Table 7.2 Site Observations
Date |
Environmental Observations |
Follow-up Status |
1 September 2020 (Site inspection) |
Observation(s) and Recommendation(s) 1. No major observation was observed. |
Nil. |
8 September 2020 (Site inspection) |
Observation(s) and Recommendation(s) 1. No major observation was observed. |
Nil. |
16 September 2020 (Site inspection) |
Observation(s) and Recommendation(s) 1. No major observation was observed. |
Nil. |
25 September 2020 (Site inspection) |
Observation(s) and Recommendation(s) 1. No major observation was observed. |
Nil. |
29 September 2020 (Site inspection) |
Observation(s) and Recommendation(s) 1. Chemicals were not placed inside the drip- tray at the RO area. |
1. Chemical removed off site for proper storage. |
According to the EIA Study Report, Environmental Permit, contract documents and EM&A Manual, the mitigation measures detailed in the documents are implemented as much as practical during the reporting period. An updated Implementation Status of Environmental Mitigation Measures (EMIS) is provided in Appendix C.

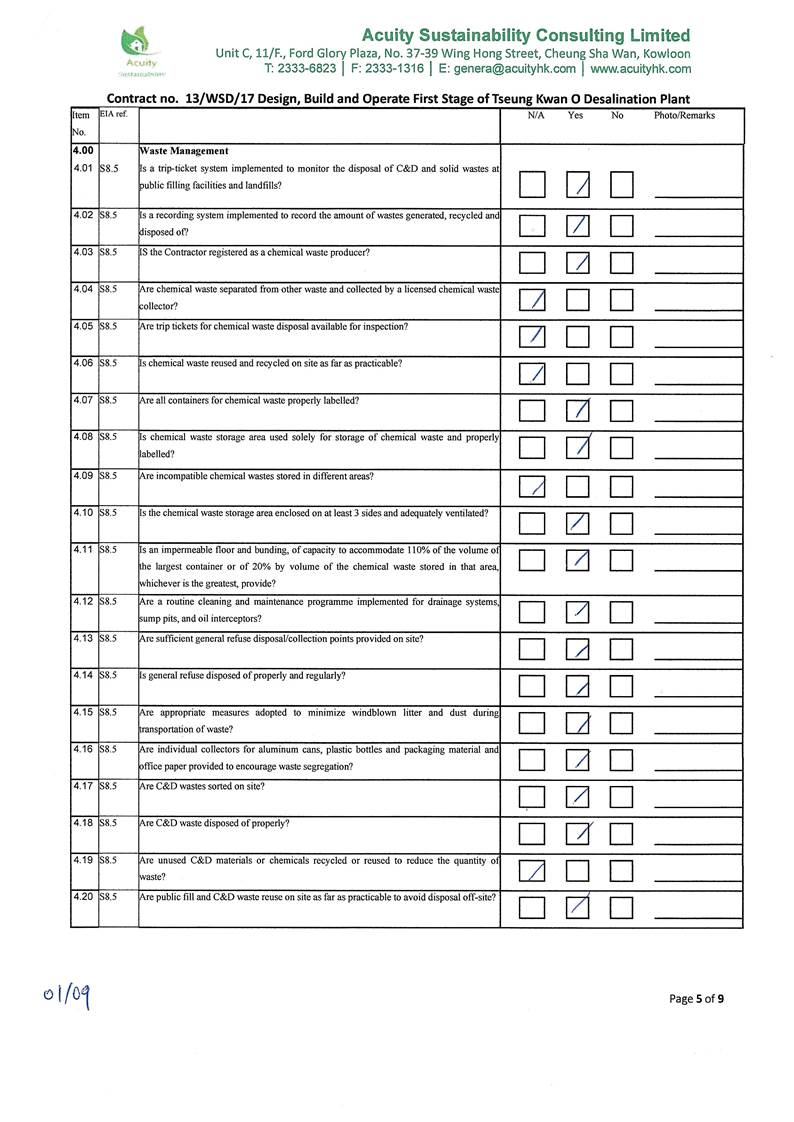

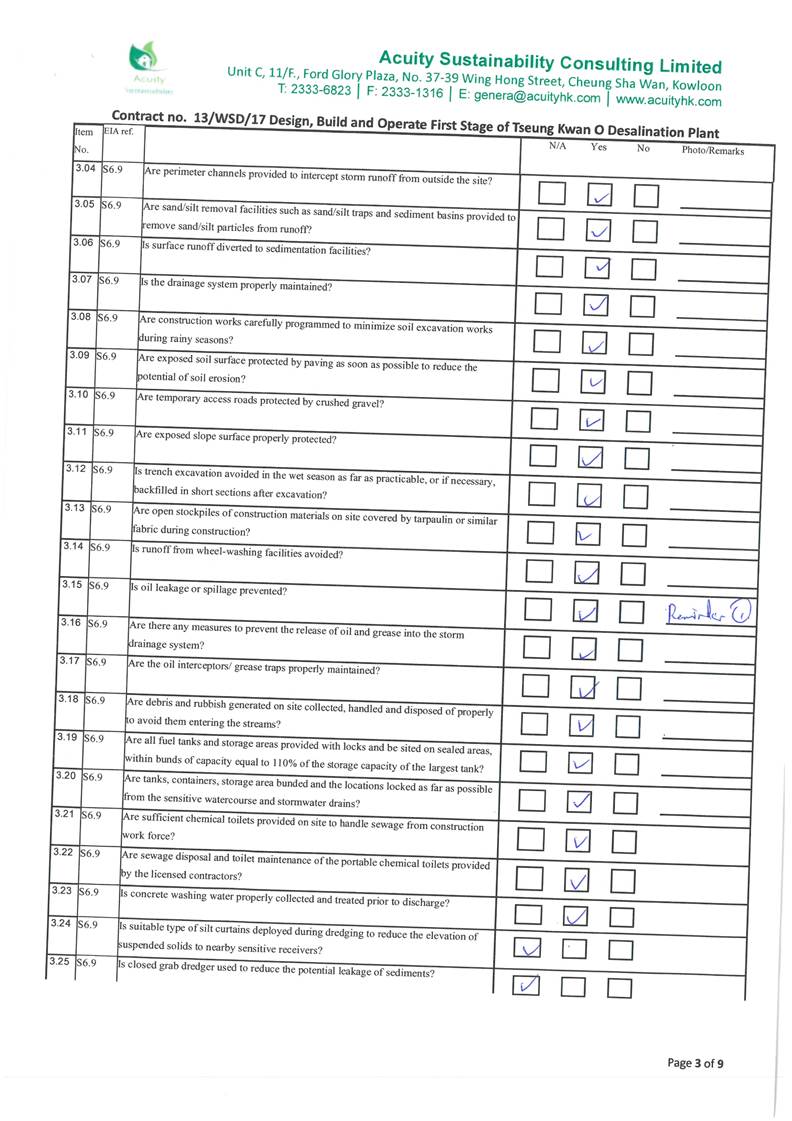

Site inspection proforma of the reporting
period is provided in Appendix I.
Works to be undertaken in the next reporting month are:
- Land Survey;
- Access Road Construction;
- ELS installation and bulk excavation at combine shaft;
- Construction of 132kV substation;
- Construction of ActifDAFF footing and perimeter wall;
- Construction of RO footing and excavation;
- Construction for Product Water Storage Tank footing;
- Excavation and Installation of temporary soil nail at Product Water Storage Tank.
The major environmental impacts brought by the above construction works will include:
- Construction dust and noise generation from GI works, access road construction and site office formation work;
- Waste generation from construction activities
The key environmental mitigation measures for the Project in the coming reporting period associated with the above construction works will include:
- Dust suppression by regular wetting and water spraying for construction works
- Reduction of noise from equipment and machinery on-site
- Sorting and storage of general refuse and construction waste
Referring to EM&A Manual Section 4.1.2, the impact noise monitoring should be carried out at all the designated monitoring stations when there are project-related construction activities undertaken within a radius of 300m from the monitoring stations.
The impact monitoring schedule for the next reporting month to be shown at Appendix K is intentionally left blank since no impact monitoring will be conducted in the next reporting month.
9.
CONCLUSIONS AND RECOMMENDATIONS
This is the 7th Monthly EM&A Report for the Project which summarizes the key findings of the EM&A programme during the reporting period from 1 September to 30 September 2020, in accordance with the EM&A Manual and the requirement under FEP-01/503/2015/A.
No noise monitoring was conducted in the reporting period due to the over distant monitoring station from the works location.
construction activities undertaken within a radius of 300m from the monitoring locations.
No impact water monitoring was conducted in the reporting period due to no marine construction works and dredging activities were conducted in the reporting period.
No project-related exceedance of the Action / Limit Level was recorded during the reporting period.
Weekly environmental site inspection was conducted during the reporting period. Minor deficiency was observed during site inspection and was rectified. The environmental performance of the project was therefore considered satisfactory.
According to the environmental site inspections performed in the reporting month, the Contractor is reminded to pay attention on maintaining proper materials storage.
No environmental complaint was received in the reporting period.
No notification of summons or prosecution was received since commencement of the Contract.
The ET will keep track on the construction works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.
Master Programme
Overview
of Desalination Plant in Tseung Kwan O
Appendix C
Summary of
Implementation Status of Environmental Mitigation
EIA
Reference |
Recommended
Environmental Protection Measures/
Mitigation Measures |
Objectives of the recommended
measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation &
Guidelines |
||
D |
C |
O |
||||||
Air Quality |
|
|||||||
S4.8.1 |
Impervious dust
screen or sheeting will be provided to enclose scaffolding from the ground
floor level of building for construction of superstructure of the new
buildings. |
Land site/ During
Construction |
Contractor(s) |
|
ü |
|
N/A |
Air Pollution
Control (Construction Dust) |
S4.8.1 |
Impervious sheet
will be provided for skip hoist for material transport. |
Land site/ During
Construction, particularly dry season |
Contractor(s) |
|
ü |
|
NA |
|
S4.8.1 |
The area where
dusty work takes place should be sprayed with water or a dust suppression
chemical immediately prior to, during and immediately after dusty activities
as far as practicable. |
Land site/ During
Construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
All dusty
materials should be sprayed with water
or a dust suppression chemical immediately prior to any loading, unloading or
transfer operation. |
Land site/ During
Construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
Dropping heights for excavated materials should be
controlled to a practical height to minimise the fugitive dust arising from
unloading. |
Land site/ During
Construction |
Contractor(s) |
|
ü |
|
N/A |
|
S4.8.1 |
During transportation by truck, materials should not be
loaded to a level higher than the side and tail boards, and should be
dampened or covered before transport. |
Land site/ During Construction |
Contractor(s) |
|
ü |
|
N/A |
|
S4.8.1 |
Wheel washing
device should be provided at the exits of the work sites. Immediately before
leaving a construction site, every vehicle shall be washed to remove any
dusty material from its body and wheels as far as practicable. |
Land site/ During
Construction |
Contractor(s) |
|
ü |
|
N/A |
|
EIA
Reference |
Recommended
Environmental Protection Measures/
Mitigation Measures |
Objectives of the recommended
measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation &
Guidelines |
||
D |
C |
O |
||||||
S4.8.1 |
Road sections between
vehicle-wash areas and vehicular entrance will be paved. |
Land site/ During
Construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
Hoarding of not
less than 2.4m high from ground level will be provided along the length of
the Project Site boundary. |
Land site/ During
construction |
Contractor(s) |
ü |
ü |
|
N/A |
|
S4.8.1 |
Haul roads will
be kept clear of dusty materials and will be sprayed with water so as to
maintain the entire road surface wet at all times. |
Land site/ During
construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
Temporary stockpiles of dusty materials will be either
covered entirely by impervious sheets or sprayed with water to maintain the
entire surface wet all the time. |
Land site/ During
construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
Stockpiles of
more than 20 bags of cement, dry pulverised fuel ash and dusty construction
materials will be covered entirely by impervious sheeting sheltered on top
and 3-sides. |
Land site/ During
construction |
Contractor(s) |
|
ü |
|
N/A |
|
S4.8.1 |
All exposed areas will be kept wet always to minimise
dust emission. |
Land site/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
Ultra-low-sulphur
diesel (ULSD) will be used for all construction plant on-site, as defined as
diesel fuel containing not more than 0.005% sulphur by weight) as stipulated
in Environment, Transport and Works Bureau Technical Circular (ETWB-TC(W)) No
19/2005 on Environmental Management on Construction Sites. |
Land site/ During
construction/ During Operation |
Contractor(s) |
|
ü |
ü |
Implemented |
Environment,
Transport and Works Bureau Technical Circular (ETWB- TC(W)) No 19/2005 on Environmental Management on Construction Sites |
EIA
Reference |
Recommended
Environmental Protection Measures/
Mitigation Measures |
Objectives of the recommended
measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation &
Guidelines |
||
D |
C |
O |
||||||
S4.8.1 |
The engine of the
construction equipment during idling will be switched off. |
Land site/ During
construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.8.1 |
Concrete batching
plant will be required on site. control measures recommended in the Guidance
Note on a Best Practicable Means for Cement Works (Concrete Batching Plant)
(BPM 3/2 (93)) will be implemented. The control measures recommended in the
Guidance Note on a Best Practicable Means for Cement Works (Concrete Batching
Plant) (BPM 3/2 (93)) will be |
Land site/ During
construction |
Contractor(s) |
|
ü |
|
N/A |
Guidance
Note on a Best |
S4.8.1 |
Regular maintenance of construction equipment deployed
on-site will be conducted to prevent black smoke emission. |
Land site/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
|
S4.10 |
To ensure proper
implementation of the recommended dust mitigation measures and good
construction site practices during the construction phase, environmental site
audits on weekly basis is recommended throughout the construction period. |
Land site/ During
construction |
Contractor(s)/ Environmental Team (ET) & Independent Environmental Checker (IEC) |
|
ü |
|
Implemented |
|
Note: D - Design stage C - Construction O - Operation
EIA
Reference |
Recommended
Environmental Protection Measures/
Mitigation Measures |
Objectives of the recommended
measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation &
Guidelines |
||
D |
C |
O |
||||||
Noise |
||||||||
S5.7 |
Only
well-maintained plant will
be operated on- site and plant will be serviced
regularly during the construction phase. |
All
area/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
A Practical Guide for the Reduction of
Noise from Construction Works, |
S5.7 |
Silencers or
mufflers on construction equipment will be utilised and will be properly
maintained during the construction phase. |
Noise control/
During construction |
Contractor(s) |
|
ü |
|
N/A |
A Practical Guide for the Reduction of
Noise from Construction Works, |
S5.7 |
Mobile plant, if
any, will be sited as far away from NSRs as possible. |
Noise control/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
A Practical Guide
for the Reduction of Noise from Construction Works, |
S5.7 |
Machines and
plant (such as trucks) that may be in intermittent use will be shut down between
work periods or will be throttled down to a minimum. |
Noise control/
During construction |
Contractor(s) |
|
ü |
|
Implemented |
A Practical Guide
for the Reduction of Noise from Construction Works, |
S5.7 |
Plants known to
emit noise strongly in one direction will, wherever possible, be orientated so
that the noise is directed away from the nearby NSRs. |
Noise control/
During construction |
Contractor(s) |
|
ü |
|
N/A |
A Practical Guide
for the Reduction of Noise from Construction Works, |
S5.7 |
Material
stockpiles and other structures will be effectively utilised, wherever
practicable, in screening
noise from on-site construction activities. |
Noise control/
During construction |
Contractor(s) |
|
ü |
|
N/A |
A Practical Guide
for the Reduction of Noise from Construction Works, |
S5.7 |
Use
of Quite Powered Mechanical Equipment (QPME). |
Noise
control/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
A Practical Guide for the Reduction of Noise from Construction Works, |
S5.7 |
Movable noise
barriers of 3m in height with skid
footing should be used and located within a
few metres of stationary plant and mobile
plant such that the line of
sight to the NSR is blocked by the barriers. The length of the barrier should be at least
five times greater than its height. The noise
barrier material should have a superficial |
Noise control/ During construction |
Contractor(s) |
|
ü |
|
N/A |
A
Practical Guide for the Reduction of Noise from Construction Works, |
EIA
Reference |
Recommended
Environmental Protection Measures/
Mitigation Measures |
Objectives of the recommended
measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation &
Guidelines |
||
D |
C |
O |
||||||
|
surface
density of at least 7 kg m-2 and have no openings or gaps. |
|
|
|
|
|
|
|
S5.7 |
The
noise insulating sheet
should be deployed such that there would be no
opening or gaps on the joints. |
Noise control/
During construction |
Contractor(s) |
|
ü |
|
N/A |
A Practical Guide for the Reduction of
Noise from Construction Works, |
S5.7 |
Construction activities (e.g. excavation/shoring,
reinstatement (asphalt), and
pipe jacking) will
be planned and carried out
in sequence, such that items of PME proposed for these activities will not be operated
simultaneously. |
Noise control/ During construction |
Contractor(s) |
|
ü |
|
Implemented |
A
Practical Guide for the Reduction of Noise from Construction Works |
S5.7 |
PMEs will not be
used at the works areas near educational institutions with residual impact
(ie the ¡§influence area¡¨ within a radius of 40m) during school hours in order
to reduce impact to the
educational institutions. |
Noise control / During construction |
Contractor(s) |
|
ü |
|
Implemented |
A Practical Guide for the Reduction of Noise from
Construction Works |
S5.7 |
Noise enclosures
or acoustic sheds would be used to cover stationary PME such as generators. Portable/Movable noise enclosure made of material with
superficial surface density of at least 7 kg m-2 may be used for screening the noise from operation of
the saw/groover, concrete. |
Noise
control/ Pre-
construction/ During construction |
Contractor(s) |
ü |
ü |
|
N/A |
|
S5.9 |
Sawcutting
pavement, breaking up of pavement, excavation /shoring, pipe laying,
backfilling, reinstatement (concrete) and pipe
jacking shall be scheduled outside the examination period. |
Noise
control/ Pre-
construction/ During construction |
Contractor(s) |
ü |
ü |
|
N/A |
|
EIA
Reference |
Recommended
Environmental Protection Measures/
Mitigation Measures |
Objectives of the recommended
measures & main concerns to address |
Implementation Agent |
Implementation Stage |
Implementation status |
Relevant Legislation &
Guidelines |
||
D |
C |
O |
||||||
S5.9 |
In view the
duration of noise exceedance at Creative Secondary School, PLK Laws
Foundation College, TKO Kei Tak Primary School and School of Continuing and
Professional Studies-CUHK is limited to 8 weeks, the construction work in the
influence areas near the four schools shall be scheduled during
long school holidays
(eg summer holiday, Easter
holiday or Christmas holiday, etc)
as far as practicable. Scheduling the construction work for the four schools. |
Noise control/ Pre- construction/ During construction |
Contractor(s) |
ü |
ü |
|
N/A |
|
S5.10 |
A noise
monitoring programme shall be implemented for the construction phase. |
Designated
monitoring stations as defined in EM&A Manual/During construction phase |
Environmental Team (ET) |
|
ü |
|
Implemented |
|
S5.10 |
The effectiveness
of on-site control measures could also be evaluated through the regular site
audits. |
All facilities/
During construction |
Contractor(s)/ Environmental Team (ET) & Independent Environmental
Checker (IEC) |
|
ü |
|
Implemented |
- |
Note: D - Design stage C - Construction O - Operation
EIA
Reference |
Recommended
Environmental Protection Measures/
Mitigation Measures |
Objectives of the recommende measures & main concerns to address |
Implementatio n Agent |
Implementation Stage |
Implementation status |
Relevant Legislation &
Guidelines |
||
D |
C |
O |
||||||
Water Quality |
||||||||
S6.9 |
Dredged marine
sediment will be disposed of in a gazetted marine disposal area in accordance
with marine dumping permit conditions of the Dumping at Sea Ordinance (DASO). |
Marine Dredging/
During construction |
Contractor(s) |
|
ü |
|
N/A |
Dumping at Sea
Ordinance (DASO) |
S6.9 |
Disposal vessels
will be fitted with tight bottom seals in order to prevent leakage of
material during transport. |
Marine Dredging/
During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
S6.9 |
Barges will be
filled to a level, which ensures that material does not spill over during
transport to the disposal site and that adequate freeboard is maintained to
ensure that the decks are not washed by wave action. |
Marine Dredging/
During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
S6.9 |
After dredging, any excess materials
will be cleaned from decks and exposed fittings before the vessel is moved from the dredging area. |
Marine Dredging/
During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
S6.9 |
All vessels
should be well maintained and inspected before use to limit any potential
discharges to the marine environment. |
Marine Dredging/
During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
S6.9 |
All
vessels must have a clean ballast system. |
Marine Dredging/ During construction |
Contractor(s) |
|
ü |
|
N/A |
- |
S6.9 |
No
discharge of sewage/grey wastewater should be allowed. Waste water from
potentially contaminated area on working vessels should be minimized and
collected. These
kinds of wastewater should be
brought back to port and discharged at appropriate collection and treatment system. |
Marine Dredging/
During construction |
Contractor(s) |
|
ü |
|
N/A |
